Tujunga, Los Angeles, CA · April – May 2025 · LADWP / LADBS

A final two days after the install, and PTO thirteen days after that

Thirteen 540 W modules with a microinverter under each, installed in one day. The city signed off two days later, and the utility authorized the system to operate thirteen days after that.

This Tujunga installation is 7.02 kW DC: thirteen Canadian Solar 540 W modules, each with an Enphase IQ8HC microinverter, on a composition shingle roof. Cali Energy installed it on 22 April 2025, the LADBS final inspection was passed on 24 April, and LADWP authorized permission to operate on 7 May, nineteen days after the permit was issued.

Solar modules on a brown shingle roof beside a brick chimney, with cypress trees and foothills beyond, Tujunga
The array beside the chimney, with the cypresses and foothills behind.

At a glance

System
7.02 kW DC
Modules
13 × Canadian Solar CS6W-540MB-AG, 540 W
Microinverters
Enphase IQ8HC, two branches of 7 and 6
Installed
22 April 2025, in one day
Final passed
24 April 2025
LADWP permission to operate
7 May 2025

The story

The LADBS permit was issued on Friday 18 April 2025. On the Monday the installation was booked for the next day, with the materials delivered to the house that morning, and the system went on the roof on Tuesday 22 April.

It is thirteen Canadian Solar 540 W modules, 7.02 kW DC, laid out as a long row of nine with two modules running down from each end. Each module has an Enphase IQ8HC microinverter under it, wired in two branches of seven and six to an Enphase IQ Combiner 5 on the wall.

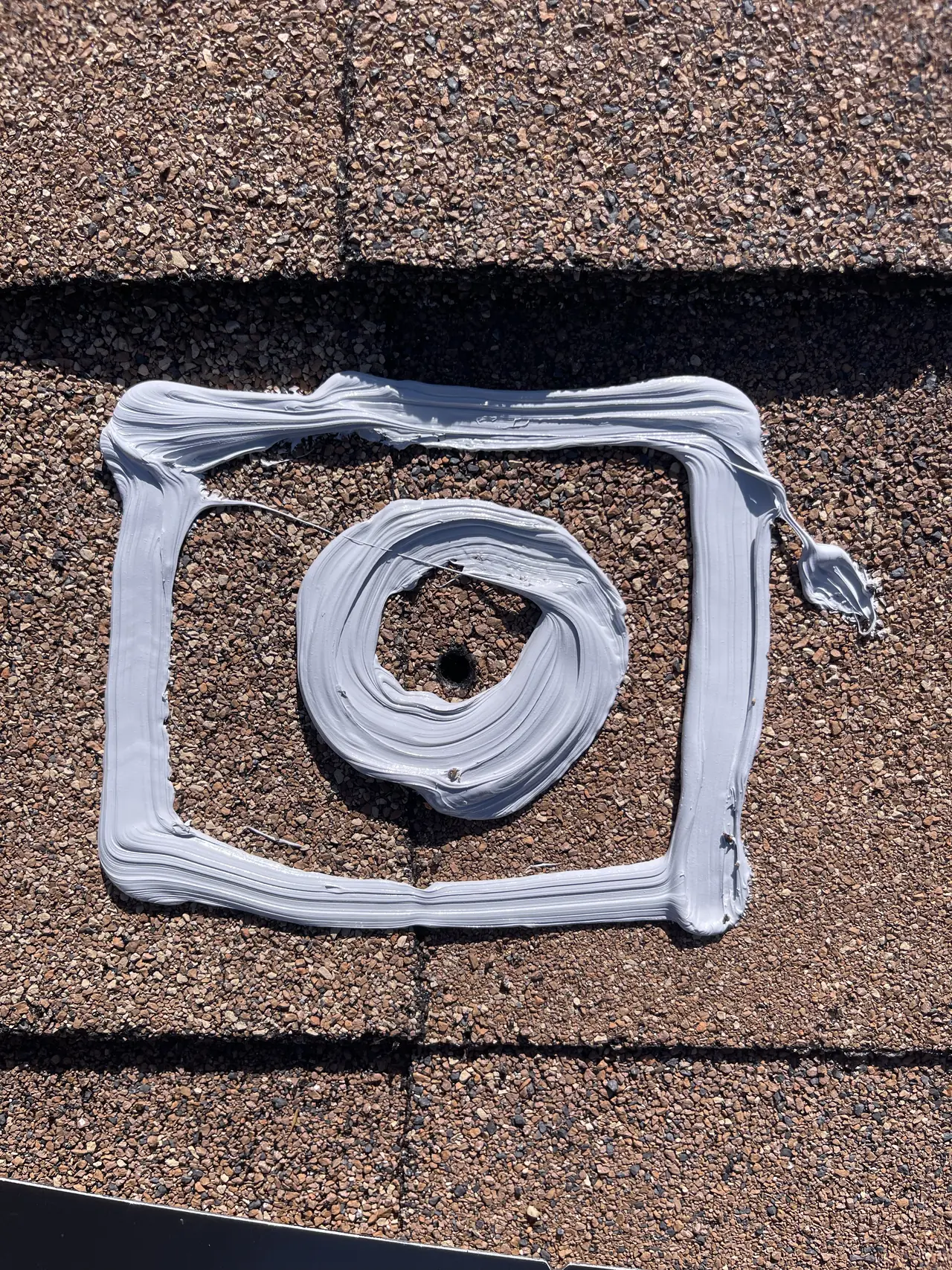

Rings of sealant around a drilled mount hole on a brown shingle roof, Tujunga
Sealant around the hole, before the mount goes down.

Every mount went through the shingle the same way: a ring of sealant around the drilled hole and a second ring around the area the base covers, then a flashed mount with its plate under the shingle course above.

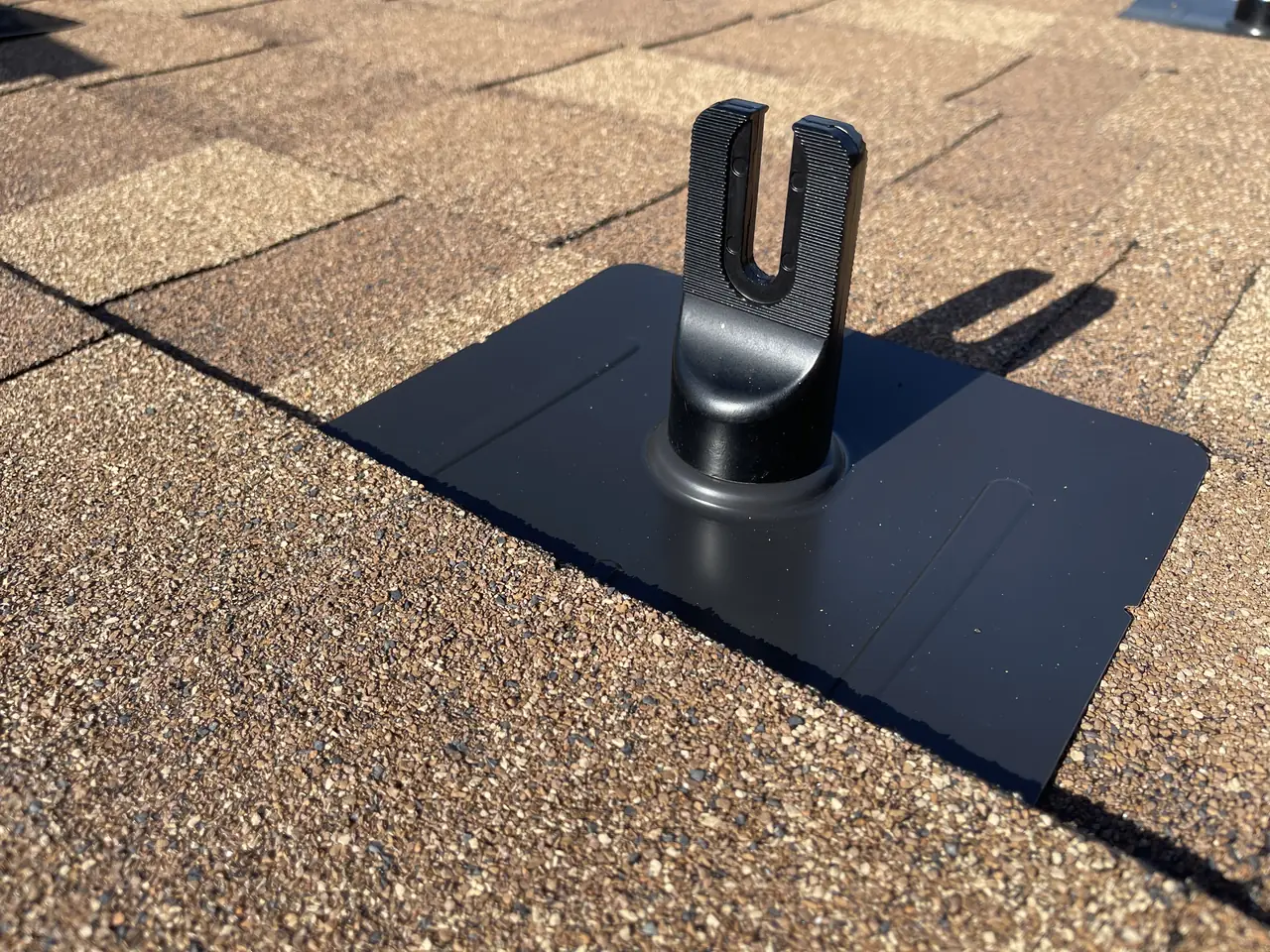

A black flashed solar mount on a brown shingle roof, Tujunga
A finished mount, its flashing under the course above.

The final inspection was requested the next day for Thursday 24 April, with an inspection window of one to three in the afternoon and the gate left open for the inspector. The final was passed that day, two days after the install.

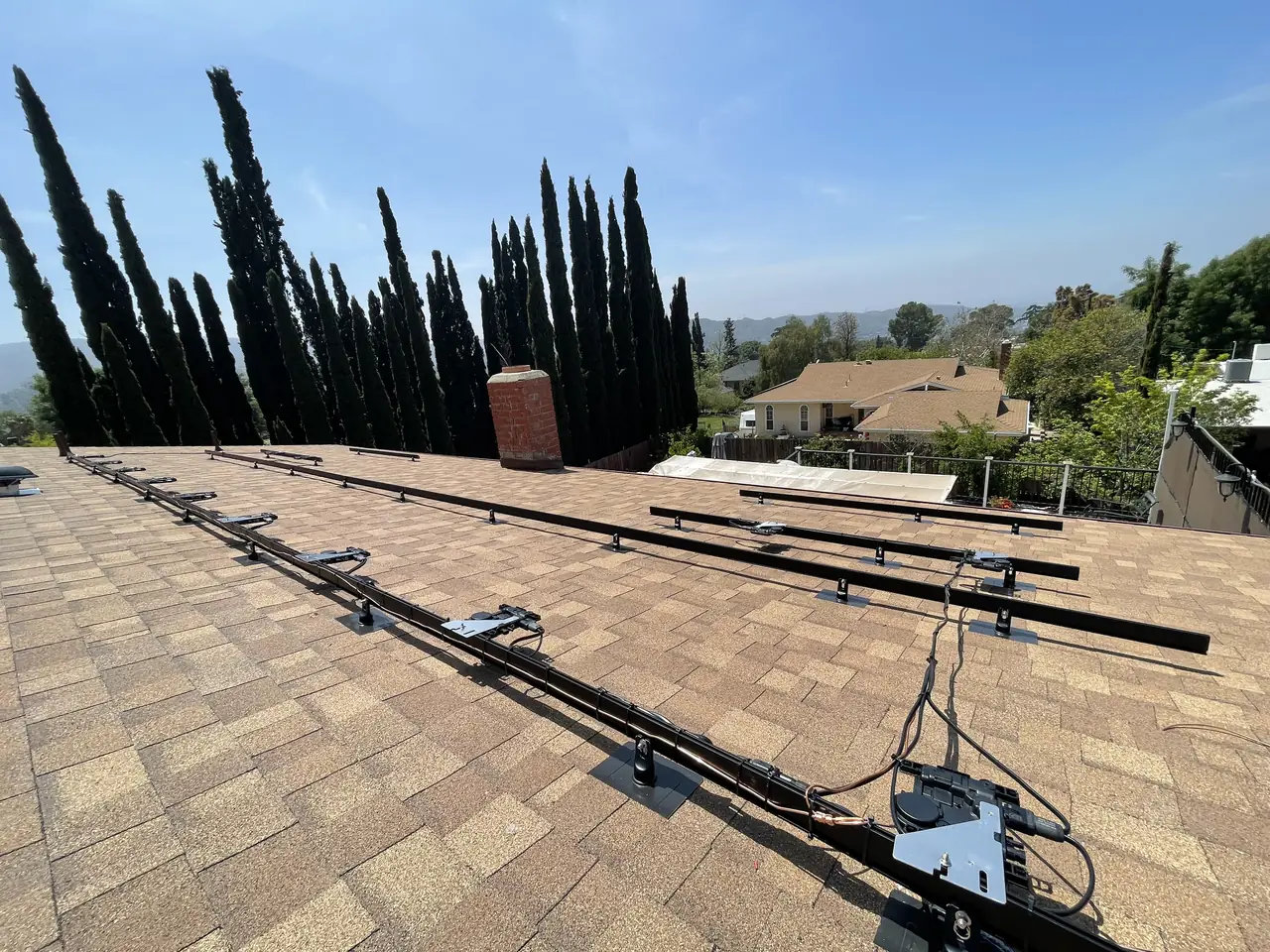

Black rails with Enphase microinverters on a shingle roof before the modules, cypress trees behind, Tujunga
Rails and microinverters in place, before the modules went on.

The utility's part followed. On 7 May LADWP sent its notice that it had authorized permission to operate, and its crew installed the new meter. The system was set up the same day, leaving the homeowner one step, switching the solar breakers on, which Cali Energy took on explaining. From permit to permission to operate, nineteen days.

How it ran

18 April 2025LADBS permit issued
22 April 2025Thirteen modules installed in one day
24 April 2025LADBS final inspection passed
7 May 2025LADWP authorizes permission to operate; new meter set
7–8 May 2025System set up; homeowner shown how to switch it on

Install to final: two days. Final to PTO: thirteen.

What we did

  • Installed the thirteen modules and microinverters in one day.
  • Sealed every mount hole before setting the flashed mounts.
  • Wired the array in two branches to an IQ Combiner 5.
  • Requested the final the day after the install and met the inspector.
  • Set the system up once LADWP authorized it and the meter was in.

System specifications

Modules13 × Canadian Solar CS6W-540MB-AG, 540 W
System size7.02 kW DC
MicroinvertersEnphase IQ8HC, one per module
CombinerEnphase IQ Combiner 5
MountingFlashed mounts on composition shingle, sealed at each hole
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You want to know how long Tujunga solar takes from permit to PTO.
  • You are planning a system of around seven kilowatts.
  • You want a microinverter under every module.
  • You have a composition shingle roof.

Cali Energy in Tujunga

Tujunga is a neighborhood inside the City of Los Angeles: permits run through LADBS, interconnection through LADWP.

Tujunga sits in the foothills at the north-east edge of the City of Los Angeles, so its permits come from LADBS and its grid connection from LADWP. After the city's final inspection, the utility still has to authorize the system before it can run.

Frequently asked questions

How long did this Tujunga system take from permit to PTO?

Nineteen days. The LADBS permit was issued on 18 April 2025, the system was installed on 22 April, the final inspection was passed on 24 April, and LADWP authorized permission to operate on 7 May, when its crew also set the new meter.

What equipment is in this Tujunga system?

Thirteen Canadian Solar CS6W-540MB-AG modules rated 540 W, 7.02 kW DC, each with an Enphase IQ8HC microinverter. They are wired in two branches of seven and six to an Enphase IQ Combiner 5 on the wall.

What happened after LADWP authorized permission to operate?

LADWP's crew installed the new meter, and the system was set up the same day. The one step left was for the homeowner to switch the solar breakers on, and Cali Energy took on explaining how.

Does Cali Energy install solar in Tujunga?

Yes. Tujunga is inside the City of Los Angeles, so permits run through LADBS and interconnection through LADWP. Cali Energy installs here on the foothill streets, books the final inspection after the install and sets the system up once the utility authorizes it. License CSLB #1032379.

What this would look like on your roof

Planning solar in Tujunga? Tell us your utility, your roof and what your bill looks like now, and we will model what a system like this would do on your house before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

Updated October 2026.
