Beverlywood, CA · November 2021 · LADWP / LADBS

Beverlywood: the monitoring was silent because the system was off.

A finished array that reports nothing looks broken. Before permission to operate, it is behaving correctly.

Between the final inspection and permission to operate, a solar system stays switched off. That is a condition of interconnection rather than an oversight: a system may not generate into the grid before the utility says so. A system that is off produces nothing, and a monitoring gateway with nothing to report does not report. On this Beverlywood project the silence was read as a fault and a site visit was asked for to fix it — the real answer was that permission had not arrived. It arrived the next day, and Cali Energy went out to start the system and put the gateway on the household network.

Solar modules on a roof above a paved yard, Beverlywood, Los Angeles
Finished, inspected, and deliberately switched off.

At a glance

Reported
Monitoring not communicating
Actual state
Switched off, as required before permission
The rule
No operation until permission to operate is granted
Permission
Granted the day before the question was raised
Then
One visit to start the system and connect the gateway
Utility / AHJ
LADWP / LADBS

The story

The array was finished, the inspection was requested, the photograph set went out. Two weeks later came the message that starts a lot of unnecessary service calls: the system is not communicating, the gateway is not reporting, please send somebody to connect it to the wi-fi.

Nothing was wrong with it.

Here is the rule that explains the silence, and it is worth knowing before it costs somebody a visit. On this utility's territory a new system stays off until permission to operate is granted. Not off as a precaution, and not off because nobody got around to it — off because generating into the grid before the utility has approved the interconnection is outside the terms of the agreement that makes the connection legal.

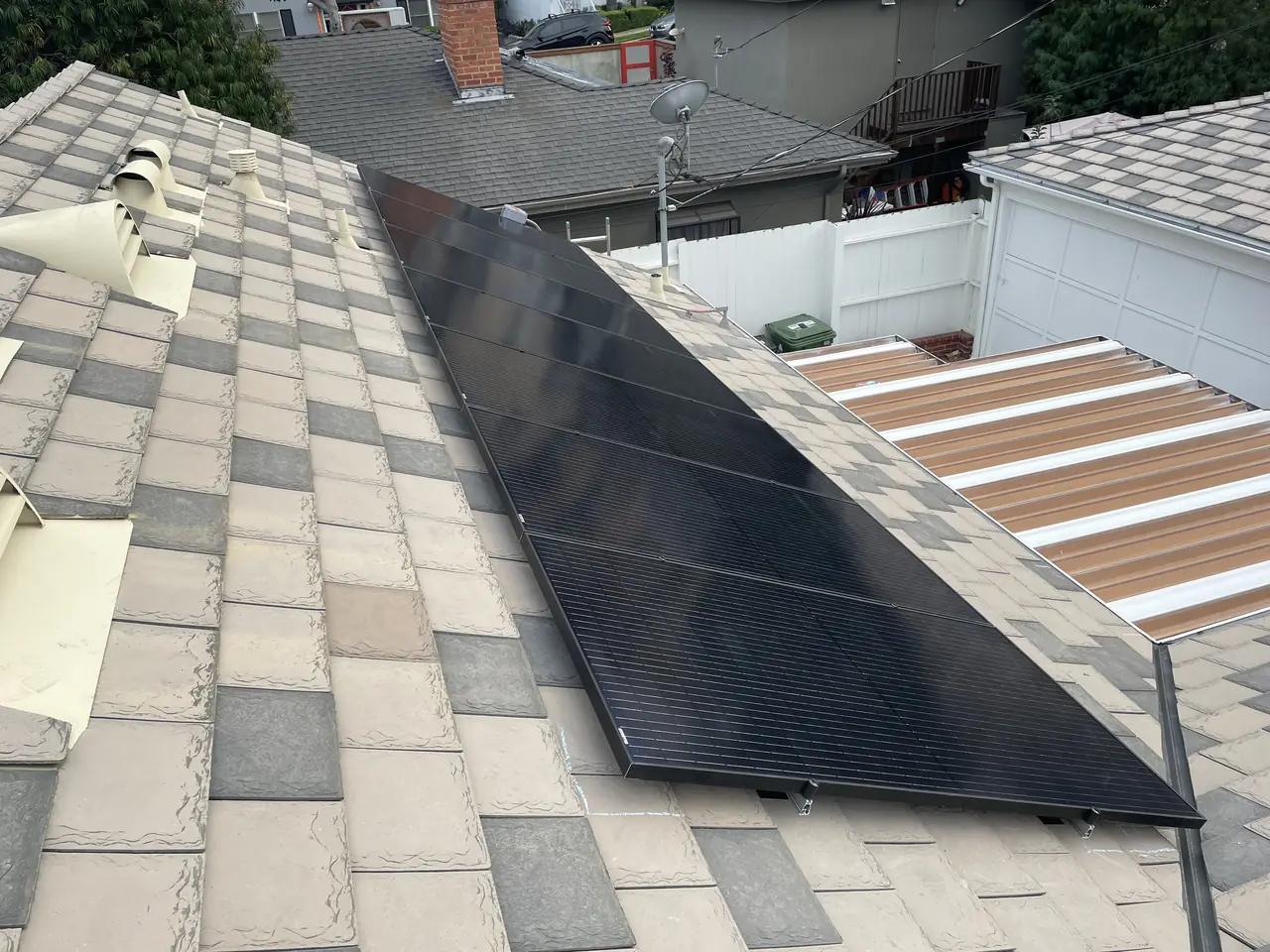

A solar module on a shingle roof beside the roof edge, Beverlywood, Los Angeles
Nothing here was broken.

So between the final inspection and the permission there is a stretch, sometimes weeks long, where a complete and perfect system does nothing at all.

And a monitoring platform cannot tell you that. The gateway takes its cue from the equipment it watches. With the system off there is no production to report, often no power to the gateway itself, and the platform shows exactly what it would show for a system that has failed: nothing.

Which is the trap. Broken and not-yet-permitted look identical from a phone.

There is one question that separates them, and it does not require anybody to climb anything: has permission to operate been granted, and on what date. Before that date, silence is correct and a site visit will achieve nothing except confirming the system is off. After that date, silence is a fault and worth chasing.

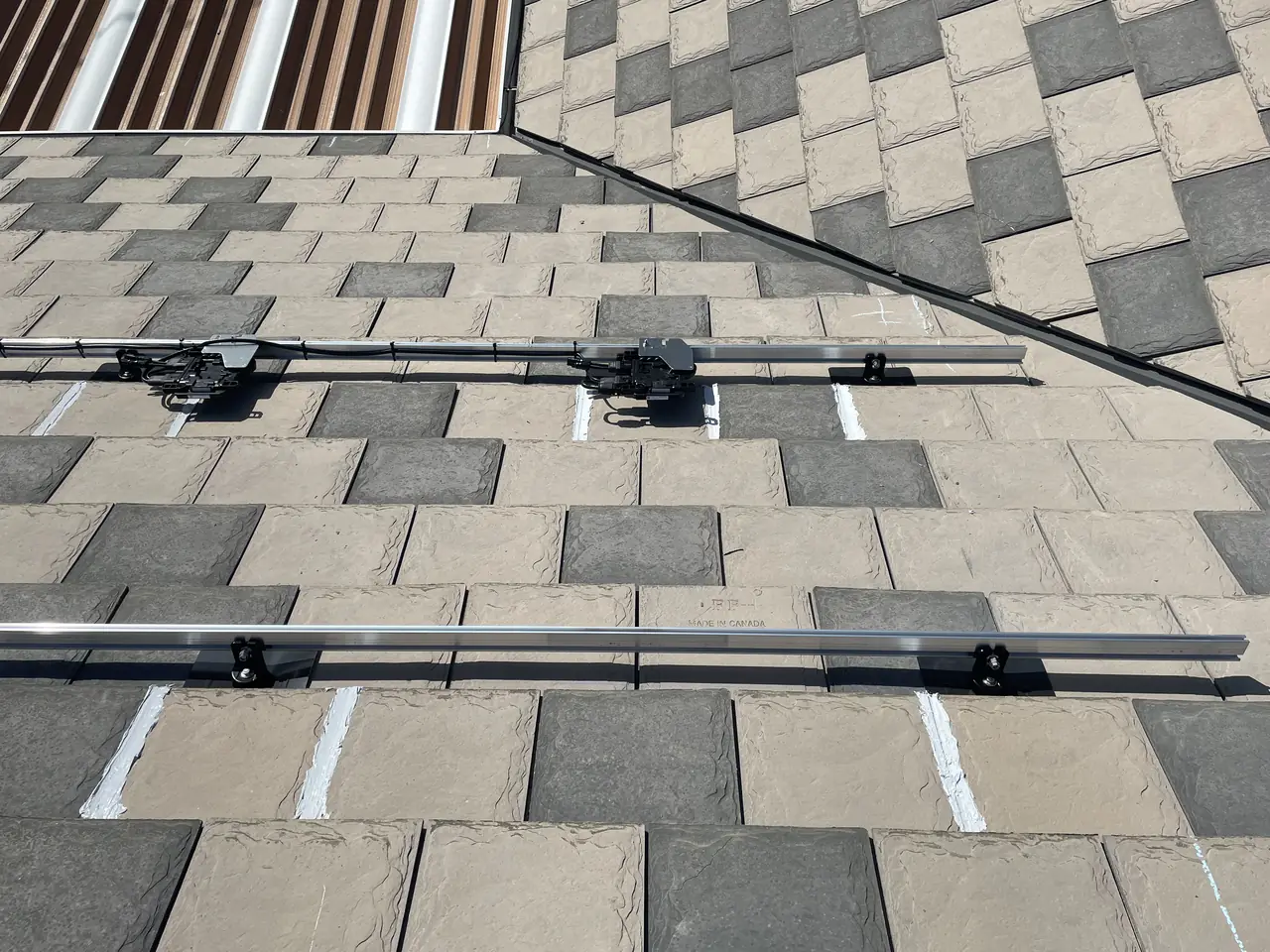

Mounting rails and attachments across a shingle roof, Beverlywood, Los Angeles
The system was complete. It was simply not allowed to run yet.

On this project the answer came back within hours, and it was almost comic: permission had been granted the previous day. The system had been doing the right thing until then and was now allowed to do the other thing.

What followed was the ordinary end of a project. A visit arranged for the middle of the day, the system started in the correct order, the gateway put on the household network so the monitoring had something to carry.

One practical note from that visit, because it catches people. Starting a system is not something anybody can do from an app. It needs somebody at the property with access to the main panel — which on this kind of lot means a gate unlocked and somebody expecting them. Arranging the access is usually the slow part of the appointment.

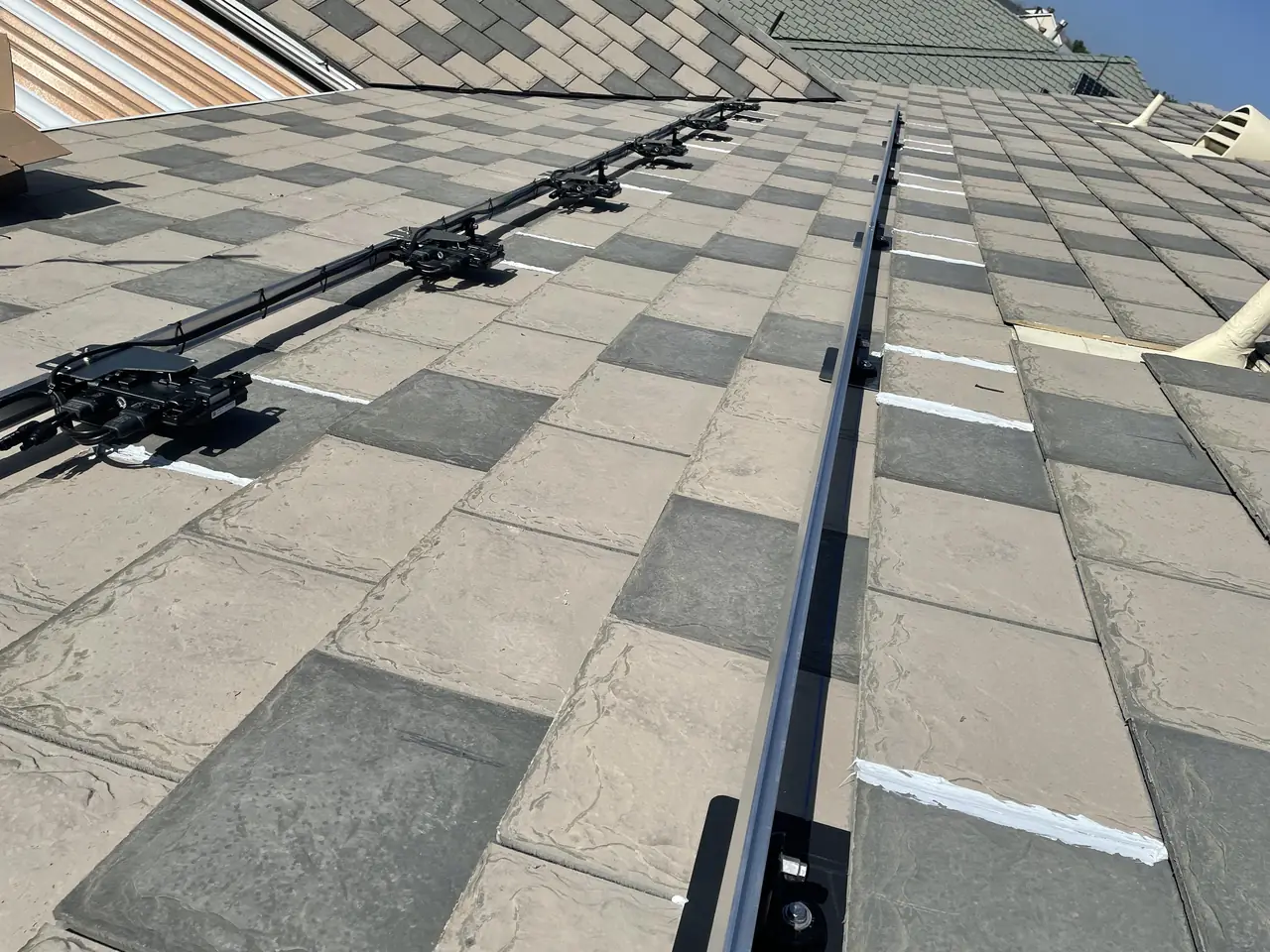

A mounting rail with clamps on a shingle roof, Beverlywood, Los Angeles
Starting it takes a person at the panel, not a tap in an app.

Cali Energy installed and commissioned this system in Beverlywood, Los Angeles.

How it ran

3 November 2021Installation
8 November 2021Inspection requested
10 November 2021Post-installation photograph set issued
23 November 2021Monitoring reported as not communicating; a site visit requested
23 November 2021Answered: the system is off because permission to operate has not been granted
23 November 2021Permission confirmed as granted the previous day
24 November 2021Visit arranged; access to the main panel confirmed

The fault report and the permission passed each other inside a single afternoon.

What we did

  • Left the system off until permission to operate was granted, as the interconnection requires.
  • Answered a reported fault with the rule rather than with a truck.
  • Started the system and put the gateway on the household network in one visit.
  • Confirmed access to the main panel before the visit rather than on the doorstep.

System specifications

ArrayResidential rooftop
MonitoringEnphase gateway
State before permissionOff, and therefore not reporting
Condition of interconnectionNo operation before permission to operate
Start-up visitRequires access to the main panel
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your new system shows nothing at all in the app.
  • You have been told the monitoring is broken and a technician is needed.
  • Your final has passed and you are waiting on permission to operate.
  • You want to know what actually happens at the start-up visit.

Cali Energy in Beverlywood

Beverlywood is City of Los Angeles on the Westside, permitted through LADBS and interconnected through LADWP. Compact lots and equipment behind gates, so a visit that needs the main panel has to be arranged rather than assumed.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

Why is my new solar system not reporting anything?

Most often because it has not been switched on yet. Until permission to operate is granted the system stays off, so there is no production to report and often no power to the monitoring gateway. The platform then shows the same blank it would show for a genuine failure.

Can I turn my solar on before permission to operate?

No. Generating into the grid before the utility has approved the interconnection falls outside the agreement that makes the connection legal. The system stays off until the permission is granted, however finished it looks from the street.

How do I tell a real monitoring fault from a system that is simply off?

Ask one question: has permission to operate been granted, and on what date. Before that date silence is correct and a site visit will only confirm the system is off. After it, silence is worth chasing.

What does the start-up visit need from me?

Somebody at the property and access to the main panel — it is not something that can be done remotely or from an app. On lots with gated equipment the access is usually the part that takes the arranging, not the work itself.

Does Cali Energy install and commission solar in Beverlywood, Los Angeles?

Yes. Beverlywood projects are permitted through LADBS and interconnected through LADWP, and the gap between the final inspection and permission to operate is a normal part of that route. The system is left off through it, which is exactly what the interconnection requires.

What this would look like on your roof

Every number above came off a real job in Beverlywood, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
