Woodland Hills, CA · January – March 2022 · LADWP / LADBS

The bolts were too short. The crew stopped.

Fourteen modules, under five kilowatts, on a Woodland Hills roof. It should have taken a day. It took two months, and every one of the decisions that cost time was made before the crew arrived.

When several companies share a job, the crew on the roof is the last line of defense, and the only thing it controls is whether to proceed. Fasteners that do not reach the framing are not a detail to improvise around: an array is a structural attachment carrying wind uplift for twenty years, and a short bolt is a failure waiting for weather. On this Woodland Hills roof Cali Energy stopped work on the installation day, named the exact fastener and quantity within hours, declined to substitute something available, and waited again later for a stamped revision rather than working to an unapproved drawing.

Black solar modules set on a gray composition shingle roof with trees behind, Woodland Hills
Fourteen modules. The work took two days. Getting to the point of doing it took two months.

At a glance

System size
4.76 kW DC
Modules
14 × Q CELLS Q.PEAK DUO BLK-G6 340 W
Inverters
14 × Enphase IQ7+ microinverters
Framing spacing
About seven feet between members
Fastener required
Thirty bolts, 5/16 by 10 inches
Time lost
Two months
Final inspection
Passed, on the first visit
Utility / AHJ
LADWP / LADBS

The story

This is a small system. Fourteen modules, a microinverter under each, under five kilowatts. On an ordinary roof it is a day's work. We were the installing contractor for another company, which held the customer, the permit, the drawings and the materials.

The crew arrived on the installation day in the middle of February and stopped within the hour.

Two things were wrong. The framing members on this roof sit about seven feet apart rather than the closer spacing an ordinary attachment assumes, and the hardware that had been supplied was nowhere near long enough to reach them. The correct fastener was a bolt five sixteenths of an inch across and ten inches long, and the job needed thirty of them.

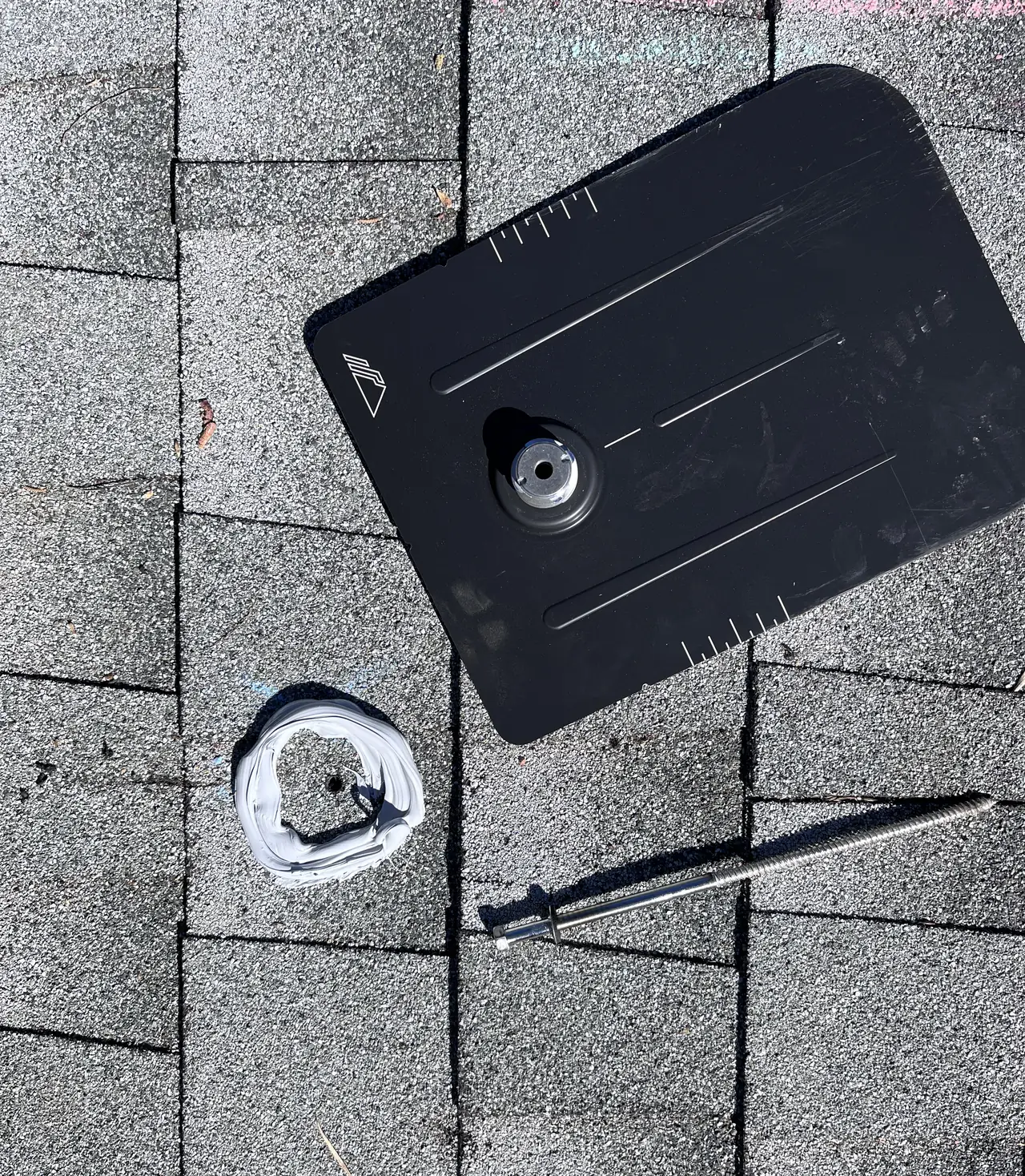

A black flashing plate seated in the shingle course with the mounting hole sealed at its center, Woodland Hills

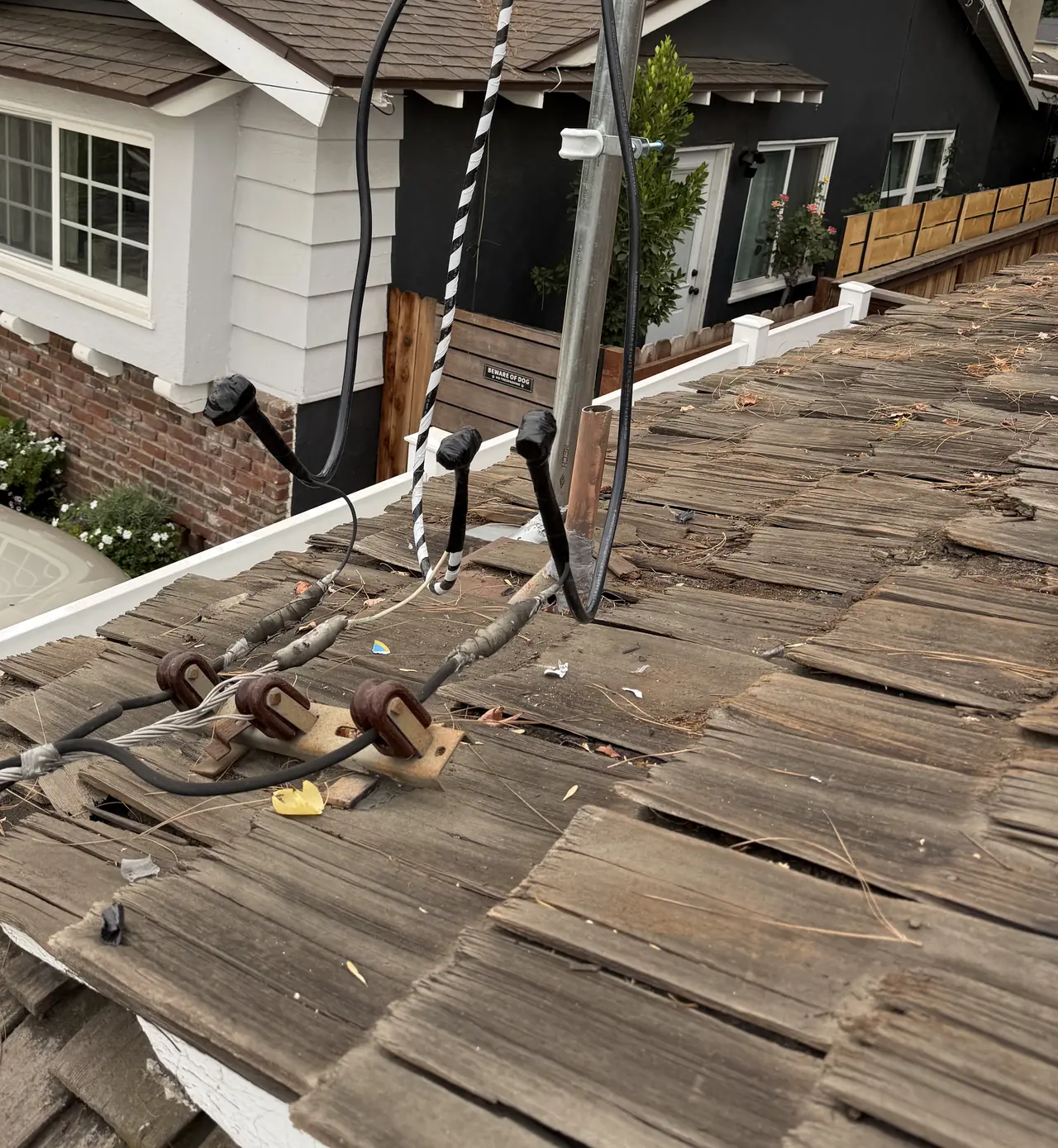

One attachment point. Everything an array does in a windstorm passes through thirty of these.

Here is why that stops a crew. An array is a structural attachment. For the next twenty years it carries wind uplift into the frame of the house, and every one of those loads goes through the fasteners. A bolt that does not reach the framing is not a compromise, it is a defect that nobody will see until the weather finds it. There is no version of this job where you use what is in the van and write it up afterwards.

So we reported it the same morning, and then the project stalled somewhere else entirely.

The company holding the job could not find the bolts. Not through the electrical distributor that had supplied the rest of the material, and not through any trade channel it tried. It asked us for suggestions, and within a few hours we sent a specific listing for the exact part in the exact quantity. Two weeks later the project manager was still asking whether anyone had found them. In the end the operations manager bought the very listing we had sent, from a consumer marketplace, because no supplier had the part.

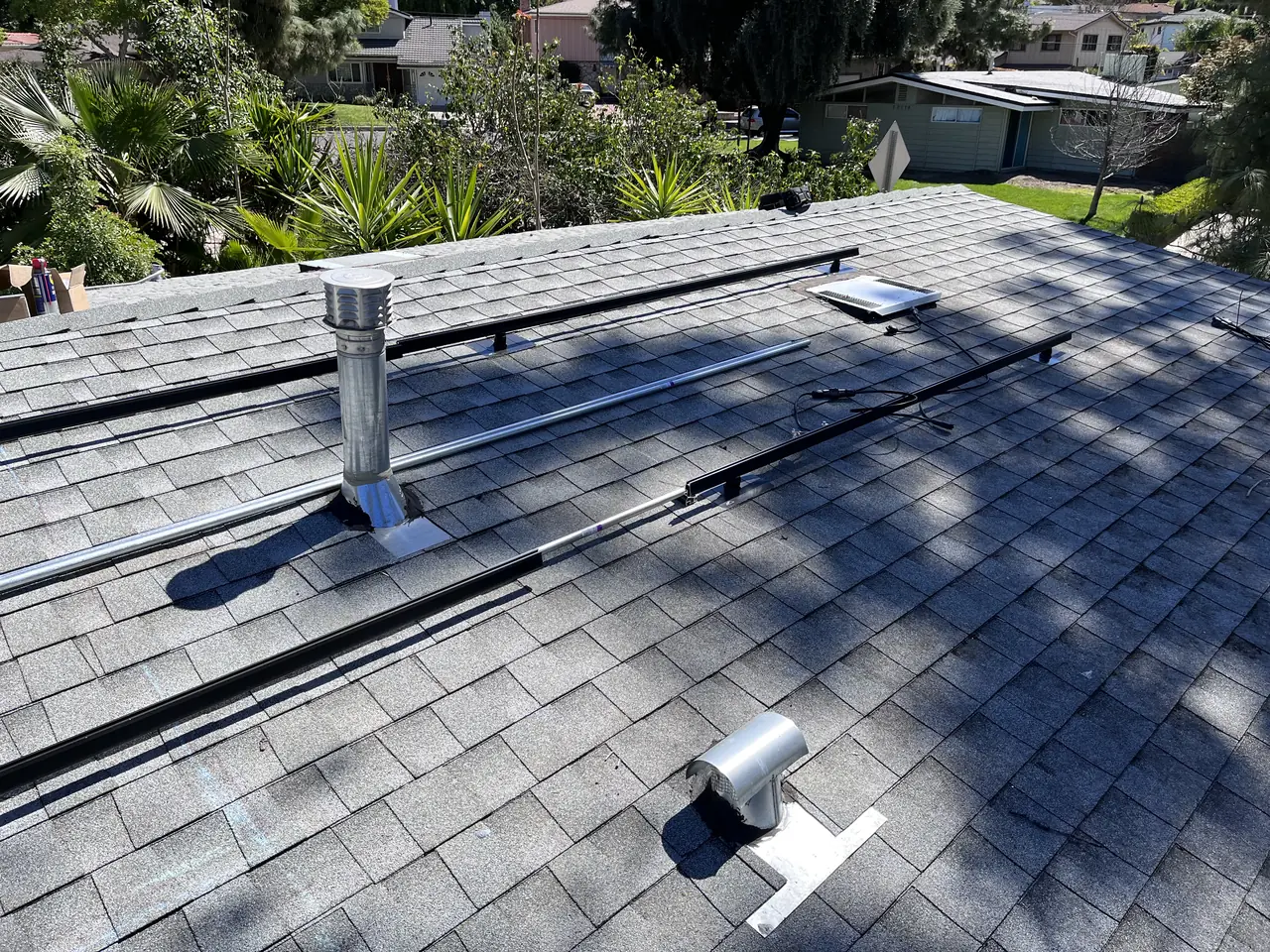

A mounting standoff and rail set on the shingle roof with the conduit run beside it, Woodland Hills
The attachment as it was finally built, once the hardware that reached the framing was on site.

Then the tracking put delivery somewhere between the ninth and the fourteenth of March, and rather than send a crew that might be turned away a second time, the decision was taken to wait. The bolts landed on the seventh. The crew was booked for the eighth.

And on that same day a third firm, brought in to redraw the plans, issued a revised set with a changed layout.

The homeowner, entirely correctly, refused to let anyone resume work on a drawing that had not been stamped again by Building and Safety. Our answer to that was one line: then we will wait for the stamps. It is the only answer. A stamped drawing is what the inspector measures the installation against, and a crew that works ahead of one is building something that may have to come apart.

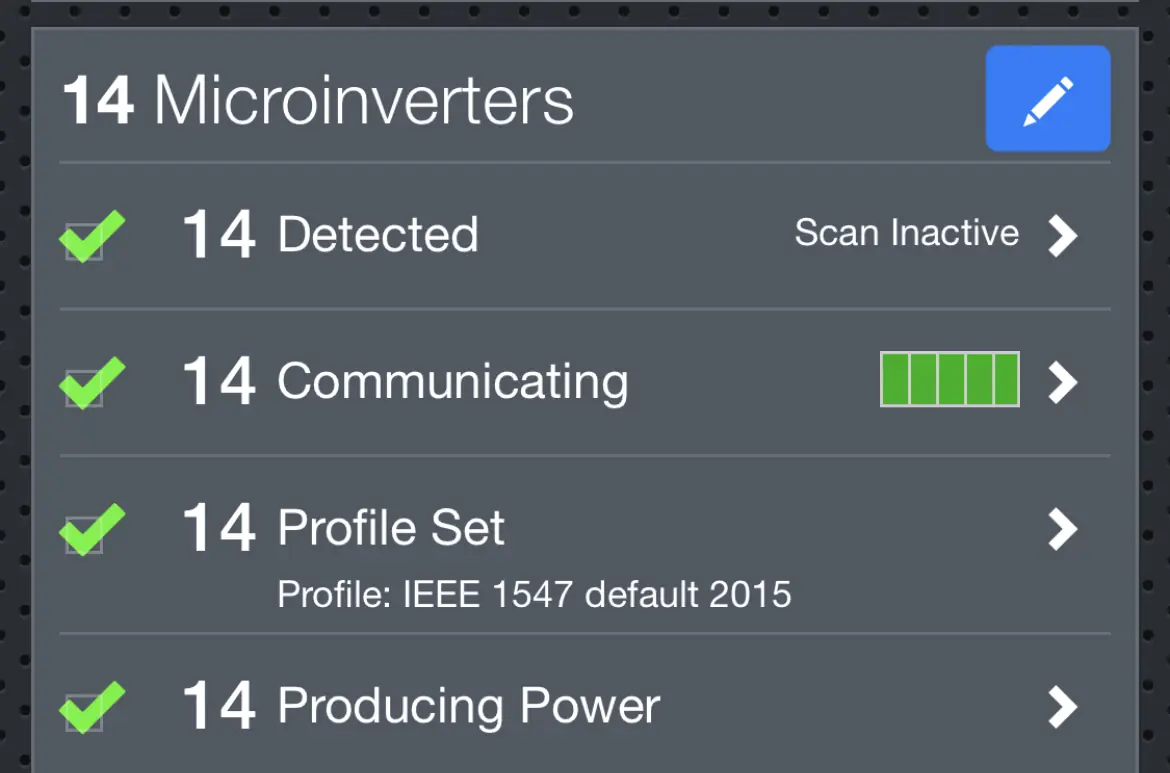

A monitoring screen showing fourteen microinverters detected, communicating and producing power, Woodland Hills
Fourteen of fourteen, reporting. Two days of work, and the rest of it was waiting well.

Work resumed on the eleventh, the final inspection passed on the sixteenth, and the completion photographs were handed over two days later.

There is something here a homeowner cannot see from the ground. On a job that several companies share, almost everything is decided before the crew arrives: who specified the hardware, who sourced it, who drew the layout, who stamped it. What the crew on the roof controls is a single decision, taken twice on this project, and it is whether to carry on anyway. Ask about that decision before you sign anything.

How it ran

19 January 2022Job handed over with plans, permit approval and the full specification; installation date requested
20 January 2022Installation put on hold; materials not ready
27 January 2022Request reopened; date agreed for mid-February with a week's notice for materials
14 February 2022Installation day. Work stopped: framing about seven feet apart and the supplied hardware far too short
14 February 2022Exact fastener and quantity specified the same day; a specific source sent within hours
28 February 2022Two weeks on, the part is still unsourced through trade channels
7 March 2022Bolts delivered after being bought from a consumer marketplace
8 March 2022Revised plans issued with a changed layout on the day work was to resume
9 March 2022Homeowner declines to proceed on an unstamped drawing; we agree to wait for the stamps
11 March 2022Installation resumes
16 March 2022Final inspection passed
18 March 2022Completion photographs handed over and the job closed

The physical work on this project was two days. Everything else was waiting for a part and for an approved drawing.

What we did

  • Stopped work on the installation day rather than fastening an array with hardware that could not reach the framing (C-10).
  • Identified the exact fastener, diameter, length and quantity within the same morning.
  • Sent a specific source for the part within hours, when it could not be found through the usual trade channels.
  • Declined to substitute an available fastener for the one the attachment required.
  • Agreed to wait for a re-stamped drawing rather than resuming work on a revised layout that had not been approved.
  • Completed the installation in two days once the correct hardware and approved drawings were in place, and passed the final inspection.

System specifications

System size4.76 kW DC
Modules14 × Q CELLS Q.PEAK DUO BLK-G6, 340 W, all black
Inverters14 × Enphase IQ7+ microinverters, one per module
RoofComposition shingle
Framing spacingAbout seven feet between members
FastenersThirty bolts, 5/16 inch by 10 inches
PermitHeld by the company running the project; revised plans re-stamped before work resumed
BatteryNone

Is your project like this one?

  • Your project has stalled and nobody can tell you which company is waiting on what.
  • Your roof framing is spaced unusually and standard hardware may not reach.
  • Your installer wants to proceed on drawings that have been revised but not re-stamped.
  • Your installation date keeps moving and nobody will tell you what it is waiting on.
  • Your Woodland Hills property is served by LADWP, while permits are handled by LADBS.

Cali Energy in Woodland Hills

Woodland Hills is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

Woodland Hills is inside the City of Los Angeles, so the drawings are stamped by LADBS and the installation is inspected against them. A stamp is not a formality on a roof like this one, where the attachment depends on reaching framing that is further apart than usual.

This installation is on the Woodland Hills projects page alongside the others, and what the work covers is set out on the Woodland Hills service area page.

Frequently asked questions

Why does fastener length matter so much on a solar installation?

Because the array is a structural attachment. For twenty years it transfers wind uplift from the modules into the frame of the house, and every one of those loads passes through the fasteners. A bolt that stops short of the framing holds in the deck alone, which is not what the calculation assumed. Nothing about it looks wrong from the ground until the weather finds it.

What should a crew do if the supplied materials are wrong?

Stop, and say exactly what is needed. The useful version of stopping is specific: the part, the dimension, the quantity, sent the same day, with a source if one can be found. What is not acceptable is substituting whatever is in the van and writing it up afterwards. On this project the crew stopped within an hour and the correct part was named the same morning.

Can work continue on revised plans that have not been re-stamped?

No, and a homeowner who refuses is protecting himself correctly. The stamped drawing is what the inspector measures the installation against. Building to a revision that has not been approved risks a failed final and work that has to come apart. Waiting for the stamp is slower and it is the only answer that ends with a passed inspection.

What changes when the installer is a subcontractor?

Most of the decisions move away from the roof. Another company specifies the hardware, orders the materials, holds the permit and talks to you. The installing crew controls one thing, which is whether to proceed with what it has been given. If you are buying through a company that subcontracts, ask who the installer is and what happens when they find a problem.

Does Cali Energy install in Woodland Hills?

Yes, across both Woodland Hills ZIP codes. On this Woodland Hills roof Cali Energy installed fourteen modules and fourteen microinverters, stopped the work when the supplied fasteners could not reach the framing, specified the exact part, and waited for a re-stamped drawing before resuming. The final passed on the first inspection. California contractor license number 1032379.

What this would look like on your roof

Every number above came off a real job in Woodland Hills, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.
