Woodland Hills, CA · April – June 2022 · LADWP / LADBS

Forty-four modules, and one more permit before anyone could inspect.

Nearly fifteen kilowatts on one Woodland Hills house, and two things to take from it: the permit nobody had opened, and the reason the monitoring showed nothing after permission to operate arrived.

On a large residential array the main service panel usually has to be derated, meaning the main breaker is replaced with a smaller one so the code limit on backfeed is satisfied without replacing the panel. That is electrical work and it needs its own permit, which has to exist before the final inspection rather than after it. Missing it does not delay the array; it delays the inspection that releases everything downstream. On this Woodland Hills array Cali Energy caught it two days before the final and had an express permit opened in time.

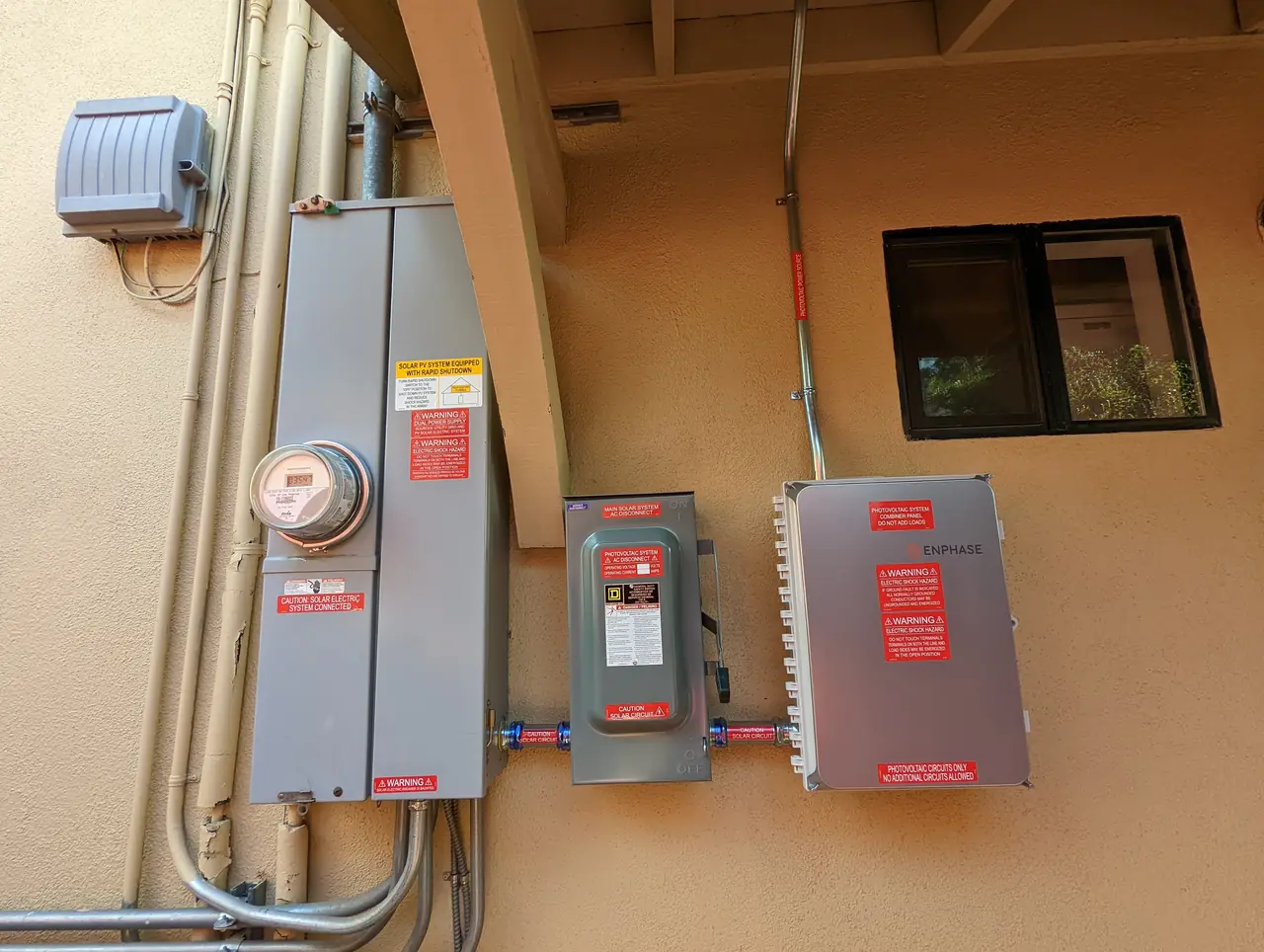

A meter, an alternating current disconnect and a combiner enclosure mounted in a row along a stucco wall, Woodland Hills
Where a forty-four module array lands. Everything difficult about this project happened on this wall.

At a glance

System size
14.96 kW DC
Modules
44 × Q CELLS Q.PEAK DUO BLK-G6 340 W
Inverters
44 × Enphase IQ7Plus microinverters
Material check
Confirmed two days before the crew arrived
Service work
Main panel derate, on its own express permit
Battery
None
Final inspection
Passed on the first visit
Utility / AHJ
LADWP / LADBS

The story

Forty-four modules and forty-four microinverters, just under fifteen kilowatts, on a house whose roof had been replaced three months earlier. We were the installing contractor; another company held the customer, the design and the materials.

The first friction was mundane, and it happens on a large share of shared work. Two days before the installation date, the only thing on site was the panels. No racking, no microinverters, no balance of system. Asking early is the difference between a crew that starts on time and a crew that stands in a driveway, and the answer came back the same day with the rest of the delivery arriving the following morning.

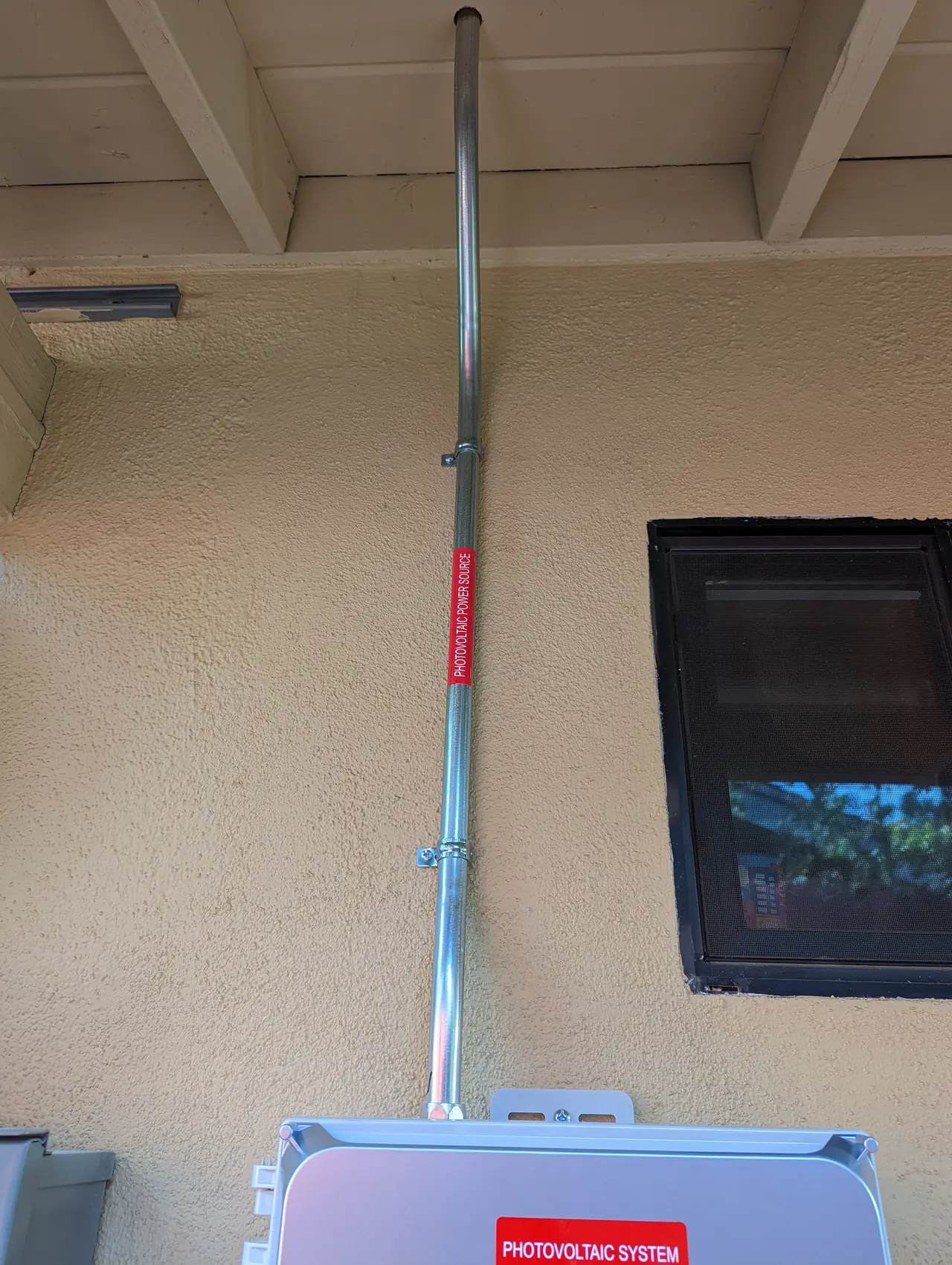

Conduit from the roof brought down along the underside of the eave, Woodland Hills
The run down from the roof. A forty-four module array has to land somewhere, and that somewhere has limits.

The second friction is the expensive one.

An array this size pushes a large current into the main service panel, and the code limits how much can be fed into a busbar from both ends at once. There are two legitimate answers. Replace the panel, which is expensive and slow. Or derate it, meaning fit a smaller main breaker so the arithmetic works with the panel already there. This project took the second route, which is usually the right one.

What it also needs is a permit. A derate changes the service equipment, and changing service equipment is permitted work with an inspection attached. Two days before the final we told the company holding the project that a derate permit had to be opened, that the express route existed, and that without it the inspection could not be booked. It was opened, the inspection went ahead, and the final passed on the first visit.

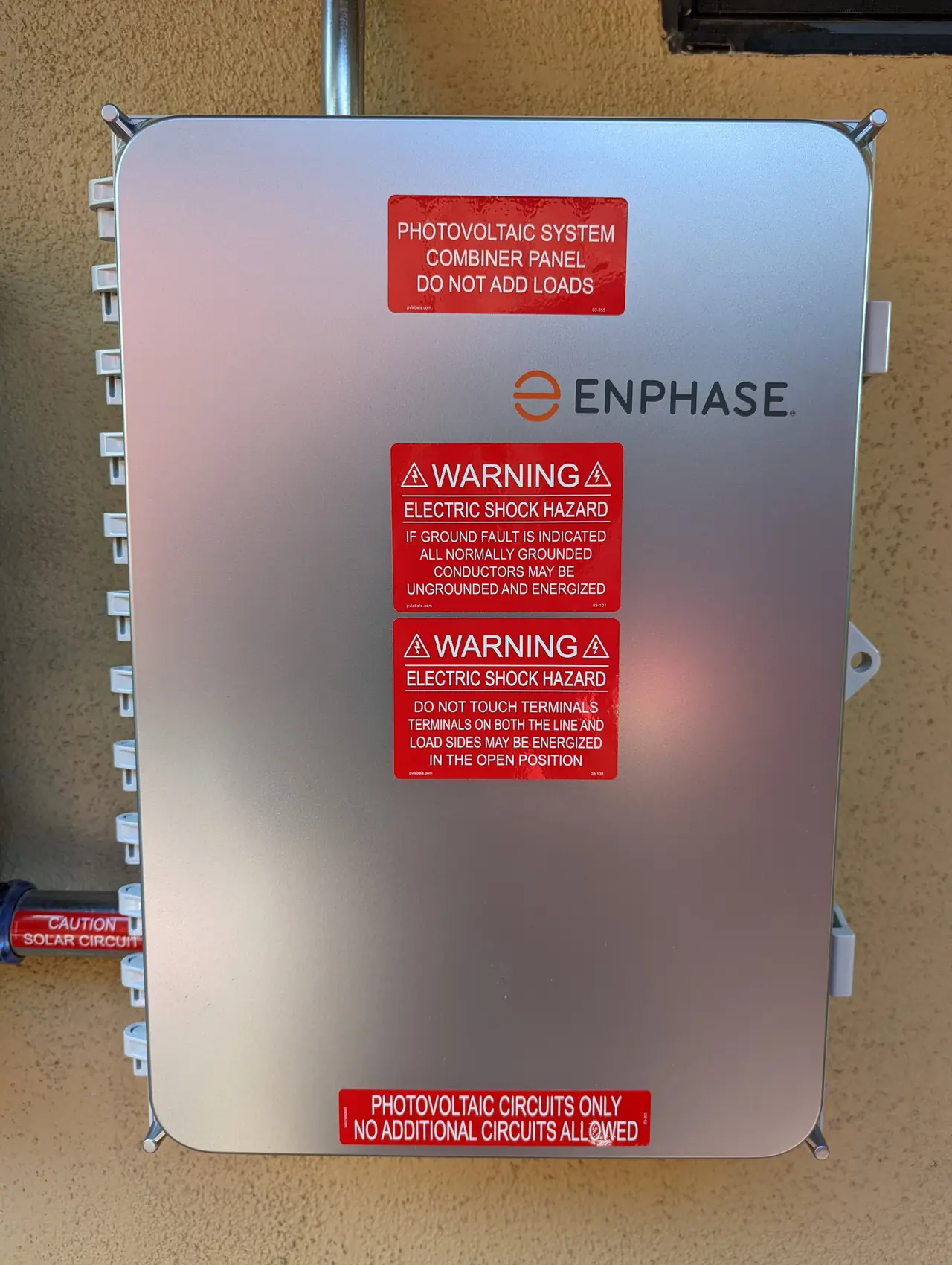

A closed Enphase combiner enclosure with warning labels mounted on the exterior wall, Woodland Hills
The combiner. Forty-four microinverters come back to this box.

Then the third thing, which is the most useful of the three because it costs nothing and confuses everyone.

In early June, after permission to operate had been granted, a monitoring account was set up and the gateway was reported as not reporting. That reads like a fault. It was not one. Permission to operate means the utility has authorized the system; it does not mean anybody has switched it on. The disconnects at the house are still where the installer left them, which is off, until someone closes them. The answer was one line: the permission came through a couple of days ago, so the customer needs to turn the system on.

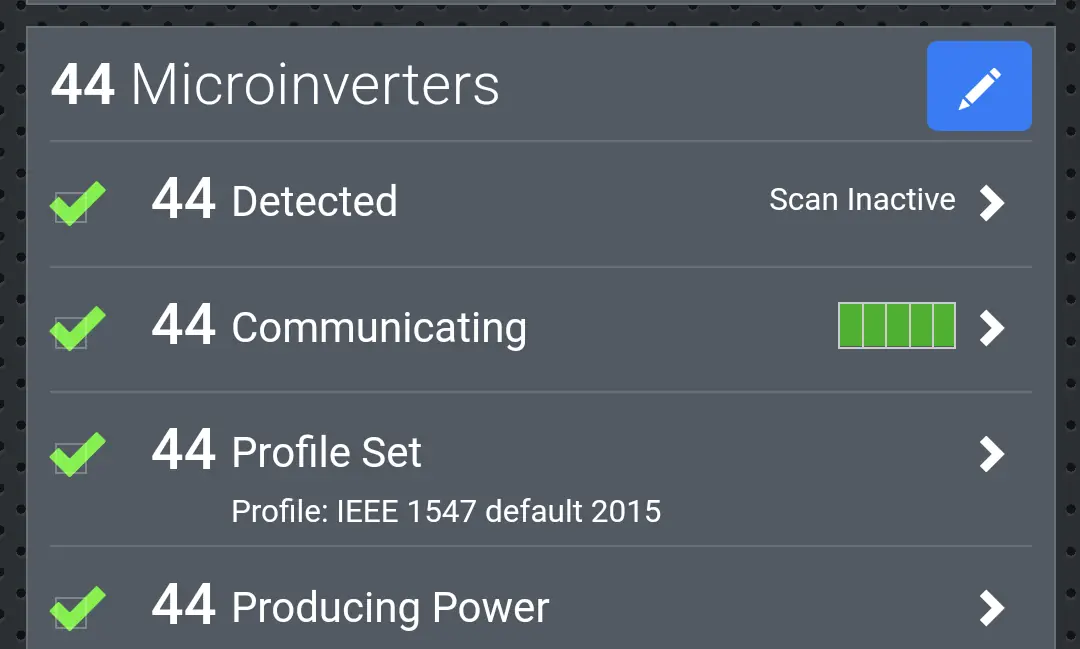

A monitoring screen showing forty-four microinverters detected, communicating and producing power, Woodland Hills
Forty-four of forty-four at commissioning on installation day. Everything on the roof was finished long before the paperwork was.

Three practical things to carry away. On any array approaching the size of the service, ask whether the design derates the panel or replaces it, and if it derates, ask when the permit for that will be opened. Confirm materials on site two days before the crew arrives rather than on the morning. And after permission to operate, someone has to physically close the disconnects, because a portal showing nothing is not evidence of a problem until that has been done.

How it ran

13 April 2022Installation date requested and agreed for the twentieth
18 April 2022Only the modules are on site; the rest of the materials confirmed for the next morning
19 April 2022Derate permit identified as missing; express permit requested so the final can be booked
19 April 2022City accepts the inspection request; final set for the twenty-first
20 April 2022Installation
22 April 2022Final inspection passed; completion photographs handed over
Early June 2022Permission to operate granted
8 June 2022Monitoring reported as silent; the cause is that the system has not been switched on at the house

The derate permit was the only item on this project's critical path. Nothing else on the job had to wait for anything.

What we did

  • Installed forty-four modules and forty-four microinverters in a single day (C-10).
  • Checked the material delivery two days out and flagged that only the modules had arrived, in time for the rest to be delivered before the crew.
  • Identified that the main panel derate needed its own permit before the final inspection could be booked, and specified the express route.
  • Passed the city's final inspection on the first visit and handed over the completion photographs.
  • Diagnosed the silent monitoring after permission to operate as a system that had never been switched on, rather than dispatching anyone.

System specifications

System size14.96 kW DC
Modules44 × Q CELLS Q.PEAK DUO BLK-G6, 340 W, all black
Inverters44 × Enphase IQ7Plus microinverters, one per module
Service workMain service panel derated rather than replaced
PermitsSolar permit plus a separate express derate permit
RoofReplaced three months before the installation
BatteryNone
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your array is large relative to your existing service panel.
  • You have been told your main breaker will be derated rather than the panel replaced.
  • Your final inspection is booked and you are not sure every permit is open.
  • Your monitoring shows nothing after permission to operate arrived.
  • Your Woodland Hills property is served by LADWP, while permits are handled by LADBS.

Cali Energy in Woodland Hills

Woodland Hills is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

On a large residential array in this part of Los Angeles the constraint is almost never the roof. It is the service panel the array has to feed into, and what the code allows to be pushed into it. LADBS inspects that; LADWP interconnects it.

This installation is on the Woodland Hills projects page alongside the others, and what the work covers is set out on the Woodland Hills service area page.

Frequently asked questions

What is a main panel derate and why would I need one?

It means replacing the main breaker with a smaller one so that the combined supply into the busbar stays within what the code allows. It is the alternative to replacing the whole service panel, and on a large array it is usually the cheaper and faster answer. It suits a house whose real demand sits comfortably below the original breaker rating, which is most houses.

Does a derate need its own permit?

Yes. It changes the service equipment, so it is electrical work with an inspection attached, and the permit has to be open before the final inspection is booked rather than afterwards. An express permit is the quick route and can be turned around in a day or two. Missing it does not delay the array; it delays the inspection that releases everything after it.

My system has permission to operate but the monitoring shows nothing. What is wrong?

In most cases nothing. Permission to operate is the utility authorizing the system, not anybody switching it on. The disconnects at the house are left open until somebody closes them, and until then the array generates nothing and the gateway has nothing to report. Check the disconnects before you report a fault, because this is the single most common false alarm after a new installation.

How early should materials be confirmed before an installation?

Two days, at least, and item by item rather than as a single yes. On this project the modules were on site and nothing else was, which was caught with time to fix it. A crew that arrives to a partial delivery loses the day, and on a shared job nobody on site has the authority to source the missing parts.

Does Cali Energy install large residential arrays in Woodland Hills?

Yes, including this forty-four module system at just under fifteen kilowatts. On arrays of that size the work that decides the schedule is the service side: whether the panel is derated or replaced, and whether the permit for it exists before the inspection is booked. Cali Energy holds California contractor license number 1032379.

What this would look like on your roof

Every number above came off a real job in Woodland Hills, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
