Panorama City, CA · December 2024 · LADWP / LADBS

Two meters on one Panorama City wall. One roof, and one day on it.

Four hundred watt modules, a microinverter under each, and a shingle roof that went from chalk lines to a finished array inside a single working day. The photographs carry their own timestamps, and they tell the day in order.

An ordinary residential array on composition shingle is a one-day job when the design is settled before the crew arrives and the property's electrical questions have already been answered. On this Panorama City property, in the north end of the City of Los Angeles, two separate services share one exterior wall, so the first decision was which one the array would feed. Cali Energy set the flashings and standoffs, ran the conduit, mounted the microinverters and laid the modules between eight in the morning and last light, with the roof penetrations flashed rather than sealed with compound alone.

Black solar modules set across a brown composition shingle roof at the end of the day, with a work vehicle in the driveway below, Panorama City
The end of the day. Everything above the shingle went on between breakfast and last light.

At a glance

Modules
Hyundai HiS-S400YH(BK), 400 W, all black
Microinverters
Enphase IQ8M, one per module
Roof
Composition shingle, two planes
Attachment
Flashed standoffs; no compound-only penetrations
Services on the property
Two, on one exterior wall
Battery
None
Work on site
One day
Utility / AHJ
LADWP / LADBS

The story

The crew was on the property at two minutes past eight, and the first photographs of the morning are not of the roof. They are of the wall.

Two services sit side by side here, each with its own meter and its own enclosure, the way a great many properties in this part of the Valley were built. On a job like this the question that has to be settled before anything goes on the roof is which service the array lands behind, because that decides the breaker, the conduit route and which account the production is credited to. Getting it wrong is not a correction. It is a rebuild.

Two meter enclosures and a closed Enphase combiner panel mounted in a row along a stucco wall under a soffit, Panorama City
Two services on one wall, with the solar combiner on the right. Which of the two an array lands behind is a drawing-board decision, not a field one.

By mid-morning the electrical was done and the crew moved up. The chalk lines were already on the shingle: the array outline and the rail positions, snapped before a single hole was drilled, which is how you find out that a layout does not fit while it still costs nothing to change.

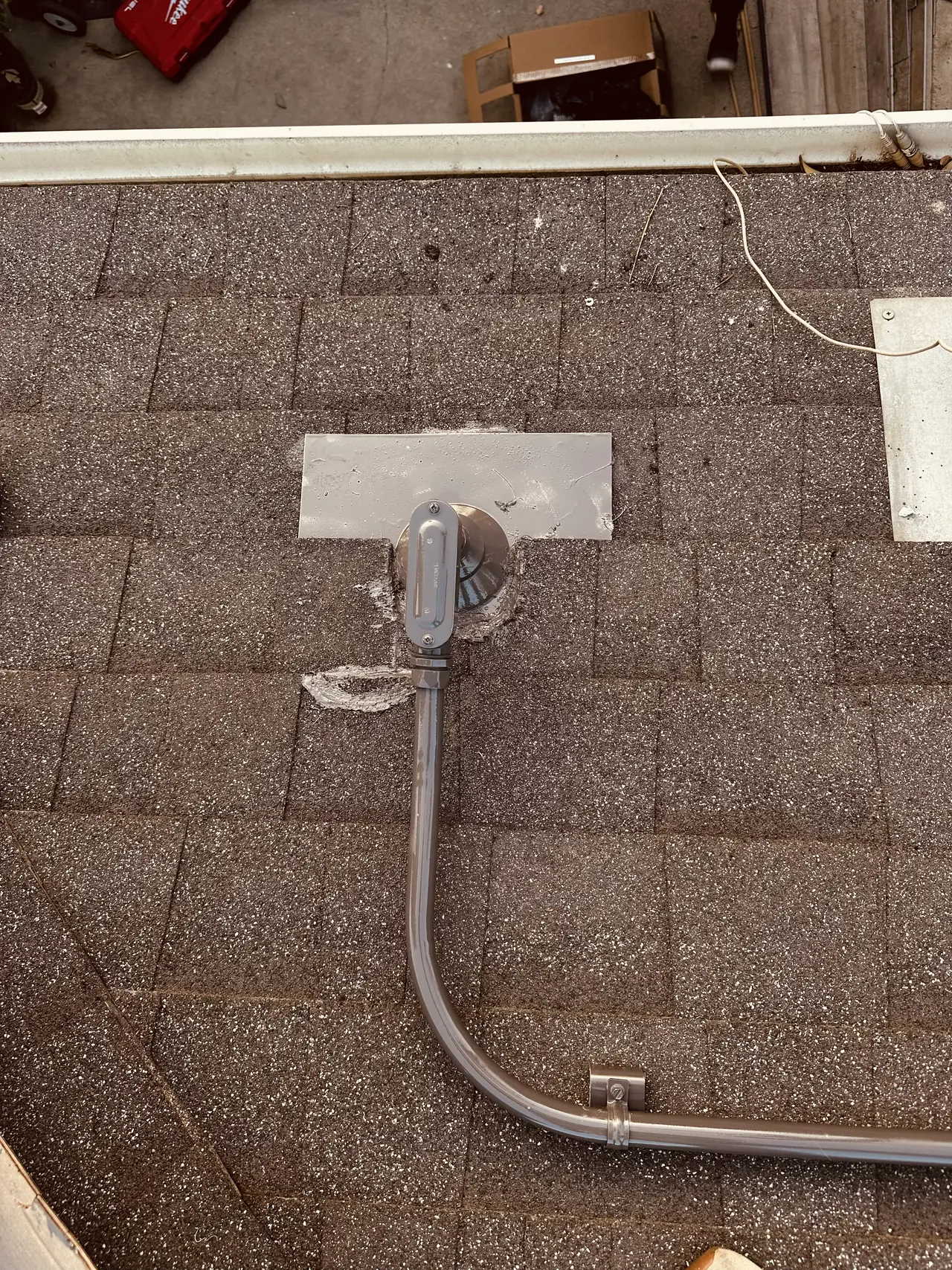

A conduit penetration through composition shingle with a metal flashing plate slipped under the course above it, Panorama City
The penetration that matters most. The flashing goes under the course above, so water runs over the plate rather than into the hole.

Look closely at that detail if you are deciding between installers. A penetration through a shingle roof can be done two ways. It can be drilled and filled with sealant, which works until the sealant ages, or the course above can be lifted and a flashing plate slid underneath so the water is carried over the top of the opening by the roof itself. The second way takes a few minutes longer per hole. It is the only one that is still working in fifteen years.

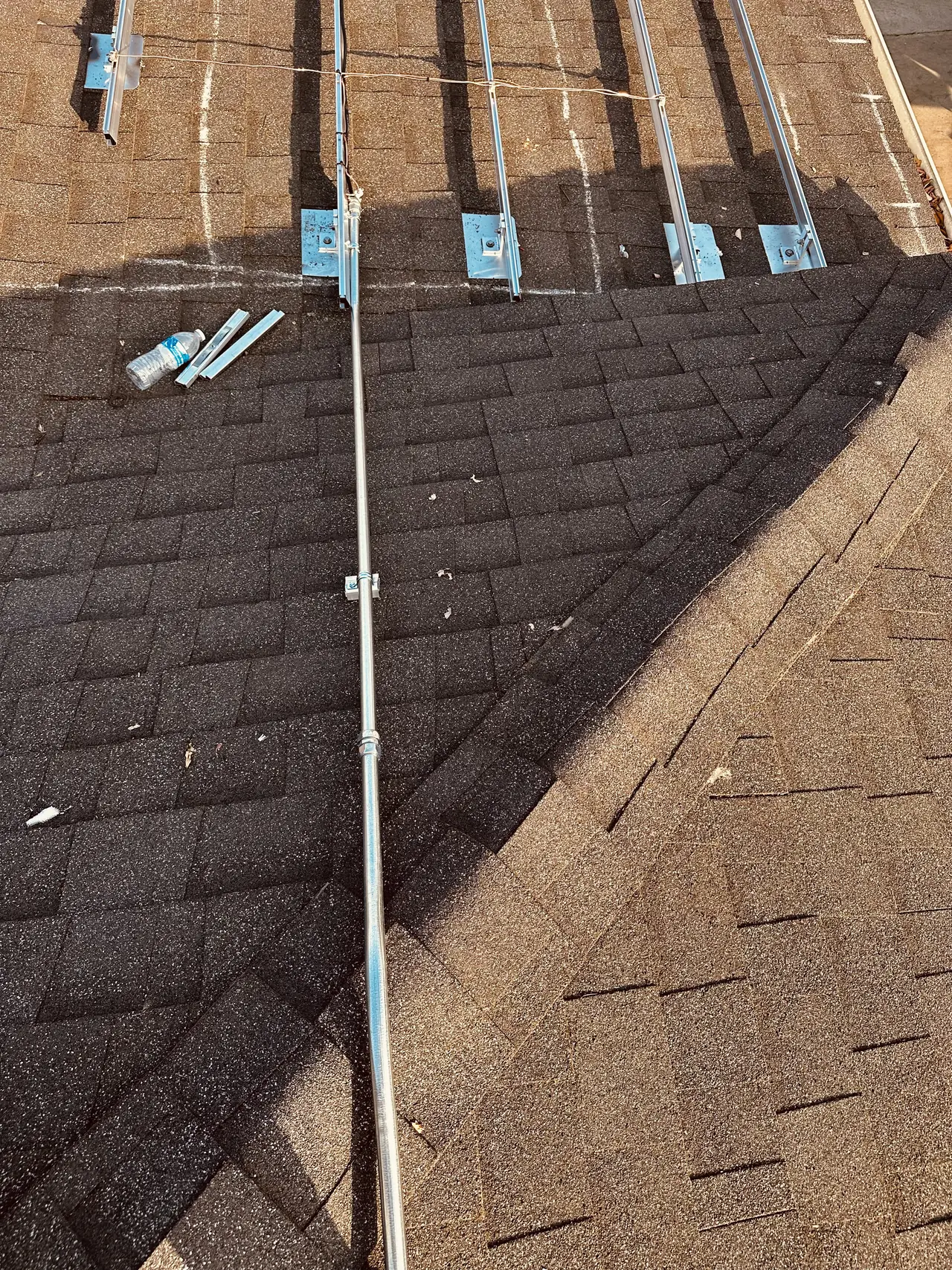

Aluminum standoffs and rails laid out across a brown composition shingle roof with the conduit run beside them, Panorama City
Standoffs and rails, set to the lines snapped that morning. Nothing on this roof is screwed straight through the shingle.

The modules are four hundred watt all-black units with a microinverter under each one. A microinverter under every module means the array has no string voltage to manage, each module is measured on its own, and the shading of one does not drag its neighbors down with it. It also means the rapid shutdown the code requires is built into the hardware rather than added as a separate device.

One number on the module label is worth carrying away. These modules open at about forty-five volts and are rated for a fifteen hundred volt system, which is a figure that matters enormously on a string inverter and not at all here. The microinverter under each module accepts a direct-current input between sixteen and fifty-eight volts, which is one module and no more. Nothing on this roof ever sits at a voltage that could not be handled by hand, and that is a safety property of the design rather than of the crew.

The second thing the labels give you is the ratio. Four hundred watts of module feeding a microinverter rated at three hundred and twenty-five volt-amperes continuous is deliberate, not a mismatch. Modules almost never reach their rated output in the real world, so the direct-current side is sized above the alternating-current side on purpose; the array spends more of the day at the microinverter's best operating point, and the handful of hours a year it would have exceeded it are cheaper to give up than to buy hardware for.

The modules went down through the afternoon. By five the array was complete on both planes, every module connected to the microinverter under it and the whole run closed back into the combiner on the wall. The crew walked the roof once more after dark, checking every attachment and every clamp, and left nothing on the property to come back for.

One day on site, from a bare roof to a finished array. That is what an ordinary residential job looks like when the design is settled first, and it is the reason the projects that run long almost never lose their time on the roof.

How it ran

8:02Crew on site; the existing services on the wall photographed before anything is touched
10:45Electrical work at the wall complete
13:20Microinverters checked and staged on the roof
15:15Flashings and standoffs set to the lines snapped that morning; rails run on both planes
16:15Conduit complete; the first modules set
16:25Module and equipment labels photographed and checked against the design
17:05Array complete on both planes and connected
18:02Last walk of the roof, after dark

Start to finish inside one visit, with no second trip for anything.

What we did

  • Settled which of the property's two services the array would land behind before the design was drawn (C-10).
  • Snapped the array outline and rail positions on the shingle before drilling a single hole.
  • Flashed every roof penetration under the course above rather than sealing it with compound.
  • Installed four hundred watt modules with a microinverter under each, so rapid shutdown is in the hardware and no module is measured as part of a string.
  • Completed the installation inside one working day.

System specifications

ModulesHyundai Energy Solutions HiS-S400YH(BK), 400 W, all black
Module electrical45.3 V open circuit, 11.25 A short circuit, 1500 V system
MicroinvertersEnphase IQ8M, 325 VA continuous at 240 V, one per module
Rapid shutdownModule-level, built into the microinverter
RoofComposition shingle
AttachmentFlashed standoffs with the flashing under the course above
BatteryNone
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your lot has two dwellings and two meters and you do not know which one solar should feed.
  • You want to know how a solar installer makes holes in a shingle roof.
  • You have been offered a string inverter and a microinverter system and want the difference in plain terms.
  • Your roof is composition shingle and you are wondering how long the work takes.
  • Your Panorama City property is served by LADWP, while permits are handled by LADBS.

Cali Energy in Panorama City

Panorama City is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

A great deal of the housing here was built as pairs: two dwellings on one lot, two services on one wall, two accounts with the utility. It changes almost nothing about how an array is built and almost everything about which meter it has to land behind, which is a question to settle before the design is drawn rather than on the day.

Frequently asked questions

Which meter should solar connect to on a property with two services?

The one belonging to the dwelling whose consumption the system is sized against. Production is credited to the account behind the meter the array feeds, so an array sized for one unit and connected to the other will not offset what it was bought to offset. This is a design decision, not a field decision, and it has to be settled before the drawings are stamped.

How should a solar penetration through a shingle roof be made?

With a flashing plate slipped under the course above the hole, so the roof itself carries water over the opening. A penetration sealed with compound alone depends on the sealant lasting as long as the array, which it does not. Every penetration on this roof was flashed.

What does a microinverter under each module change?

Three things. There is no high-voltage string on the roof, each module is measured and reported on its own, and the rapid shutdown the electrical code requires is built into the device rather than added separately. The trade is more hardware on the roof and a higher up-front cost.

Can a residential array really be installed in one day?

An ordinary one, yes, when the design is settled and the materials are on site. The projects that take weeks lose their time to permits, corrections and interconnection reviews, not to the work itself. This array went from a bare roof to complete between eight in the morning and last light.

Does Cali Energy install on shingle roofs in Panorama City?

Yes, and shingle is the most common roof in this neighborhood. On this Panorama City property Cali Energy set flashed standoffs, ran the conduit, mounted Enphase IQ8M microinverters and completed the array in a single day. California contractor license number 1032379.

What this would look like on your roof

Every number above came off a real job in Panorama City, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.
