Los Feliz, CA · March 2022 · LADWP / LADBS

Los Feliz: nine days on a standard plan.

Asked for a date on Wednesday. On the roof on Thursday. Passed the final the following Friday.

A standard plan is a pre-approved drawing set for solar installations that fall inside defined limits — ordinary roof types, ordinary equipment, ordinary connection. A project built to one does not wait for a plan check to examine it from scratch, which removes the longest step in the permitting half of the job. On this Los Feliz project Cali Energy installed the array the day after it was scheduled and passed the final inspection nine days after the file opened.

A solar module mounted on a composition shingle roof beside a stucco wall, Los Feliz, Los Angeles
On the roof the morning after the date was agreed.

At a glance

Scheduled to installed
One day
File opened to passed final
Nine days
Drawings
Standard plan set
Materials
Collected rather than waited for
Utility / AHJ
LADWP / LADBS

The story

On a Wednesday morning the request was simply for a date. Drawings and pricing were attached, the project was ready, and the only open question was when a crew could go.

The array went on the following morning. The final inspection was booked the day after that and passed nine days after the file opened.

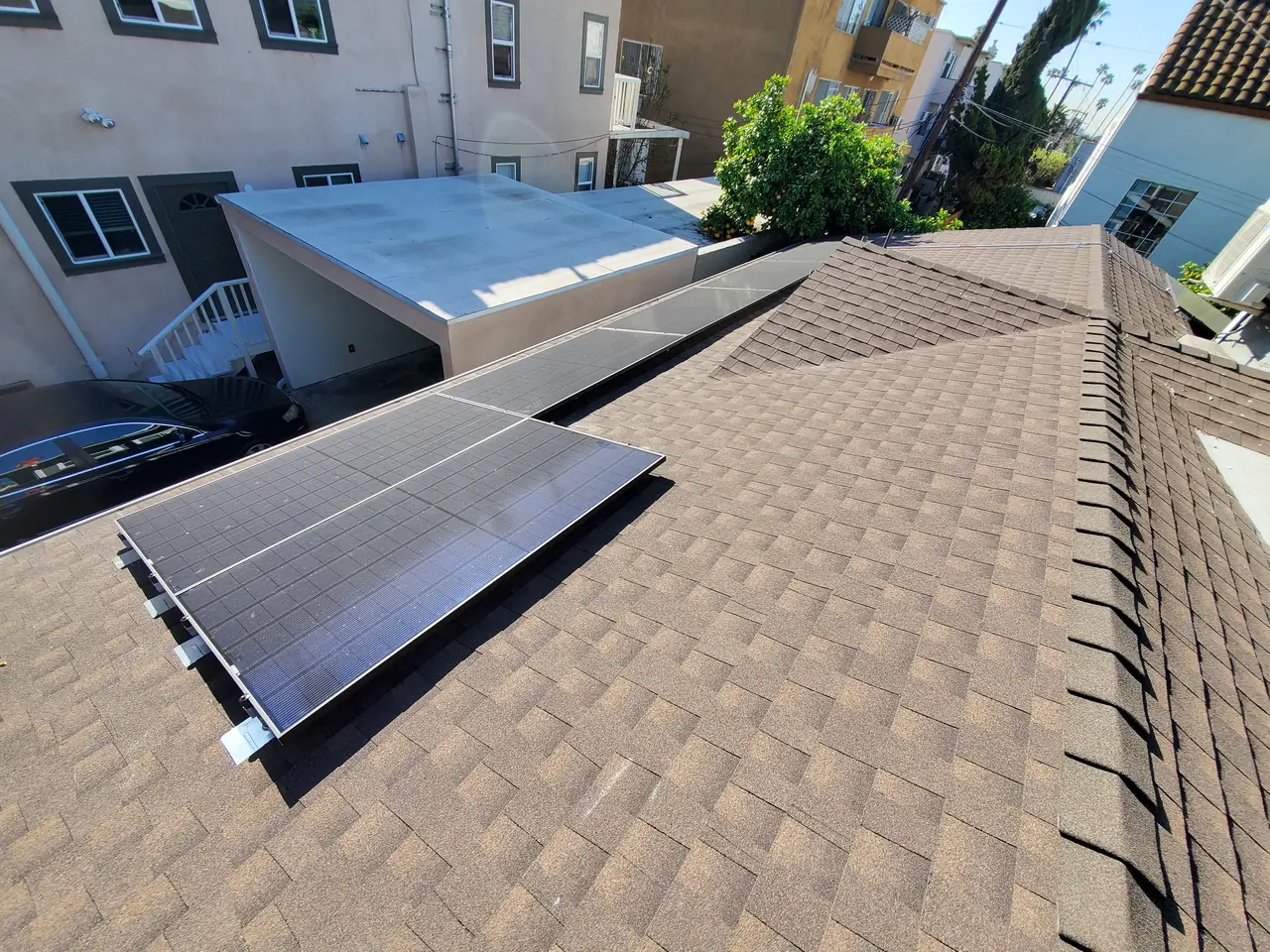

Solar modules on a hipped composition shingle roof with neighboring buildings behind, Los Feliz, Los Angeles
A standard plan is checked against a template rather than examined from scratch.

Two things made that possible, and one of them is worth a page of its own.

The drawings were a standard plan. A standard plan is a pre-approved set for solar installations that stay inside defined limits — a common roof type, listed equipment within stated ratings, a connection method the department has already accepted. Rather than submitting a bespoke design and waiting for an engineer to examine it from scratch, a project built to the standard set is checked against a template that has already been approved.

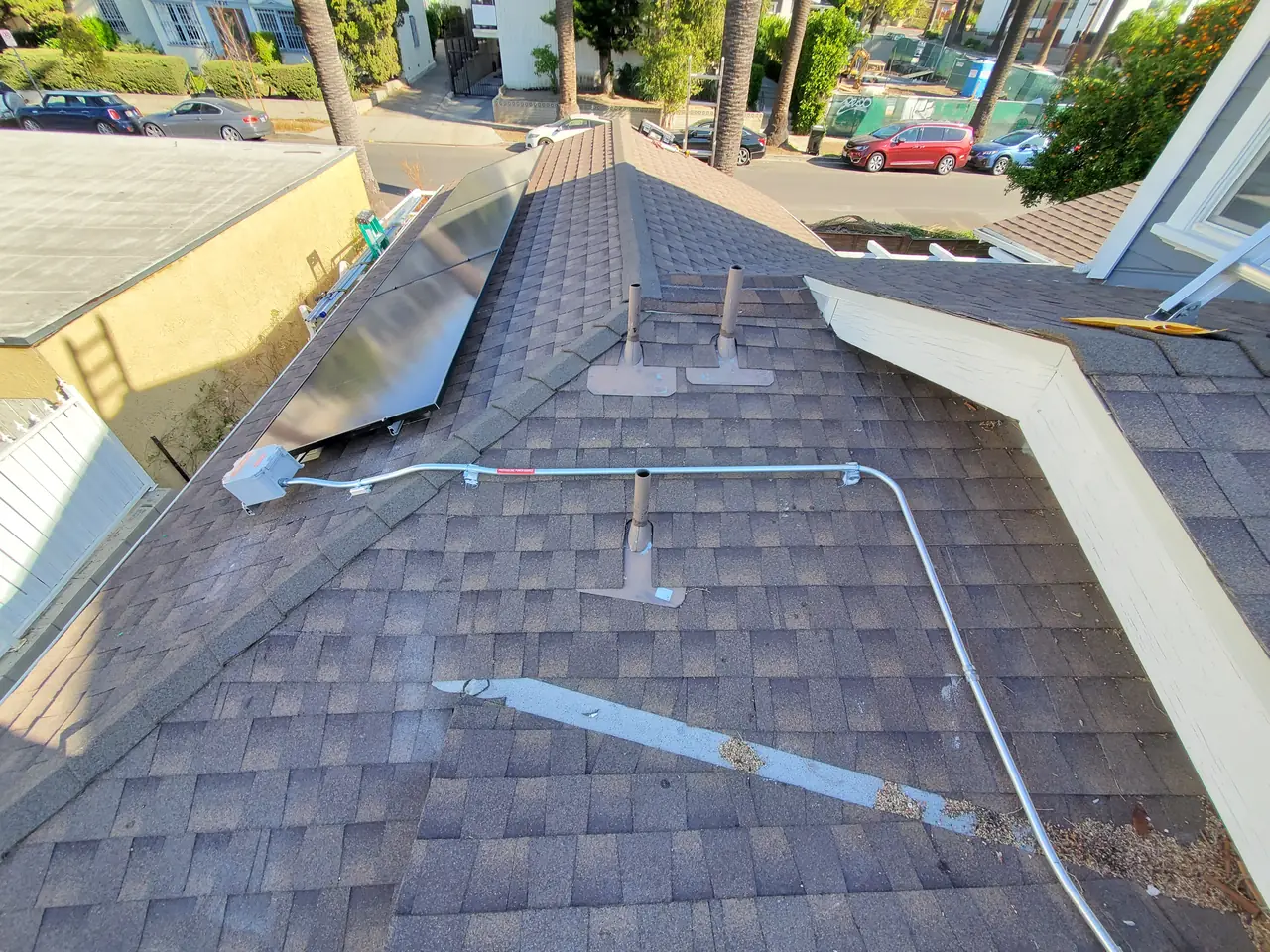

A conduit run fixed along a shingle roof ridge above a street, Los Feliz, Los Angeles
Final inspection nine days after the file opened.

That removes the longest and least predictable step in the permitting half of the job. Plan check on a custom set is a queue with a person at the end of it; a standard plan skips the queue because the examination has already happened.

What it costs is flexibility. A standard plan only works while the project stays inside the envelope — the moment something unusual appears, a module that does not fit the listed parameters, a roof that is not one of the covered types, a connection that is not the standard one, the project leaves the template and goes back into ordinary plan check. That is not a failure; it is the trade. Straightforward projects move quickly precisely because they gave up the right to be unusual.

The second thing was small and made a day of difference. When the materials were being arranged there was a choice between having them delivered and collecting them from the counter. Delivery would have set the install on Friday. Collection meant Thursday. It was decided in one exchange within the hour, and the crew went a day earlier.

Most project delays are not made of big things. They are made of decisions like that one taken slowly.

One practical note about standard plans that catches people at the wrong moment. The inspector works against the approved document, so it has to be on site, on paper, on the day. On this project the file would not open the evening before the inspection; it was reissued and printed in time. Whoever is holding the drawings should open them the day before rather than at the gate.

Cali Energy installed and finaled this array in Los Feliz, Los Angeles, on a standard plan set.

How it ran

9 March 2022Date requested — drawings and pricing already in hand
9 March 2022Materials arranged for collection rather than delivery, bringing the install forward a day
10 March 2022Array installed
11 March 2022Final inspection booked for the eighteenth
17 March 2022Standard plan document reissued so it could be printed for the inspection
18 March 2022Final inspection passed

Nine days from an open file to a passed final, with the design already approved before anybody asked for a date.

What we did

  • Built the project to a pre-approved standard plan set.
  • Took the collection option so the crew could go a day earlier.
  • Installed the array the day after the date was agreed.
  • Booked the final the following day and passed it.
  • Reissued the plan document in time for it to be on site on paper.

System specifications

ArrayResidential rooftop
DrawingsPre-approved standard plan set
Plan checkChecked against the template rather than examined from scratch
MaterialsCollected the same day the date was agreed
Final inspectionNine days after the file opened
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You have been told a solar permit takes weeks and want to know why.
  • Your project is ordinary and the timeline you were quoted is not.
  • Somebody has said your design no longer fits the standard plan.
  • Your inspection is tomorrow and nobody can open the drawings.

Cali Energy in Los Feliz

Los Feliz is City of Los Angeles below Griffith Park, permitted through LADBS and interconnected through LADWP. A mix of hillside and flat blocks, and the kind of straightforward roof a standard plan is written for.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

What is a solar standard plan?

A pre-approved drawing set for installations that stay inside defined limits — a common roof type, listed equipment within stated ratings, a standard connection method. A project built to one is checked against a template that has already been approved rather than examined from scratch, which removes the longest step in permitting.

Why is a standard plan faster?

Because the examination has already happened. Plan check on a bespoke design is a queue with an engineer at the end of it, and the wait is the least predictable part of the whole job. A standard plan skips that queue entirely, which is how a project goes from an open file to a passed final inside two weeks.

When does a project fall out of the standard plan?

The moment something leaves the envelope: equipment outside the listed parameters, a roof type not covered, a connection method that is not the standard one. It is not a failure — it is the trade. Straightforward projects move quickly precisely because they gave up the right to be unusual.

Does the plan need to be on site for the inspection?

Yes, on paper, on the day. The inspector works against the approved document, and an inspection with no drawings to check against does not go ahead. Whoever holds the file should open it the day before rather than at the gate — on this Los Feliz project it had to be reissued the evening before.

Does Cali Energy install solar in Los Feliz, Los Angeles?

Yes. Los Feliz projects are permitted through LADBS and interconnected through LADWP. This one was built to a standard plan set and ran from an open file to a passed final in nine days, with the array on the roof the morning after the date was agreed.

What this would look like on your roof

Every number above came off a real job in Los Feliz, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
