Sun Valley, CA · March 2022 · LADWP / LADBS

Nine days from install to a passed final.

A 5.44 kW DC array with a 200-amp service panel upgrade in Sun Valley, on LADWP — permitted without plan check and finaled nine days after the crew came off the roof.

Under the LADBS process used for this project in 2022, a qualifying residential microinverter system received an express permit with no plan check.

New service equipment installed on an exterior wall, Sun Valley
The new service equipment, set and labeled.

At a glance

DC System
5.44 kW
Modules
16 × 340 W
Inverters
16 × Enphase IQ7+
Service Panel
Upgraded to 200 A
Roof
Composition shingle
Permit
Express, no plan check
Install → final
9 days
Utility / AHJ
LADWP / LADBS

The story

Permit issued in January without plan check. Installed in March. Final inspection passed nine days after the crew came off the roof.

Two separate things sit behind that calendar. The first is the permit route. Under the process LADBS used for this project in 2022, a roof-mounted microinverter system not exceeding ten kilowatts AC on a one- or two-family dwelling could be issued an express permit with no plan check at all. No drawings queued for review, no corrections, no waiting on an engineer. That is what put a permit in hand in January.

The second is what happened after the array was finished, and it is not the same thing. Plan check sits before installation, so skipping it does not shorten the gap between coming off the roof and passing the final. That gap — nine days here — is inspection scheduling, and it is worth reading as a separate number.

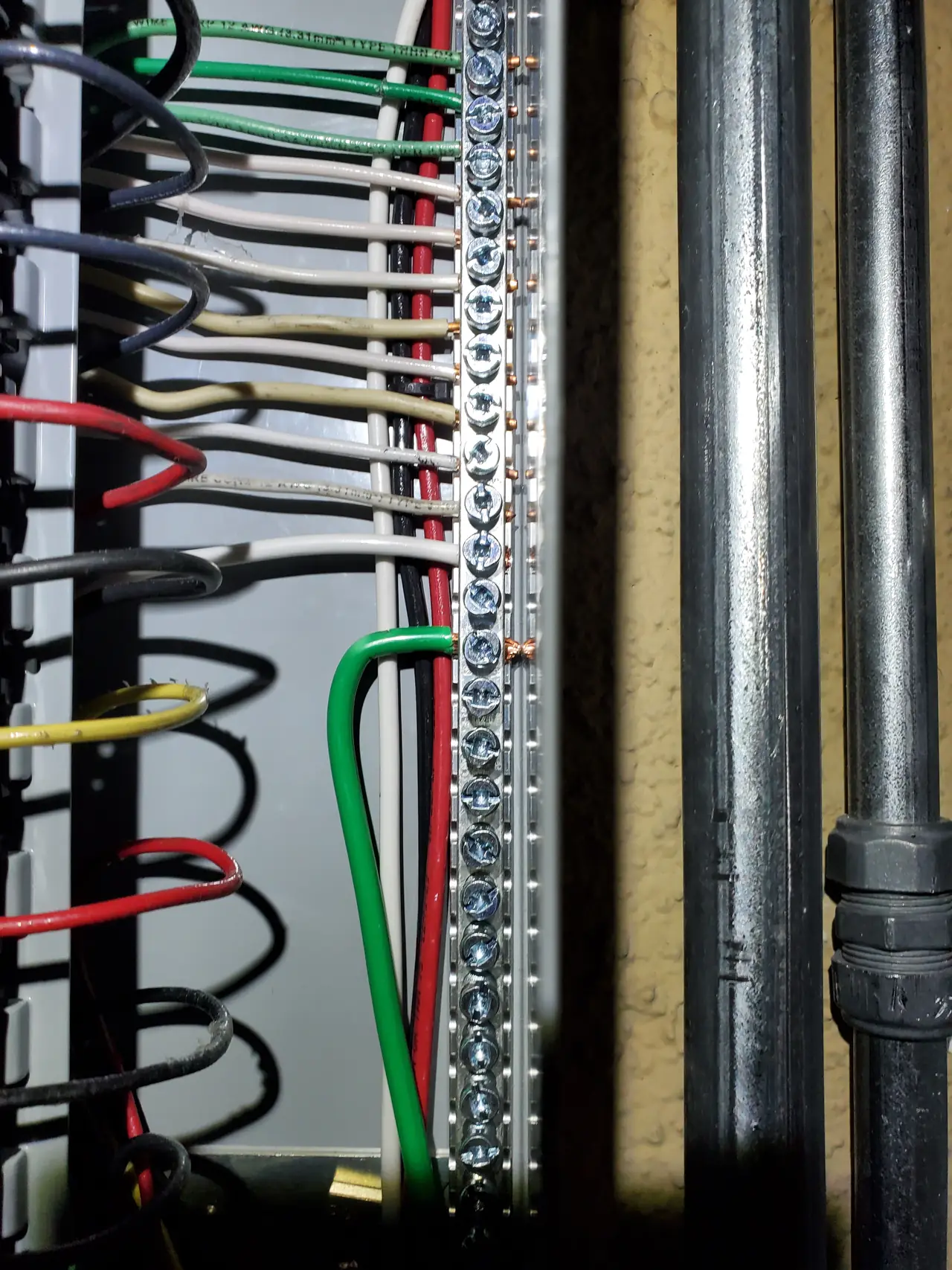

Interior of a service panel with breakers and conductors, Sun Valley
Inside the new panel.

The array is sixteen Q.CELLS 340-watt modules on sixteen Enphase microinverters, and the service panel was upgraded to 200 amps as part of the same job. It sits on composition shingle over 2×4 rafters, covering 310 square feet — well under half the roof.

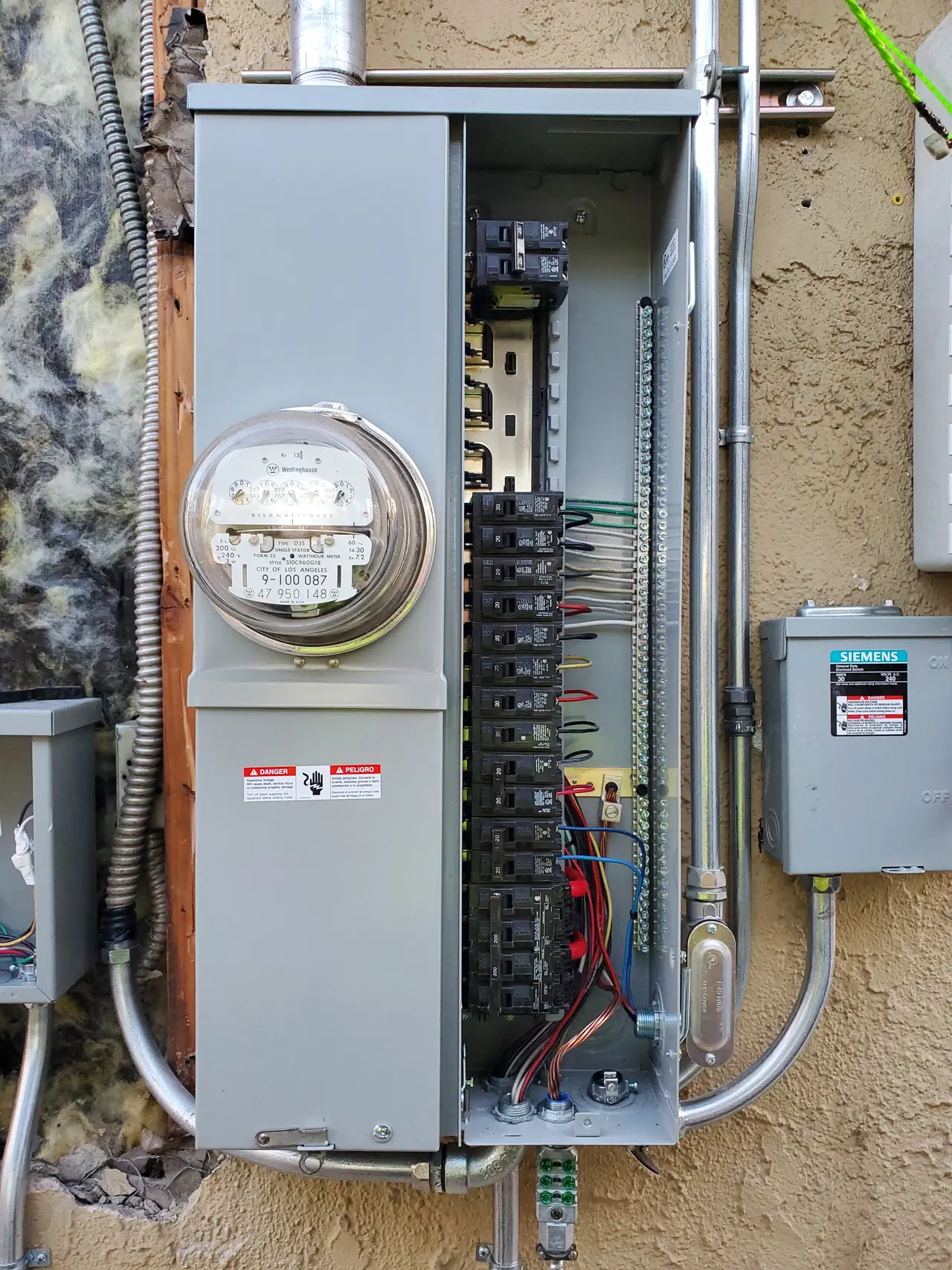

Service panel set into an exterior wall opening during replacement, Sun Valley
The panel going back into the wall.

The only friction was paperwork format. The party handling the file expected a separate signed job card. On this permit the inspector signed the permit itself, and that signed page was the record of the passed final. It took a couple of emails to establish what to file.

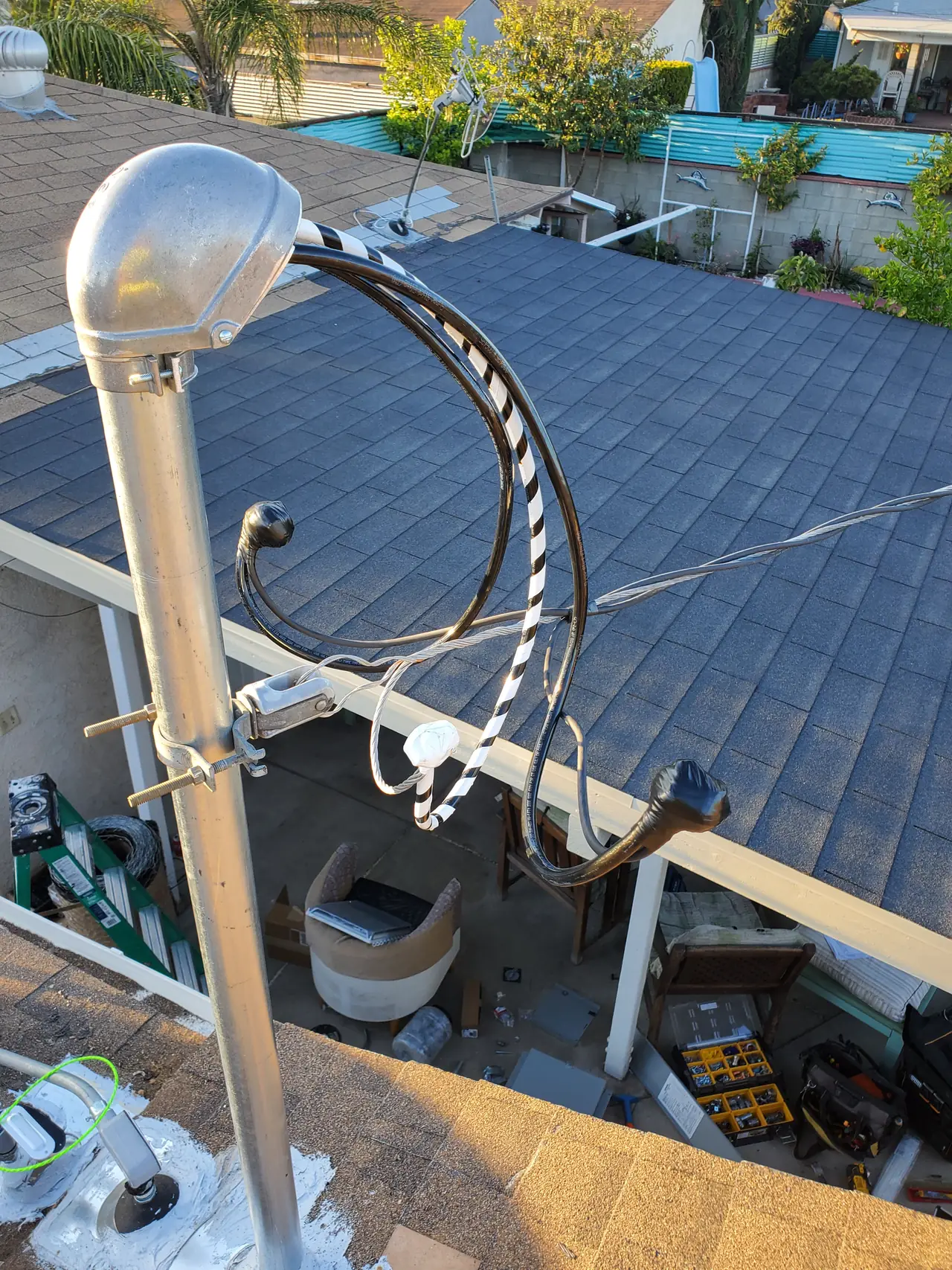

Roof with conduit and a vent, Sun Valley
Conduit crossing to the service side.

Worth saying plainly: LADBS changes its criteria, and which route a project takes depends on its configuration. This describes what happened on this project in 2022, not a rule you can count on today.

How it ran

21 January 2022Express solar permit issued, no plan check
14 March 2022Installed
23 March 2022Final inspection passed

Nine days run from installation to the passed final inspection. The permit had been issued in January without plan check; because plan check sits before installation, the two are separate facts rather than cause and effect.

What we did

  • Installed sixteen modules on composition shingle over 2×4 rafters.
  • Upgraded the main service panel to 200 amps as part of the same job (C-10 scope).
  • Carried the inspection and passed the final nine days after installation.
  • Established what the signed record of the final actually was and supplied it.

System specifications

DC system5.44 kW
Modules16 × Q.CELLS Q.PEAK DUO BLK-G6+, 340 W
Inverters16 × Enphase IQ7PLUS-72-2-US
Service panelUpgraded to 200 A
RackingIronRidge XR10 on flashed feet
RoofComposition shingle, rafters 2×4 at 24 in on center
Array load2.9 lb per sq ft over 310 sq ft
Permit routeExpress permit, no plan check, issued January 2022
BatteryNone
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your system is small enough that plan check may not apply.
  • You have been quoted a two-month permitting timeline for a modest array.
  • Your panel needs upgrading at the same time as the solar goes on.
  • Somebody is asking you for a job card and your inspector signed the permit.
  • You are on LADWP.

Cali Energy in Sun Valley

Sun Valley sits inside City of Los Angeles boundaries, so every project here is permitted through LADBS and interconnected through LADWP. Our work in this ZIP code runs from single-row arrays on new accessory dwelling units to a 13 kW system on a replaced service panel, on composition shingle and on low-slope rolled composition.

Two projects on the same street went through two different permit routes in the same months, and the calendars were not close.

This installation is on the Sun Valley projects page alongside the others, and what the work covers is set out on the Sun Valley service area page.

Frequently asked questions

Can a residential solar permit be issued without plan check?

Under the LADBS process used for this project in 2022, a roof-mounted microinverter system not exceeding ten kilowatts AC on a one- or two-family dwelling was issued an express permit with no plan check. Criteria change and routes depend on configuration, so treat this as what happened on this project rather than a current rule.

How fast can a small solar project be finished?

On this one the final inspection passed nine days after installation. That gap is inspection scheduling. It is separate from the permit route, because plan check happens before installation rather than after it — this project skipped plan check, which is why a permit was in hand in January, but that is a different part of the calendar.

What counts as proof that a final inspection passed?

On this permit the inspector signed the permit itself, and that signed page was the record. Some processes expect a separate job card instead. It is worth establishing which applies before somebody is waiting on a document that was never issued.

Does Cali Energy do panel upgrades alongside solar in Sun Valley?

Yes. Sun Valley is inside City of Los Angeles boundaries, so permits run through LADBS and interconnection through LADWP. Cali Energy coordinates service panel upgrades alongside solar projects; this installation included an upgrade to 200 amps.

What this would look like on your roof

Every number on this page came off a real job in Sun Valley, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
