Cypress Park, CA · June – July 2022 · LADWP / LADBS

Cypress Park: the site visit that never came.

Two identical projects can be a month apart on the calendar and never differ on the roof. Usually it is this one step.

Before it agrees to connect a system, the utility normally sends a representative to look at the property — the pre-construction site assessment. That visit has to be scheduled against a crew's calendar, and it is where most of the variation between two otherwise identical interconnection timelines comes from. It can also be waived: an installer with a pre-construction site assessment waiver on file has the step bypassed and the file moves straight on. On this 6.8 kW Cypress Park project Cali Energy had the assessment bypassed and reached permission to operate twenty-six days after filing.

A solar array on a composition shingle slope with a bamboo screen and hillside houses behind, Cypress Park, Los Angeles
6.8 kW, and twenty-six days from filing to permission to operate.

At a glance

System
6.8 kW AC-CEC
Site assessment
Bypassed rather than scheduled
First four notices
All within two days of filing
Filing to permission to operate
Twenty-six days
Utility / AHJ
LADWP / LADBS

The story

This project has no story in the usual sense. Nothing was wrong with the roof, nothing came back on the drawings, nobody had to be chased. Six point eight kilowatts on a small northeast Los Angeles lot, filed in the middle of June, running by the middle of July.

It is written up precisely because it went quickly, and because the reason it went quickly is a single step that most owners never hear named.

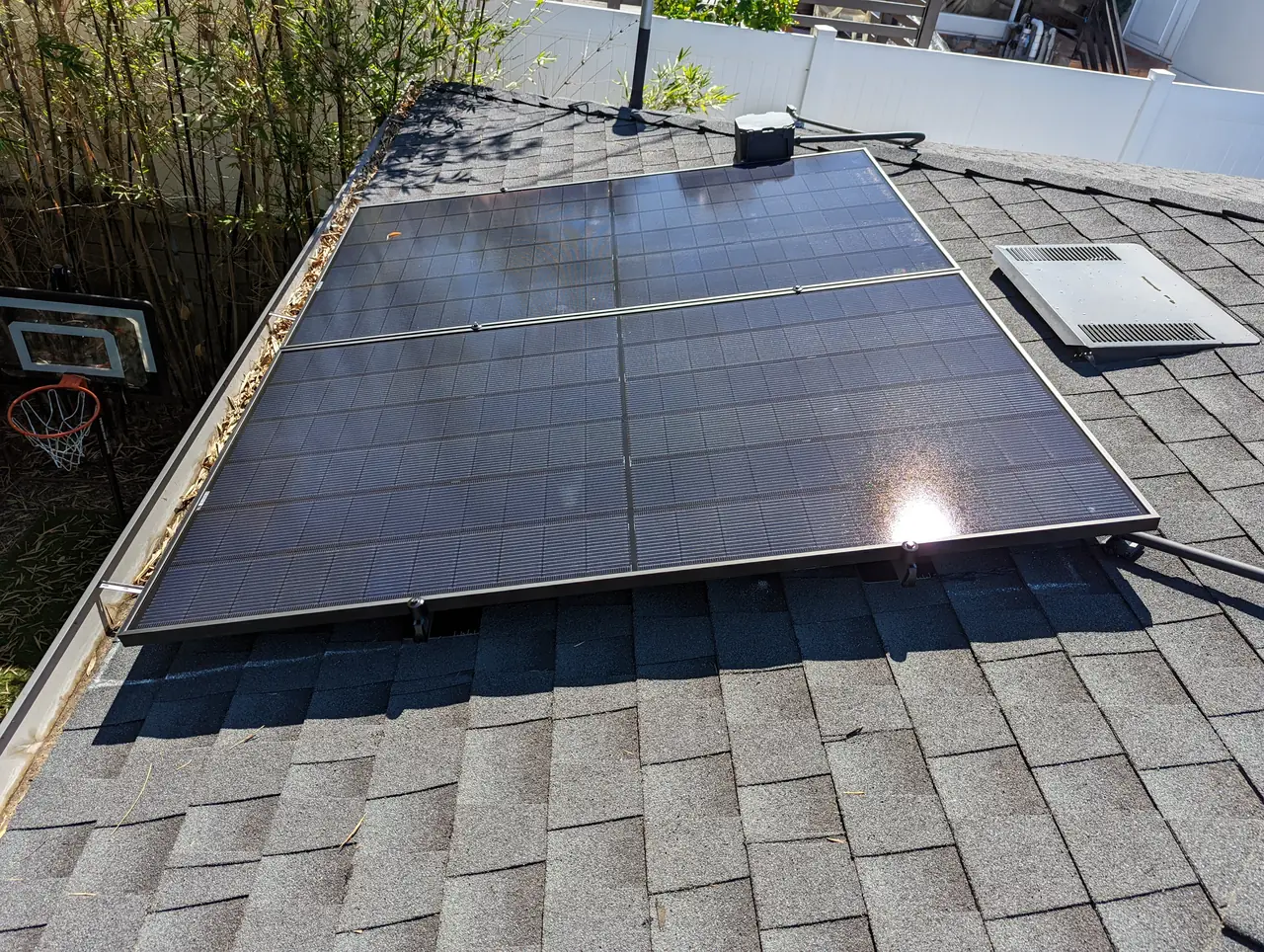

Solar modules laid across a shingle roof above a back garden, Cypress Park, Los Angeles
Nothing here needed a visit to settle.

Read the second progress notice carefully and it tells you itself. An onsite assessment will be completed shortly, it says — unless a pre-construction site assessment waiver is on file. On this project one was. The fourth notice arrived the same day to say the assessment had been bypassed, and the file moved on without anybody going anywhere.

Here is why that single line does more than it looks.

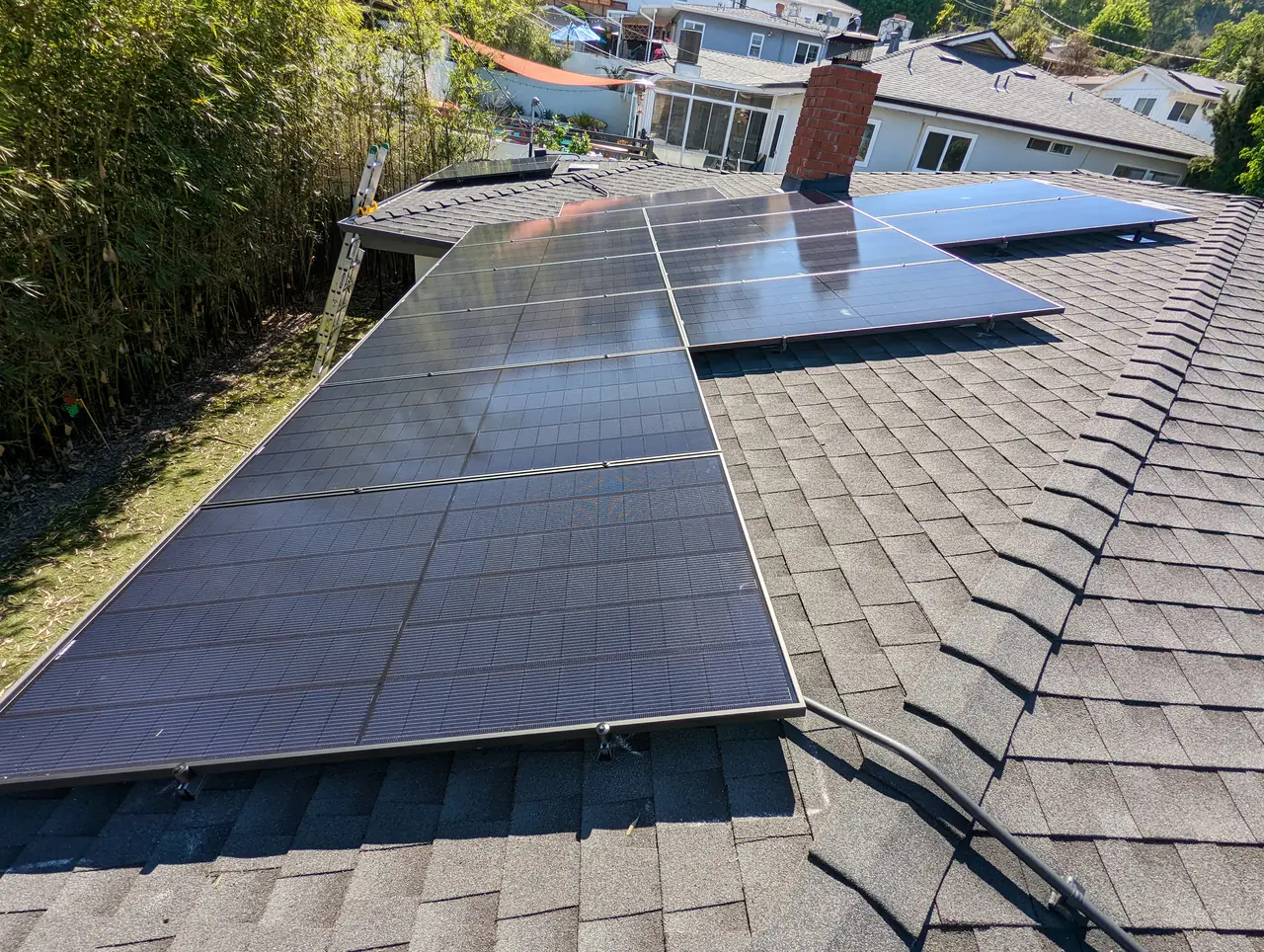

Two roof planes carrying solar modules with neighboring houses and hills beyond, Cypress Park, Los Angeles
Four progress steps closed in the first two days.

The site assessment is the utility sending a representative out to look at the property before it agrees to connect anything: where the service comes in, where the meter is, whether the equipment can be worked on. It is a real visit by a real person with a real calendar, and a calendar is the one thing in this process that cannot be hurried from the outside. When the visit is scheduled it adds weeks. When it is waived it adds nothing at all.

That is the whole difference between an interconnection that closes in under a month and one that runs to three. Not the size of the system, not the difficulty of the roof, not how quickly anybody answers email — a visit that either happens or does not.

The waiver sits on file with the utility rather than being requested project by project, and it is not something a homeowner arranges. What an owner can do is ask whether the company quoting them files with one, because on two otherwise identical quotes that single answer can separate the calendars by a month.

The rest of this project is the sequence working as designed. The request was confirmed on the twentieth of June. The utility charge cleared the next morning and the first, second and fourth notices all landed that same day. The installation was approved on the fifth of July, the meter was set on the sixteenth, and permission to operate came with it.

Twenty-six days, on a project where the only thing anybody did differently was not wait for somebody to drive over.

Cali Energy designed, permitted and interconnected this 6.8 kW array in Cypress Park, Los Angeles.

How it ran

20 June 2022Interconnection request confirmed — 6.8 kW AC-CEC
21 June 2022Utility charge cleared; first, second and fourth progress notices all recorded — site assessment bypassed under a waiver
28 June 2022Array installed
5 July 2022Installation approved; meter requested
16 July 2022Meter set and permission to operate

Twenty-six days from filing. Four steps closed inside the first two days because one of them did not have to be scheduled.

What we did

  • Filed with a pre-construction site assessment waiver on file.
  • Cleared the utility charge the morning after the request was confirmed.
  • Closed four progress steps inside the first two days.
  • Carried the project to permission to operate in twenty-six days.

System specifications

System6.8 kW AC-CEC
ArrayResidential rooftop
Site assessmentBypassed under a pre-construction waiver
Approval to meter setEleven days
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You are comparing two quotes and the timelines are months apart.
  • Somebody has told you solar takes three months and not said why.
  • Your interconnection is waiting on a visit nobody has scheduled.
  • You want to know which part of the process is actually variable.

Cali Energy in Cypress Park

Cypress Park sits in the northeast of the City of Los Angeles, between the river and the hills, permitted through LADBS and interconnected through LADWP. Small lots and modest systems, where the calendar is decided by the process rather than by the roof.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

What is a pre-construction site assessment?

A visit by a utility representative to look at the property before the utility agrees to connect a system — where the service enters, where the meter sits, whether the equipment can be worked on safely. It is a real appointment on a real crew calendar, and scheduling it is what turns a step measured in days into one measured in weeks.

What is a site assessment waiver?

A pre-construction site assessment waiver held on file with the utility, which lets the onsite visit be bypassed rather than scheduled. The utility's own progress notice names it: the assessment will be completed shortly unless such a waiver is on file. It is filed by the installer rather than arranged by the homeowner.

Why do two identical solar projects take different amounts of time?

Most often because of this step. System size, roof difficulty and how fast anybody answers email matter far less than whether a site visit has to be scheduled. On this Cypress Park project the assessment was bypassed and the interconnection closed in twenty-six days; with a visit in the queue the same project runs considerably longer.

What should I ask an installer about my timeline?

Ask whether they hold a pre-construction site assessment waiver with the utility. It is a plain yes or no, it costs nothing to ask, and on two otherwise identical proposals it tells you more about the calendar than almost anything in the specification does.

Does Cali Energy install solar in Cypress Park, Los Angeles?

Yes. Cypress Park is inside city limits, so projects here are permitted through LADBS and interconnected through LADWP. This one was 6.8 kW AC-CEC and reached permission to operate twenty-six days after filing, with the site assessment bypassed rather than scheduled.

What this would look like on your roof

Every number above came off a real job in Cypress Park, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.
