Woodland Hills, CA · September 2020 – August 2021 · LADWP / LADBS

The application said 12.9 kilowatts. The agreement said 12.53.

A large residential array on a wide Woodland Hills roof, installed without incident, and then held up by a single digit typed into the wrong box. What makes it worth recording is what the homeowner said in the middle of it: that he had no way to judge any of this, and had not filled in a single form.

The interconnection application and the interconnection agreement are two different documents, and the utility compares them. If the system size on the agreement does not match the size already on file, review stops until the contractor either corrects the form or formally changes the system size through the utility's solar representative, which is a far slower route. Empty fields matter too: a battery section left blank is returned, while the same section filled with zeros is accepted. On this Woodland Hills project Cali Energy handled that chain end to end, which on a residential job is what the homeowner is actually buying.

A large black solar array spread across a wide composition shingle roof at dusk, Woodland Hills
Nearly thirteen kilowatts on one roof plane. The installation was the easy part.

At a glance

Recorded by the utility
12.9 kW AC-CEC
Modules
Q CELLS Q.PEAK DUO BLK-G6+ 340 W
Inverters
Enphase microinverters
Utility work type
Overhead service, meter and service
Battery
None
Application to permission to operate
Just under two months
Warranty work
One microinverter replaced eight months after switch-on
Utility / AHJ
LADWP / LADBS

The story

The contract went out at the end of September and was signed the same day. The site was inspected the next afternoon, the permit set came back within days, and the drawings went over to him.

His reply is the point. He wrote that he had no expertise to evaluate the plans, acknowledged receipt, asked what the next steps were, and said he had not heard from the electric company. Later, when a utility form landed in his inbox covered in correction notes, he forwarded it and asked whether this was something we were going to take care of, because he had not filled out any paperwork at all.

He should not have to. On a residential solar project the contractor carries the whole chain: the design, the permit, the interconnection application, the agreement, the corrections, the release, the meter order. The owner signs a contract and, at the end, is told to switch it on.

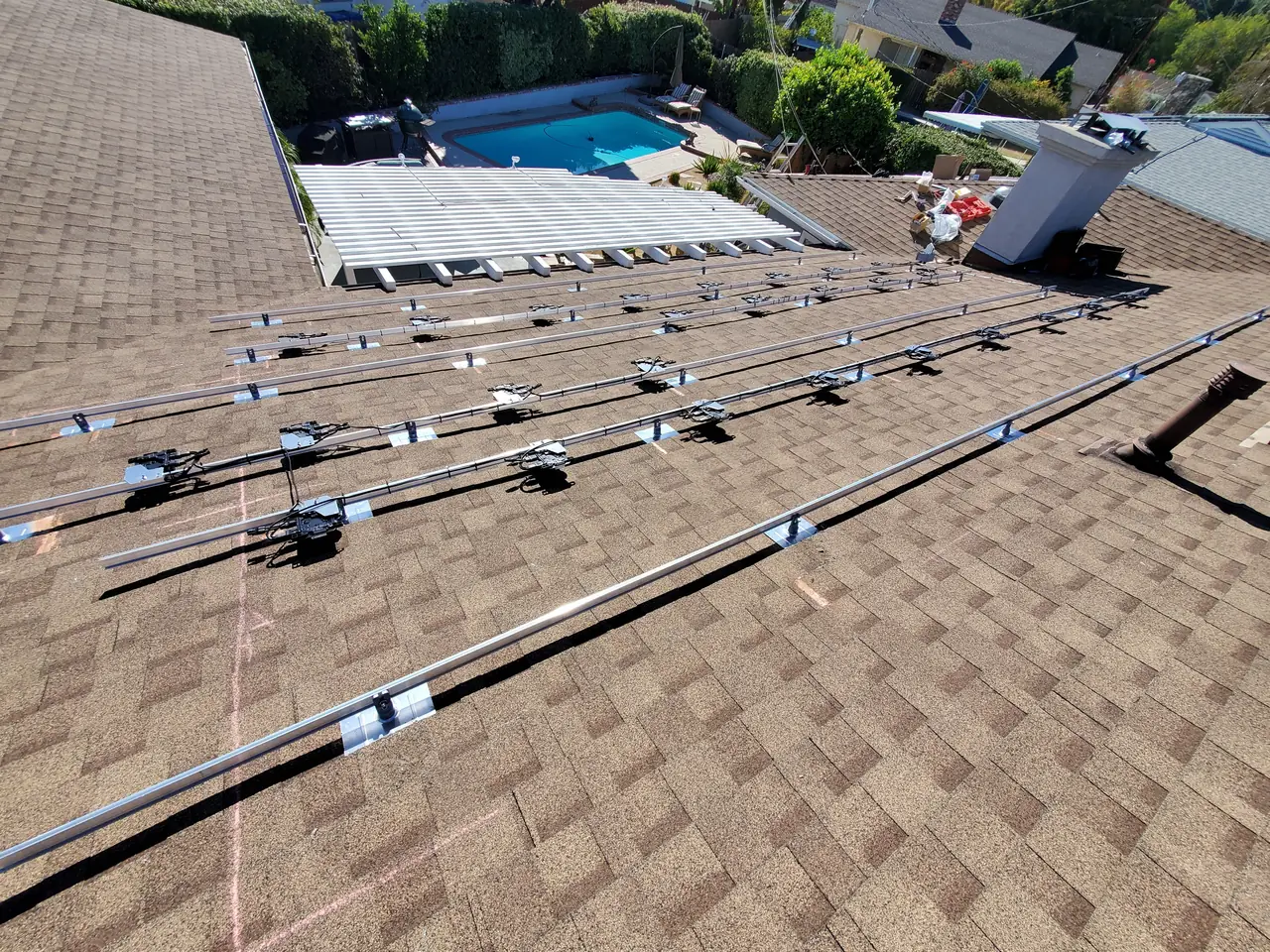

Mounting rails and microinverters laid out across a wide shingle roof before the modules are set, with a pool visible below, Woodland Hills
Rails and microinverters set out before the modules. A thirteen kilowatt array needs a roof this wide.

The application went in at 12.9 kilowatts as the utility records it, on overhead service, with meter and service work rather than a meter swap alone. The utility acknowledged it within days, arranged the meter position visit for the following morning, completed its site assessment and granted permission to install. Four days from application to permission to build is a good run by any standard.

Then the agreement arrived, and this is the mechanism to carry away.

The interconnection application is not the interconnection agreement. They are separate documents, filed at different moments, and the utility reads the second against the first. Ours came back with corrections. When it was resubmitted, the system size on it read 12.53 kilowatts against the 12.9 already on file. One mistyped number. The reply was immediate and entirely reasonable: either correct the form or put a formal size change through the solar representative, which is a different process with a different clock. We answered that we did not want to change anything and that the number was a typing error, and sent it again.

It came back a second time. The battery fields had been left blank, and blank is not the same as none. They had to be filled with zeros. Both round trips were closed inside a single day, and the next message from the utility was the one that mattered: the agreement is approved, and the only thing still needed on this job is the city's release.

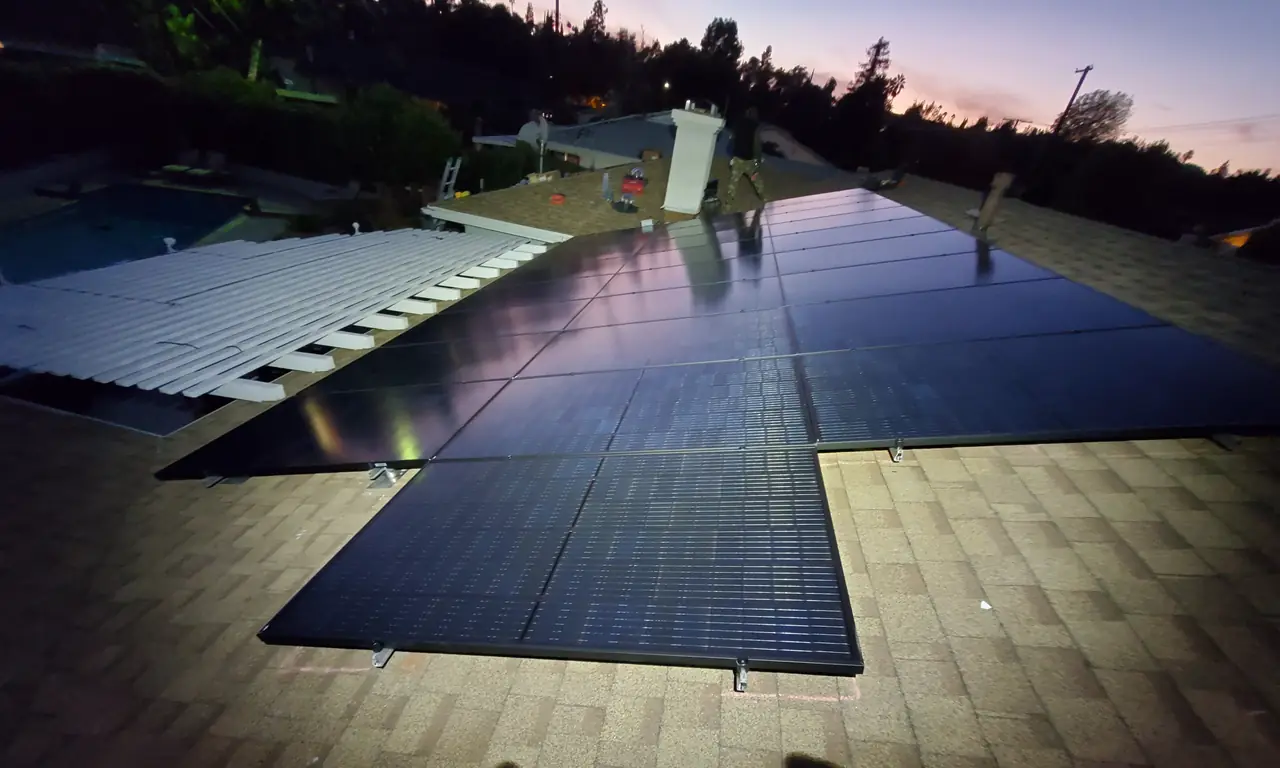

The completed black array seen along the ridge of the shingle roof with neighboring houses beyond, Woodland Hills
The finished array. From the agreement's approval onward the project lived entirely on paper for seven weeks.

A technician went back in November to finish some stucco work on the wall. The utility completed its interconnection review at the start of December and permission to operate arrived the next day with the net meter set. The owner forwarded it and asked when we could come and switch the system on so he could hand over the final payment. It was booked for eight the next morning.

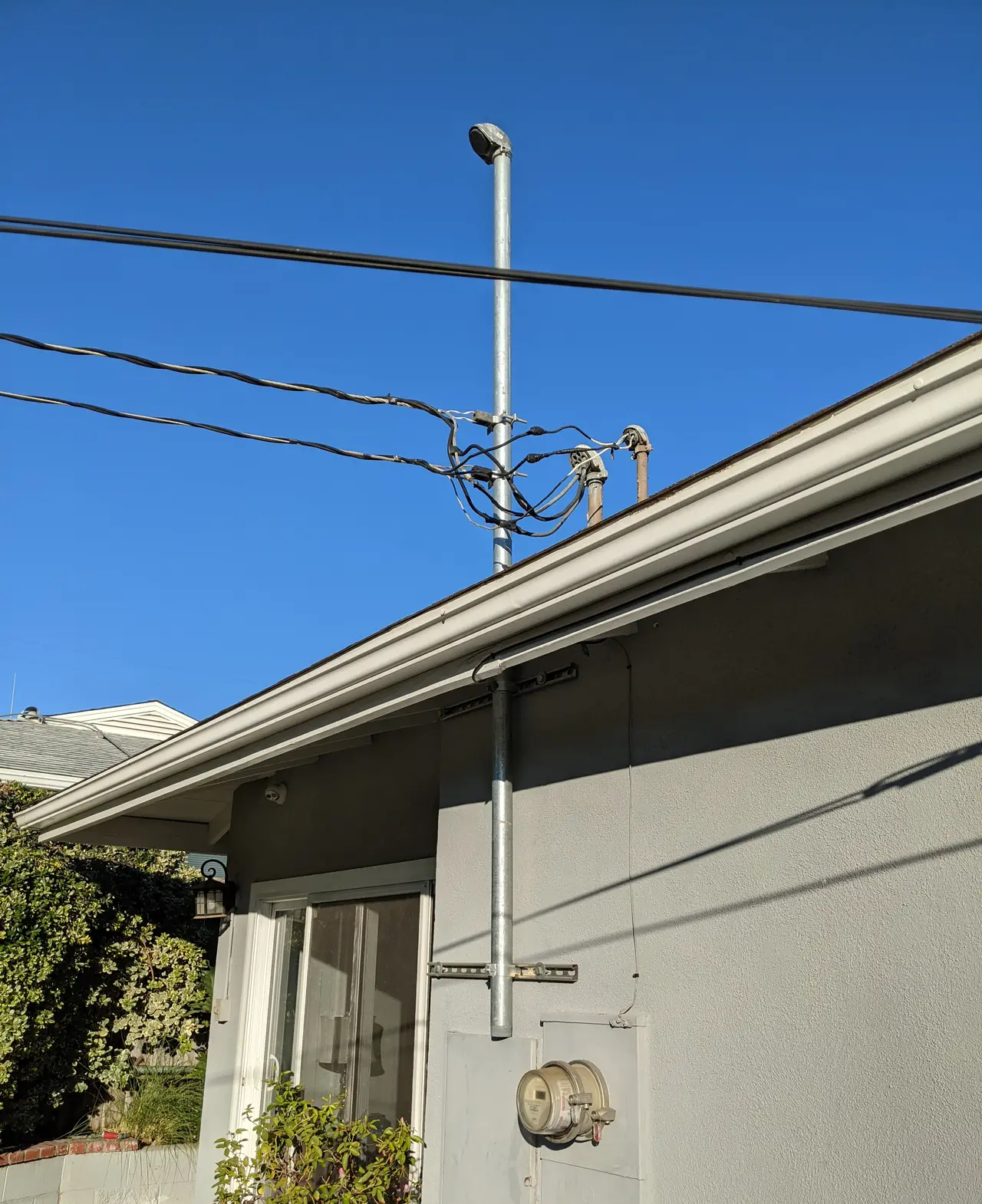

A service mast and meter on the stucco wall of a single-story house against a clear sky, Woodland Hills
The service side. The utility classified this job as meter and service rather than meter alone.

Eight months later, one microinverter stopped. The owner spotted it in the app and asked, fairly, how a component fails after eight months and what the warranty on it actually is. The answer is twenty-five years, and a single unit failing early is uncommon but not alarming. We filed the claim with the manufacturer, the replacement arrived, and a crew fitted it on a morning that suited him.

Then a last small thing that saves everyone a wasted visit. He wrote afterwards to say the service had been good but that his app still showed the panel dark. It was not dark. Monitoring platforms take a day or two to backfill after a unit is swapped, and a panel that has just been replaced reads as silent until they do. We said so rather than sending a second truck, and that was the end of it.

Two things to take from this. Ask your installer who fills in the interconnection agreement, and check that the size on it matches the size on the application, because a single digit in the wrong place stops a finished system from being connected. And after any warranty swap, give the monitoring two days before you decide it did not work.

How it ran

29 September 2020Contract sent and signed the same day
30 September 2020Site inspection
3 October 2020Permit set received
5 October 2020Drawings sent to the owner; interconnection application filed at 12.9 kW AC-CEC
8 October 2020Utility confirms the application and arranges the meter position visit for the next morning
9 October 2020Site assessment complete; permission to install granted
13 October 2020Interconnection agreement returned with corrections; resubmitted form reads 12.53 kW and is challenged; typing error corrected and battery fields zeroed
14 October 2020Agreement approved; only the city's release outstanding
November 2020Stucco work completed on the wall
1 December 2020Utility completes interconnection review
2 December 2020Permission to operate; net meter set; switch-on booked for the next morning
July – August 2021One microinverter fails eight months after switch-on; warranty claim filed, replacement fitted, monitoring backfills within days

This timeline reflects a straightforward roof with no panel upgrade and no association. The seven weeks between the agreement's approval and permission to operate were paperwork, not construction.

What we did

  • Inspected the site the day after the contract was signed and had a permit set back within four days.
  • Filed the interconnection application and carried every subsequent form, so the owner filled in nothing (C-10).
  • Identified the size mismatch on the interconnection agreement as a typing error and corrected it rather than opening a formal system size change.
  • Resubmitted the agreement with the battery fields zeroed when blank fields were rejected, and closed both round trips inside a day.
  • Installed the array, completed the stucco work and carried the project to permission to operate.
  • Filed the manufacturer warranty claim when a single microinverter failed eight months in, and fitted the replacement.
  • Explained the monitoring backfill delay after the swap instead of dispatching a second visit.

System specifications

Recorded by the utility12.9 kW AC-CEC
ModulesQ CELLS Q.PEAK DUO BLK-G6+, 340 W, all black
InvertersEnphase microinverters, one per module
RoofComposition shingle
Utility work typeOverhead, meter and service
BatteryNone; recorded by the utility as zero
Warranty term on the microinvertersTwenty-five years
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You have been sent a utility form and are not sure whether it is yours to complete.
  • Your system is installed and the utility says it is still waiting on something.
  • You want to know what a contractor is actually responsible for after the panels are up.
  • A single panel has gone dark in your monitoring app.
  • Your Woodland Hills property is served by LADWP, while permits are handled by LADBS.

Cali Energy in Woodland Hills

Woodland Hills is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

Woodland Hills is inside the City of Los Angeles, so LADBS inspects and LADWP interconnects. The paperwork chain between the two is longer than most owners expect, and on a residential project it is the contractor who is supposed to carry all of it.

This installation is on the Woodland Hills projects page alongside the others, and what the work covers is set out on the Woodland Hills service area page.

Frequently asked questions

What is the difference between the interconnection application and the agreement?

The application opens the project and puts a system size on file. The agreement is a later document that sets the terms under which the system connects, and the utility reads it against what the application already says. If the sizes disagree, even by a few hundred watts, review stops. Correcting a typing error takes a day; changing the system size formally is a different process altogether.

Why was a form rejected for blank fields?

Because blank and zero mean different things to a reviewer. A battery section left empty reads as unanswered, while the same section filled with zeros reads as a deliberate statement that there is no storage on the project. It sounds like pedantry and it is not: the reviewer cannot tell whether an empty box means none or means forgotten, so the form comes back.

Should the homeowner be filling in utility paperwork?

No. On a residential solar project the contractor carries the application, the agreement, the corrections, the city release and the meter order. The owner signs a contract and, at the end, is told when to switch the system on. If a utility form reaches your inbox, forward it to your installer and ask them to handle it rather than attempting it yourself.

A single panel shows nothing in my app after a repair. Is it broken again?

Not if the repair was recent. Monitoring platforms need a day or two to backfill after a microinverter is replaced, and during that window the new unit reads as silent even though it is generating. Give it two days before calling anyone. On this system that is exactly what happened, and no second visit was needed.

Does Cali Energy handle warranty claims on the systems it installs in Woodland Hills?

Yes. On this project a microinverter failed eight months after switch-on, and Cali Energy diagnosed it, filed the manufacturer claim, received the replacement and fitted it. The microinverters carry a twenty-five year term, but a term is only worth what the person filing the claim makes of it. California contractor license number 1032379.

What this would look like on your roof

Every number above came off a real job in Woodland Hills, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.
