Westchester, CA · January – February 2022 · LADWP / LADBS

Westchester: three permits, one inspection visit.

Every permit closes with its own final. Nothing says they have to be separate mornings.

A project that touches more than one scope carries more than one permit, and each permit closes with a final inspection of its own. What is less obvious is that those finals need not be separate visits: requests filed for the same date are normally worked as one trip, because the inspector is coming to the address either way. On this Westchester house three permits went in for finals on the same Wednesday and all three closed — five days after the array went up. Cali Energy scheduled the installation around the household and the inspections around each other.

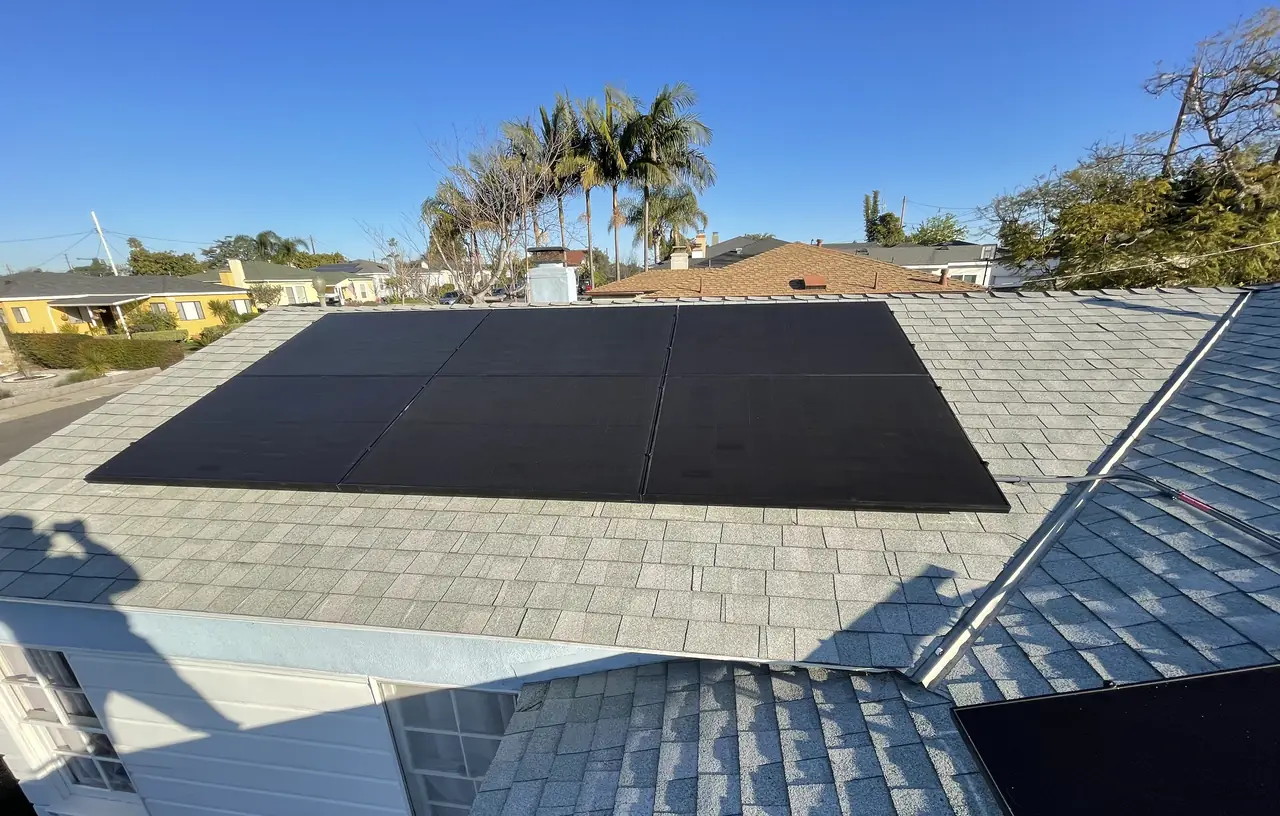

The finished array filling the roof slope, Westchester, Los Angeles
Five days from here to a closed permit.

At a glance

Permits on the job
Three
Finals requested
All three for the same day
Installation to passed final
Five days
Installation date
Moved once, to suit the household
Utility / AHJ
LADWP / LADBS

The story

The project opens with two lines that are worth keeping. We offered the Wednesday. The household could not do Wednesday. It went in on the Friday.

That is not a scheduling anecdote, it is the one variable on a solar project that genuinely belongs to the owner. Almost everything else — plan check, the interconnection queue, the inspection calendar — runs on somebody else's clock. The day the crew arrives is the part that can be moved to suit a household, and moving it costs nothing if it is moved early.

The array went up on the Friday. On the Monday three inspection requests went in.

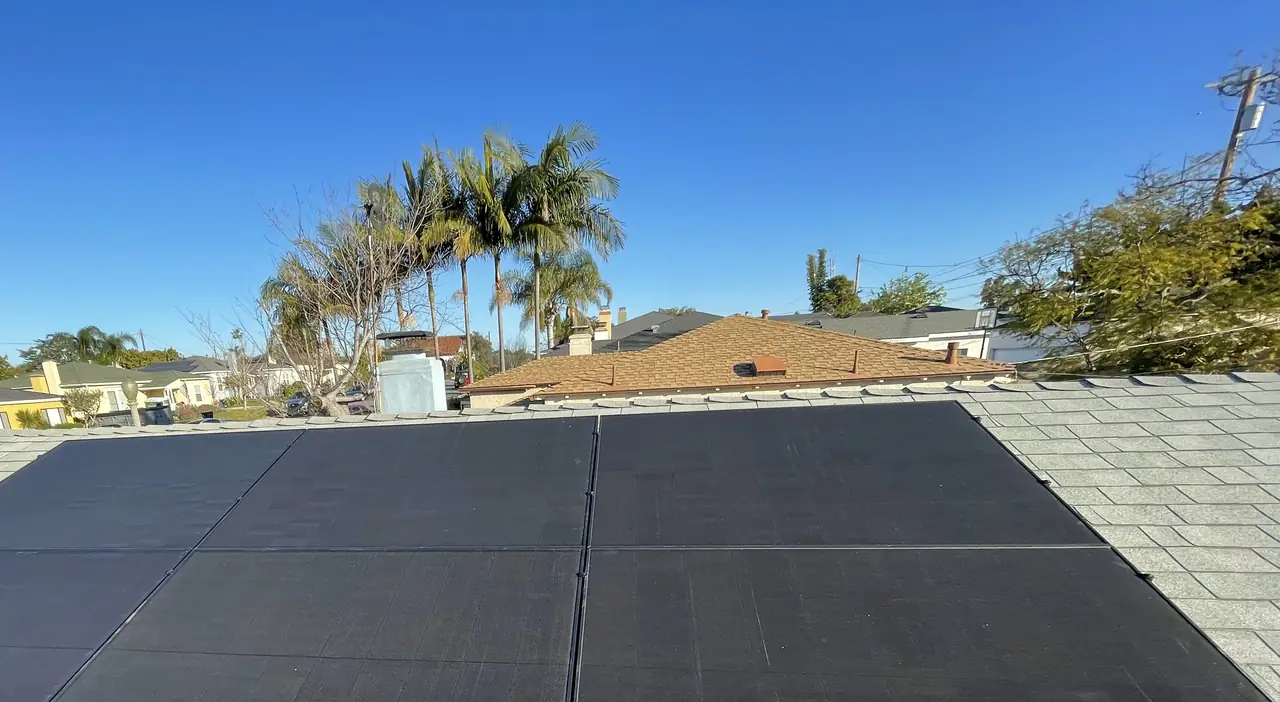

The array with the palms and the neighboring roofs beyond, Westchester, Los Angeles
One roof, three authorizations.

Three, because the house carried three permits.

That surprises people who expect one project to mean one permit, and it is ordinary. Permits follow scopes of work, not projects. The array is one scope. Electrical work at the service or the panel is another. A battery, a car charger, a re-roof underneath — each is its own scope with its own authorization, its own plan check and its own inspection card.

And each closes with its own final. That part is not a formality: a permit left unclosed stays open against the address, and an open permit is a problem that surfaces at a sale or on the next job that touches the same equipment.

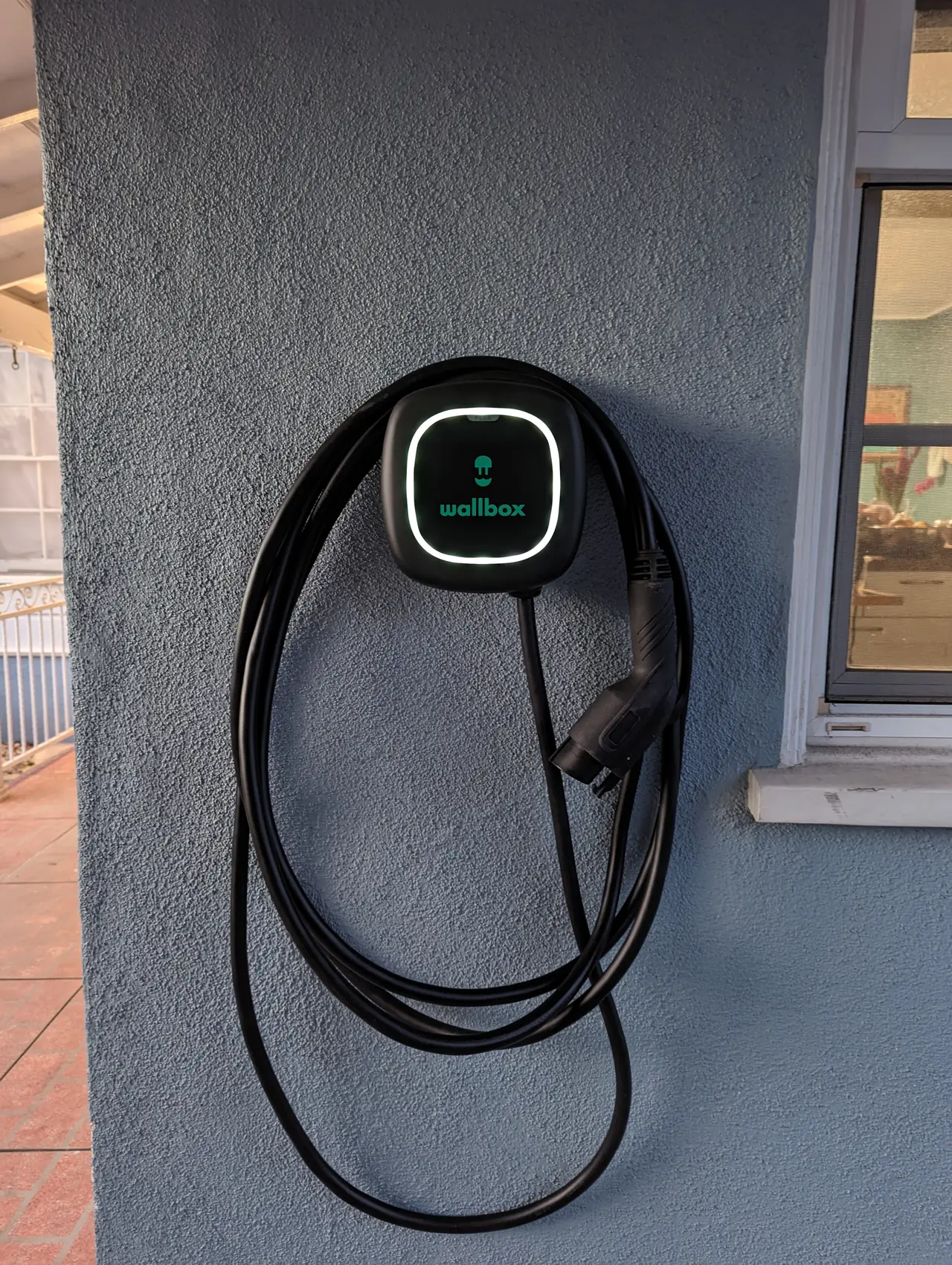

A level 2 electric vehicle charger mounted on an exterior wall, Westchester, Los Angeles
A separate scope, and a separate permit to close.

Here is the part worth actually doing something with. Three finals do not have to be three visits.

Requests filed for the same date are generally worked together, because the inspector is driving to the address regardless, and once there, looking at three cards rather than one costs minutes rather than a morning. Filed for three different dates, the same work becomes three trips, three places in three queues, and the elapsed time is the sum rather than the maximum.

What that looks like in weeks: a project that could close in a week closes in a month, with a finished array sitting on the roof throughout and nothing generating, because permission to operate waits on the finals.

Here they were all requested for the Wednesday. They were held on the Wednesday. The permit closed on the Thursday — five days after the modules went on.

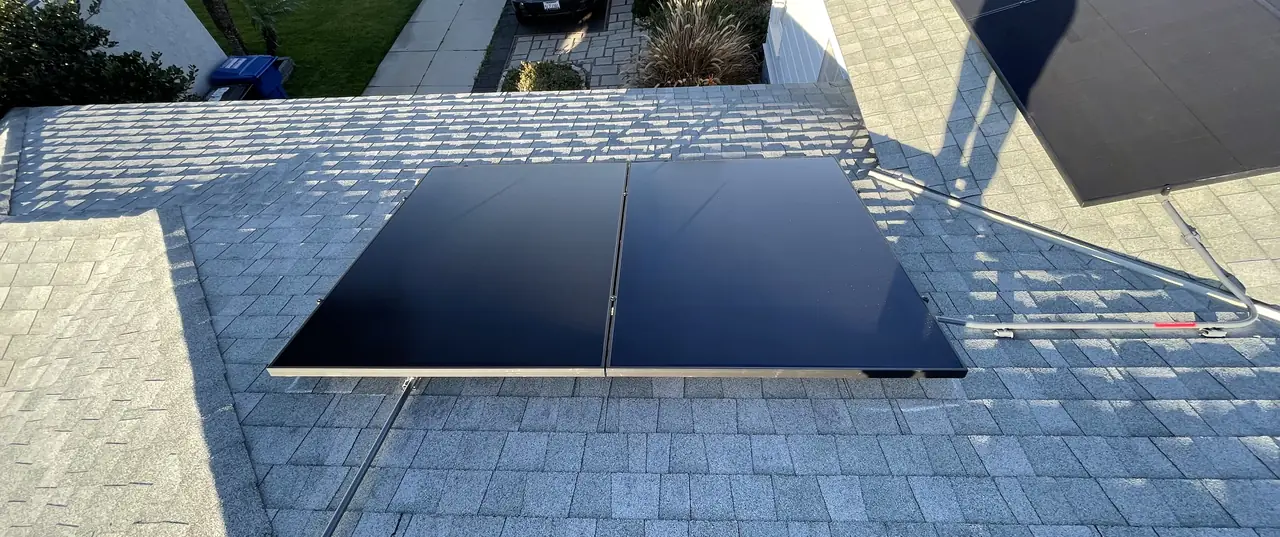

Modules on the roof seen across the yard, Westchester, Los Angeles
All three requests went in for the same Wednesday.

So the question to ask a contractor is not when the final is. It is how many permits the job carries, and whether the requests are in for the same day.

Cali Energy installed and finaled this project in Westchester, Los Angeles.

How it ran

31 January 2022Installation date agreed, then moved to the Friday at the household's request
4 February 2022Installation
7 February 2022Three final inspections requested — one per permit, all for the Wednesday
9 February 2022Inspections held
10 February 2022Final passed

Five days from an array on the roof to a closed permit, with three of them to close.

What we did

  • Moved the installation date to suit the household rather than the crew calendar.
  • Filed all three inspection requests for the same date.
  • Closed three permits on a single visit.
  • Took the project from installation to a passed final in five days.

System specifications

ArrayResidential rooftop
PermitsThree on one property
FinalsOne per permit, all requested for the same date
InstallationMoved once at the household's request
OutcomePassed five days after installation
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your project has more than one permit and you do not know why.
  • You have been given three different inspection dates for one house.
  • Your array is finished and the permits are closing one at a time.
  • You want to know which parts of the schedule you can actually influence.

Cali Energy in Westchester

Westchester is City of Los Angeles beside the airport, permitted through LADBS and interconnected through LADWP. Ordinary single-family blocks, and jobs that carry more paperwork than one roof would imply.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

Why does one solar project need several permits?

Because permits follow scopes of work rather than projects. The array is one scope; electrical work at the service or the panel is another; a battery, a car charger or a re-roof underneath are each their own. Every one carries its own authorization and its own inspection card.

Does each permit need its own final inspection?

Yes. A permit closes on a final, and one left unclosed stays open against the address indefinitely — which surfaces at a sale, or on the next job that touches the same equipment. Three permits mean three finals, however small two of them are.

Can several finals be done on the same visit?

Generally yes, when the requests are filed for the same date. The inspector is coming to the address either way, and reviewing three cards on site costs minutes. Filed for different dates, the same work becomes three trips and three waits.

How quickly can a solar permit close after installation?

Faster than most people expect when the requests are in early and synchronized. On this Westchester project the array went up on a Friday, the inspections were held the following Wednesday and the permit closed on the Thursday — five days.

Does Cali Energy install solar in Westchester, Los Angeles?

Yes. Westchester projects are permitted through LADBS and interconnected through LADWP, and houses here regularly carry more than one permit on a single job. Getting the inspection requests onto one date is the cheapest week a project can save.

What this would look like on your roof

Every number above came off a real job in Westchester, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
