Hollywood Hills, CA · October 2021 – December 2023 · LADWP / LADBS

Hollywood Hills: the owner pulled the panel permit and it was still open.

The first question on the solar job was not about the roof. It was about a permit from before the project existed.

California lets a homeowner pull a permit for work on property they own. It is legal, it is common for a main panel upgrade, and it carries the same obligation as any other permit: it has to be closed with a final inspection. An open permit does not lapse quietly — it stays against the property and resurfaces on the next job that touches the same equipment. On this Hollywood Hills house the opening question of the solar project was whether the owner's own panel permit could be finalled, and Cali Energy took the 4 kW system through to interconnection approval and start-up.

Solar modules on a red tile roof with the hillside beyond, Hollywood Hills, Los Angeles
The new scope, on a house that already had history.

At a glance

System
4 kW AC-CEC
Opening question
Closing out an owner-pulled panel permit
Solar final
Requested September 2023
Interconnection approved
End of November 2023
Started
December 2023
Utility / AHJ
LADWP / LADBS

The story

Most solar projects begin with a roof. This one began with a sentence from the owner: can we final out this panel upgrade, I have the permit here, I pulled it myself.

That is a better question than it looks, asked at exactly the right moment.

California allows an owner-builder permit: a homeowner can take out a permit for work on a property they own rather than going through a licensed contractor. For a main panel upgrade it is not unusual. It is entirely legal.

What it does not do is change what a permit is. A permit is an authorization with an obligation attached — the work gets inspected, and the file closes on a final. Nobody comes looking for you if it does not. It simply stays open.

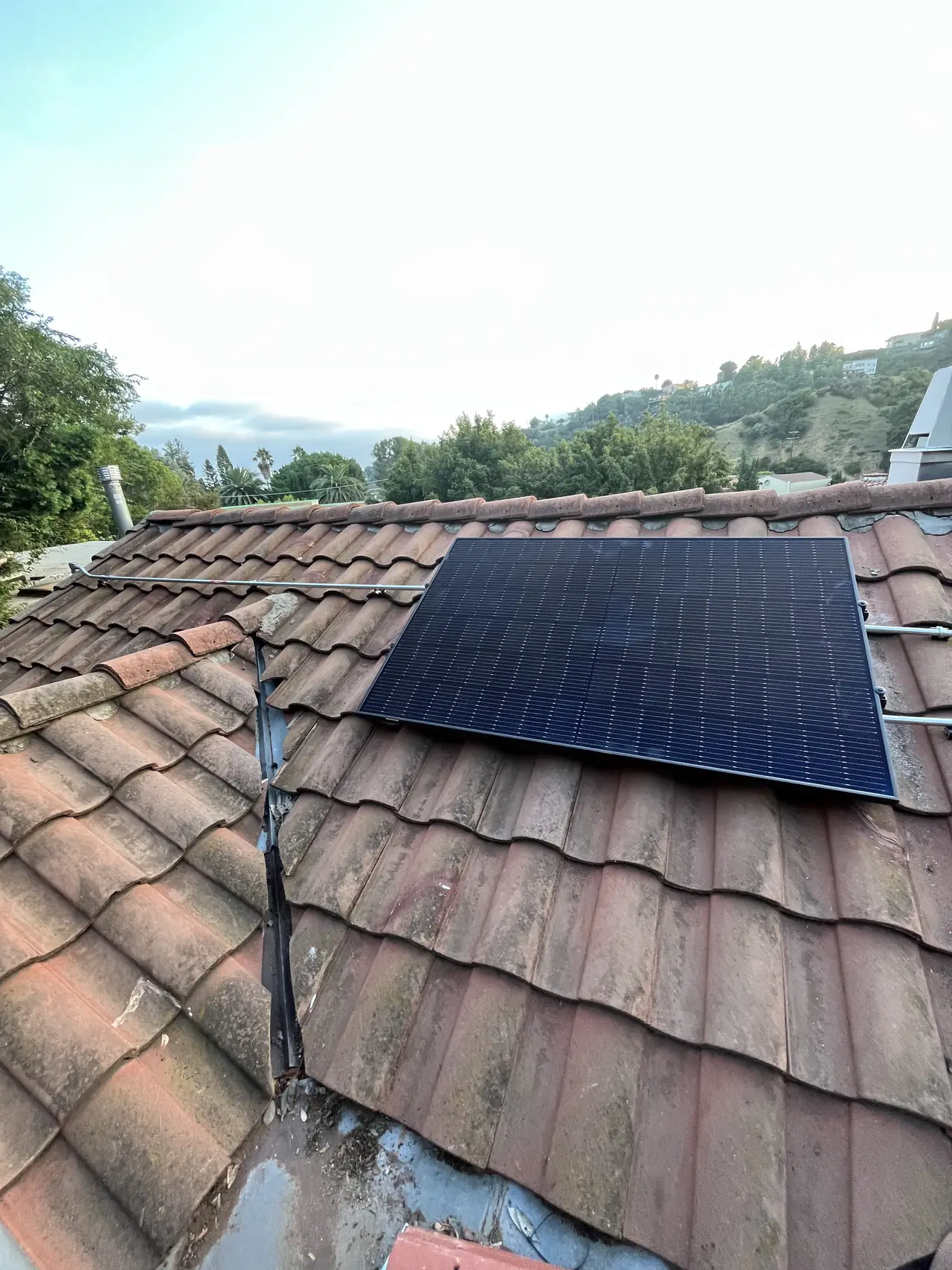

The array on the tile roof with the hills behind, Hollywood Hills, Los Angeles
The array connects to the panel. So does the paperwork.

And an open permit is not an abstraction. It sits against the address, visible in the department's records, and it turns up at the two moments that matter: when the property is sold, and when somebody applies to do work on the same equipment.

Which is precisely what a solar project is. The array connects to the main panel. The interconnection is described in terms of that panel's rating and its busbar. The inspector who comes for the solar final is looking at equipment that already carries an unfinished authorization. Nobody has to go hunting for the problem; it is in the same file.

So the order of operations on a house like this is: close what is open, then apply for what is new. Doing it the other way round means discovering the old permit at the worst possible point, which is the day of the final on the new one.

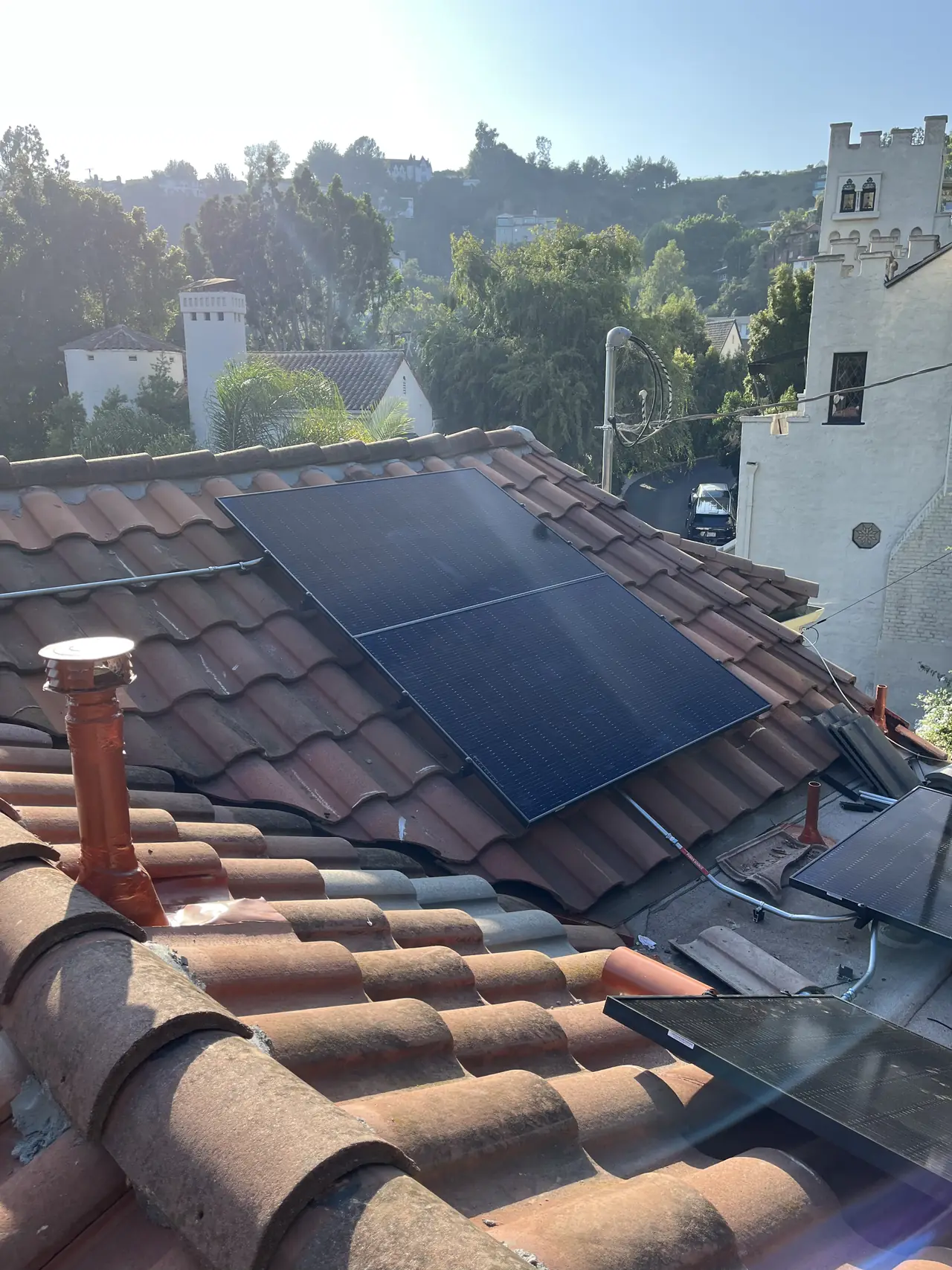

A tile roof and the neighborhood below, Hollywood Hills, Los Angeles
Close what is open, then apply for what is new.

The solar scope followed later — nearly two years later, which happens more often than the brochures suggest and usually has nothing to do with the roof. What matters is the order it went in: the panel question was settled first, and the array went up in September 2023 onto equipment whose paperwork was no longer a loose end.

From there the project ran the ordinary route. The solar final was requested in September. At the end of November the utility confirmed that the interconnection review was complete and that a request had gone out to schedule and install the net meter. In the first days of December the owner asked for the system to be started, and it was.

The useful check for anybody in an older house: if you have ever pulled a permit yourself — for a panel, a water heater, a garage conversion — find out whether it was ever finalled. Do it before you order solar, not while you are waiting on it. The department keeps the inspection history, and the answer takes one query.

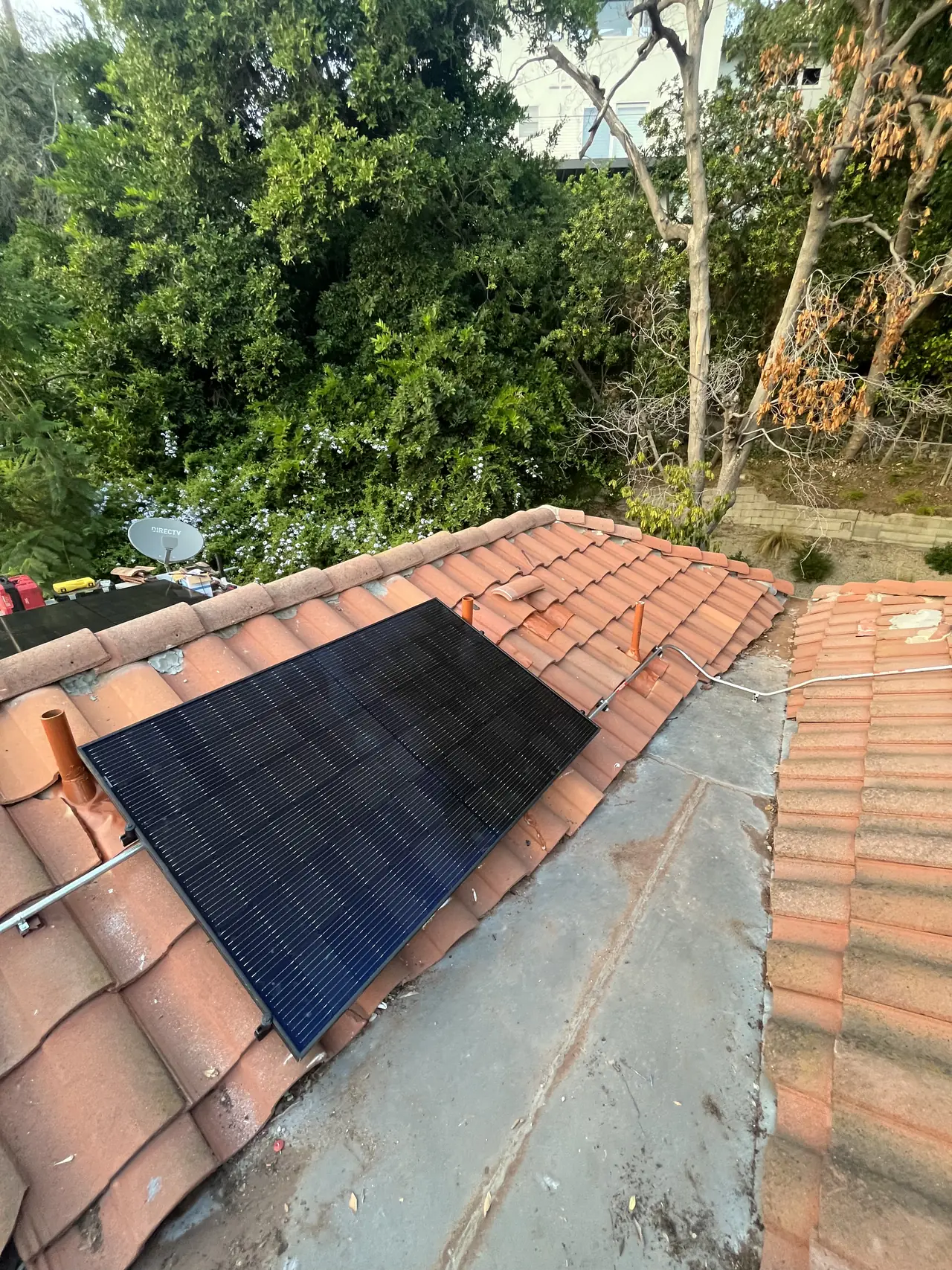

Modules on the tile roof among the trees, Hollywood Hills, Los Angeles
The last item on the project was a meter.

Cali Energy permitted, installed and started this 4 kW system in Hollywood Hills, Los Angeles.

How it ran

24 September 2021Main panel upgrade carried out under the owner's own permit
20 October 2021Owner asks whether that permit can be closed with a final
14–15 September 2023Solar array installed
18 September 2023Final inspection requested on the solar permit
30 November 2023Utility confirms the interconnection review is complete and requests the net meter
1 December 2023Owner asks for the system to be started
5 December 2023Start-up arranged

The first item on this project was a permit that predated it, and the last was a meter.

What we did

  • Treated the open panel permit as the first item on the project rather than the last.
  • Carried the solar permit through to its final inspection.
  • Followed the interconnection review through to the net meter request.
  • Started the system once the utility approval was in hand.

System specifications

System4 kW AC-CEC
Earlier workMain panel upgrade, permitted by the owner
That permitStill open when the solar project began
Solar finalRequested September 2023
InterconnectionApproved at the end of November 2023
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You pulled a permit yourself and never had the work inspected.
  • You are adding solar to a panel that was upgraded years ago.
  • Your solar project has stalled on something that predates it.
  • You want to know what an open permit does when the house is sold.

Cali Energy in Hollywood Hills

Hollywood Hills is City of Los Angeles above the basin, permitted through LADBS and interconnected through LADWP. Older houses that have been worked on repeatedly, which is where open permits tend to accumulate.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

Can a homeowner pull their own permit in California?

Yes. An owner-builder permit lets somebody take out a permit for work on property they own rather than going through a licensed contractor, and for a main panel upgrade it is not unusual. The obligations that come with the permit are the same either way.

What happens if a permit is never closed with a final?

It stays open against the address in the department's records. Nothing happens immediately — and that is the problem, because it surfaces later, at a sale or when somebody applies to work on the same equipment.

Why does an old panel permit affect a new solar project?

Because the array connects to that panel, and the interconnection is described in terms of its rating and busbar. The inspector arriving for the solar final is looking at equipment that already carries an unfinished authorization, in the same file.

How do I check whether my permit was finalled?

The building department keeps the inspection history against the address, so the answer is one query rather than an investigation. The time to ask is before ordering solar, not while waiting on the final.

Does Cali Energy install solar in Hollywood Hills, Los Angeles?

Yes, including on houses with history. Projects here are permitted through LADBS and interconnected through LADWP, and on older properties the first useful step is usually finding out what is already open against the address.

What this would look like on your roof

Every number above came off a real job in Hollywood Hills, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
