Palms, CA · March – May 2021 · LADWP / LADBS
Palms: the inspections nobody tells you about.
Owners are told about the final. On this project it was the third inspection, and the first one came back with a correction.
A solar permit is not inspected once. Depending on what the work touches there can be a rough inspection, while conduit, mounts and wiring are still open and visible; a service or pole inspection, covering the utility-facing equipment; and the final. Each is requested separately, scheduled separately and can separately come back with a correction. On this Palms project Cali Energy took the rough inspection at the start of April, cleared the correction it returned, and booked the service release and the final together for one day in May.
At a glance
- Inspections
- Rough, service release, then final
- Rough inspection
- Conducted 1 April
- Correction on it
- Issued the same day
- Service release and final
- Both booked for 17 May
- Permit
- Issued well before the work concluded
- Utility / AHJ
- LADWP / LADBS
The story
Almost everything written for homeowners about solar permits talks about one inspection. The final. It is the one people are told to expect, the one they arrange to be home for, and the one whose result they are given.
On this Palms project the final was the third inspection, and the first of them came back with a correction.
Here is the sequence, and why it exists.

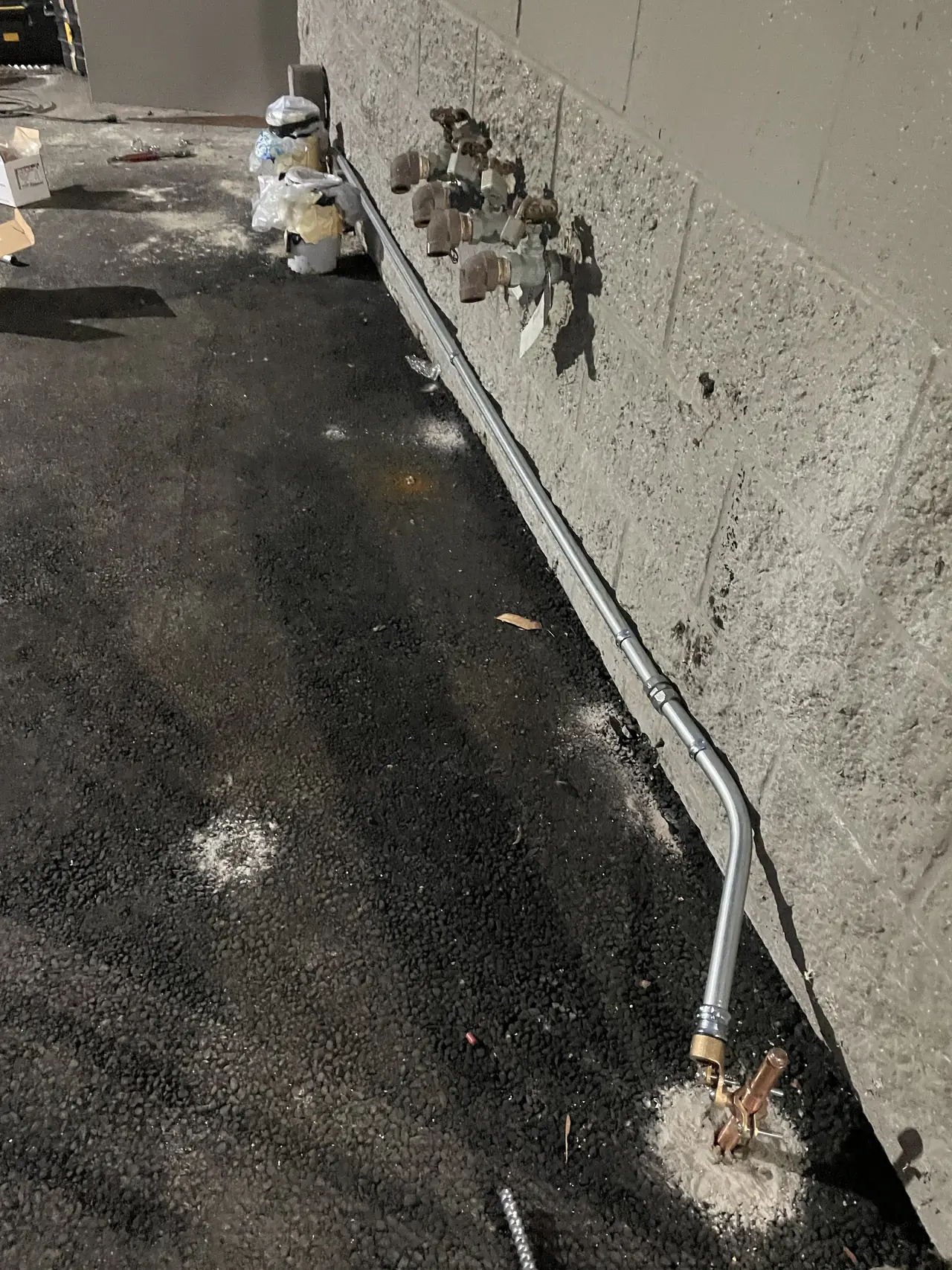

A rough inspection happens while the work is still open. Conduit that will be closed in, mounts that will disappear under modules, wiring that will be covered — somebody has to see those before they stop being visible. Once the array is on and the walls are made good, that examination is no longer possible without taking things apart, which is exactly why it is booked earlier rather than folded into the end.

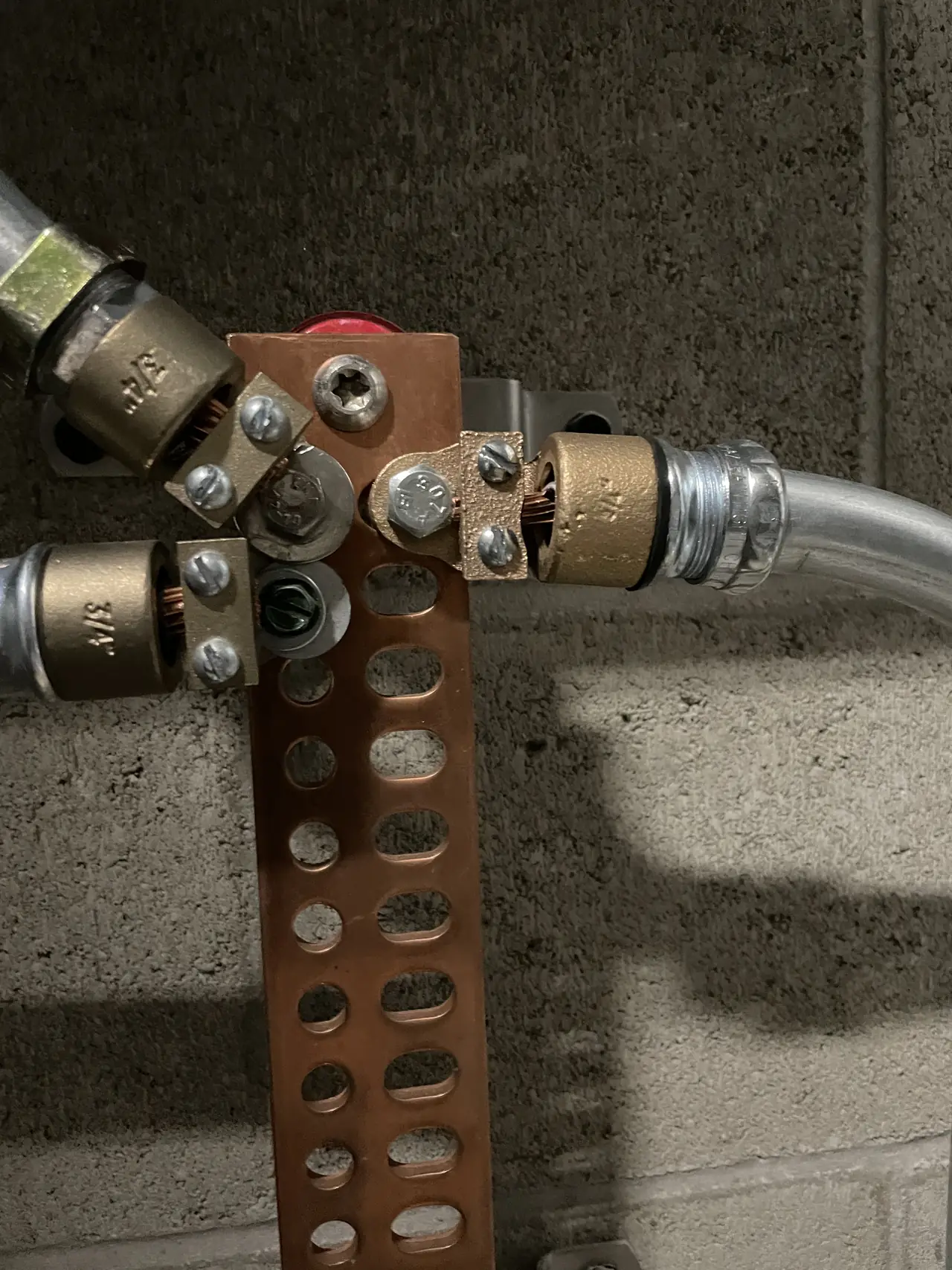

A service or pole inspection covers the equipment on the utility side: the service entrance, the meter position, the connection point. It is a different scope from the array and from the interior work, and it is treated as its own visit.
And then the final, which looks at the completed installation.
Each of them is its own request, its own slot and its own queue. That is the part that surprises people, because each one can be booked, waited for, missed, rescheduled and corrected independently of the others. A project is not one appointment with the building department; it is a series of them, and the calendar is the sum.
On this project the rough inspection was requested in the third week of March for the thirty-first. It was conducted on the first of April and returned a correction the same day, which is ordinary at that stage — the rough is the inspection that produces them most often, precisely because it is looking at work that is still accessible and therefore still cheap to change. A correction at rough costs an adjustment. The same item found at final costs opening something up.
The remaining two were requested together at the start of May, for the seventeenth: the service and power release, and the final. That is the other thing worth knowing about this sequence — inspections that belong to different stages can still be booked onto one visit when the work is ready for both.
One more thing owners ask about. The permit itself had been issued well before the work concluded. A permit is not a booking with a date attached; it is an authorization that stays valid while the job moves through its inspections, and a gap between the two is not by itself a problem.
What to do with all this as an owner: ask which inspections your project needs, not when the inspection is. If the answer is more than one, ask which of them is next — because the one you were told about is the last.
Cali Energy permitted this project and carried it through its inspection sequence in Palms, Los Angeles.
How it ran

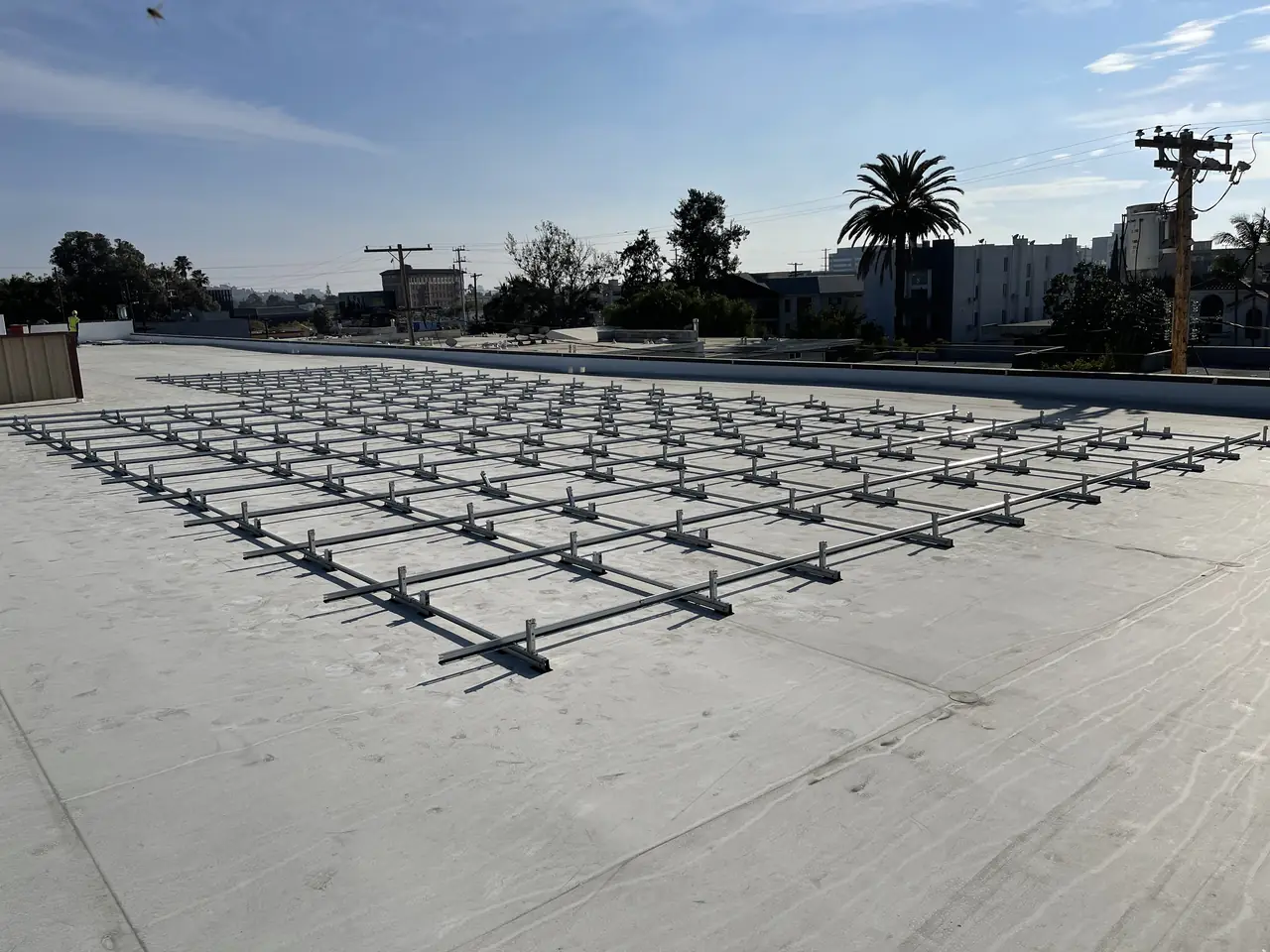

| February 2021 | Array set on the roof |
|---|---|
| 22 March 2021 | Rough inspection requested for the 31st |
| 1 April 2021 | Rough inspection conducted |
| 1 April 2021 | Correction issued against it |
| 6 May 2021 | Service and power release and the final requested together for the 17th |
| 17 May 2021 | Service and power release, and the final |
Two inspections and a correction before the one most owners think is the only one.
What we did
- Booked the rough inspection while the work was still accessible.
- Cleared the correction it returned at the stage where that is cheap.
- Booked the service release and the final together once the work was ready for both.
- Carried the permit through its full inspection sequence.
System specifications
| Array | Rooftop array on a flat roof |
|---|---|
| Rough inspection | Work examined while still open |
| Service release | Utility-facing equipment, its own scope |
| Final | The completed installation, booked for the same day in May |
| Corrections | Can be issued against any of them |
| Utility / AHJ | LADWP / LADBS |
Is your project like this one?
- You were told to expect one inspection and a second has appeared.
- Your project has a correction and you are not sure which stage it is against.
- Your permit was issued months ago and the work is still going.
- You want to know what an inspector actually looks at and when.
Cali Energy in Palms
Palms is a dense pocket of City of Los Angeles between the 10 and Culver City, permitted through LADBS and interconnected through LADWP. Work here often touches the service as well as the roof, which is what brings the extra inspections.
This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.
- License and classifications: CSLB #1032379
- Official reference for this process: LADBS — inspection
- Official reference for this process: LADBS — plan review and permitting
Frequently asked questions
How many inspections does a solar permit need?
More than one on most projects. Depending on what the work touches there can be a rough inspection while conduit, mounts and wiring are still visible, a service or pole inspection covering the utility-facing equipment, and the final on the completed installation. Each is requested and scheduled separately.
What is a rough inspection?
An examination of the work before it is covered up — conduit that will be closed in, mounts that will disappear under modules, wiring that will be concealed. Once the array is on, that look is no longer possible without dismantling something, which is why it is booked earlier rather than folded into the end.
Is a correction at rough inspection serious?
Less serious than the same item at final. The rough is the inspection that produces corrections most often, because it is looking at work that is still accessible and therefore still cheap to change. Found at final, the same item means opening something up again.
Why was the permit issued so long before the work finished?
Because a permit is an authorization rather than an appointment. It stays valid while the job moves through its inspections, and a gap between issuance and completion is not by itself a problem — projects wait on materials, on other trades and on inspection queues.
Does Cali Energy handle inspections in Palms, Los Angeles?
Yes, all of them. Palms projects are permitted through LADBS and interconnected through LADWP, and work here often touches the service as well as the roof — which is what brings the extra inspections rather than a single visit at the end.
What this would look like on your roof
Every number above came off a real job in Palms, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.
Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.
Related
This timeline reflects this property and this permitting path. Updated September 2026.
