Van Nuys, Los Angeles, CA · October 2023 – January 2024 · LADWP / LADBS

The array was finished. The paperwork was not.

Thirty-two modules on a cross-gable roof, inspected and released by the city three weeks after the application went in. Then nothing happened for two months. The form that turns a released job into a working one had been sent back, and the message had gone nowhere.

An LADWP solar project needs two things to finish: a final release from the building department, and an approved interconnection agreement on file with the utility. On this Van Nuys house the release arrived in three weeks, but the utility had returned the agreement for correction into a queue with nobody assigned to it, and the project sat untouched for two months. Cali Energy traced the stalled work request by phone, refiled the corrected agreement the same afternoon, and the net meter was set eight days later.

All-black solar modules across the planes of a composition shingle roof under a clear blue sky, Van Nuys, Los Angeles
Thirty-two modules split across the planes of a cross-gable roof.

At a glance

Array
32 modules, 395 W each — 12.64 kW DC
Inverters
32 microinverters, one per module
Size recorded by the utility
10.4 kW AC-CEC
Roof
Composition shingle, cross-gable
City release
Three weeks after the application
Idle time
Two months waiting on the interconnection agreement
Net meter
Eight days after the corrected form
Utility / AHJ
LADWP / LADBS

The story

The build itself was ordinary and quick. A single-family house with a cross-gable composition shingle roof, thirty-two 395-watt modules laid in three groups of eleven, eleven and ten, and a microinverter under every module. Rails went down across four planes, the modules followed, and the city released the job three weeks after the interconnection application was filed.

That release is a real milestone. It means an inspector has been on the roof and in the service equipment, that the work passed, and that the building department has told the utility so. On a normal project the utility then schedules a crew, swaps the meter, and the system starts producing.

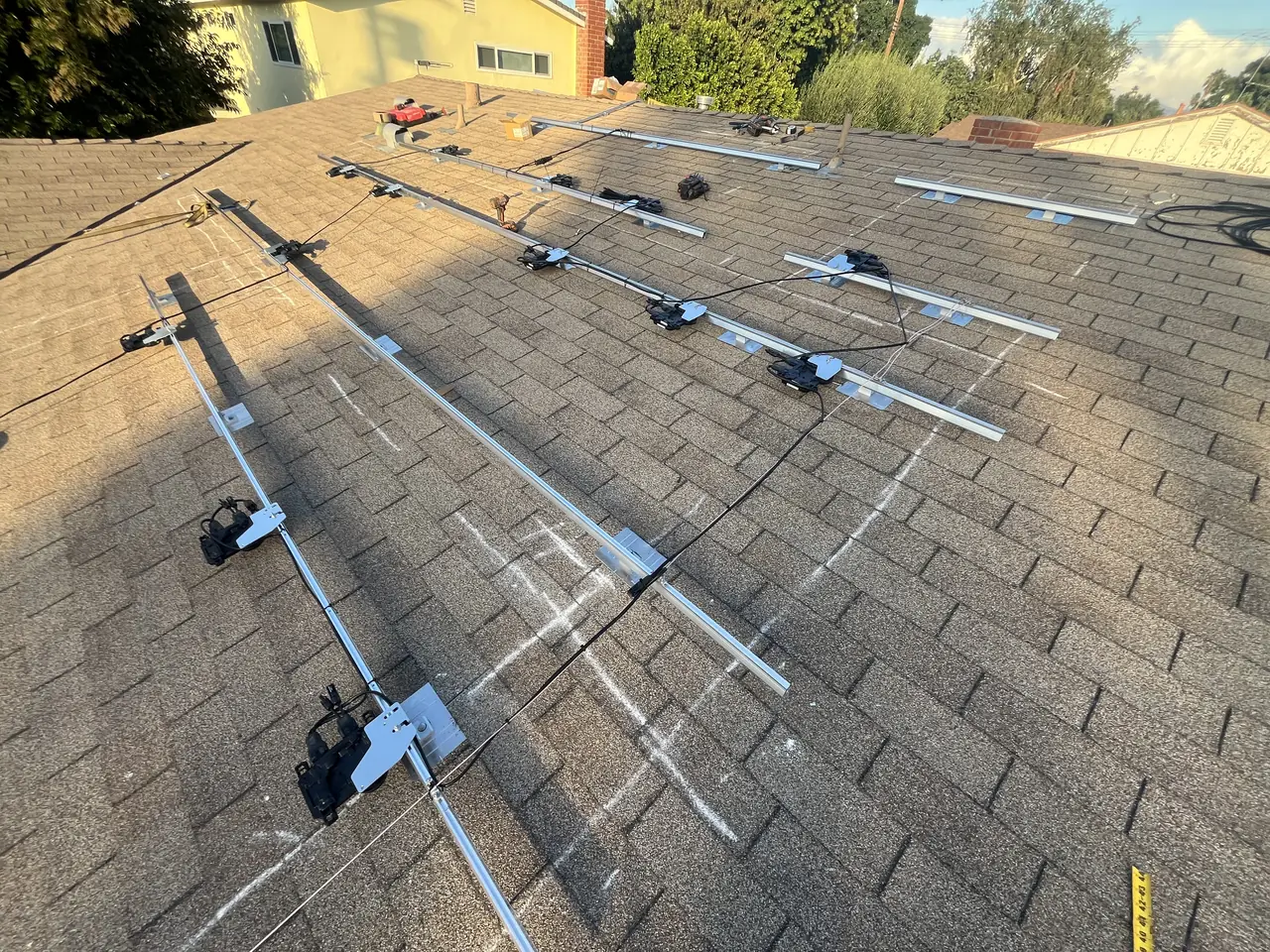

Aluminum mounting rails laid out across a shingle roof before the modules go on, with a suburban street beyond, Van Nuys, Los Angeles
Rails across four planes. The layout is set before a single module is carried up.

Here nothing happened. Not for a week, not for a month. The building side was closed and quiet. The utility side showed a work request that had been opened, assessed, and then simply stopped moving.

What had gone wrong was small. Alongside the application, a residential project files a Small System Interconnection Agreement — the document in which the customer and the contractor state the system's size, its equipment and its point of connection, and agree to the utility's terms for operating alongside the grid. The reviewer had found information on that form missing or incorrect and had sent it back with a note attached. The notice went into the same stream as a dozen routine progress updates, and the project stayed exactly where it was.

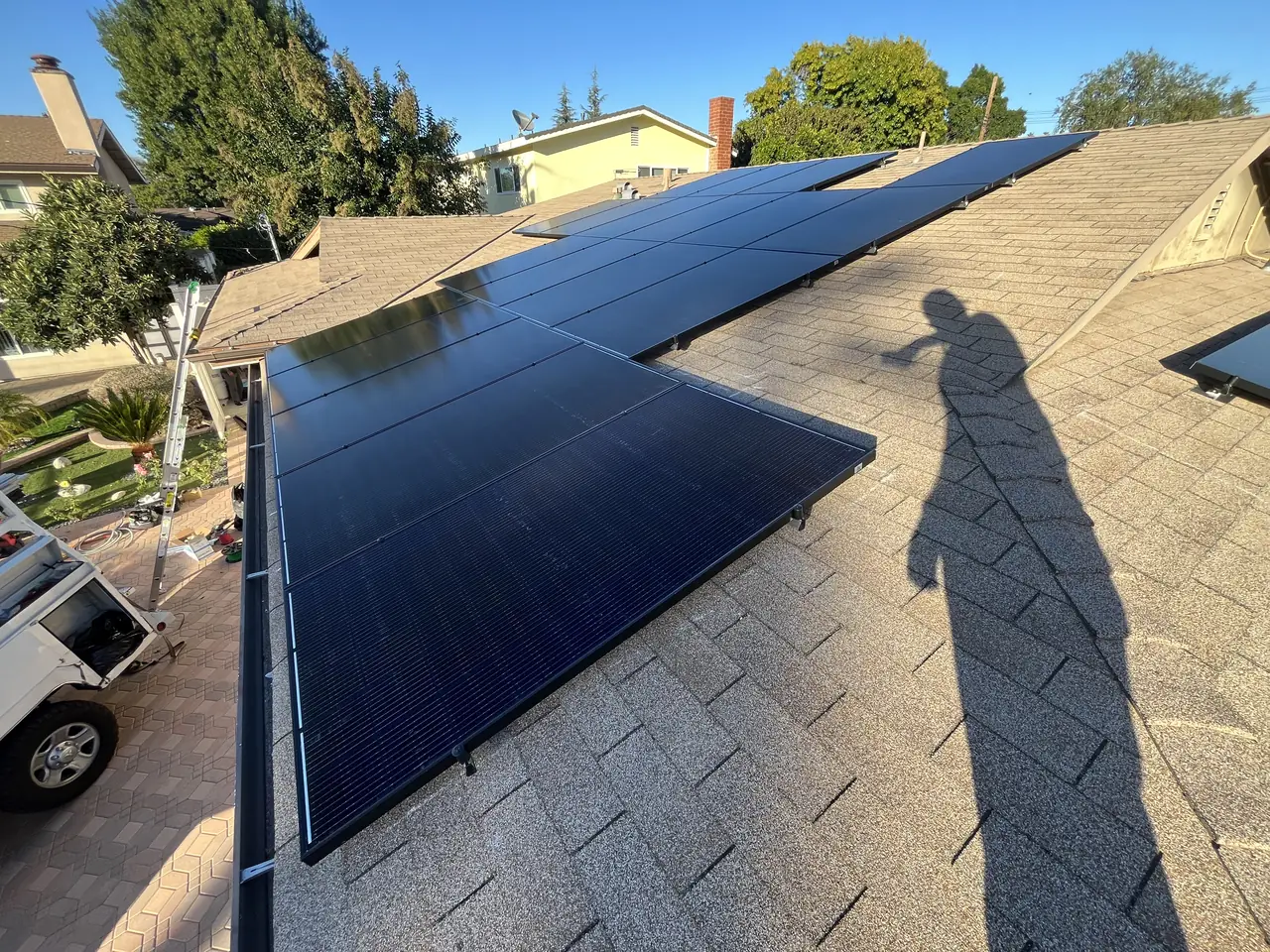

Two rows of black modules following the slope of a shingle roof toward the ridge, Van Nuys, Los Angeles
Eleven modules in the first group. The other two sit on the planes behind.

In January the project was called in to the utility directly. The answer came back plainly: the interconnection agreement had never been approved. Nobody was at fault in the field. The form had been reviewed, returned and left in a queue with no one assigned to look at it.

A coordinator walked through what had to happen: complete the agreement again, correct the fields that had been flagged, send it back. That was done the same afternoon. She confirmed receipt the same day, pushed the project to the construction field, and said to expect roughly a week.

It took eight days. The utility's crew pulled the old meter and set a new net meter in its place at the end of January, which is the moment a system in Los Angeles is allowed to run.

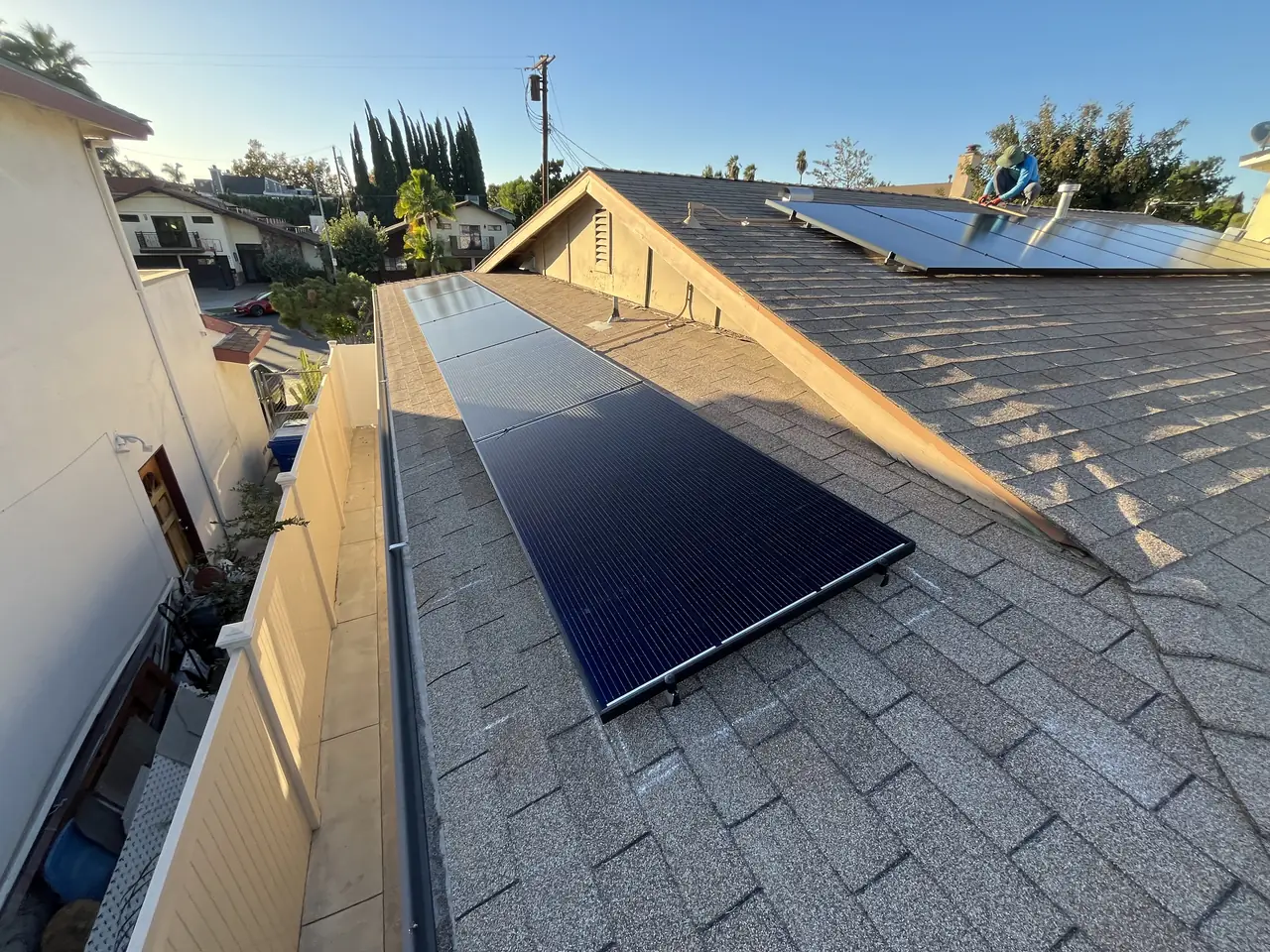

Black modules on the far slope of a shingle roof with rooftops and trees in the background, Van Nuys, Los Angeles
The far plane. Ten modules here, in the group that finishes the array.

The lesson is not about the form. Forms come back all the time, and correcting one takes twenty minutes. The lesson is that a solar project running through a large utility produces a stream of automated notices, most of which require nothing, and one of which is a request for action. If nobody is reading them as a queue rather than as mail, a finished array can sit on a roof doing nothing for as long as it takes somebody to notice.

Since this project, every LADWP job we run gets a standing check against the utility's own work request status rather than against the notices it sends. If the status has not moved in three weeks, somebody calls. It is a dull habit and it is the difference between eight days and two months.

How it ran

Late October 2023Interconnection application filed; recovery charge paid
Early November 2023Application reviewed, site assessment completed, meter spot issued
Mid-November 2023Final release from the building department
November – December 2023No movement on the utility side
Early January 2024Project called in; utility begins tracing the stalled work request
Mid-January 2024Utility confirms the agreement was never approved; corrected agreement filed and accepted the same day
Mid-January 2024Interconnection review complete; meter request issued
Late January 2024Net meter set — permission to operate

Three weeks from application to city release. Two more months before anyone found the returned form.

What we did

  • Designed a 32-module array across four planes of a cross-gable shingle roof.
  • Installed the mounting system, modules and a microinverter under each module.
  • Filed the interconnection application and carried the project through the utility's site assessment and meter spot.
  • Took the job through the building department's final inspection and release.
  • Traced the stalled work request, found the returned interconnection agreement and refiled it corrected the same day.
  • Followed the project to the meter swap and commissioned the system.

System specifications

Modules32 × 395 W, all-black — 12.64 kW DC
Inverters32 microinverters
Size recorded by the utility10.4 kW AC-CEC
GroupsThree: eleven, eleven and ten modules
RoofComposition shingle over four planes
MeteringExisting house meter swapped for a net meter
Utility / AHJLADWP / LADBS
