Sun Valley, CA · November 2023 · LADWP / LADBS

Two houses. Two routes. One day.

A newly built detached ADU and an extended single-family home a few doors apart in Sun Valley, both on LADWP, both granted permission to operate on 16 November 2023.

LADWP directed this project to use a manual filing process because the new unit did not yet have the service information required by the standard online workflow.

Solar array on a composition shingle roof with the neighbourhood behind, Sun Valley
The array on the newly built unit.

At a glance

Project A
1.74 kW AC-CEC
Project B
2.32 kW AC-CEC
A — building
New detached ADU
B — building
Extended home
A — filing
Manual
B — filing
Standard online
Both — PTO
16 November 2023
Utility / AHJ
LADWP / LADBS

The story

Two houses a few doors apart. Two systems of a couple of kilowatts each. Permission to operate granted on the same day, meters set one after the other.

From the street they look like the same project twice. On paper they are not.

One is a newly built detached accessory dwelling unit, twenty-seven by forty feet, put up under the city's ADU ordinance and issued its certificate of occupancy. The other is a house that had been there for decades and had just grown: a detached garage taken down and close to a thousand square feet added at the rear, plus smaller additions at the front and a porch.

Junction box and conduit on a composition shingle roof beside a solar module, Sun Valley

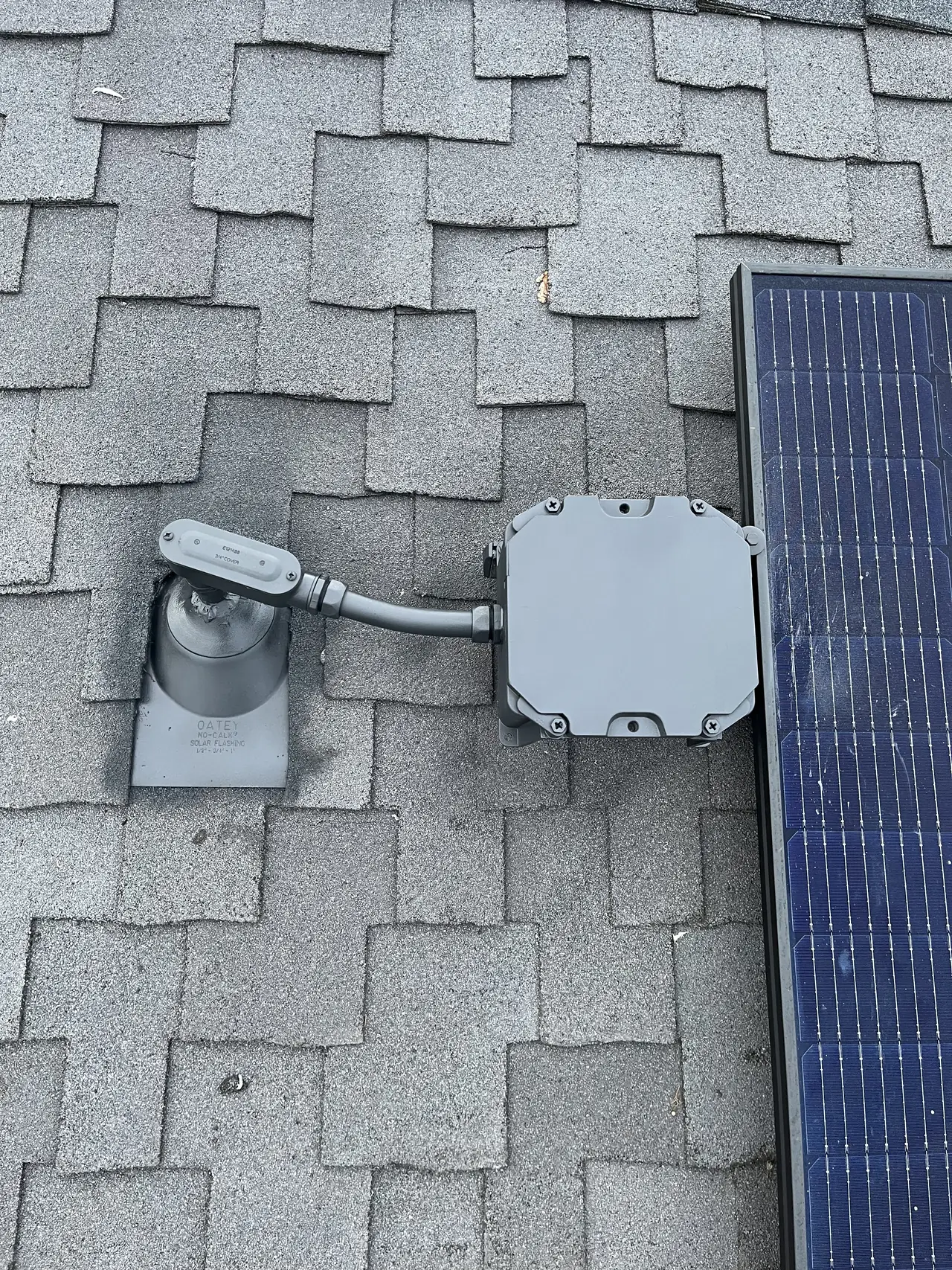

Roof penetration on the new unit.

The filing routes differed too, and this is the part worth knowing.

The standard online interconnection application is built around an address that already has a service and an account. A brand-new unit has neither yet. For the ADU the utility directed us to file manually, under a separate set of instructions that has to be requested first. We asked, filed by hand and cleared the fee the same day.

Solar array on a composition shingle roof under cloud, Sun Valley

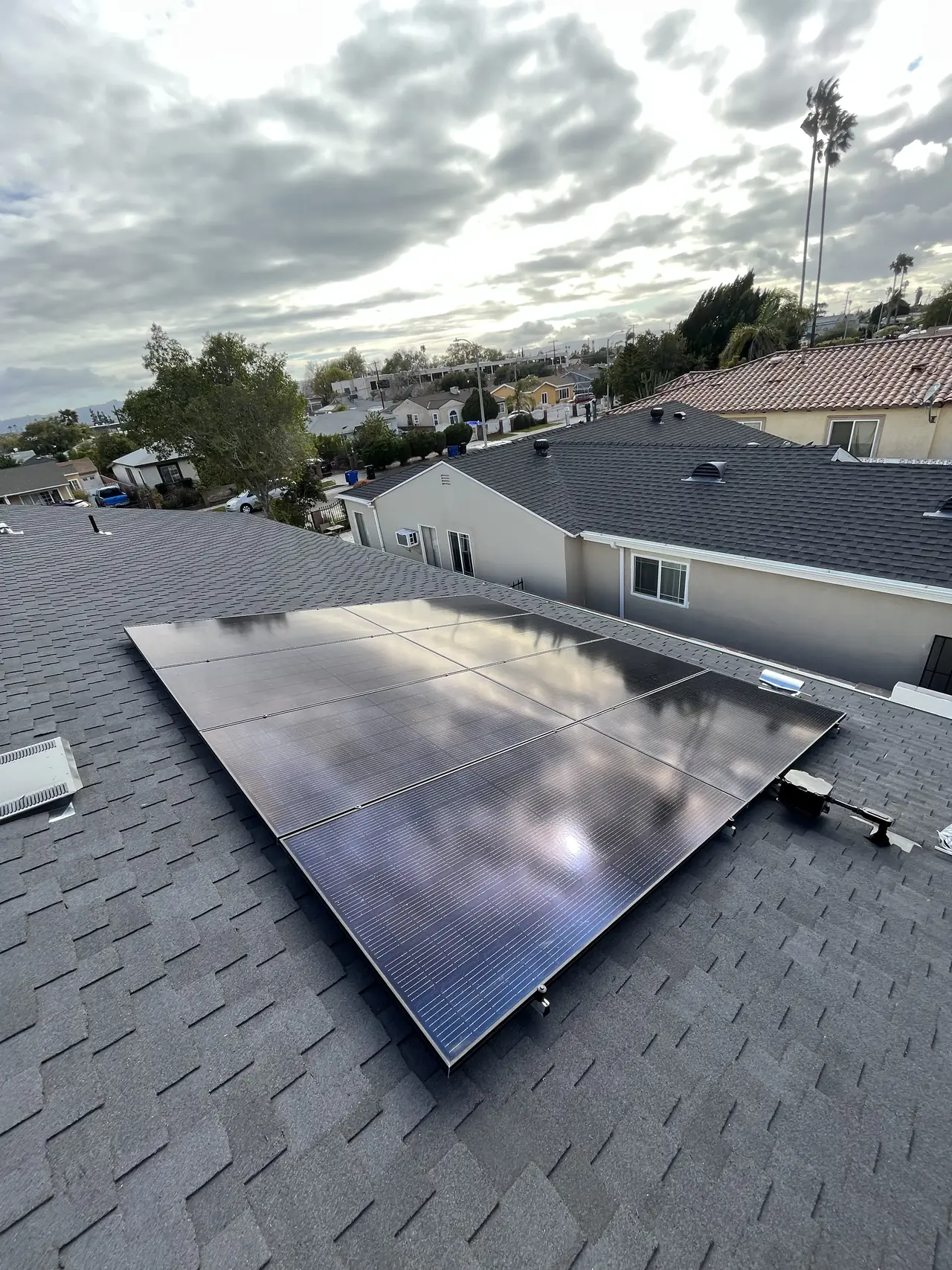

The extended house, two doors along.

The neighboring house had an address and an account already, so its application went in through the usual route — and a week earlier.

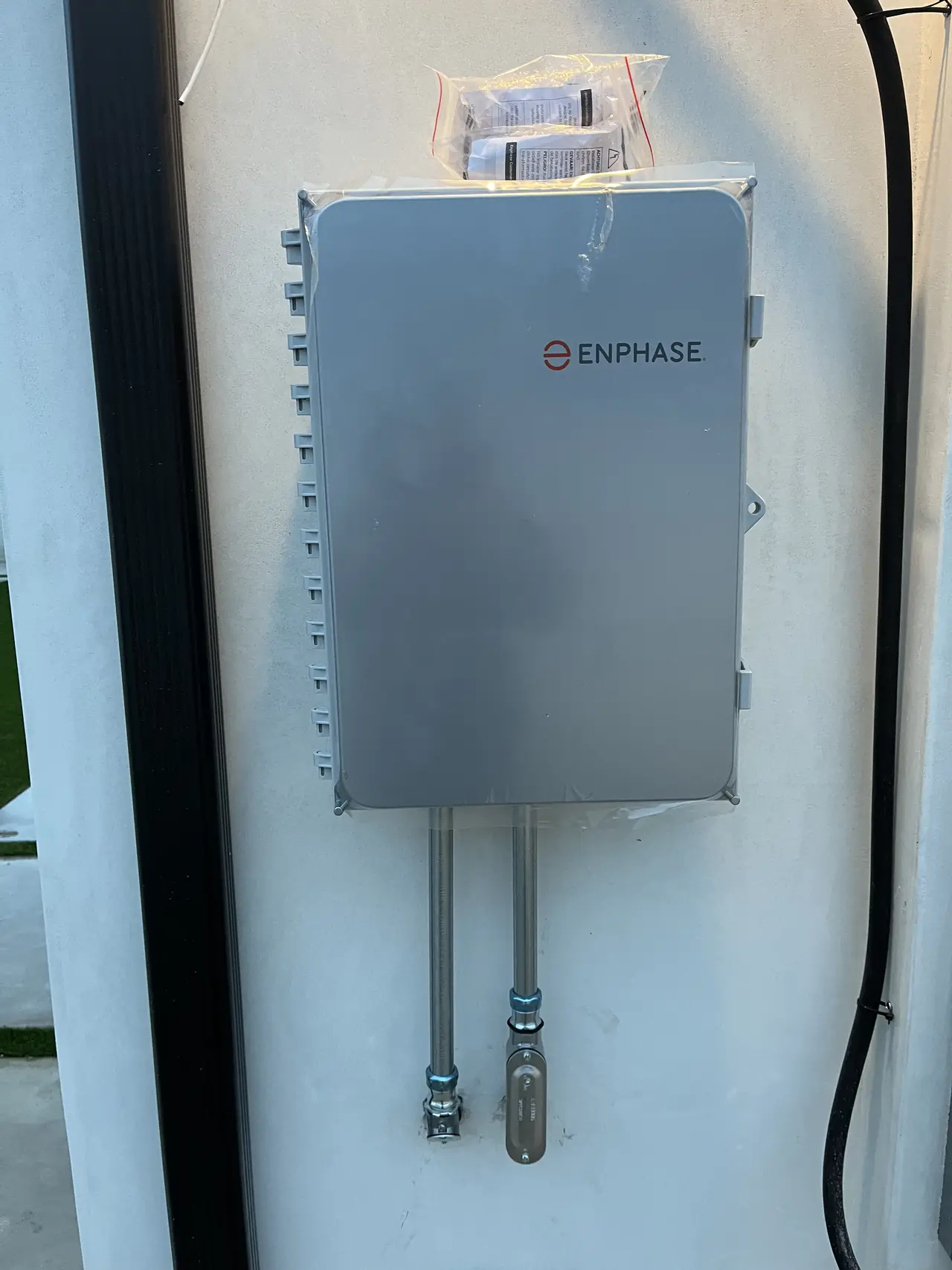

Enphase gateway mounted on an exterior wall, Sun Valley
Monitoring gateway at the service wall.

They converged anyway. Both received their building department release on the same day in November, and both were authorized on the same day after that. Forty-one days end to end for the one filed by hand, forty-nine for the one filed online.

How it ran

28 September 2023B — interconnection application filed online
4 October 2023B — application reviewed, site assessment closed
6 October 2023A — manual filing instructions requested, application filed, fee cleared
19 October 2023A — application reviewed, site assessment closed
7 November 2023Both — building department final release
16 November 2023Both — permission to operate granted

Both figures run from the interconnection application to Permission to Operate: 41 calendar days on the new unit, 49 on the extended house.

What we did

  • Requested the manual filing instructions for the newly built unit and filed by hand.
  • Cleared the interconnection fee the same day the manual application went in.
  • Filed the neighboring project through the standard online route.
  • Carried both through building department release to permission to operate.

System specifications

A — system1.74 kW AC-CEC
A — buildingNew detached ADU, 27 × 40 ft, certificate of occupancy issued
A — filing routeManual interconnection application
B — system2.32 kW AC-CEC
B — buildingExisting home; detached garage demolished, rear addition of roughly 36 × 31 ft, certificate of occupancy issued
B — filing routeStandard online application
B — meterExisting meter replaced
BatteryNone on either
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You have just built a detached ADU and nobody can tell you how to apply.
  • Your new unit has no utility account yet and the online form will not accept it.
  • You have extended your house and are rethinking the electrical side.
  • You are running two projects on one property or one street at once.
  • You are on LADWP.

Cali Energy in Sun Valley

Sun Valley sits inside City of Los Angeles boundaries, so every project here is permitted through LADBS and interconnected through LADWP. Our work in this ZIP code runs from single-row arrays on new accessory dwelling units to a 13 kW system on a replaced service panel, on composition shingle and on low-slope rolled composition.

Not all of it is on main houses. New accessory dwelling units and extended homes carry arrays too, often small ones on a service that needs no change.

This installation is on the Sun Valley projects page alongside the others, and what the work covers is set out on the Sun Valley service area page.

Frequently asked questions

How do you apply for solar interconnection on a brand-new ADU?

The standard online application assumes an address with an existing service and account. A newly built unit has neither, so on this project the utility directed us to file manually under a separate set of instructions, which have to be requested first. The application went in by hand and the fee was cleared the same day.

Does a new detached ADU need solar?

New detached accessory dwelling units in California generally fall under the solar requirement in the Energy Code, but there are exemptions — including limited available solar area and small calculated systems. What applies to a particular unit comes from its own compliance documents, so it is a question for the plans rather than a rule of thumb.

Why would two similar projects take different lengths of time?

Here the difference was the filing route, not the work. The project with an existing address filed online a week earlier; the new unit had to request manual instructions first. Both received their building department release and their authorization on the same days, which is why the end-to-end figures differ while the finish does not.
