South Los Angeles, CA · November – December 2024 · LADWP / LADBS

South Los Angeles: the correction had a queue of its own.

Filing the answer took two days. Getting it in front of an engineer took another nineteen.

When a correction at the final cannot be closed on site, the project goes back through plan check — and plan check is a separate queue with its own stages: a completeness review, a fee, an assignment to an engineer, and then either approval or a further set of corrections. Each stage arrives as a status rather than a conversation. On this South Los Angeles project the correction came in mid-November, the new application was filed two days later and deemed complete within four, and it was still the third of December before an engineer had it. Cali Energy ran the inspection request and the drawing review side by side.

A solar array on a composition shingle roof seen from above, South Los Angeles
Finished, and waiting on a queue it had only just joined.

At a glance

First final
Correction issued
New application filed
Two days later
Deemed complete
Four days after filing
Reached an engineer
Nineteen days after filing
Then
A second set of corrections, against the drawings
Utility / AHJ
LADWP / LADBS

The story

Some corrections at the final are an hour of work. A label in the wrong place, a cover not fitted, a conductor that needs clipping up. The inspector writes it, somebody fixes it, the permit closes.

And some corrections cannot be answered on the roof at all, because what is being questioned is not the work but the description of it. Those go back through plan check, and plan check runs on a different calendar.

The distinction matters more than it sounds. An inspection compares the installation against the approved drawings. Plan check compares the drawings against the code. Different people, different departments, different queues — and being in one of them does not move you along the other.

Here is what the second queue actually looks like from inside, because it is mostly invisible from outside.

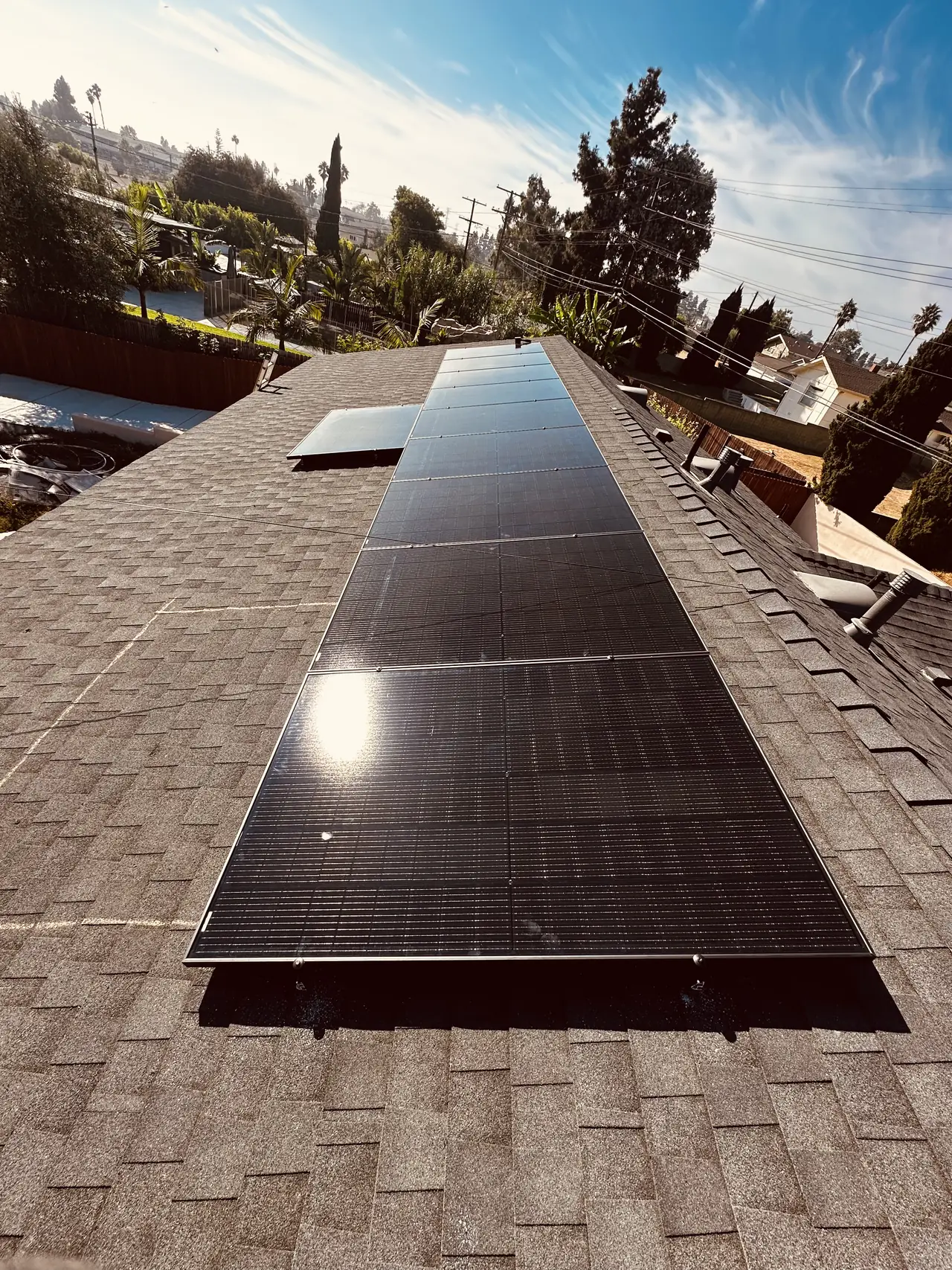

Solar modules on a shingle roof against a clear sky, South Los Angeles
The work was not the question. The drawing was.

The application goes in with its documents and enters a completeness review. This is not a technical review: somebody checks that what was filed is a whole submission. The department's stated target is two business days. On this project it took four.

Then the application is deemed complete, and — for a project classified as small, which a residential solar job normally is — it qualifies for a virtual counter appointment. That is worth knowing, and worth not over-reading: the appointment makes the conversation easier, it does not change your place in the line.

Then the fee. Until the plan check fee is paid the application is complete but not accepted, and an unaccepted application is not in the queue at all. This is the cheapest day to lose and the easiest one to lose.

Then assignment. The file goes to a plan check engineer, and this is where the time actually goes. Four days to be called complete; another fifteen before anyone was looking at it.

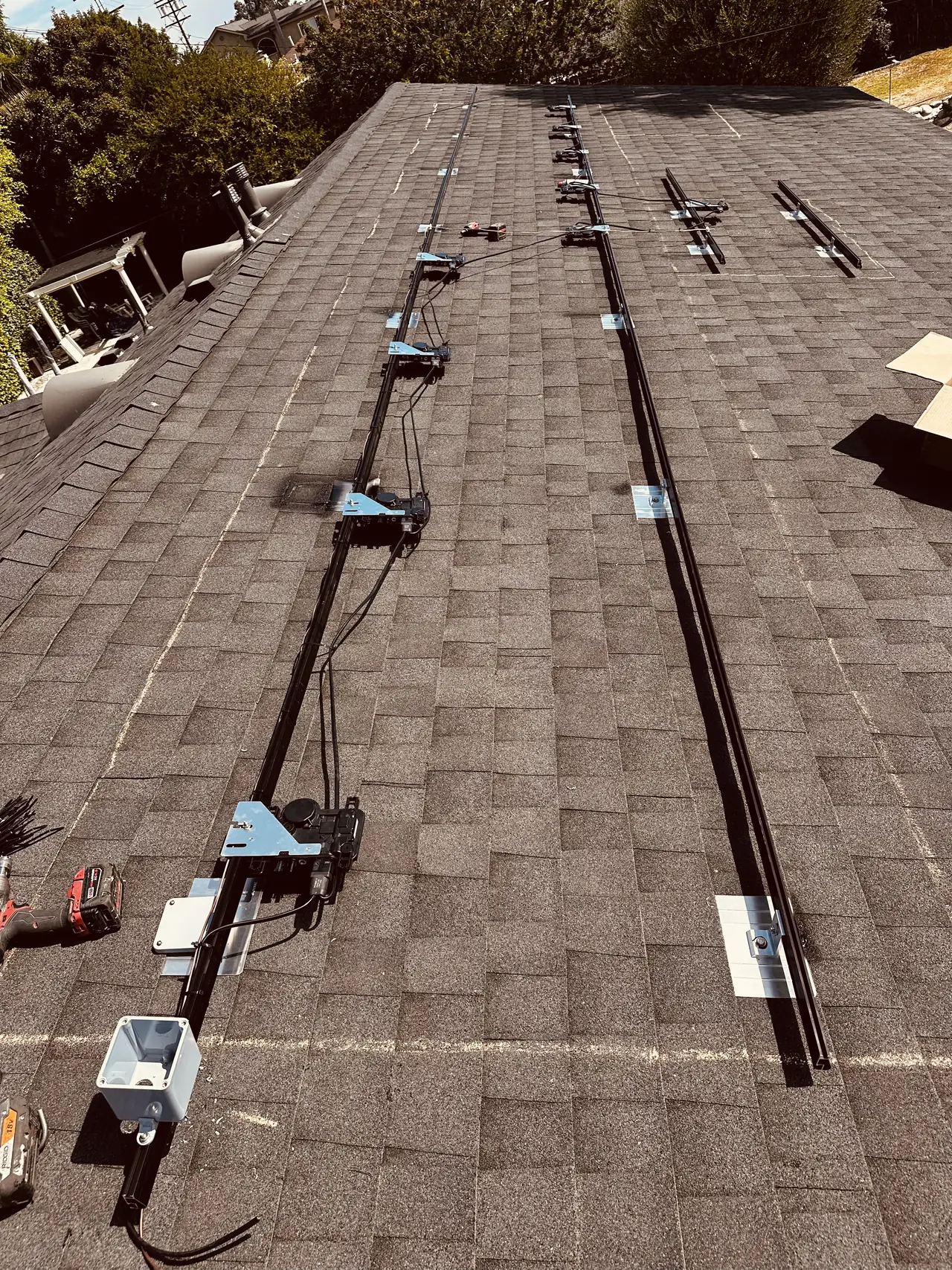

Mounting rails laid in rows across a shingle roof before the modules, South Los Angeles
What an inspection compares against the approved set.

And then, on the same day it was assigned, the answer: corrections issued. Not against the work this time — against the plans.

Meanwhile we had a second final inspection booked for the beginning of December. That was the right thing to do and it did not speed anything up. Until the revised set is approved there is nothing for an inspector to compare the roof against; the booking only saves the days between approval and the next available slot.

What happens from there is fixed in order, even when the dates are not. The corrections get answered and the revised set goes back in. The set is approved. Only at that point does an inspection mean anything, because only then is there a drawing for the roof to match. And permission to operate sits behind all of it: the utility does not switch on a system whose permit has not closed.

What an owner should take from this is a better question to ask. Not «when is the inspection» — that answer is available and usually misleading. The question is which queue the project is in right now, and what the next status will be. Complete, accepted, assigned, corrected, approved: five words that describe where a file really is.

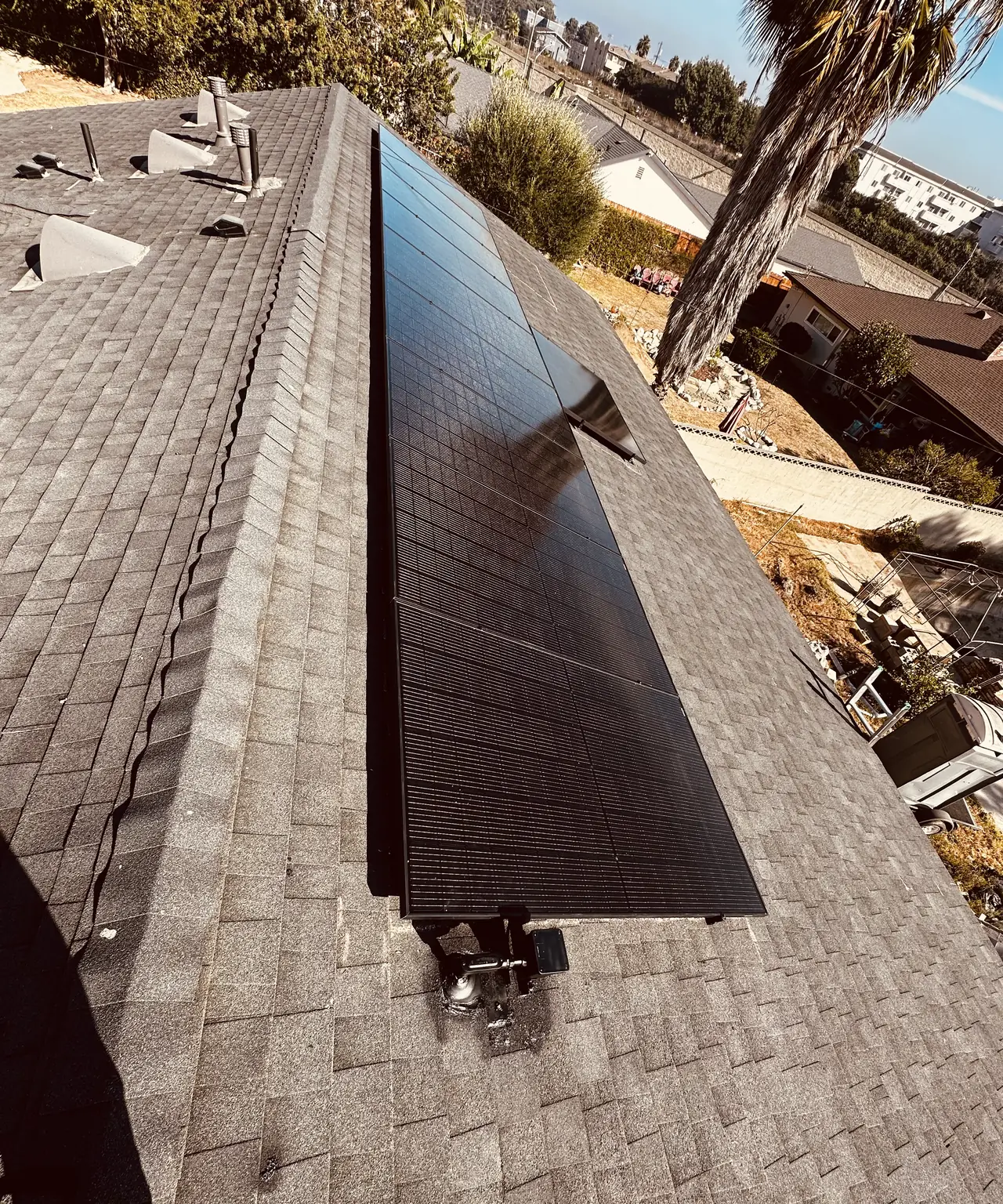

The array running along the ridge of the roof, South Los Angeles
Built in October, and still waiting on a drawing in December.

Cali Energy permitted this project and carried both queues in South Los Angeles.

How it ran

7 October 2024Installation begins
11 October 2024Array complete
7 November 2024Final inspection requested for the 12th
12 November 2024Correction issued against the final
14 November 2024New application filed; completeness review begins
18 November 2024Application deemed complete; qualifies as a small project
19 November 2024Plan check fee paid; application accepted
27 November 2024Second final inspection requested, for 3 December
3 December 2024Application assigned to a plan check engineer
3 December 2024Corrections issued — this time against the drawings
After thatCorrections answered, the set approved, and only then does the final have something to check against

Two queues on one project: one for the work, one for the paper, and only one of them was moving.

What we did

  • Filed the new application two days after the correction rather than waiting.
  • Paid the plan check fee the day the application was accepted, so the file could enter the queue.
  • Kept a second inspection request booked while the drawings were in review.
  • Tracked the file by its status rather than by telephone.

System specifications

ArrayResidential rooftop
First finalCorrection issued
Route to close itBack through plan check
Application stagesComplete, accepted, assigned, corrected
Small-project routeQualified for a virtual counter appointment
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your final came back with a correction and the fix is not on the roof.
  • You have been told to file a new application after an inspection.
  • Your project is in plan check and the statuses mean nothing to you.
  • You want to know where the waiting actually happens.

Cali Energy in South Los Angeles

This is the Vermont Knolls side of South Los Angeles, inside the city and permitted through LADBS, interconnected through LADWP. Small single-story lots, often with a second structure at the back, and the same permit counter as the rest of the city.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

What is the difference between plan check and inspection?

Plan check is an engineer comparing the drawings against the code, normally before the work. Inspection is an inspector comparing the work against the approved drawings, after it. Different departments and different queues, and progress in one does not move the other.

Can a correction at the final send a project back to plan check?

Yes, when the item questioned is the description rather than the workmanship — the installed arrangement is not what the approved set shows. The fix is then to the drawings, which means a new application, a fee, a queue and possibly a further round of corrections.

What do the plan check statuses mean?

Submitted means the paperwork is being checked for completeness, not reviewed. Complete means the submission is whole. Accepted means the fee has been paid and it is in the queue. Assigned means an engineer has it. After that comes either approval or corrections.

Does booking another inspection speed things up?

No. Until the revised drawings are approved there is nothing for the inspector to compare the installation against. Booking ahead saves only the gap between approval and the next free slot, which is worth having but is not the delay.

Does Cali Energy handle solar permits in South Los Angeles?

Yes, including around Vermont Knolls and the blocks either side of it. Projects here go through LADBS for permitting and LADWP for interconnection, the same as the rest of the city. Where a job ends up in plan check after an inspection, the part that needs managing is the order of the statuses rather than the phone calls.

What this would look like on your roof

Every number above came off a real job in South Los Angeles, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
