Granada Hills, CA · November 2025 · LADWP / LADBS
The sealant is not what keeps the water out. The flashing is.
An array on composition shingle, documented one attachment at a time. Every mount on this roof is the same three steps, and the order of them is what decides whether a roof leaks in year eight.
A solar mount on a shingle roof is a hole through the covering, and there are two ways to close it. The wrong way is a bead of sealant over the fastener: it looks finished, it works for a few seasons, and then the sealant fails because sealant always fails. The right way is a metal flashing plate slid up under the course above the hole, so water running down the roof passes over the metal and back onto the shingle below. Sealant goes under the plate as a secondary barrier, not as the barrier.
At a glance
- Roof
- Composition shingle
- Array
- Across several roof planes
- Every mount
- On a flashing plate, slid under the course above
- Sealant
- Horseshoe bead at each fastener, open at the downhill side
- Penetrations
- Existing vent pipes re-flashed where the work reached them
- Utility / AHJ
- LADWP / LADBS
The story
One detail gets repeated at every attachment on this roof, and it is the detail that decides whether a roof with an array on it is still dry in fifteen years, and it is invisible from the ground the day it is finished.
An attachment holding solar racking is a lag bolt driven through the covering into the structure. That is a hole in a roof. Whatever you do next is the entire waterproofing of that hole.
Start with what the sealant is and is not. It is a secondary barrier. It is not the waterproofing, and a roof where the sealant is doing the work is a roof on a timer — every sealant eventually shrinks, cracks and lets go, and a mount sealed that way fails silently, under a module, where nobody looks.

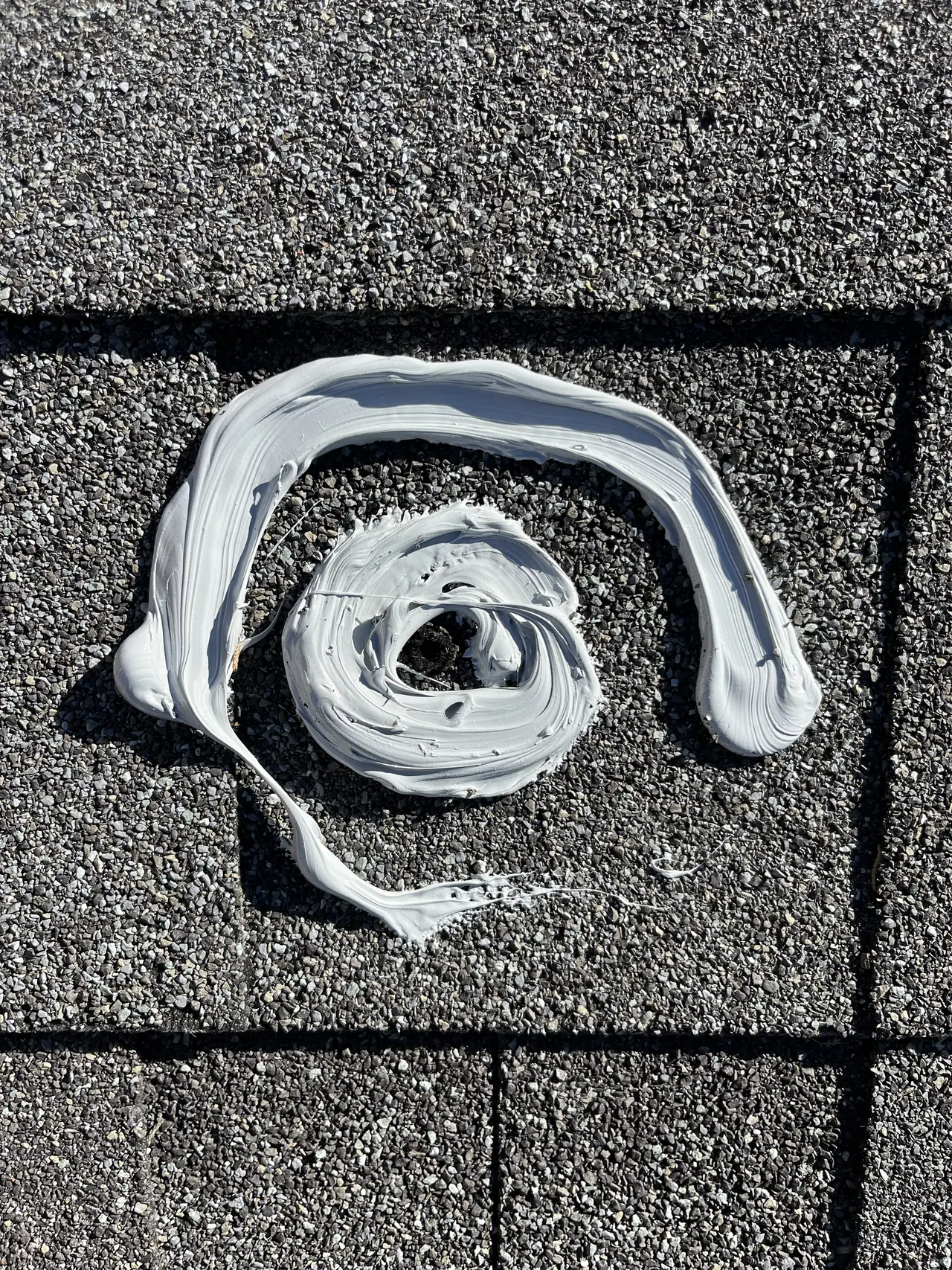

Two things about the bead in the photograph. It is applied around the hole before anything goes on top of it, not squeezed over the top afterwards. And it is a horseshoe rather than a closed ring — open at the downhill side. A closed ring would dam any water that did get under the plate and hold it against the hole. Left open at the bottom, the same water runs out.

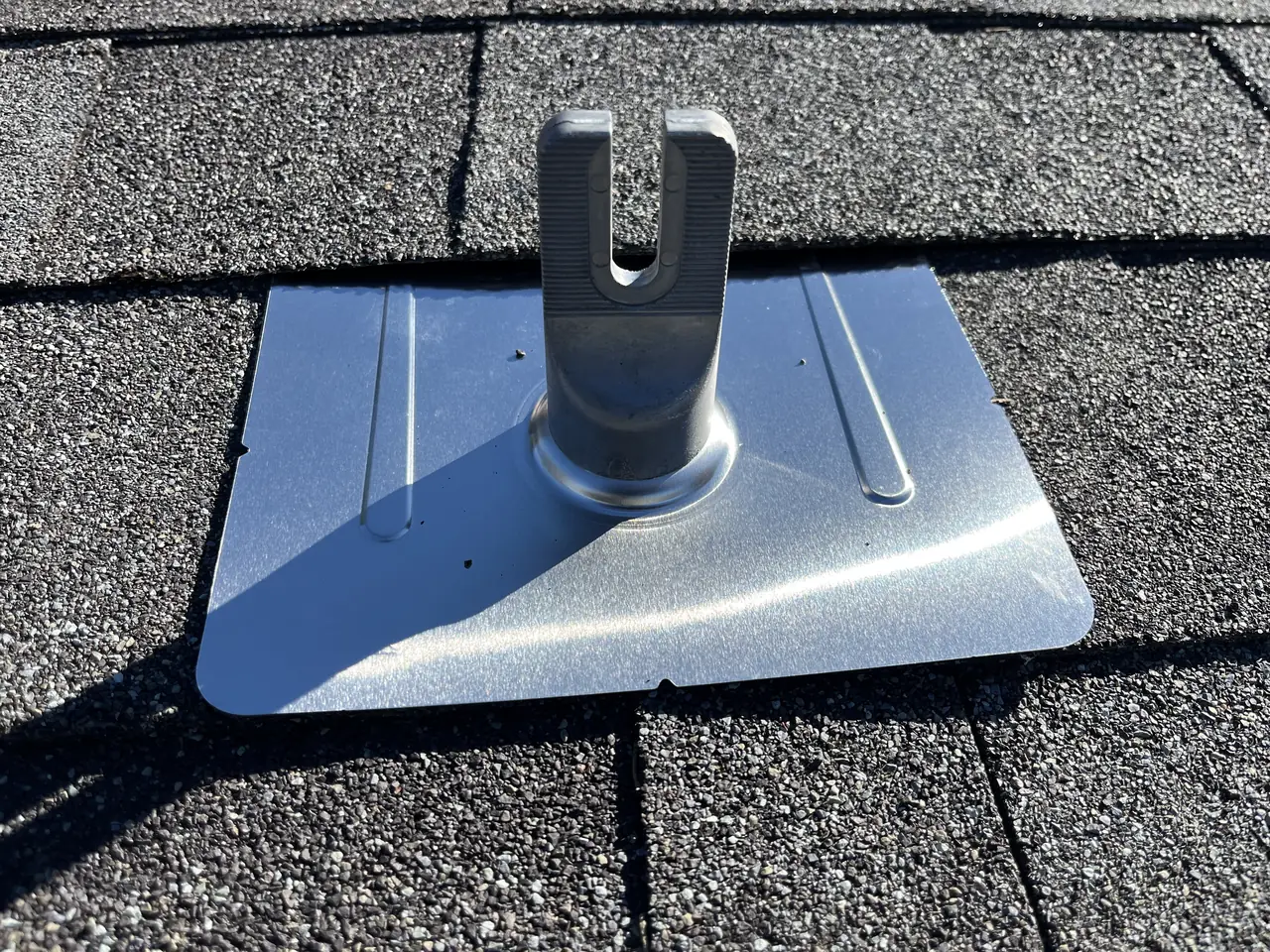

Then the flashing. A flat metal plate goes over the fastener, and the top edge of that plate slides up underneath the shingle course above it. That is the part people miss. Water running down a shingle roof reaches the plate, travels over the metal, and comes back out onto the shingle below the plate — it never reaches the hole, because the hole is under metal that is itself under a shingle.
If the plate is laid on top of the shingles instead of tucked under the course, the geometry is reversed: water runs down the shingle and straight onto the upslope edge of the plate, where the only thing stopping it is sealant. That installation looks identical from the driveway and is a different roof entirely.

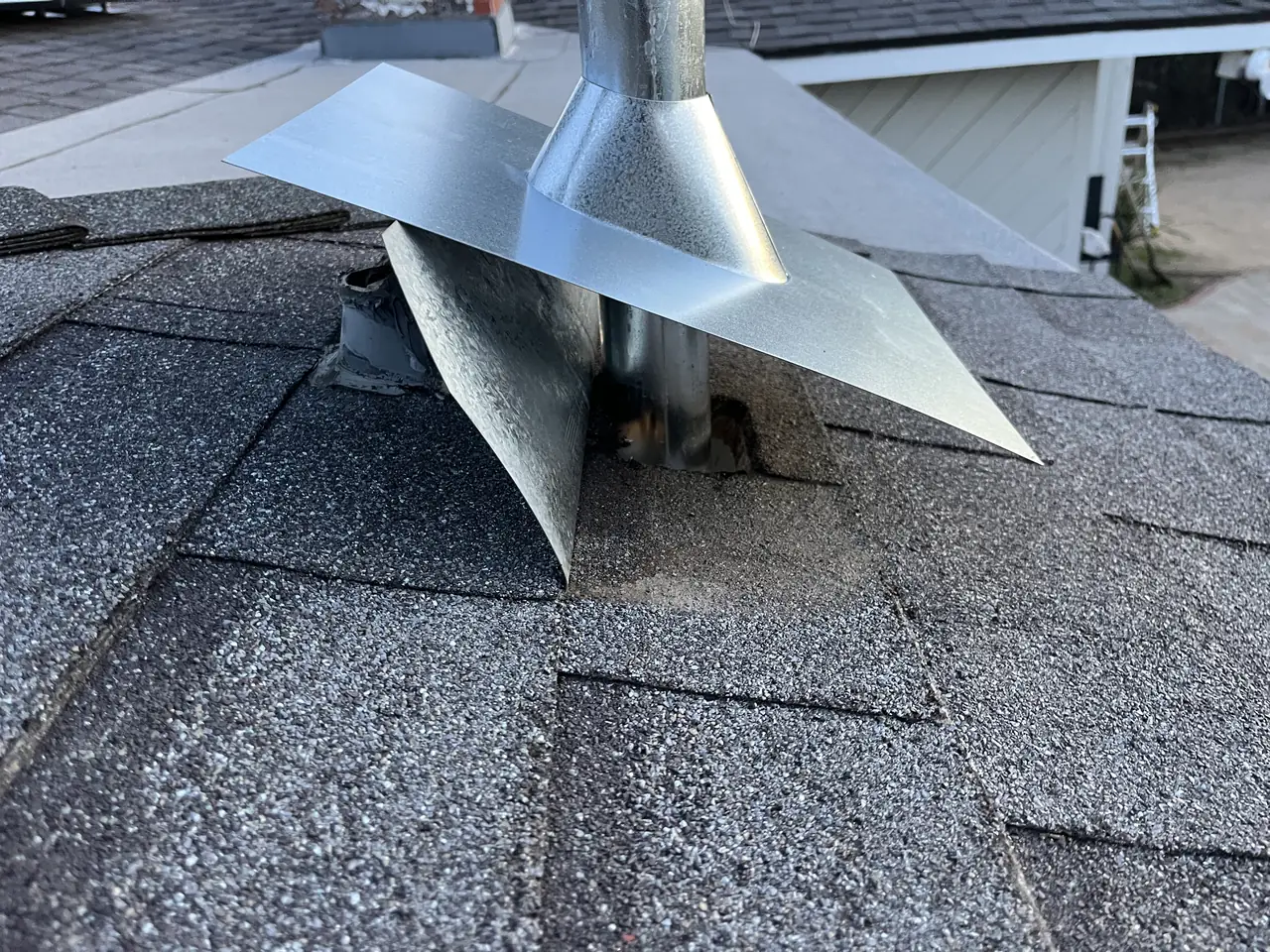

One more thing this roof shows. Where the work reached an existing penetration — a vent pipe, a flue — that penetration was re-flashed rather than worked around. Old pipe flashings on a roof of any age are frequently the first thing to fail, and they sit in exactly the part of the roof where an array is about to make future access expensive. Doing them while the crew is already up there costs an hour.
What to ask, if you are having this done. Ask whether the mounts are flashed or sealed. If the answer is sealed, that is your answer about the whole job. Ask to be sent photographs of the flashings before the modules go on — every competent installer takes them anyway, because they are the evidence the work was done properly and the only evidence that exists once the array is on top.
And if somebody is already on your roof, ask them to look at the existing pipe flashings while they are there. It is the cheapest roofing work you will ever buy, and the window closes the day the array goes on.
The modules went on over flashed attachments and re-flashed vents, the final passed and the system has been running since. Cali Energy flashes every mount on a Granada Hills shingle roof, because the alternative is a roof warranted by a tube of sealant.
How it ran
| November 2025 | Attachments set and flashed, mount by mount |
|---|---|
| November 2025 | Existing vent penetrations re-flashed |
| November 2025 | Rails and modules set across several roof planes |
One detail, repeated at every attachment. That is the whole standard.
What we did
- Flashed every attachment with a plate tucked under the shingle course above it.
- Applied sealant under the plate, open at the downhill side, as a secondary barrier.
- Re-flashed existing vent penetrations while the roof was accessible.
- Photographed each attachment before the modules covered it.
System specifications
| Roof | Composition shingle |
|---|---|
| Array | Across several planes of the same roof |
| Attachment | Lag into structure, flashing plate under the course above |
| Sealant | Applied under the plate as a horseshoe, open at the downhill side |
| Existing penetrations | Vent pipes re-flashed while the roof was open |
| Evidence | Each attachment photographed before the modules went on |
| Utility / AHJ | LADWP / LADBS |
