Granada Hills, CA · January – September 2026 · LADWP / LADBS
The unit had no address, so the application went in under the main house.
A small array on a new accessory dwelling, and a hundred and eight days between the first confirmation and permission to operate — almost all of it spent on which address the record belonged to.
An interconnection request is filed against a service address. An accessory dwelling that will have its own meter does not necessarily have its own address yet, so the request goes in under the main house and has to be corrected later. Until the correction lands, the utility's own staff cannot find the work request when they search the address the meter is actually on. It is a records problem, not an engineering one, and it costs real weeks.
At a glance
- Building
- New detached accessory dwelling behind a main house
- Recorded by the utility
- 1.99 kW
- Modules
- 5 × Mission 410 W
- Microinverters
- 5 × Enphase IQ8A
- First confirmation
- 10 March 2026 — under the main house address
- Notices reissued
- 26 May 2026 — under the ADU address
- Permission to operate
- 26 June 2026
- First confirmation to permission
- 108 days
The story
The estimate for this system was written in January 2026, and the internal note attached to it records the constraint: the accessory dwelling will have its own main panel and its own meter installed on the unit itself, and no address has been assigned to it yet.
That is not unusual and it is not anybody's mistake. An accessory dwelling gets a meter when the service is built. It gets an address when the city assigns one, and those two events are not coordinated. In between there is a building with a service, a meter and no name.
So the interconnection request went in against the only address that existed — the main house. The first confirmation came back on the tenth of March, naming the main house, for a system of 1.99 kilowatts.
Then the record had to catch up with the building. The notices stopped and restarted in the second half of May, this time naming the accessory dwelling, and the review chain effectively ran again from there.
The clearest illustration of the cost came in June. Writing to the utility about the project under the main house address, the reply came back: no work orders for this address. The work request existed, the system was on the roof, and the representative searching the address he had been given could not see it — because by then the record lived under the other one.
What untangles it is nothing clever: reply with both addresses, say plainly which is the main house and which is the unit, and name the work request number so the search is not against a string at all. That is the whole fix, and it works because everybody on the other end is also trying to find the same job.
The building department's final release was issued on the twenty-first of May. The site evaluation, the representative's approval and the meter request landed together on the twenty-third of June, and permission to operate followed three days later. A hundred and eight days from the first confirmation.
The system has run since June, and the owner's monitoring account is live.
If you are building an accessory dwelling with its own meter, ask the city when the address will be assigned, and tell your installer the moment it is. Everything downstream — the interconnection record, the meter, the monitoring account, the bill — is filed against that string, and every week it does not exist is a week somebody is filing against the wrong one.
Permission to operate came through in June and the accessory dwelling has run on its own meter since. Cali Energy carried this Granada Hills project through an address that did not exist for most of it. The drawing problem that ran alongside it is on one character in a part number.
How it ran
| January 2026 | Estimate prepared; the accessory dwelling will have its own meter and no address has been assigned yet |
|---|---|
| 10 March 2026 | Interconnection request confirmed under the main house address |
| 21 May 2026 | Building department's final release issued |
| 26 May 2026 | Notices reissued under the accessory dwelling's own address |
| 23 June 2026 | Site evaluation, approval and meter request, all together |
| 23 June 2026 | Utility representative, searching the main house address: no work orders found |
| 26 June 2026 | Permission to operate |
| 26 June 2026 | Permission to operate |
108 days from the first confirmation. The engineering took a day.
What we did
- Filed against the only address that existed and flagged the mismatch in writing.
- Carried the correction through until the record sat on the right service.
- Answered the utility's search failure with both addresses and the work request number.

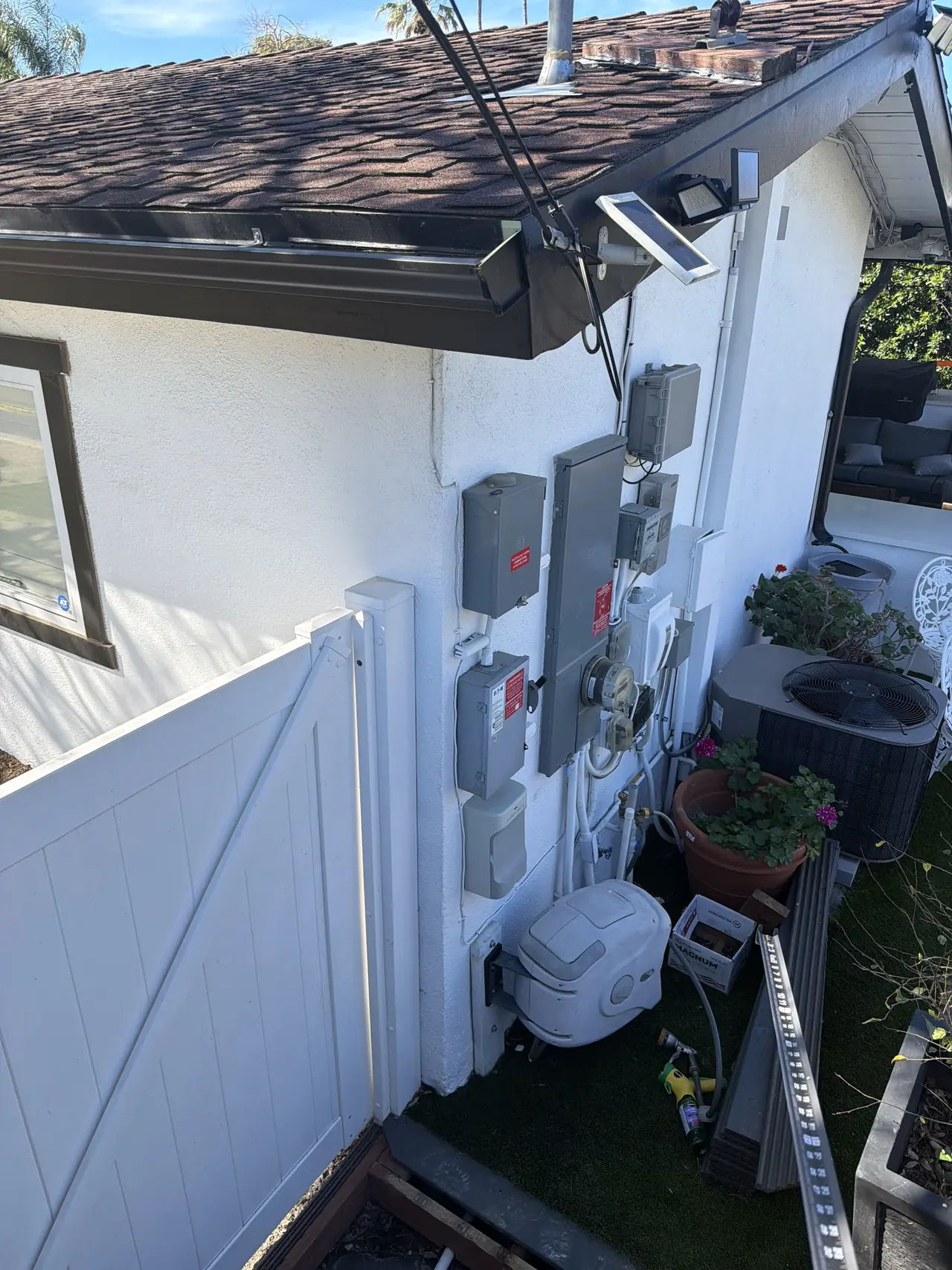

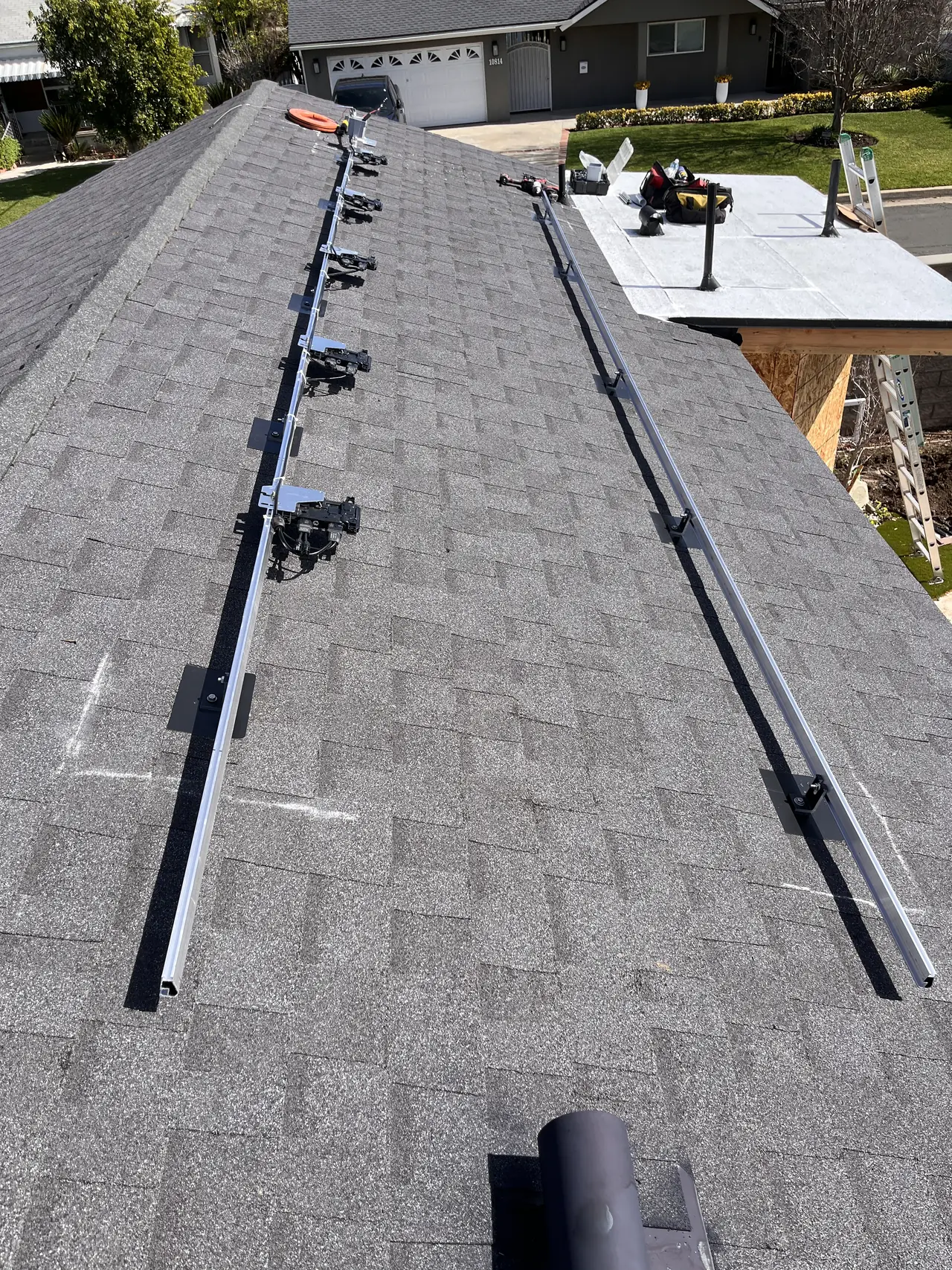

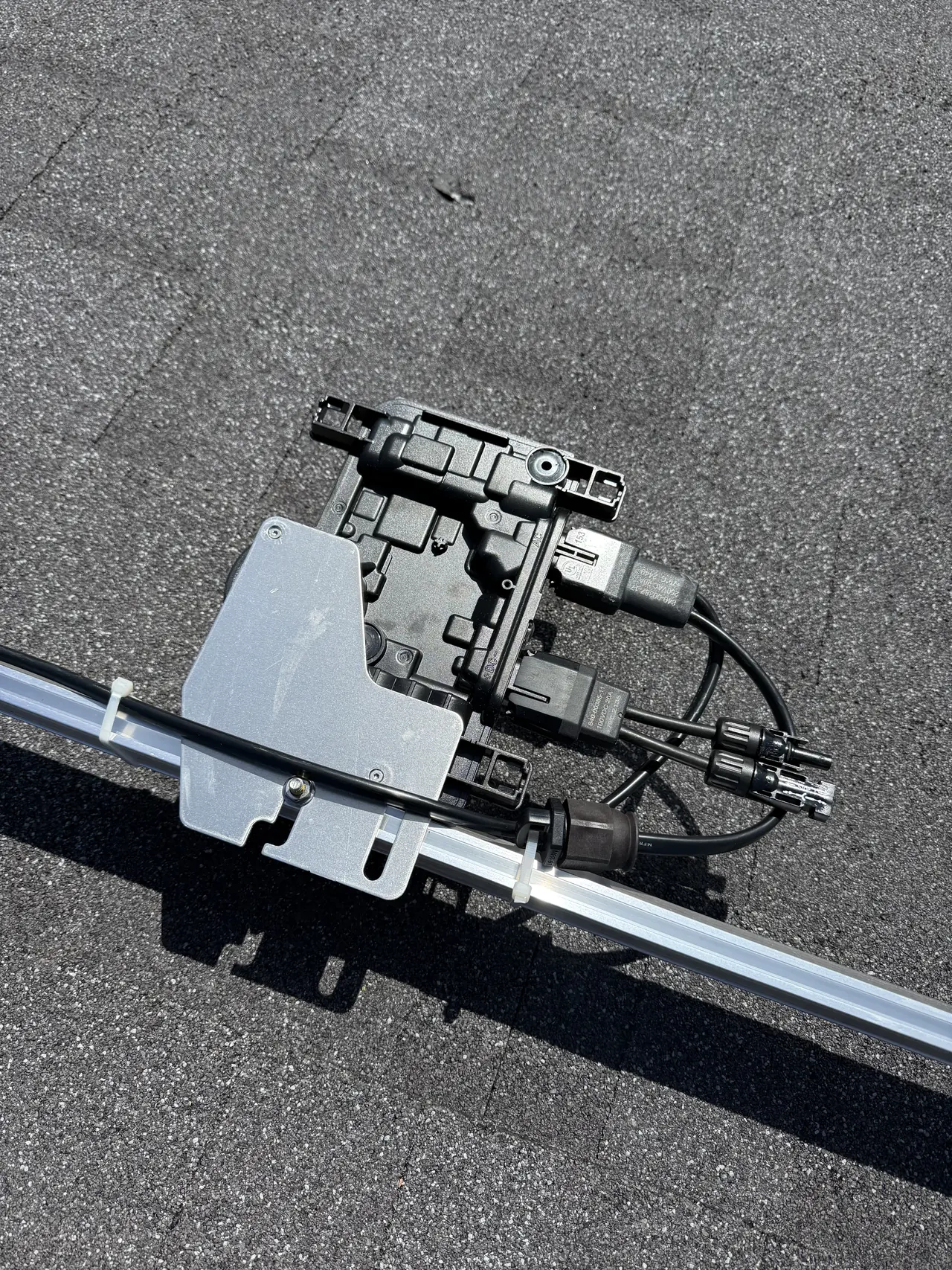

- Set five modules with a microinverter under each on the accessory dwelling roof.
- Handed the monitoring account to the owner once the system was running.
System specifications
| Building | New detached accessory dwelling with its own service and meter |
|---|---|
| Modules | 5 × Mission 410 W |
| Microinverters | 5 × Enphase IQ8A, one per module |
| Recorded by the utility | 1.99 kW |
| Filed against | The main house address, the only one that existed |
| Corrected to | The accessory dwelling's own address, in May |
| First confirmation to permission | 108 days |
| Utility / AHJ | LADWP / LADBS |
