Glendale, CA · July 2021 – December 2021 · Glendale Water & Power / City of Glendale

The panel permit was already open. Under someone else's name.

A Glendale house with nineteen modules on microinverters and a service panel rebuilt to 200 amps. The solar permit was ready to issue in November when the city found an electrical permit for the same panel upgrade, opened two months earlier by another contractor and never paid. Clearing it took a morning; knowing to look took the city.

The city's permit system is indexed by address. An electrical permit applied for at a property stays on that property's record whoever applied for it, and a second application for the same work runs into the first. Here the fix was to pay the open balance and refile the same scope with Cali Energy as the contractor of record, which the city processed the same day. The lesson is to ask the city what is already open at the address before the panel work is scheduled.

Enphase combiner and a fused disconnect mounted on a gray stucco wall with conduit rising to the roof, Glendale
The combiner and disconnect on the side wall, conduit up to the array.

At a glance

Array
19 modules, 370 W each — 7.03 kW DC
Inverters
19 microinverters, one per module
Recorded by the utility
6.484 kW CEC-AC
Estimated production
12,485 kWh a year
Service
Main panel rebuilt to 200 A, new meter position
Spot drawings
Two: service panel and generation meter
Filing to permission
Twenty weeks
Utility / AHJ
Glendale Water & Power / City of Glendale

The story

The design was ordinary in the best way: nineteen 370-watt modules with a microinverter under each, 7.03 kilowatts on the nameplate, a combiner and disconnect on the side wall, and a main service panel rebuilt to 200 amps because the old one had neither the rating nor the space for a solar breaker. The array faces a little west of south at a 23-degree tilt, and the application put it at 12,485 kilowatt-hours a year. The utility recorded it at 6.484 kilowatts AC.

The interconnection application went to Glendale Water & Power at the end of July, and its review is specific about what the submission has to contain. The executed agreement has to state the AC rating the utility's own portal calculates, exactly, to the third decimal. The electronic-signature history goes with it. Monthly solar-access figures go on the form. Engineering then reviews the drawings separately, and here it wanted the new panel shown on the single-line diagram and a photograph of the spot where the generation meter would go, with its clearances in frame.

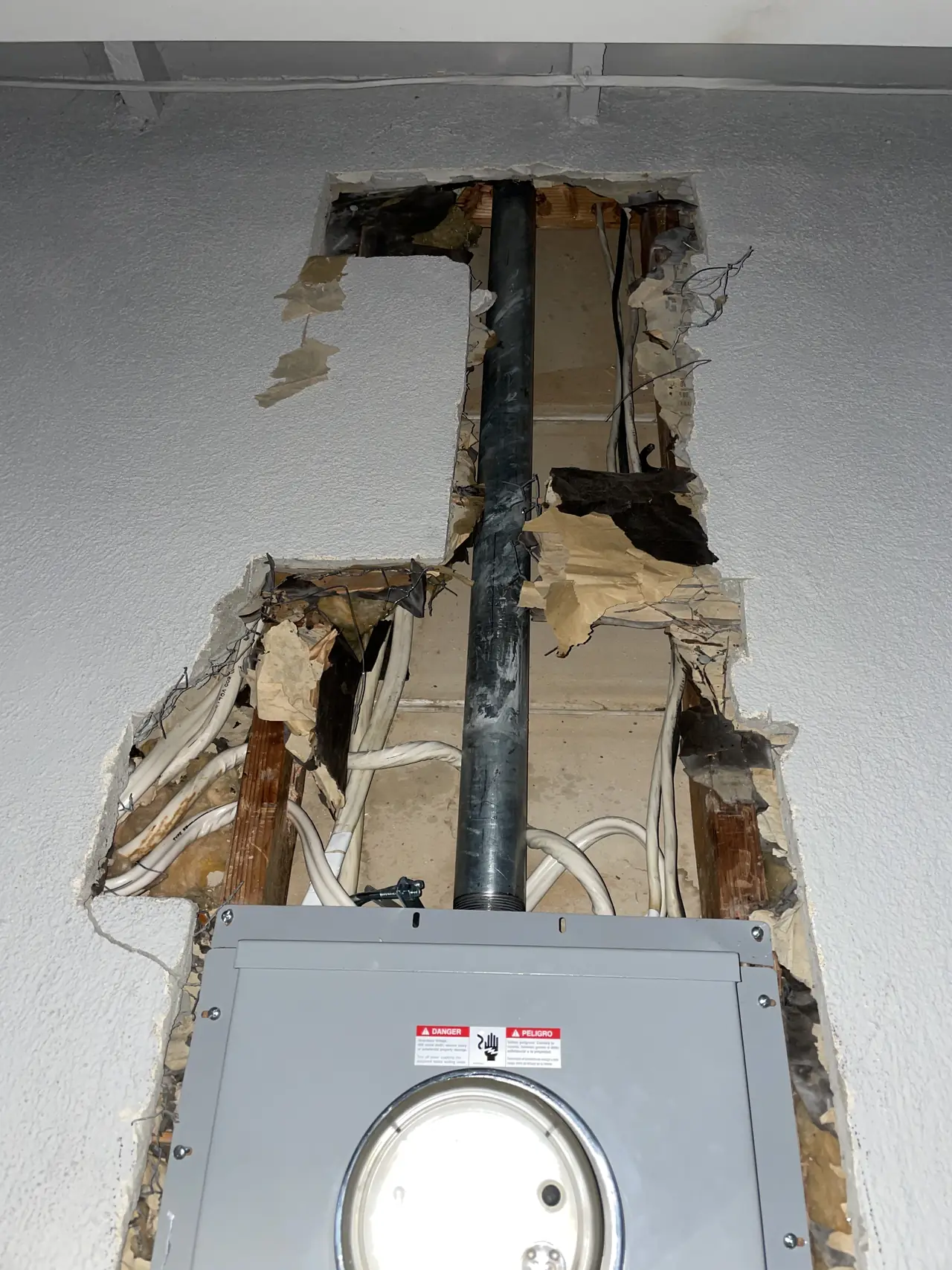

Stucco wall cut open above a new electrical panel to run the service conduit, with the old wiring exposed, Glendale
The wall opened above the new panel for the service conduit. Stucco was patched after inspection.

A Glendale panel upgrade also brings its own drawing. The utility's planner visited at the end of August and issued a service spot for the 200-amp panel in early September, with a tampering notice to sign and a service fee to pay for the new drop. That spot is not the solar spot. The generation meter got its own drawing when the interconnection agreement was approved at the end of September, and both had to be printed into the plans before the utility would stamp them for the city.

Plan check ran through October. The city's reviewer sent redlines and asked for conventional framing notes on the roof; the revisions went back through the utility for approval first, as Glendale requires, then to the city. The solar permit fee was paid on the fifth of November and the permit was ready to sign the following Monday.

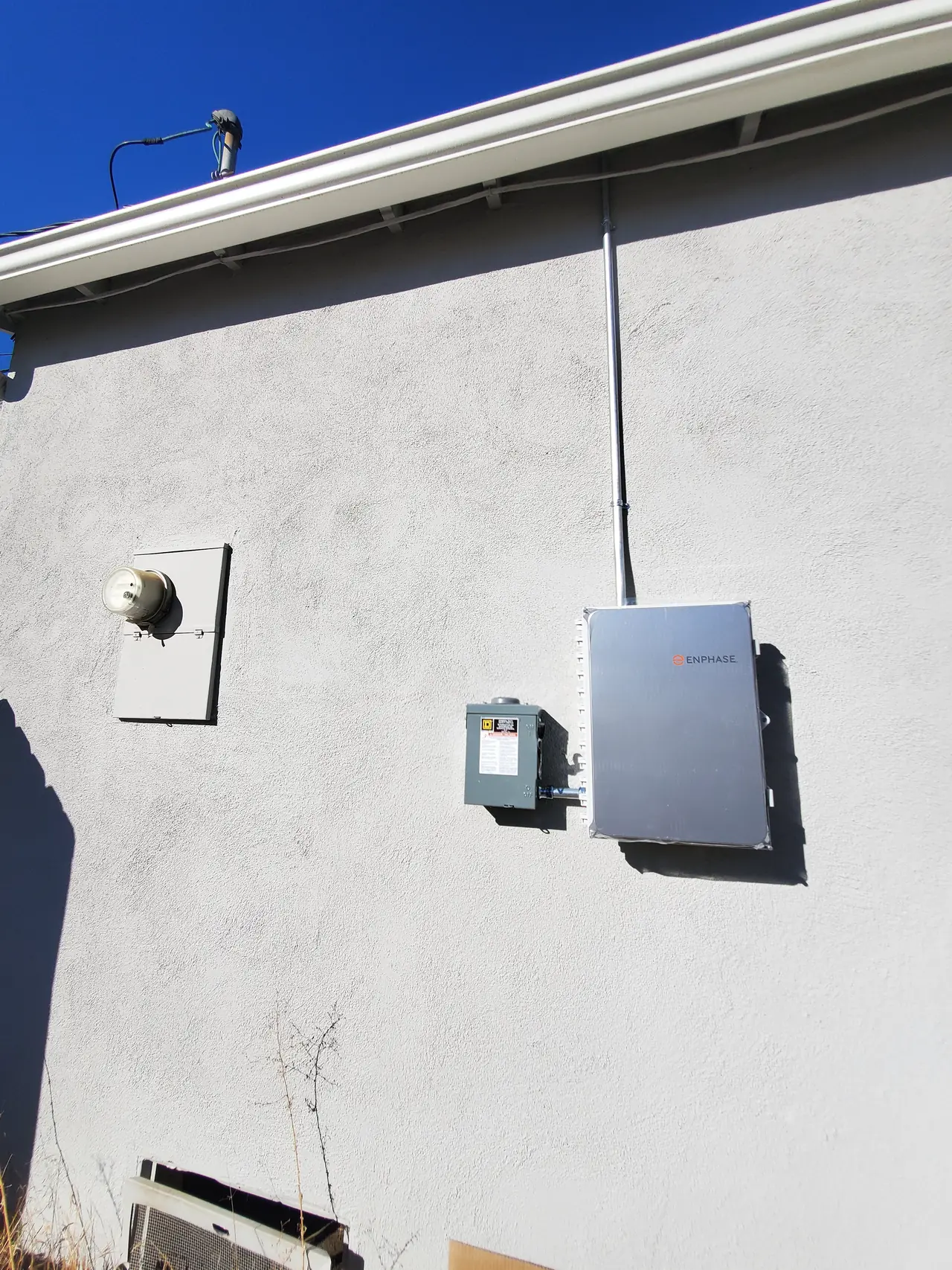

Side wall of a stucco house with a combiner, a disconnect and a blanked plate where the old meter was, Glendale
The round plate marks the old meter position. The service now enters elsewhere.

That Monday morning the question was routine — does the panel upgrade need its own permit, or does it ride on the solar permit? — and the answer was not. The city's permit technician checked the address and found an electrical permit for a 200-amp service upgrade already in the system, applied for on the twentieth of September by a different contractor, processed and waiting on an unpaid balance. It was not ours. It was on our address.

What the city needed was simple once it was said out loud: the open balance paid, and a new electrical application for the same scope with the contractor information changed to ours. Both were done before lunch, and the electrical permit was issued that afternoon under Cali Energy as contractor of record. No signature was needed on the permit itself; the application we had sent weeks earlier served as the backup.

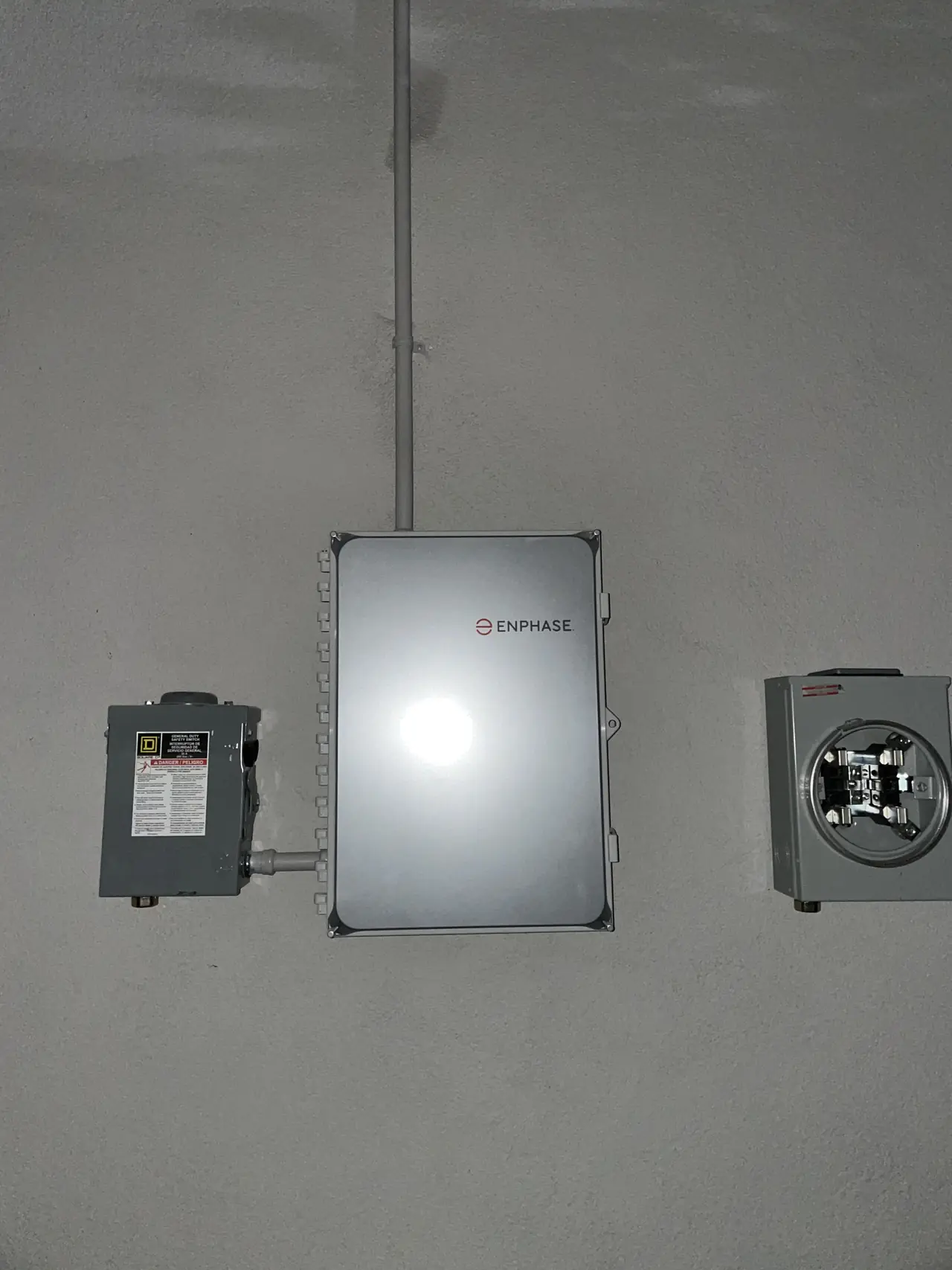

Combiner box, disconnect and new meter socket on a stucco wall at night, Glendale
The finished wall: combiner, disconnect and the new meter socket, ready for the utility.

The rest was inspection and metering. The utility installed the generation meter on the ninth of December and issued permission to operate the next day.

A morning was a cheap outcome, and it is not the only one available. An open permit under another name can carry an unpaid fee, an expired plan check or an inspection history that has to be reconciled before anything new will issue, and none of that is visible from outside the city's system. On a house where somebody else has quoted or started electrical work, ask the city what is on the address before the panel is ordered. It is one phone call, and it belongs at the start of the job rather than the end.

How it ran

26 July 2021Interconnection application filed
27 July – 2 August 2021Agreement and forms corrected; forwarded to utility engineering
25–26 August 2021Engineering corrections: new panel on the single line, photo of the meter location
4 September 2021Service spot issued for the 200 A panel
29 September 2021Interconnection agreement approved; generation-meter spot issued
30 September 2021Utility-stamped plans sent to the city
14–25 October 2021City redlines, framing notes, revisions approved
5 November 2021Solar permit fee paid
8 November 2021Open electrical permit found; balance paid, refiled, issued the same day
9 December 2021Generation meter installed
10 December 2021Permission to operate

Twenty weeks from filing to permission; the open permit cost one morning of it.

What we did

  • Designed a 19-module microinverter array with a combiner and disconnect on the side wall.
  • Rebuilt the main service panel to 200 amps at the utility's spotted location (C-10).
  • Carried the interconnection application through the utility's review and its engineering review to approval.
  • Incorporated both spot drawings into the plans and took them through the city's plan check.
  • Cleared the open electrical permit on the address and refiled it as contractor of record the same morning.
  • Passed the inspections and had the generation meter set in December.

System specifications

Modules19 × 370 W — 7.03 kW DC
Inverters19 microinverters; combiner on the side wall
Recorded by the utility6.484 kW CEC-AC
Array23-degree tilt, azimuth 186
Estimated production12,485 kWh a year
ServiceMain panel rebuilt to 200 A; meter relocated
PermitsSolar (city), electrical (city), two utility spot drawings
Utility / AHJGlendale Water & Power / City of Glendale
