Studio City, CA · December 2022 – August 2023 · LADWP / LADBS

Two dwellings on one lot. Two of everything on the paperwork.

The old house and garage came down, a new two-story house went up with a detached accessory dwelling behind it, and each building got its own meter, its own work request and its own fee. Both were switched on the same day.

This lot was metered as two services: the house and the accessory dwelling each had a meter of its own. Where that is the case, each meter needs its own interconnection request with its own charge, even when one crew installs both arrays in the same week. So the first question on a two-dwelling lot is not how big the arrays are, it is how many meters there are. The site work merges. The paperwork follows the meters.

Black solar modules along the edge of a composition shingle roof against a clear sky, Studio City
One of the two arrays. The other is on the building behind it.

At a glance

Lot
New house and a detached ADU
Work requests
Two, filed the same day
Recorded by the utility
2.32 kW and 1.45 kW
Modules
Silfab
Meters
Two, side by side on one wall
Filing to permission
Sixty days, both
Meter work
Existing meters changed for net meters
Utility / AHJ
LADWP / LADBS

The story

This lot was cleared before any of it began. The existing house, an accessory structure and the garage were demolished under one permit, the old pool was backfilled and the shell taken out, and what went up in their place was a new two-story dwelling with an attached two-car garage, plus a detached accessory dwelling unit at the back.

Two dwellings on one piece of land. That sentence is the whole design problem, and not for the reason people expect. The arrays are small and the roofs are ordinary. What doubles is the paperwork.

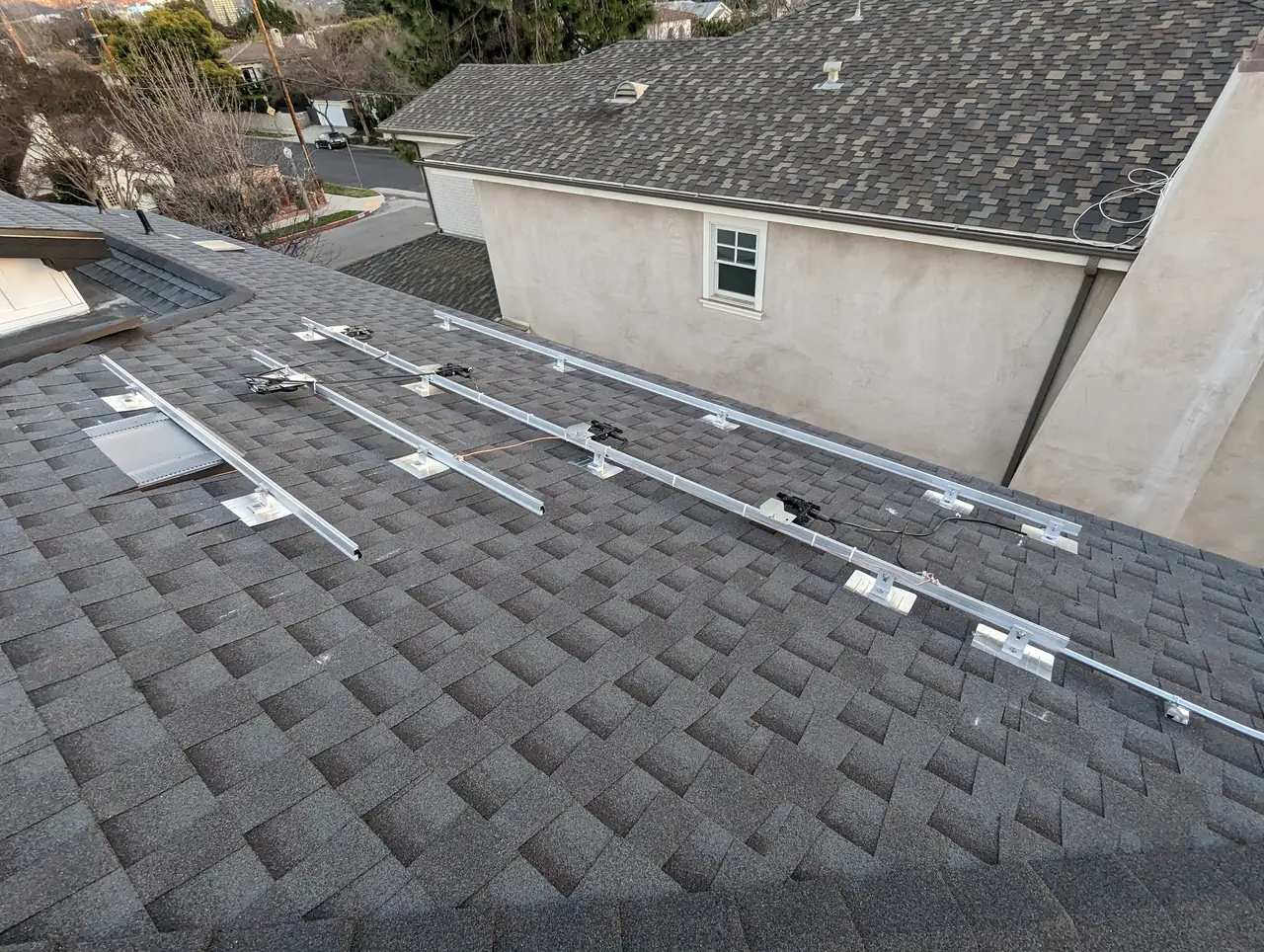

Mounting rails laid out across a new composition shingle roof with a neighboring house beyond, Studio City
Rails on the new roof. The array on this building is the larger of the two.

Here each building had a service and a meter of its own, and that is what decided the paperwork. An interconnection request attaches to a meter, so two meters meant two of everything: two work requests filed on the same day, two expenditure recovery charges paid two days later, two site evaluations, two building department releases and two grants of permission to operate — for arrays the utility recorded at 2.32 and 1.45 kilowatts. A second dwelling fed from the main house on one meter is a different job, and worth establishing before anybody quotes.

That is worth knowing before you budget an accessory dwelling unit. The modules and the labor scale with the roof; the filing scales with the number of meters. Two small arrays on two services carry two applications and two charges, and that pair of charges is the line people leave out of the budget.

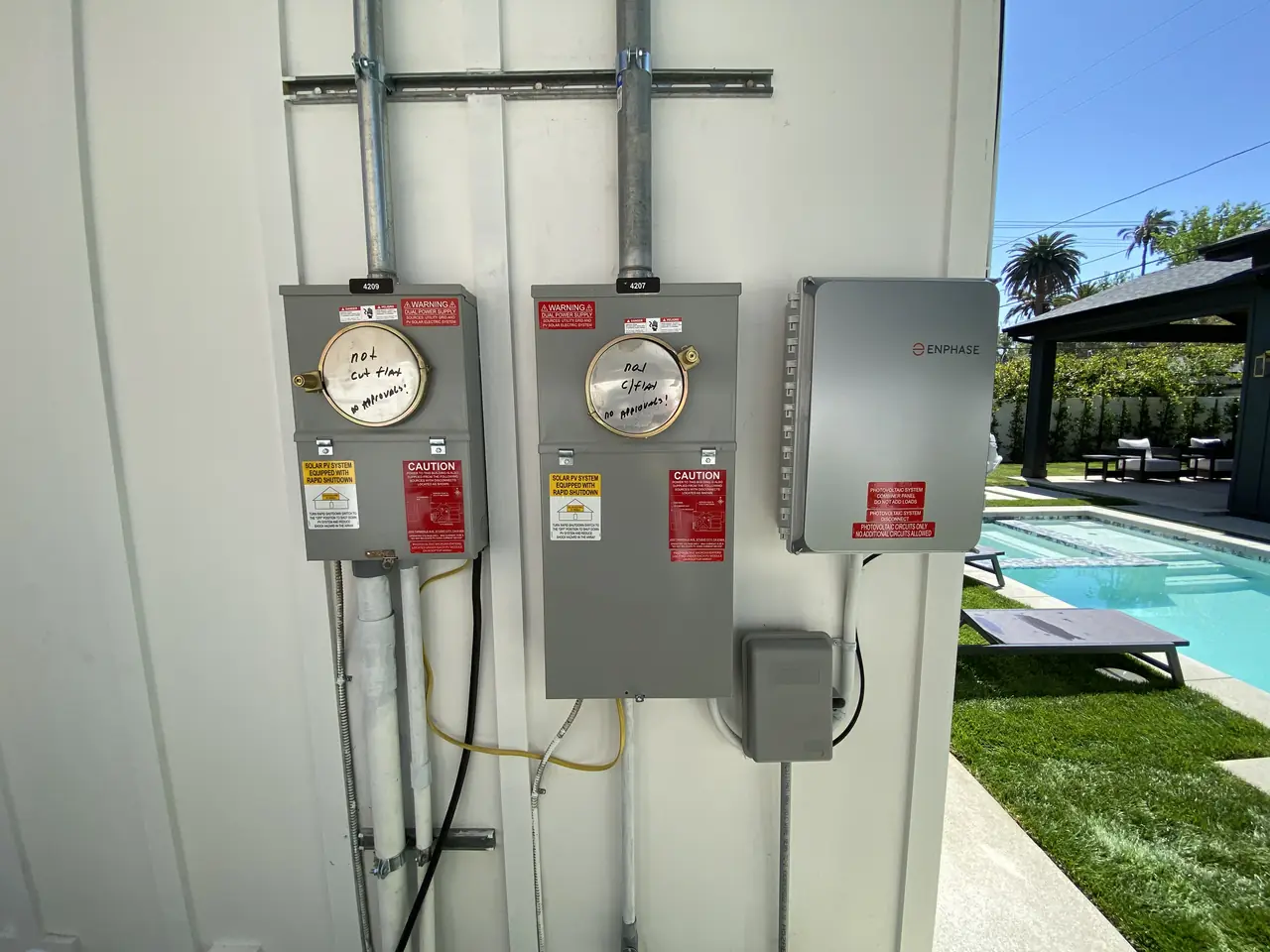

Two meter sockets side by side on an exterior wall with a solar combiner beside them and a pool beyond, Studio City
Two meters, one wall. The left one serves the building at the back.

Now the part that is specific to a house somebody builds to sell rather than to live in. On an owner-occupied job the person who knows what is happening on site is the person paying the bill, and they tell you. On a development there is an office, a general contractor, subcontractors and a solar installer, and information travels between them at whatever speed somebody remembers to send an email.

At the end of June the developer's office wrote to say a meter had been installed at the property by the utility, adding that they had only just worked out that this was something we needed to know. That is not carelessness so much as the ordinary shape of a job with four companies on it. But it mattered here, because until an ordinary meter exists there is nothing for the utility to change into a net meter — and because the system could not be commissioned until the metering was actually in place.

We went out the next morning to photograph the installation for the application. The gate was locked and nobody on site had been told to expect us, which cost an hour and two phone calls. Both of those are worth building into a schedule on a development: access is somebody else's decision, and that somebody is rarely the person who booked you.

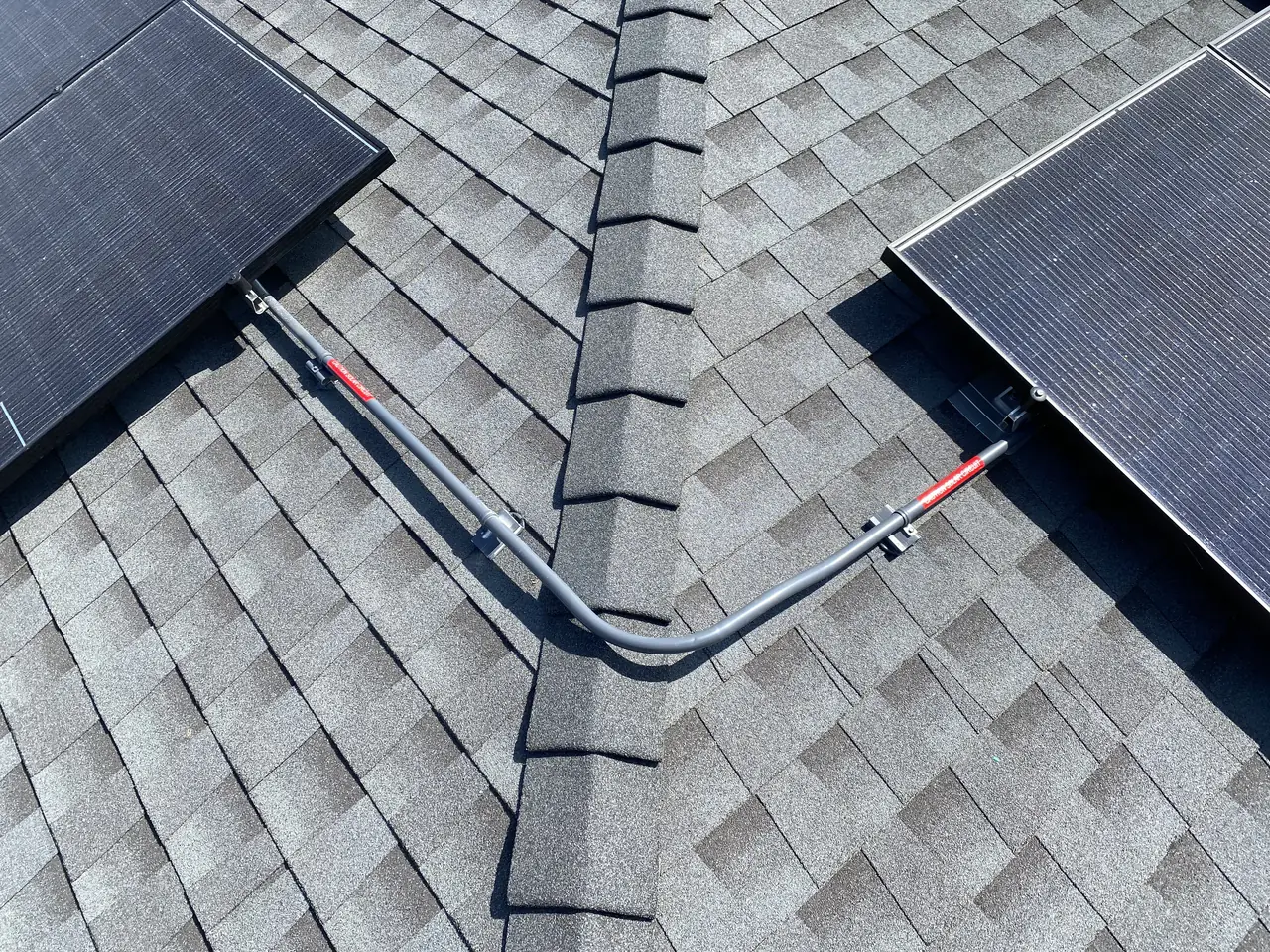

Conduit crossing the ridge of a shingle roof between two groups of solar modules, Studio City
Over the ridge, between the two groups on this roof.

Once filed, the utility side moved quickly. The requests went in on the first of July and the fees on the third; five days after filing, the review, the confirmation and the site evaluation all landed on the same day for both dwellings. The building department's final release came in the middle of August, and permission to operate for both buildings arrived on the thirtieth — the same day the net meters went on. Sixty days from filing on each.

One detail from the permission notice is worth reading if you are buying a newly built house with solar on it. The work type is recorded as a change: an existing meter was taken off and a net meter put on in its place. A new building gets an ordinary meter first so the site has power during construction, and the solar meter replaces it at the end. If somebody tells you a new house is already solar-ready, that is the step to ask about.

And if there are two dwellings, ask for both sets of numbers. Two buildings on one lot means two meters, two accounts and two interconnection records, and they do not have to be the same size or even switched on in the same month. Here they were. That was a choice somebody made, not a rule.

How it ran

January 2022Existing house, accessory structure and garage demolished; old pool backfilled
2022New two-story house with attached two-car garage, detached accessory dwelling and a new pool with spa
December 2022First contact about the solar
28 June 2023Developer reports a meter has been installed at the property
29 June 2023Site visit to photograph the installation for the application
1 July 2023Two interconnection requests filed, one per dwelling
3 July 2023Charges paid on both
6 July 2023Review, confirmation and site evaluation on both, same day
14 August 2023Building department final release; interconnection approved
30 August 2023Permission to operate on both; net meters set

Sixty days from filing to permission, on both dwellings at once.

What we did

  • Filed a separate interconnection request for each dwelling on the same day.
  • Installed both arrays on a lot that was still an active construction site.
  • Photographed the installation for the application when the developer reported the meter was in.
  • Carried both work requests from filing to permission to operate in sixty days.
  • Left two meters and two sets of solar labeling on one wall, one per dwelling.

System specifications

DwellingsNew two-story house and a detached accessory dwelling unit
Recorded by the utility2.32 kW on the house, 1.45 kW on the accessory unit
ModulesSilfab
RoofComposition shingle, new
Work requestsTwo, one per dwelling
ChargesTwo, one per work request
MetersTwo; existing meters changed for net meters
Also on the lotNew pool with spa
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You are building a second dwelling and want to know what doubles.
  • You are a developer and solar is one of four trades on your site.
  • You are buying a newly built house that already has an array on it.
  • Your lot has two meters and you do not know which serves what.
  • You want the accessory dwelling connected in its own right, not off the house.

Cali Energy in Studio City

Studio City is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

A Studio City lot that changes hands usually changes shape: the old house comes down, a larger one goes up, and a second dwelling appears at the back. How the utility treats that depends on how the lot is metered.

This installation is on the Studio City projects page alongside the others, and what the work covers is set out on the Studio City service area page.

Frequently asked questions

Does an ADU need its own interconnection?

If it has its own service and its own meter, yes. On this lot the house and the accessory dwelling each had their own work request, their own charge and their own grant of permission to operate, for arrays the utility recorded at 2.32 and 1.45 kilowatts.

Does filing two requests cost twice as much?

The utility charge is per work request, and a work request attaches to a meter — so two separately metered dwellings means two charges. It is the count of services that doubles the paperwork, not the size of the arrays.

Can both dwellings be switched on at once?

They can, and here they were — both grants of permission arrived on the same day, sixty days after filing. It is not automatic, though. Two work requests can move at different speeds, and filing them together is what keeps them in step.

Why was the meter changed rather than installed?

Because a new building gets an ordinary meter first, so the site has power while it is being built. The net meter replaces it once the solar is released. On this lot the permission notice records both dwellings as a meter change rather than a new set.

What is different about solar on a developer's build?

Who knows what, and when. On an owner-occupied job the person paying tells you what is happening. On a development the information sits with an office, a general contractor and several subcontractors, and it reaches the solar installer last. Build site access and notice into the schedule rather than assuming them.

What this would look like on your roof

Every number on this page came off a real job in Studio City, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.
