Simi Valley, CA · November 2022 – December 2022 · Southern California Edison / City of Simi Valley

The array was ready. The house had to be open.

A Simi Valley installation finished in late November whose final inspection moved, for a reason that has nothing to do with the work.

An inspector needs access to everything on the permit. On most residential solar that includes the service equipment and the point of connection, and frequently a subpanel, a disconnect or an inverter that sits in a garage, a utility room or behind a locked side gate. If nobody can open those, the visit is wasted and the inspection goes back into the queue. On this Simi Valley project Cali Energy moved the appointment around the homeowner's travel rather than sending an inspector to a locked house, which cost a day on the calendar and saved a wasted visit.

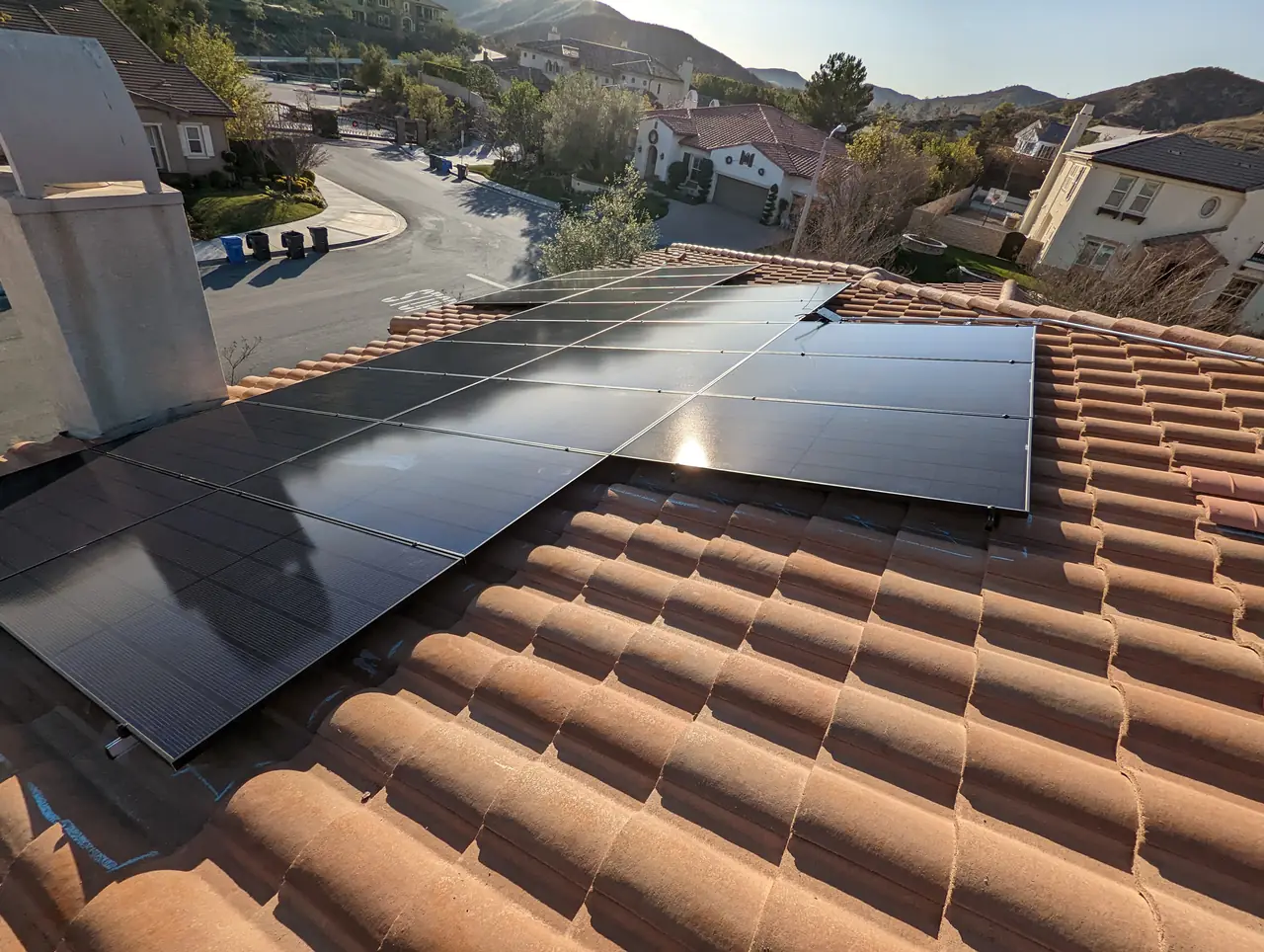

Solar array on the S-tile roof of a house in Simi Valley with the street beyond
Installed at the end of November. The inspection followed nine days later, for reasons that had nothing to do with the roof.

At a glance

Installation
28 November 2022
Final first booked
6 December 2022
Rescheduled once
Homeowner away until the Tuesday night
Final rebooked
7 December 2022
Reason access matters
Service equipment and point of connection
Cost of a missed visit
Back of the scheduling queue
Utility / AHJ
Southern California Edison / City of Simi Valley

The story

The Cali Energy crew put the array up at the end of November. The final inspection was booked for the sixth of December, moved because the homeowner was out of town until the Tuesday night, and rebooked for the seventh. On a project that was physically finished, that is a week of calendar spent on nobody being home.

Why a solar inspection needs the house open at all is not obvious, because the intuitive picture is an inspector on the roof with a clipboard.

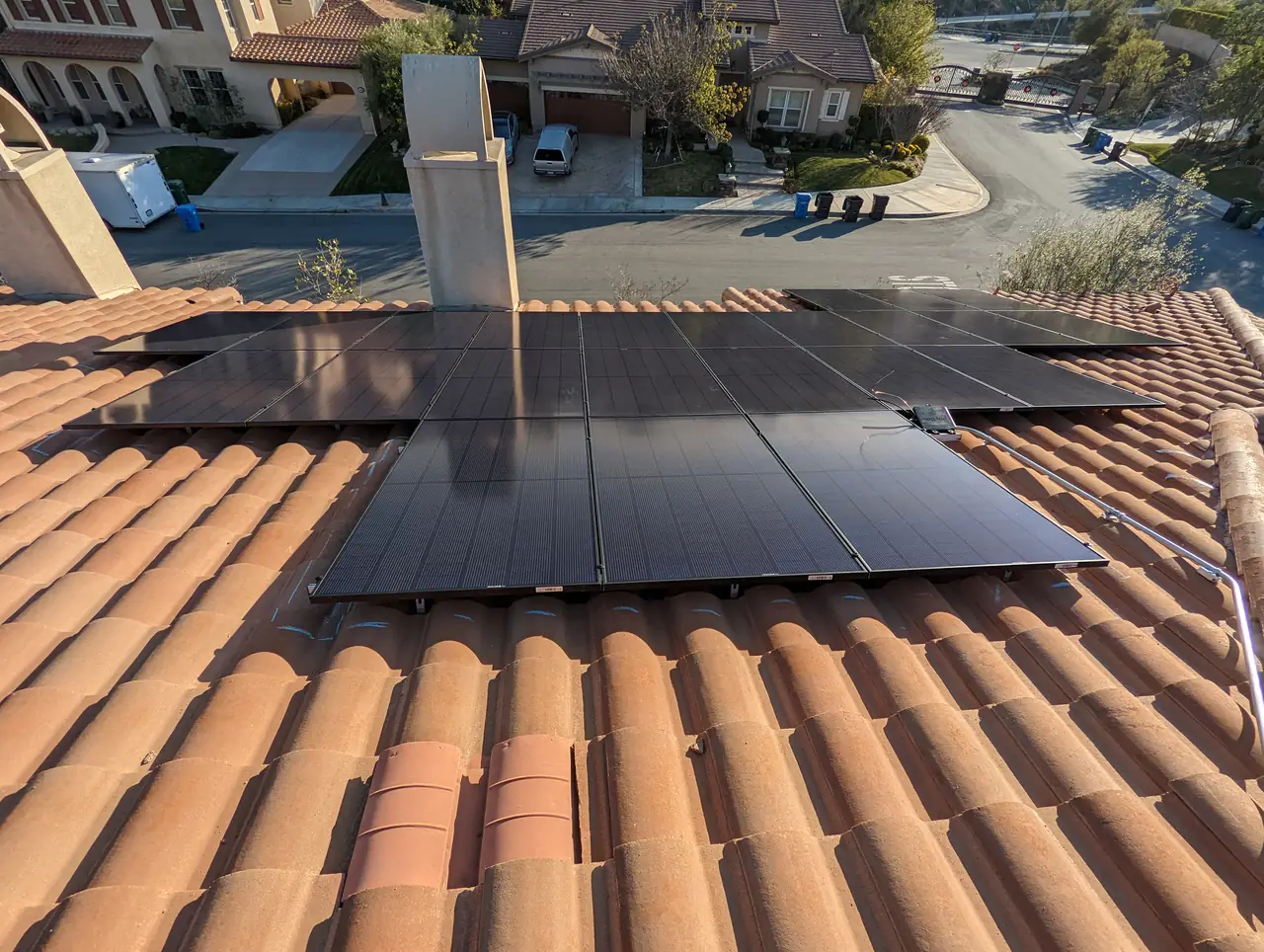

Solar modules set on the S-tile roof of a Simi Valley house on both sides of a chimney
The roof half of the inspection, which is the half people expect.

The roof is one part of it. The inspector also has to see the service equipment, the disconnects, the labeling and the actual point where the solar circuit lands. On a great many houses at least one of those is inside: a subpanel in a garage, a disconnect in a utility room, an inverter on an interior wall, or service equipment behind a side gate that is locked. Without access to those, the inspection cannot be completed, and an inspector who cannot complete it does not come back the same afternoon.

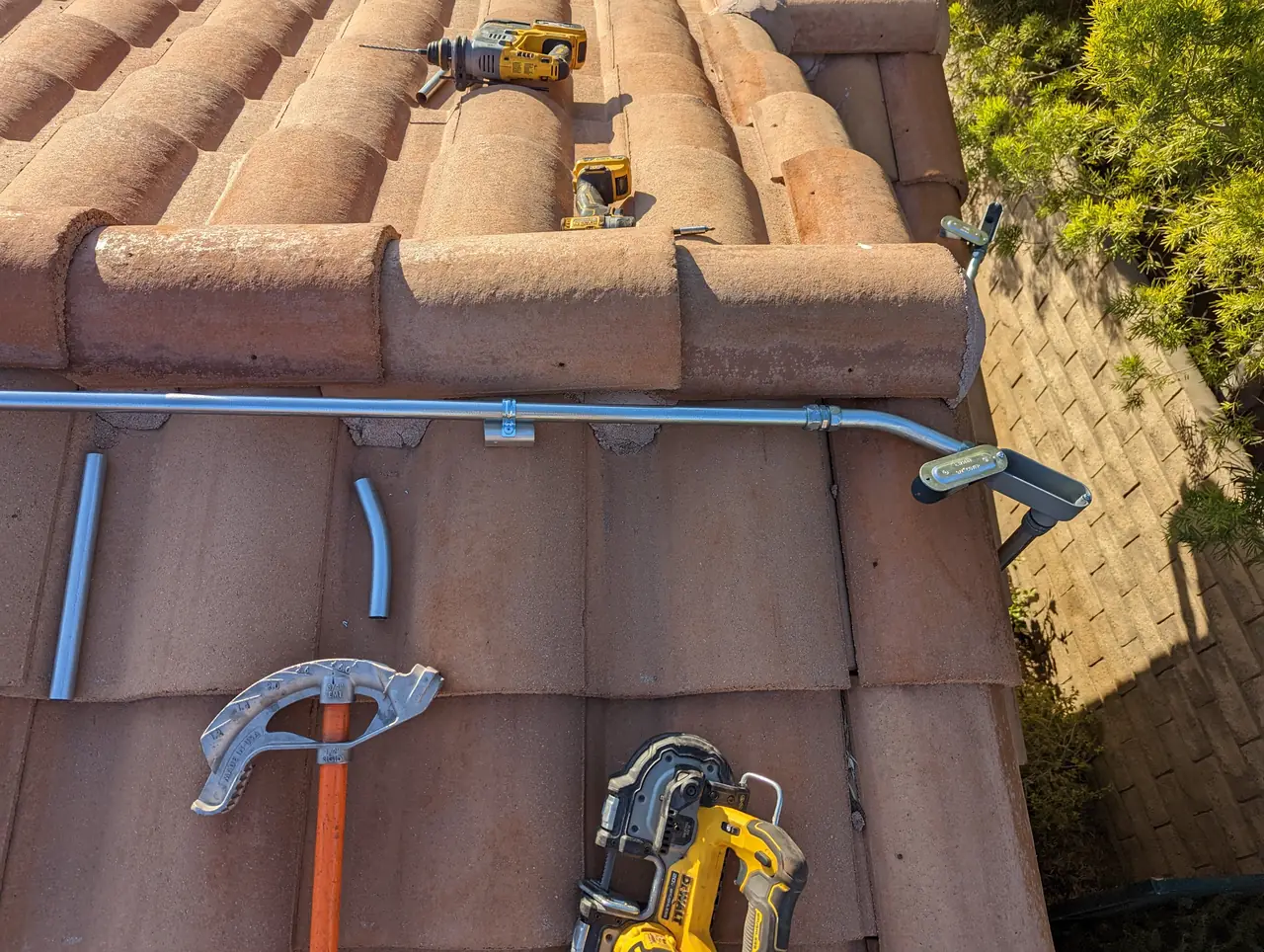

Conduit run clipped along the S-tile roof of a house in Simi Valley
The conduit run off the roof. Where it lands is commonly indoors or behind a gate, which is the other half of the inspection.

The practical advice that follows is short. When an installation is booked, ask when the inspection window will fall and keep it clear. Make sure somebody who can open every door and gate will be there, and that it is somebody who knows which doors matter. If there are dogs, say so. If a gate is locked, say where the key is. None of that is the homeowner's job in any formal sense and all of it decides whether a finished project closes this week or next.

Inspectors, for their part, are usually flexible about the window itself and inflexible about access, which is the right way round. The visit is short; getting to it is the expensive part.

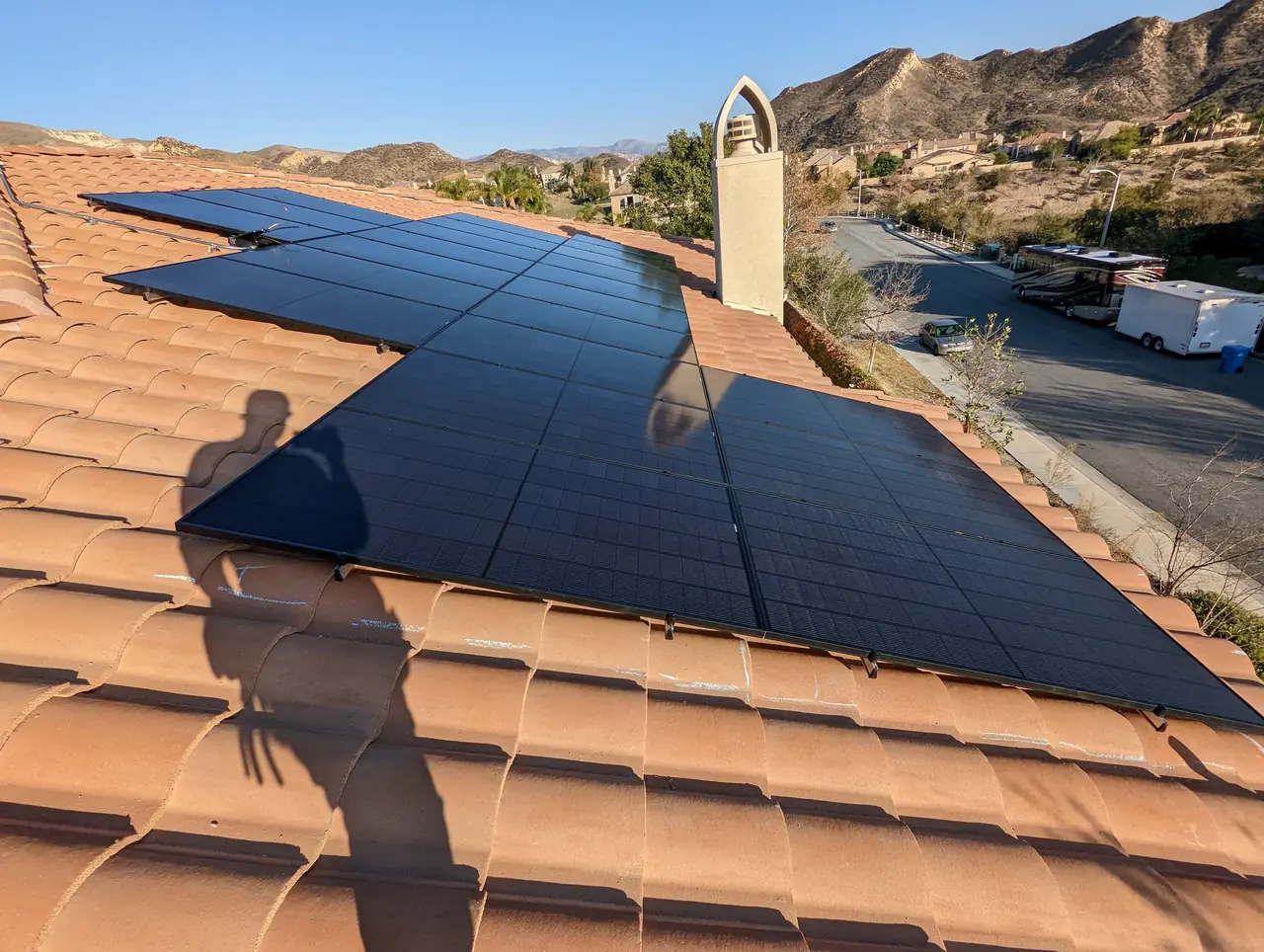

Completed solar array across two faces of an S-tile roof in Simi Valley
The finished array.

How it ran

18 November 2022Installation date confirmed with the homeowner
28 November 2022Array installed
2 December 2022, morningFinal inspection booked for 6 December
2 December 2022, middayHomeowner away until Tuesday night; inspection moved
2 December 2022, afternoonFinal rebooked for 7 December
7 December 2022Final inspection

Nine days from installation to inspection, a week of it scheduling. This timeline reflects this property.

What we did

  • Completed the installation in a single visit (C-10).
  • Booked the final inspection as soon as the work was ready.
  • Rescheduled around the homeowner's travel rather than sending an inspector to a locked house.
  • Confirmed the new appointment with the homeowner before it was booked.
  • Presented the work for inspection with the service equipment accessible.

System specifications

ScopeResidential solar installation
InstallationOne visit, 28 November 2022
Inspection access neededRoof, service equipment, disconnects, point of connection
Commonly indoorsSubpanel, disconnect or inverter
Rescheduling costBack of the queue, typically days
What helpsSomeone present who can open every door and gate
Utility / AHJSouthern California Edison / City of Simi Valley

Is your project like this one?

  • Your installation is finished and you are trying to schedule the inspection.
  • You have travel planned and a solar project in progress.
  • Your service equipment or subpanel is indoors or behind a locked gate.
  • You want to know why a finished array can take another two weeks to close.

Cali Energy in Simi Valley

Simi Valley is a city in Ventura County: permits run through the City of Simi Valley Building & Safety Division, interconnection through Southern California Edison.

A solar final in Simi Valley is not only a roof inspection. Where the service equipment, subpanel or point of connection is inside the house or behind a locked gate, somebody has to be there to open it.

This installation is on the Simi Valley projects page alongside the others, and what the work covers is set out on the Simi Valley service area page.

Frequently asked questions

Does somebody have to be home for a solar final inspection?

Usually yes. The inspector has to see the service equipment, the disconnects, the labeling and the point of connection, and on many houses at least one of those is in a garage, a utility room or behind a locked gate. Without access the inspection cannot be completed and has to be rebooked.

Does Cali Energy schedule Simi Valley inspections around the homeowner?

Yes. Cali Energy books the final as soon as the work is ready and confirms the appointment with the homeowner before it is set, because a missed visit costs days rather than hours. On this project the inspection moved once around the owner's travel. Fifteen Simi Valley projects are written up on our projects page. Our license is CSLB #1032379.

What happens if the inspector cannot get in?

The visit is recorded as not completed and the inspection goes back into the scheduling queue, which in most cities means another few days. Nothing is failed and nothing has to be redone, but the permit stays open and everything downstream of it, including the utility's side, waits.

What should I have ready for the inspection?

Access to the roof approach, the service equipment, any interior subpanel or disconnect, and the point of connection. Unlock side gates, secure dogs, and make sure whoever is home knows which rooms matter. If the equipment is spread between a garage and an exterior wall, say so when the appointment is booked.

What this would look like on your roof

Every number above came off a real job in Simi Valley, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
