Pacoima, CA · May – August 2021 · LADWP / LADBS

In Pacoima, a panel upgrade decides which route you file on.

Nine kilowatts on a low-slope roof, a service panel that had to be replaced, and the one document that determines how the interconnection is filed.

The utility offers more than one interconnection route. The quick one is built for systems that connect to the service as it already exists; the standard one is what a project needs when the service itself changes, because only it produces a meter spot — the utility's written instruction on where new service equipment may go. On this Pacoima project the main panel was being replaced, so a meter spot was required. Cali Energy confirmed the scope to the utility's service planner the day he raised it, filed the photographs he asked for, and the request moved onto the standard process with the meter spot sheet issued nine days after filing.

A large solar array on tilt frames across a low-slope roof with mountains on the horizon, Pacoima, Los Angeles
Nine kilowatts on a low-slope roof, waiting on one sheet of paper.

At a glance

System
9.3 kW AC-CEC
Roof
Low slope, tilt frames
Service
Main panel replaced as part of the project
Interconnection filed
14 June 2021
Meter spot issued
23 June 2021 — nine days later
Final inspection
16 July 2021, corrections on both permits
Permission to operate
29 July 2021
Utility / AHJ
LADWP / LADBS

The story

The site visit on this house produced a quote with an item in it that homeowners do not enjoy reading: the main service panel had to be replaced before any solar could be connected. That was priced into the project as one number rather than presented later as a surprise, which is the only way to price it that survives the install.

That decision about the panel is what sets everything downstream, because it changes which interconnection route the project belongs on. The utility runs more than one. The quick route exists for systems that tie into the electrical service the way it already stands: fewer documents, a quicker review, no site planning work. It is the right route for a great many residential projects.

Replacing the main panel is service work, and service work needs a meter spot — the utility's written instruction on where the new equipment may be placed and under what conditions. Only the standard process produces one. That single document is the whole reason the routes are not interchangeable, and it is worth knowing before a request is filed rather than after.

The utility's service planner raised it the day after the request went in. He wrote asking for photographs from the panel to the pole and added the observation that mattered: the job looked like a service upgrade. Cali Energy confirmed the scope the same day and asked how to move the application onto the standard process.

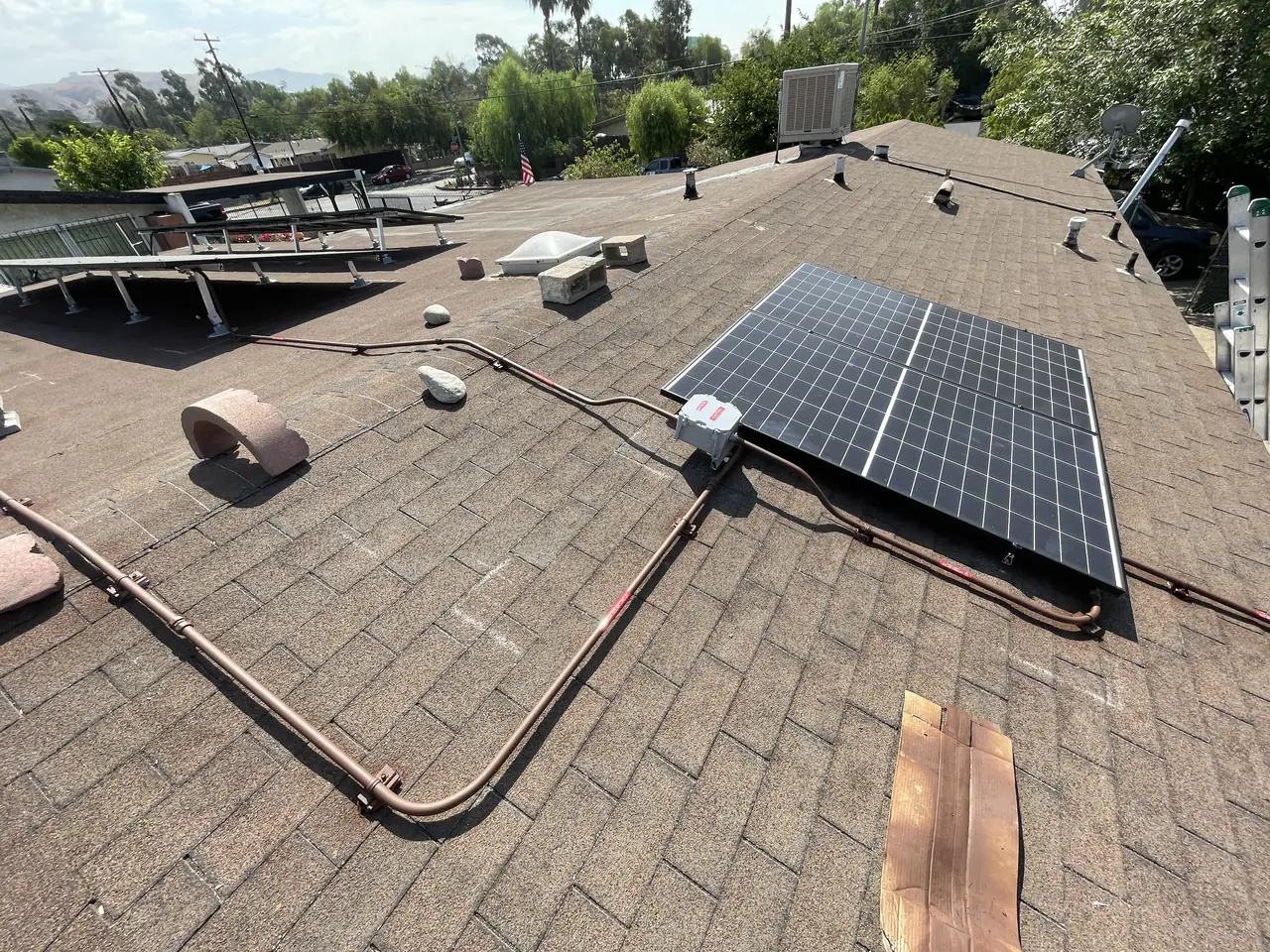

Conduit running across a low-slope roof to the edge of a tilted solar section, Pacoima, Los Angeles
The roof work was never the part that was waiting.

The photographs went in within two days. Raising it with the department's management moved it the same day, and the meter spot sheet came through on the twenty-third of June — nine days after the request was filed — with an instruction to send photographs of the completed installation once it was done. Nine days to get a service upgrade onto the right route and documented is a good outcome, not a delay.

From there it ran in order. The array went on a low-slope roof on tilt frames, which is how a nine-kilowatt system fits and gets its pitch on a roof that has almost none. The final inspection was on the sixteenth of July and produced corrections on both permits — the solar and the electrical for the panel — which is ordinary on a project carrying two. Both were cleared, the utility marked the installation approved on the twenty-first of July, and permission to operate was issued on the twenty-ninth.

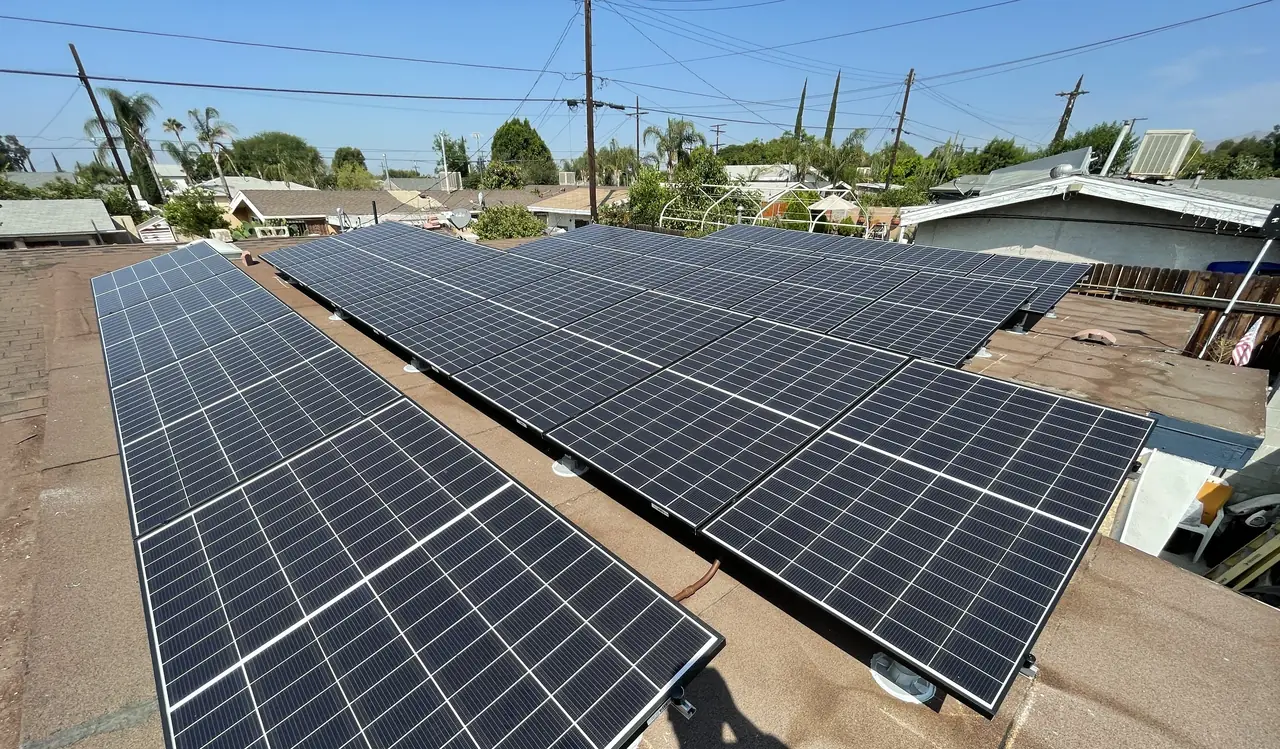

Rows of solar modules on tilt frames across a low-slope roof, seen along the array, Pacoima, Los Angeles
Tilt frames give a low-slope roof the pitch it does not have.

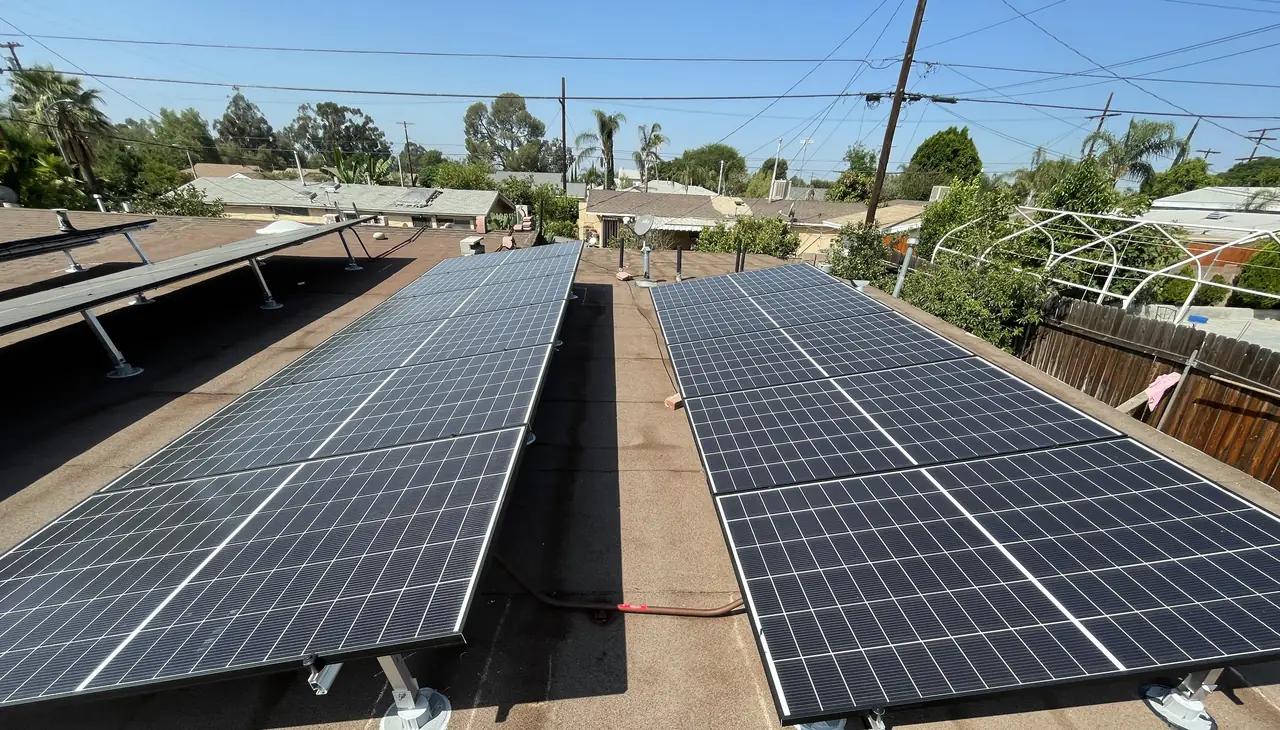

Two rows of tilted solar modules with a clear walkway between them on a low-slope roof, Pacoima, Los Angeles
Space between the rows so each one is reachable.

The system was registered on Enphase Enlighten on the fifth of August so the household could see production per module, and the unconditional waiver closing the project out followed five days later. The practical takeaway is the one the service planner gave for free: match the interconnection route to the scope before filing. If the service is changing, the project needs a meter spot, and the meter spot is what decides the route.

How it ran

13 May 2021Quote issued after the site visit, including the panel upgrade
2 June 2021Homeowner approves the scope
7 June 2021Contract signed
14 June 2021Interconnection request filed and fees paid
15 June 2021Utility asks for panel-to-pole photographs and flags the service upgrade
17 June 2021Photographs filed
23 June 2021Standard process confirmed; meter spot sheet issued
July 2021Array installed on tilt frames; main panel replaced
16 July 2021Final inspection; corrections issued on both permits
21 July 2021Utility marks the installation approved
29 July 2021Permission to operate issued
5 August 2021System registered on Enphase Enlighten
10 August 2021Unconditional waiver issued; project closed

Nine days from the interconnection filing to the meter spot, and six weeks from filing to permission to operate. This timeline reflects this property and this period.

What we did

  • Quoted the required main panel upgrade inside the project price rather than after it (C-10).
  • Confirmed the scope to the utility the same day its service planner raised it.
  • Filed the panel-to-pole photographs the utility asked for within two days.
  • Carried the interconnection on the standard process and obtained the meter spot sheet nine days after filing.
  • Installed a nine-kilowatt array on tilt frames over a low-slope roof.
  • Cleared corrections on both permits and carried the project to permission to operate on 29 July.
  • Registered the system on Enphase Enlighten and closed the project with an unconditional waiver.

System specifications

Rated output9.3 kW AC-CEC
RoofLow slope
MountingTilt frames
ServiceMain service panel replaced
Interconnection routeStandard process, as a service upgrade requires
PermitsTwo — solar and electrical
MonitoringEnphase Enlighten, per-module production
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your project includes a main service panel upgrade.
  • You have been told a quick-route filing will save you time.
  • You want to know what a meter spot is and whether you need one.
  • You have a low-slope roof and want to know how the array gets its pitch.
  • Your project is carrying two permits and you expected one.

Cali Energy in Pacoima

Pacoima is a City of Los Angeles neighborhood in the northeast San Fernando Valley, which means the permit goes through LADBS and the interconnection through LADWP. The housing is mostly post-war single story on modest services, and the ZIP it shares with Arleta turns up in the paperwork more often than anyone expects.

This installation is on the Pacoima projects page alongside the others, and what the work covers is set out on the Pacoima service area page.

Frequently asked questions

What is a meter spot and when do you need one?

It is the utility's written instruction on where service equipment may be placed and under what conditions. You need one whenever the service itself changes — a new main panel, a relocated meter, a service upgrade. A solar system that connects to the service as it already stands usually does not need one, which is why the quick interconnection routes do not issue them.

Can an interconnection request be moved between routes?

Yes, and on this Pacoima project it took nine days end to end. The utility's service planner asked for panel-to-pole photographs and noted that the job looked like a service upgrade; the scope was confirmed the same day, the photographs went in within two days, and the meter spot sheet followed. There is no penalty for the move itself — the cost is only the time a mismatch sits unnoticed.

Does Cali Energy handle main panel upgrades with solar in Pacoima?

Yes. Cali Energy quotes the service work inside the project price when a panel has to be replaced, carries the meter spot request and runs both the solar and electrical permits through LADBS to a passed final. Nine Pacoima projects are written up on our projects page. Our license is CSLB #1032379.

Why does a project like this have two permits?

Because two different scopes of work are being inspected. The solar array is one permit and replacing the main service panel is another, and each gets its own corrections at the final if the inspector finds anything. Seeing correction notices arrive on both on the same day is ordinary rather than a sign of trouble.

What this would look like on your roof

Every number above came off a real job in Pacoima, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related
