North Hollywood, CA · September 2023 – July 2024 · LADWP / LADBS

The garage became a home. A new garage was built as well.

A detached garage converted into a two-storey dwelling, with a two-car garage built alongside it under the same permit — and an array that arrived on the roof months after the building was signed off.

California law is clear on this and it is the opposite of what most people are told: when a garage is converted or demolished as part of building an accessory dwelling unit, a local agency cannot require the parking to be replaced. On this lot a new two-car garage was built anyway, under the same permit, because the owner wanted it. That is a choice, not a condition.

Solar array on the shingle roof of a converted garage with hills in the distance, North Hollywood
The array sits on what used to be a garage.

At a glance

Building
Garage converted to a two-storey ADU
Also built
New attached two-car garage, same permit
Replacement parking
Not required by law — built by choice
Modules
Mission Solar
Microinverters
Enphase IQ8M, one per module
Recorded by the utility
3.9 kW
Request to permission
Five weeks
Utility / AHJ
LADWP / LADBS

The story

The permit for this project describes the whole thing in one line: an addition, a conversion of the existing garage into a two-storey accessory dwelling unit, and an attached two-car garage. It is tempting to read a rule into that — the garage stopped being a garage, so a garage had to be built. That reading is wrong, and it is worth saying so plainly because it costs people money.

Under state law a city cannot require you to replace off-street parking when a garage, carport or covered parking is converted or demolished in order to build an accessory dwelling unit. Not in North Hollywood, not anywhere in California. If you are told at plan check that you owe the city two parking spaces because your garage became a bedroom, ask which code section that comes from.

So why is there a new two-car garage on this lot? Because the owner wanted one and put it in the same application. That is a sensible way to do it — one permit, one set of inspections, one crew on site — but it is a decision about how you want to live on your lot, not a toll you pay for the conversion.

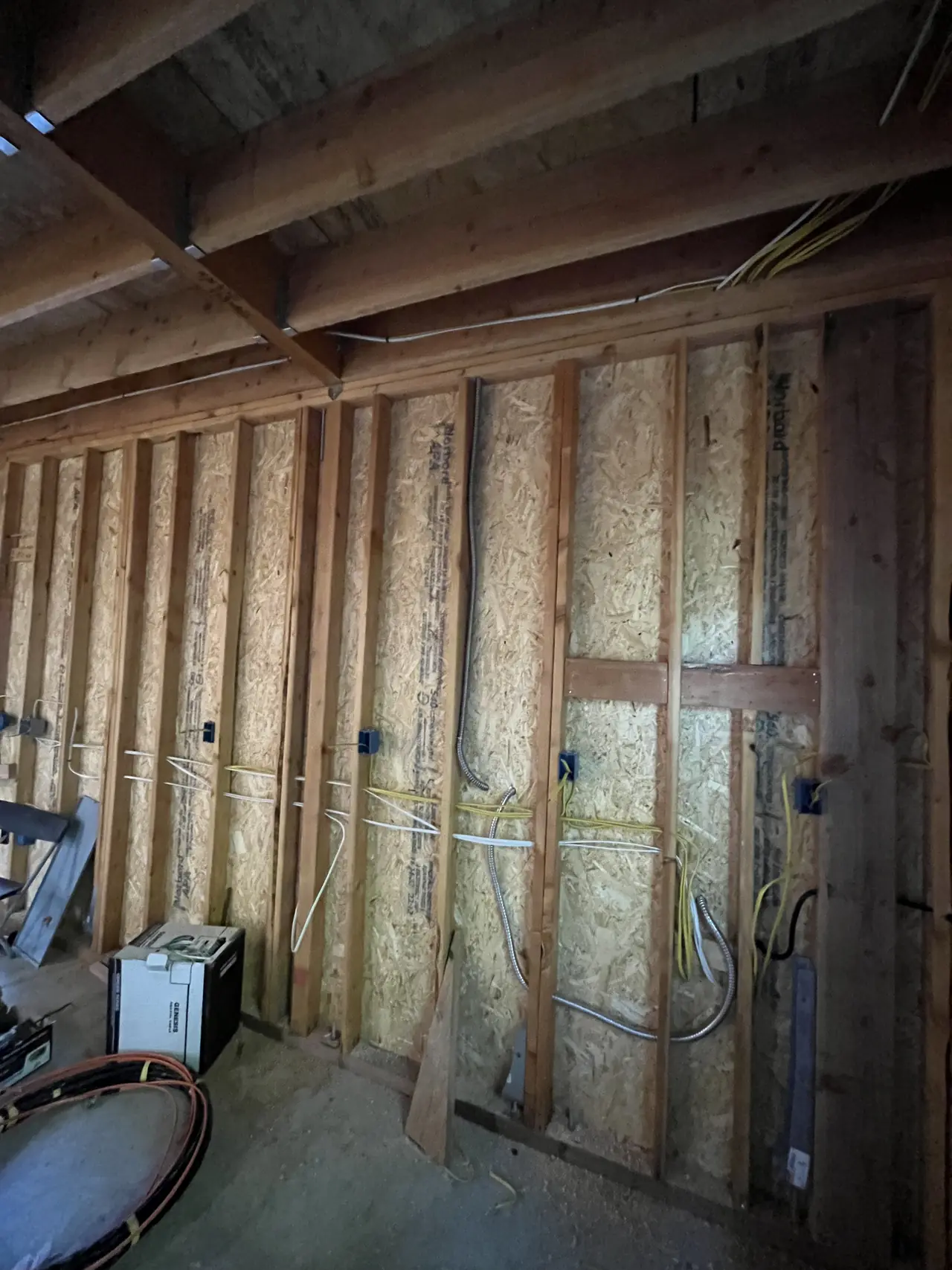

Interior framing of a new dwelling with electrical runs across the studs, North Hollywood
The conversion mid-build. This is the stage at which wiring is cheap and after which it is not.

The sequence here is worth being exact about, because it is the ordinary one and it is not the one people expect. The building went first and finished first: permit, framing, a supplemental permit along the way recording a change to the side yard setback, and a certificate of occupancy signed in February 2023. We came into it in September of that year, for the solar, on a dwelling that already existed and was already lived in.

From that first conversation to permission to operate was about nine and a half months, and most of it was neither building nor installing. It was the gap between deciding and filing — which on a finished ADU is entirely the owner's to close.

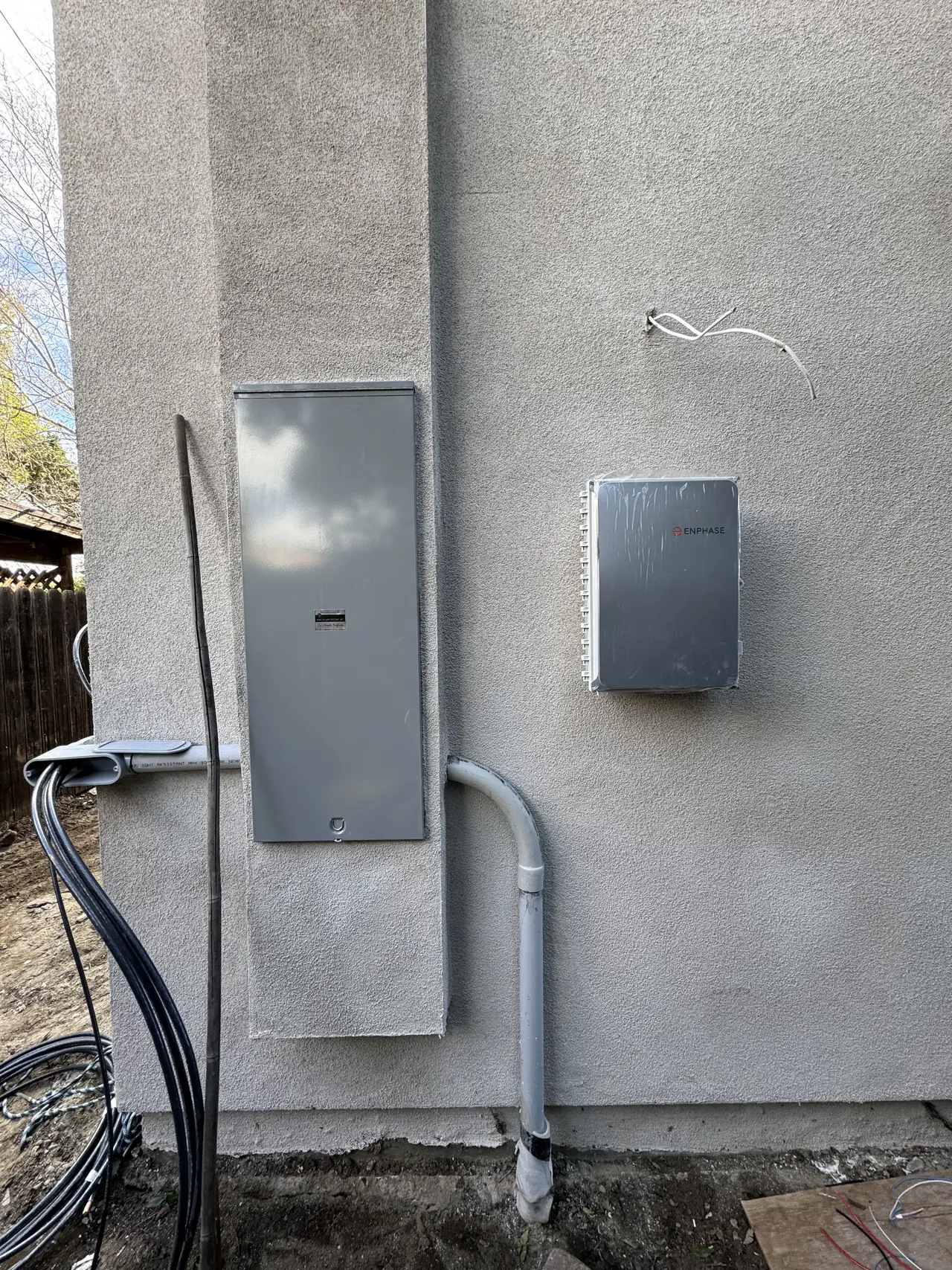

New electrical panel and solar combiner mounted on an exterior wall beside a patched stucco band, North Hollywood
The new service on the outside wall. The strip of fresh stucco shows where it went in.

The electrical side is on the outside wall: a new panel, the solar combiner beside it, and a conduit dropping into the ground. The band of newer stucco running down the wall is where it all went in — that patch is the honest record of the work, and it is the same on every conversion.

The array is Mission Solar modules with an Enphase IQ8M microinverter under each one, on the shingle roof of the converted building; the utility recorded the request at 3.9 kilowatts. Small, because the roof is small. That is the trade on a conversion: you gain a dwelling and you gain a roof, but the roof is the size of a garage.

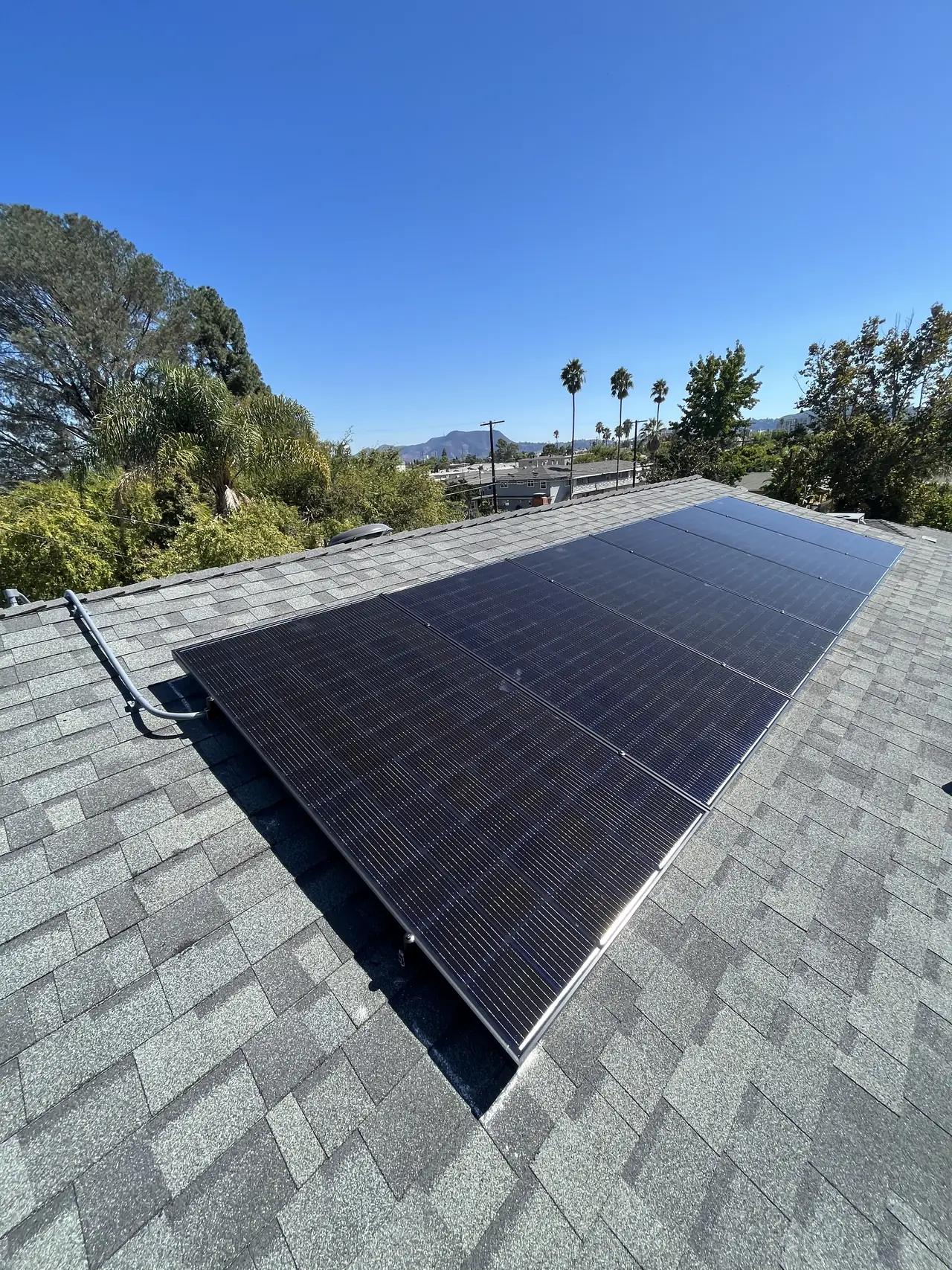

Finished solar array across a shingle roof with trees and hills behind, North Hollywood
Finished, on a roof that did not exist in this form two years earlier.

Once the building was done the utility side was quick. The interconnection request went in on the twelfth of June, the first progress notices and the completed site evaluation came two days later, the installation was released in the second week of July, and permission to operate arrived on the fifteenth. Five weeks.

If you are converting a garage and solar is anywhere in the plan, raise it before the walls close. On this lot it came up afterwards and everything still worked — but the conduit run was a retrofit rather than a line on the framing drawing, and that is the difference between a length of pipe and an afternoon of finish work.

How it ran

February 2023Certificate of occupancy for the converted dwelling and the new attached two-car garage
June 2023Supplemental permit recording a change to the side yard setback
27 September 2023First conversation about solar, through the house next door
12 June 2024Interconnection request filed; fee paid
14 June 2024Progress notices and site evaluation complete
11 July 2024Installation released
15 July 2024Permission to operate

Nine and a half months from first conversation. Five weeks of it was the utility.

What we did

  • Added the array to a dwelling that had already been converted and certified.
  • Installed a new panel and the solar combiner on the exterior wall of the converted building.
  • Fitted Mission Solar modules with one Enphase IQ8M microinverter each.
  • Carried the interconnection from request to permission to operate in five weeks.

System specifications

ScopeGarage converted to a two-storey accessory dwelling unit
New garageAttached two-car, same permit — not a legal requirement
ModulesMission Solar
MicroinvertersEnphase IQ8M, one per module
RoofComposition shingle
ElectricalNew panel and solar combiner on the exterior wall
Recorded by the utility3.9 kW
Utility / AHJLADWP / LADBS

Is your project like this one?

  • You have been told you must replace parking to convert your garage.
  • You want solar on an ADU and are not sure when in the build to raise it.
  • You have a small roof and want to know what size of array it supports.
  • You want the electrical planned before the walls close rather than after.
  • You are weighing a conversion against building new.

Cali Energy in North Hollywood

North Hollywood is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

Garage conversions are the most common way a North Hollywood lot gains a home, and the parking question that follows is the one homeowners most often get told wrong.

This installation is on the North Hollywood projects page alongside the others, and what the work covers is set out on the North Hollywood service area page.

Frequently asked questions

If I convert my garage to an ADU, do I have to replace the parking?

No. California law prohibits a local agency from requiring replacement off-street parking when a garage, carport or covered parking structure is demolished or converted in conjunction with an accessory dwelling unit. On this lot a new two-car garage was built under the same permit because the owner wanted one, not because it was required.

Should I build a replacement garage anyway?

That is a question about how you want to use the lot, not a compliance question. If you do want one, putting it in the same application as the conversion means one permit and one run of inspections instead of two.

How big an array fits on a converted garage?

About as big as the garage was. This roof carries Mission Solar modules with an Enphase IQ8M microinverter under each, and the utility recorded the request at 3.9 kilowatts.

When should the solar wiring go in on a conversion?

While the studs are open. On this building the runs went across the framing before the walls were closed; doing it afterwards means opening finished walls again.

Why is there a strip of newer stucco on the wall?

Because the wall was opened to bring the new service in and then patched. On a conversion that band is normal, and it is worth agreeing beforehand who finishes it and to what standard.

How long does the solar part take once the building is finished?

Five weeks here, from the interconnection request to permission to operate. The longer stretch on this project was the nine months between the first conversation and the application going in, which is time the owner controls.

What this would look like on your roof

Every number on this page came off a real job in North Hollywood, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
