Long Beach, CA · February 2022 · Southern California Edison / City of Long Beach

Installed on Monday in Long Beach, signed off on Tuesday

Sixteen modules, sixteen microinverters, one working day on the roof and an inspector on site the next morning. The interesting part of this project all happened before it started.

This Long Beach installation took one working day: sixteen 400 W modules — 6.4 kW DC — with an Enphase microinverter under each went on the Monday, and the final inspection was passed the following morning. Cali Energy had the permit, the approved meter position and the materials in hand before the crew arrived, which is what makes a one-day job possible — the roof work is rarely the part that takes the time.

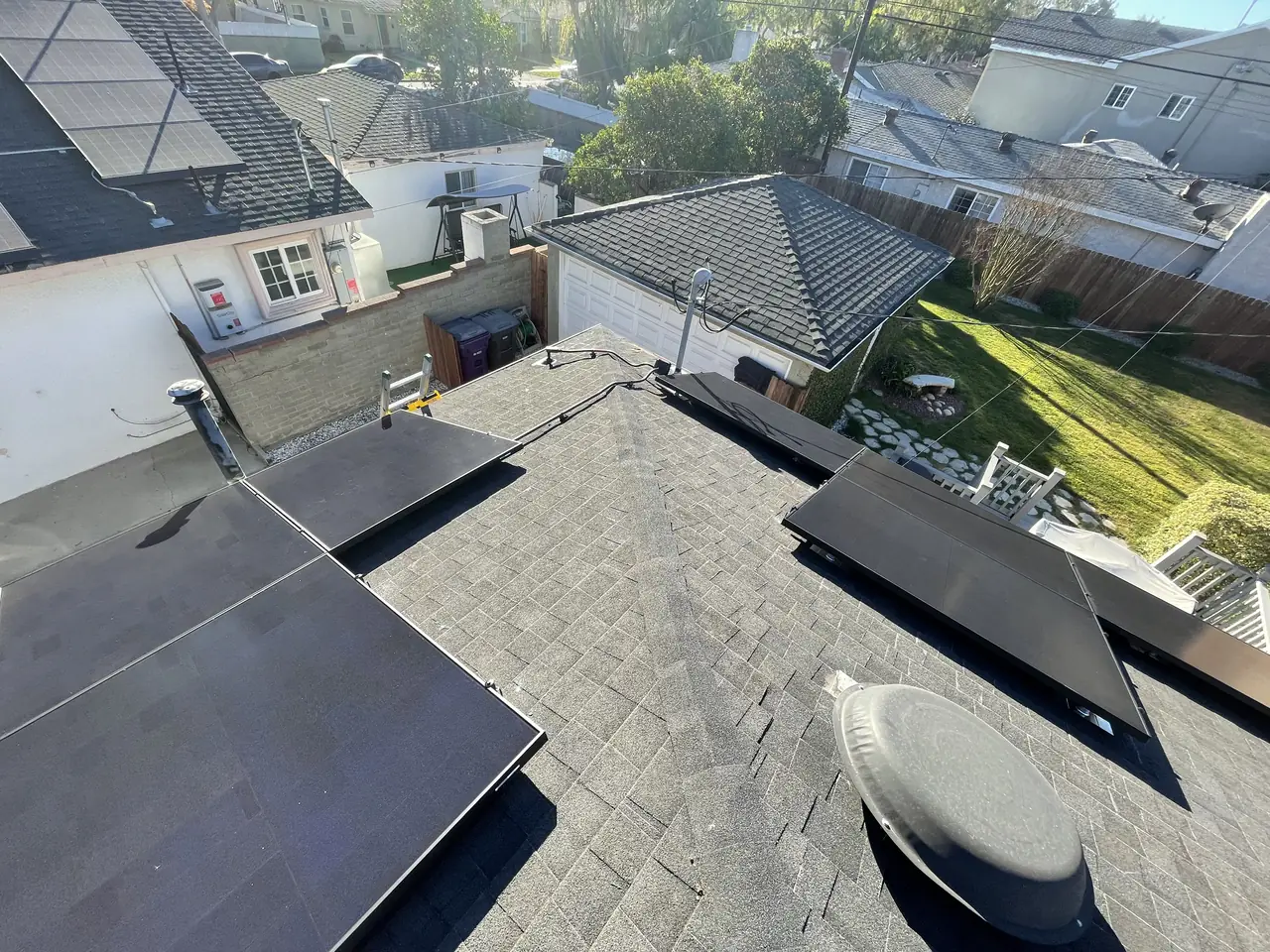

Two groups of solar modules on a shingle roof with the neighborhood and power lines beyond, Long Beach
The finished array, photographed the day it went on.

At a glance

Array
16 modules, 400 W each — 6.4 kW DC
Combiner
Enphase IQ Combiner, IQ8 system
Roof
Composition shingle, two groups
Materials
Delivered the working day before
Installed
Monday, 7 February 2022
Final inspection
Passed Tuesday, 8 February 2022
Utility / AHJ
Southern California Edison / City of Long Beach

The story

The whole visible part of this project is one day long. The materials came the working day before, the crew arrived on the Monday, and sixteen modules went onto two groups of a composition shingle roof with a microinverter under each of them. The inspector came the next morning and passed it.

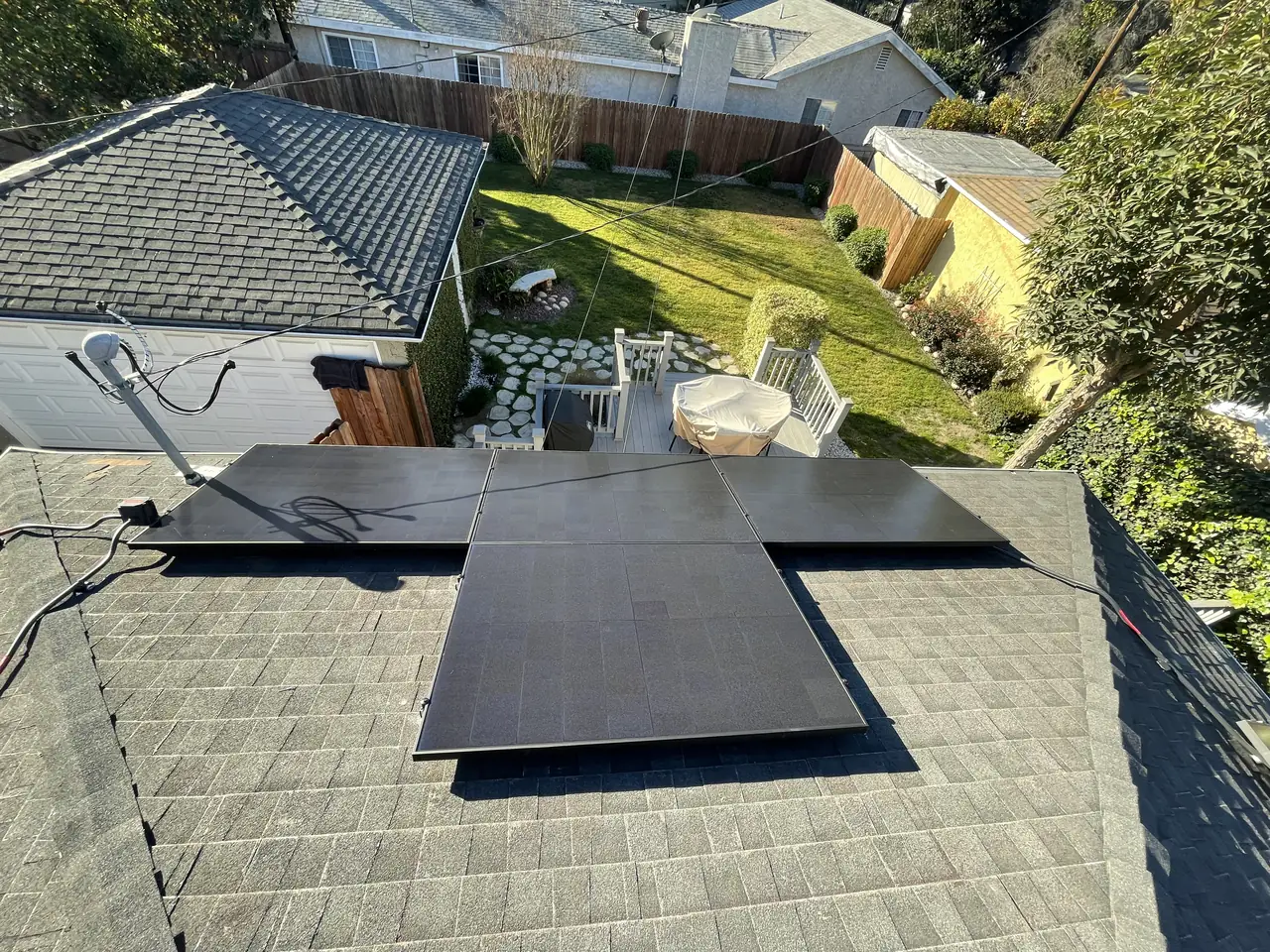

A solar array in two groups across a shingle roof above a driveway, Long Beach
Two groups, sized to the planes the roof actually offered.

That reads like a boast and it is not meant as one. A one-day installation is not a crew moving faster; it is a project where nothing was left to be discovered on the day. The permit was already issued. The utility had already approved where the meter would sit. The materials were on site rather than at a counter. Everything that can stop a job had been finished somewhere else first.

Microinverters help with the second half of it. Each module converts on its own, so there is no string design to lay out across the roof, no single inverter position to argue about, and the commissioning is a matter of each unit reporting in rather than a system coming up as one. Sixteen modules, sixteen microinverters, and a combiner on the wall that ties them together.

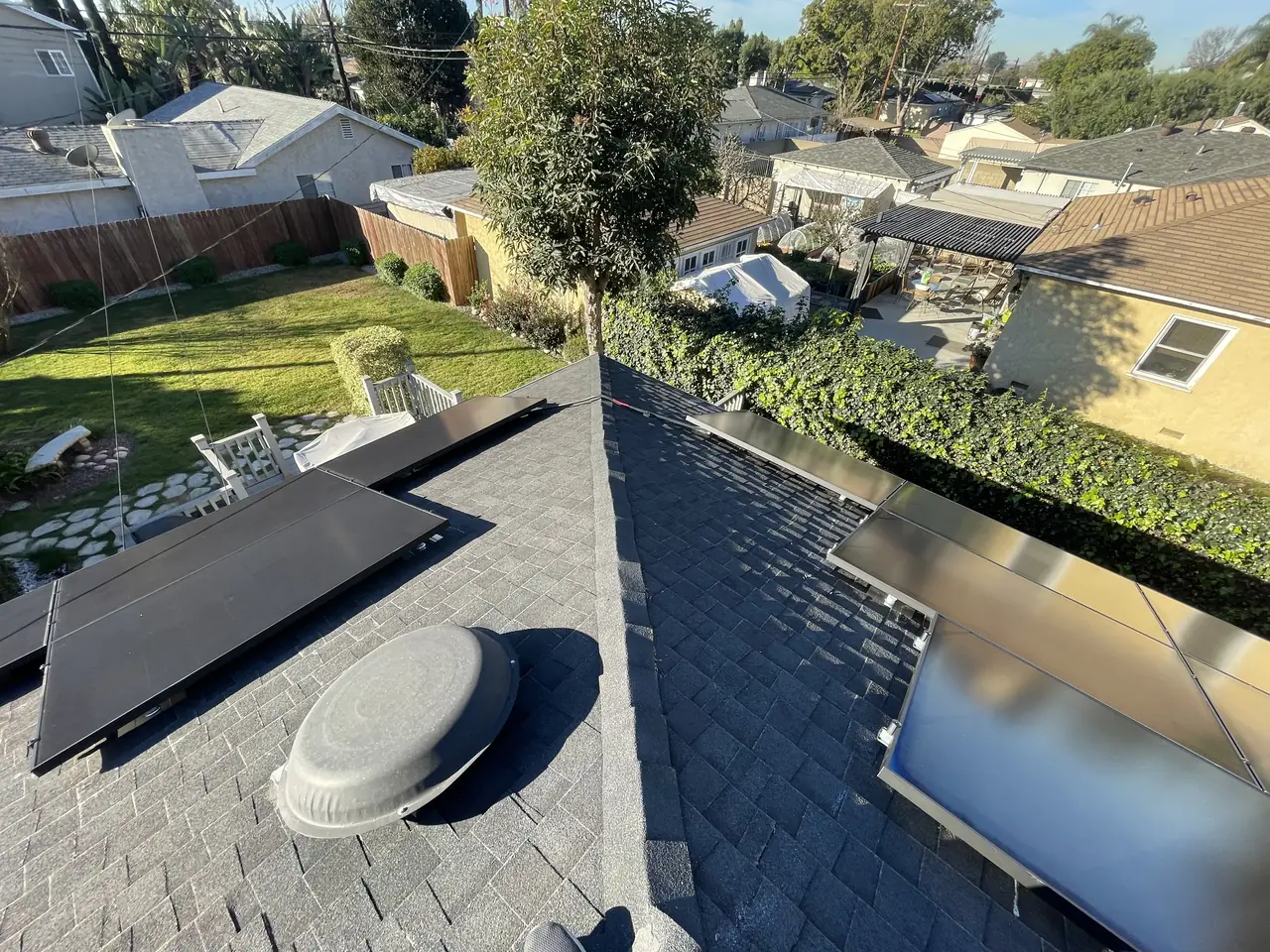

Solar modules on a shingle slope seen from the ridge, with a vent left clear beside them, Long Beach
From the ridge: the vent left clear, the groups set around it.

The next-morning inspection is the part worth planning for. Long Beach takes inspection requests online and gives a date rather than a window you negotiate, so the booking has to be made when the work is genuinely going to be ready. Booking the day after an installation only works if the installation is finished — labeled, closed up and safe to look at — before the crew leaves.

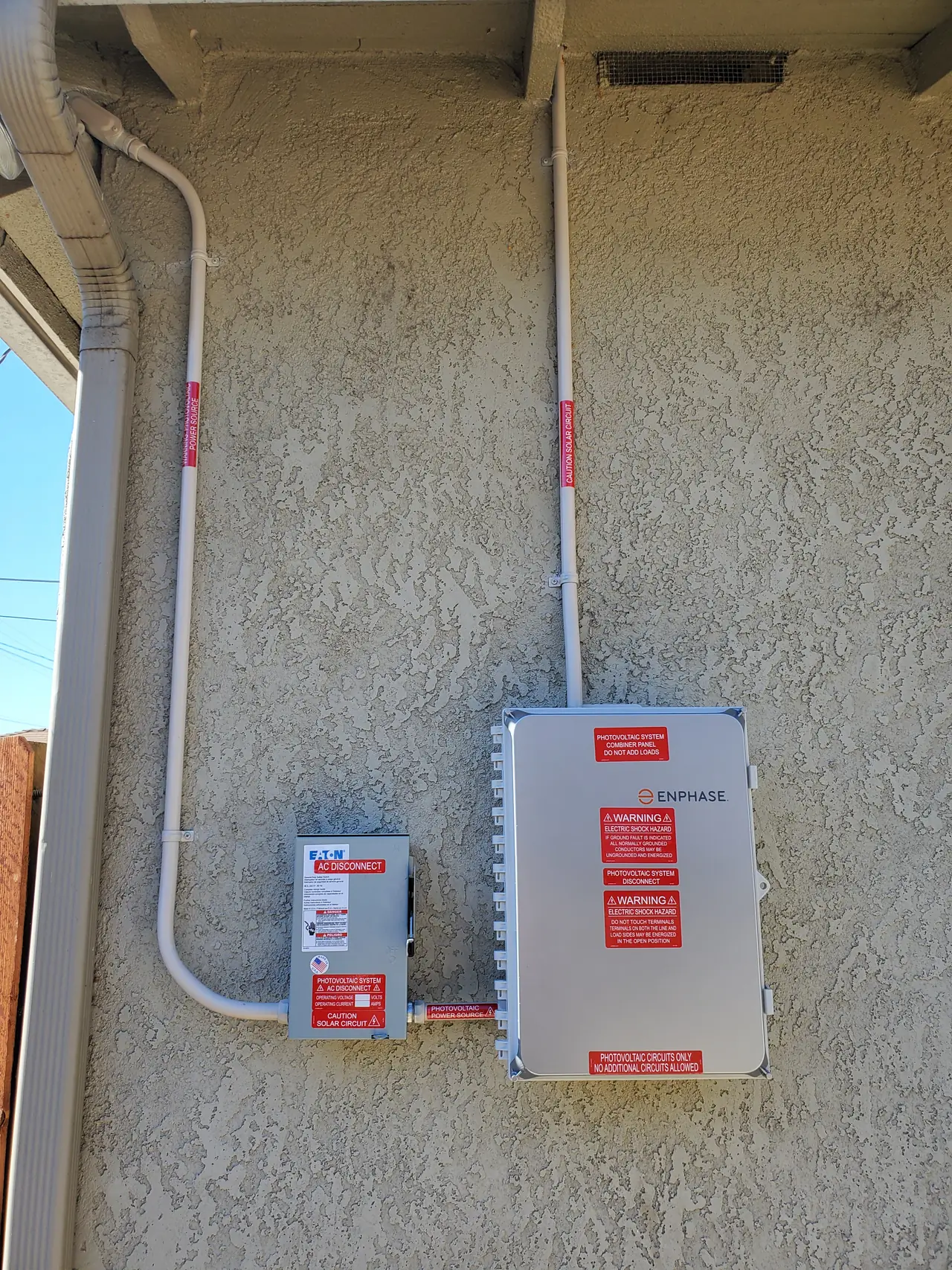

A disconnect and conduit run mounted on a stucco wall beside a fence, Long Beach
The wall side: disconnect, conduit and labels, done the same day.

None of that shows on a finished roof, which is exactly why it gets overlooked. A single day on site is the visible end of it. The reason the day was enough is everything that happened before it.

If you are comparing quotes and one of them promises a single day on the roof, the question is not whether the crew is fast. It is whether the permit is issued, the meter position approved and the material on site — because those are what turn one day into three.

How it ran

Early February 2022Permit issued and the meter position approved
4 February 2022Materials delivered ahead of the install
Monday, 7 February 2022Sixteen modules and sixteen microinverters installed
Same dayCombiner, disconnect and labeling completed on the wall
Same dayFinal inspection requested for the following morning
Tuesday, 8 February 2022Final inspection passed

One day on the roof, because nothing was left to be found out on the day.

What we did

  • Had the permit, the approved meter position and the materials in place before the crew was booked.
  • Installed sixteen modules in two groups with an Enphase microinverter under each.
  • Fitted the combiner and disconnect and labeled the run the same day.
  • Requested the final inspection for the next morning and left the work ready for it.
  • Passed the final on 8 February 2022, the day after the installation.

System specifications

Modules16 × 400 W — 6.4 kW DC, an Enphase microinverter under each
CombinerEnphase IQ Combiner, IQ8 system
RoofComposition shingle, array in two groups
LayoutSet around the existing roof vents
Wall equipmentCombiner, AC disconnect, labeled run
Final inspectionPassed 8 February 2022
Utility / AHJSouthern California Edison / City of Long Beach

Is your project like this one?

  • You have been quoted a one-day installation and want to know if that is real.
  • Your project has been waiting and nobody can say what on.
  • You want the inspection booked rather than left until later.
  • Your roof is a simple shingle plane with a couple of vents on it.
  • You want to know what microinverters change about the installation day.

Cali Energy in Long Beach

Long Beach is its own city, not a Los Angeles neighborhood: permits run through the City of Long Beach Building & Safety Bureau, interconnection through Southern California Edison.

A one-day installation followed by a next-morning final is not a sign that somebody hurried. It is a sign that everything that takes time — the permit, the utility's meter position, the materials — was finished before anybody got on the roof. In Long Beach those three run on three different calendars.

This installation is on the Long Beach projects page alongside the others, and what the work covers is set out on the Long Beach service area page.

Frequently asked questions

Can a solar installation really take one day?

On a straightforward shingle roof, yes — sixteen modules went on here in a single working day. What makes it possible is not speed on the roof but preparation off it: the permit issued, the utility's meter position approved and the materials delivered the day before. Where a job runs to three days, it is usually one of those three that was not ready.

How soon after installation can the final inspection happen?

As soon as the work is genuinely finished, and here that was the next morning. Long Beach takes inspection requests online and assigns a date, so the booking has to be made against work that will actually be ready — labeled, closed up and safe to look at. Booking optimistically is how a project collects a correction.

What do microinverters change on the day?

They remove the string design from the roof. Each module converts on its own, so there is no series layout to work around shading or roof planes, and commissioning is each unit reporting in rather than one inverter starting the whole system. On a roof with two separate groups, as here, that is simpler to build and simpler to fault-find later.

Does Cali Energy install solar in Long Beach?

Yes. Long Beach runs its own permit counter and its own inspection booking, and interconnection goes to Southern California Edison rather than a municipal utility. Cali Energy handles all of it — permit, installation, inspection and commissioning — and books the final against work that is ready for it. License CSLB #1032379.

What this would look like on your roof

Every number above came off a real job in Long Beach, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
