Hollywood Hills, CA · October 2022 – February 2023 · LADWP / LADBS

Hollywood Hills: the third final went in under a different permit.

Two corrections on the same number, and then a number issued in the new year. That change says more than either correction.

A permit describes a scope of work. A revision corrects the drawings inside that scope; a new permit is what the work needs when the scope itself has moved. On this Hollywood Hills project the final was attempted three times across three months — two corrections against the original permit in October and November, then a third request at the end of January under a permit issued in the new year. The second permit is what the third inspection was made against, and Cali Energy kept the roof under continuous permit cover across the change.

Solar modules on a shingle roof with trees and low sun, Hollywood Hills, Los Angeles
Finished through all three attempts at a final.

At a glance

Finals attempted
Three, across three months
Corrections
Two, both on the original permit
Third attempt
Under a permit issued the following year
What the change signals
The scope moved, not just the drawing
Utility / AHJ
LADWP / LADBS

The story

The sequence here is short and it says a lot.

Late October: a final requested for the twenty-eighth. It was held that day and it came back corrected.

Three weeks later: a second final requested, for the twenty-eighth of November, on the same permit. Filing under the same number is itself a statement — it means the expectation was that whatever the inspector wanted sat inside the work already permitted. That one came back corrected too.

Then a gap over the holidays, and at the end of January a third request, for the first of February. Different permit number. Not a revision to the first one — a second permit, issued in the new year.

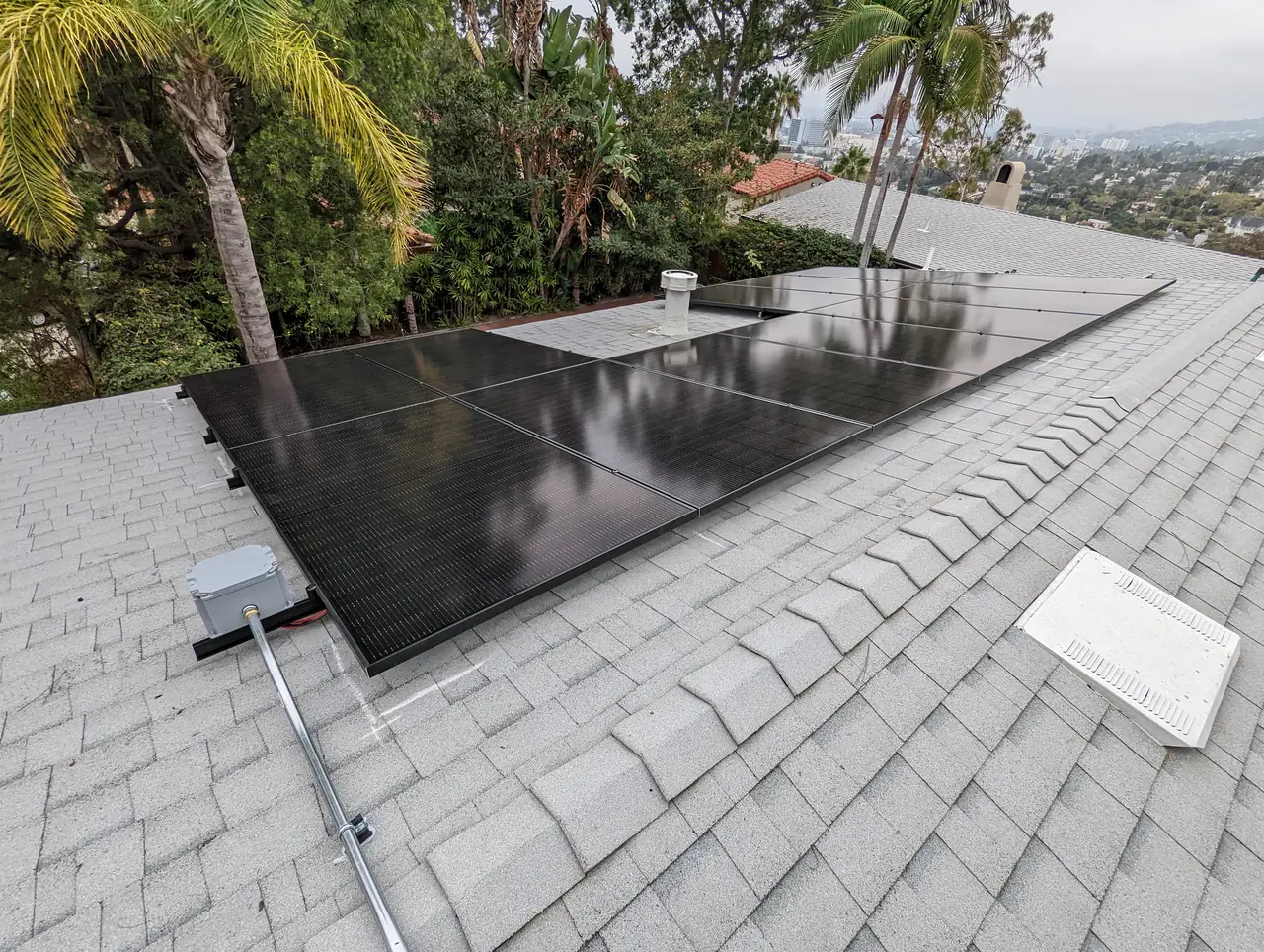

The array on a hillside roof with palms beyond, Hollywood Hills, Los Angeles
Three months, and nothing on the roof changed.

That last detail is the one worth explaining, because permit numbers are readable if you know what you are looking at. The leading digits are the year the permit was issued. Two numbers on one address, a year apart, means the job did not simply get fixed — it got re-described.

Here is the distinction that governs which one you need.

A revision keeps the permit and corrects the drawings under it. The work being authorized is the same work; the set describing it was wrong, incomplete or has moved on site. Most solar corrections end here.

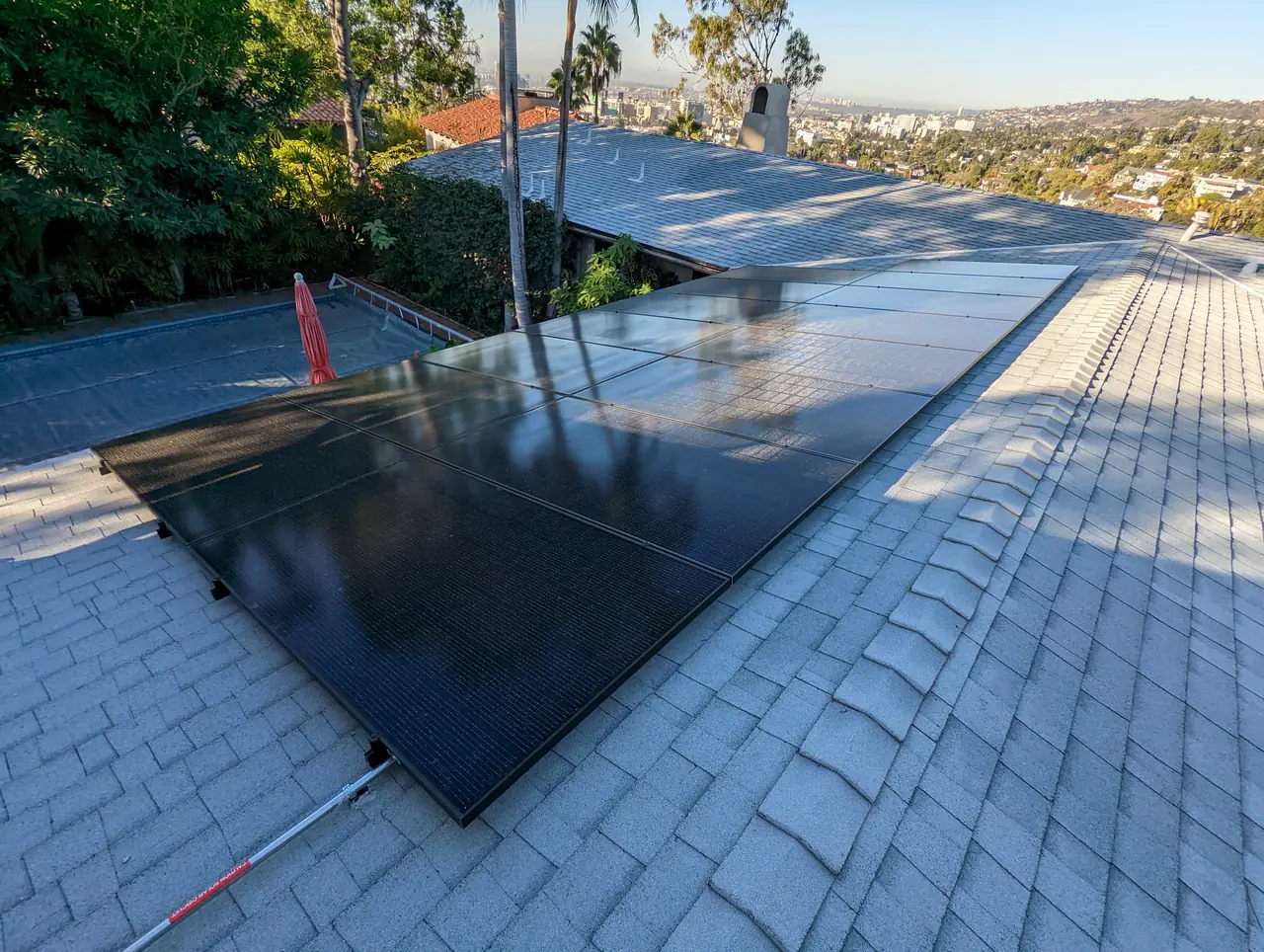

A solar module on a roof above the valley, Hollywood Hills, Los Angeles
A second correction on one item is a signal, not a repeat.

A new permit is for when the scope changes. Something was added that the first permit never covered, or the arrangement changed enough that the authorization no longer fits it. You cannot revise your way into work that was never permitted.

Which gives an owner a genuinely useful signal, and it arrives early: two corrections in a row on the same item. The first correction is ordinary. The second one, on the same point, is the moment to ask whether the answer sits inside the scope at all, because each attempt costs a request, a slot and the wait in front of it.

Three months on this roof, and the array was finished for all of them.

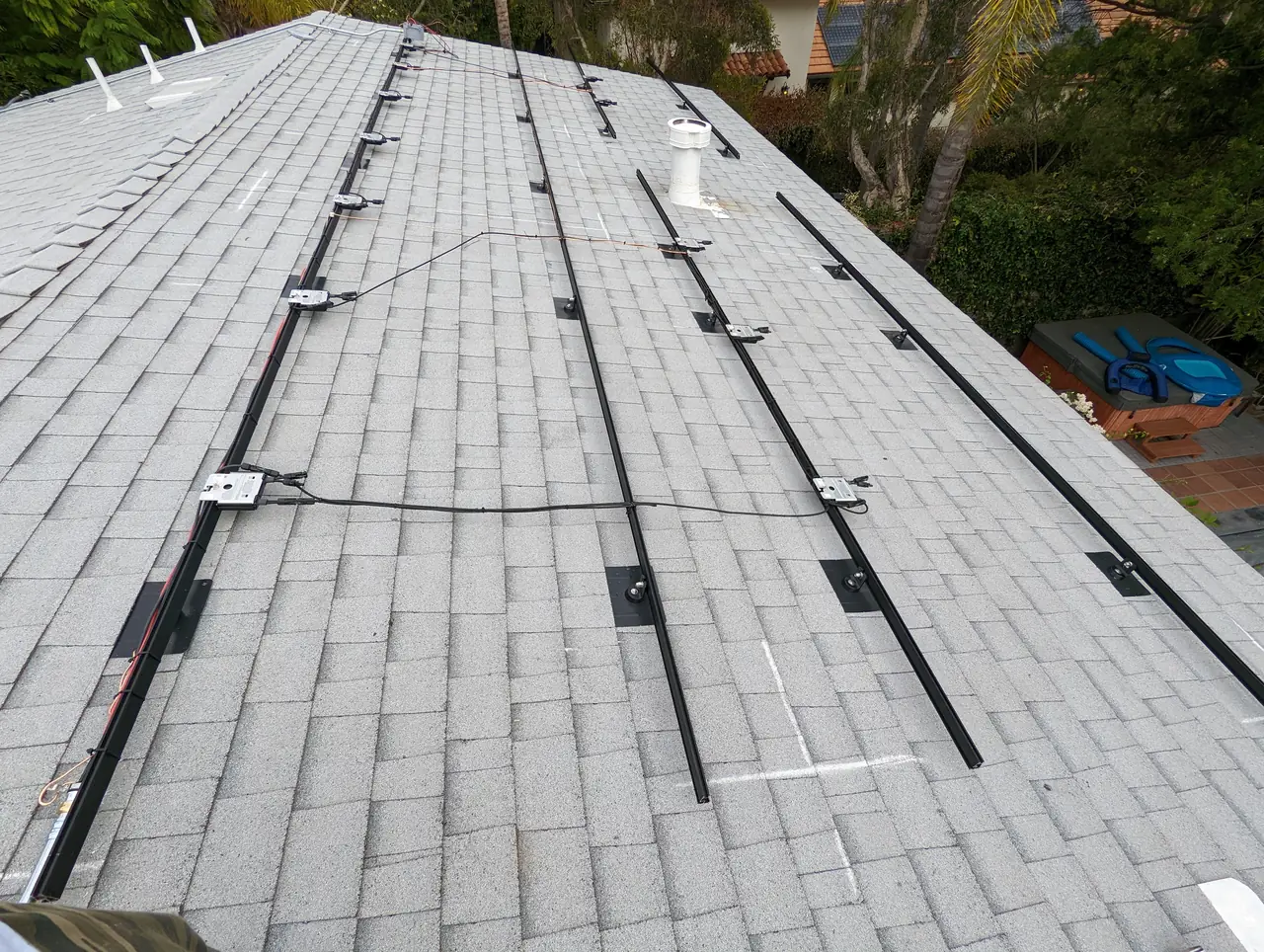

Mounting rails in rows on a shingle roof, Hollywood Hills, Los Angeles
The work a permit describes, and the reason a second one exists.

Cali Energy permitted and inspected this project in Hollywood Hills, Los Angeles.

How it ran

14 October 2022Installation
25 October 2022Final inspection requested for the 28th
28 October 2022Correction issued against the final
18 November 2022Second final requested, for the 28th, on the same permit
28 November 2022Second correction issued
30 January 2023Third final requested, for 1 February — under a second permit
From thereThe second permit carries its own final, and the roof is inspected against the set that describes it

Three attempts in three months, and the number on the third was not the number on the first.

What we did

  • Requested the final promptly each time rather than sitting on a correction.
  • Re-presented the work on the original permit while that was still the right route.
  • Took out a second permit once it was clear the work had moved beyond the first.
  • Kept the roof under continuous permit cover across the change.

System specifications

ArrayResidential rooftop
First permitIssued 2022
Corrections against itTwo
Second permitIssued 2023
Third finalRequested under the second permit
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your final has come back twice on the same item.
  • There are two permit numbers on your address and nobody has explained why.
  • You are being told you need a new permit rather than a revision.
  • Your project has stayed open across a calendar year.

Cali Energy in Hollywood Hills

Hollywood Hills is City of Los Angeles above the basin, permitted through LADBS and interconnected through LADWP. Hillside lots, long service runs and fire access rules that bite harder here than on flat ground.

This installation is on the Los Angeles projects page alongside the others, and what the work covers is set out on the Los Angeles service area page.

Frequently asked questions

What is the difference between a permit revision and a new permit?

A revision keeps the permit and corrects the drawings under it — same authorized work, better description. A new permit is needed when the scope itself changes, because work that was never permitted cannot be revised into an existing authorization.

What does it mean if a final is corrected twice?

Often that the first fix answered the symptom rather than the item. Two corrections in a row on the same point usually means the answer sits outside the permitted scope, and the question to ask at that moment is whether a revision is enough or a second permit is required.

Can one address have two solar permits?

Yes, and it is common enough to be unremarkable. Permit numbers carry the year of issue in their leading digits, so two numbers a year apart on one address describe a job that was re-scoped rather than simply repaired.

How long does a corrected final take to clear?

It depends entirely on whether the fix is inside the scope. Inside it, days. Outside it, the project needs new paperwork and rejoins a queue — on this Hollywood Hills roof the span from first attempt to third was three months, with the array complete throughout.

Does Cali Energy handle solar inspections in Hollywood Hills, Los Angeles?

Yes. Hillside projects here are permitted through LADBS and interconnected through LADWP, and the fire access and service-run rules are stricter than on flat lots — which is exactly where a correction most often turns out to be about scope rather than workmanship.

What this would look like on your roof

Every number above came off a real job in Hollywood Hills, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
