Chatsworth, CA · July 2023 · LADWP / LADBS

The inspector never came to the house.

The Los Angeles Department of Building and Safety runs a Virtual Inspection Program. On this Chatsworth project the permit inspection was held over video, in a fifteen-minute window, with nobody driving anywhere.

LADBS operates a Virtual Inspection Program that a permit holder can join by signing a participation agreement. On this project the inspection was then held over a video call in a scheduled fifteen-minute slot rather than as a site visit.

Solar modules installed on a roof in Chatsworth
The array that the inspection covered.

At a glance

Program
LADBS Virtual Inspection
Joining requirement
Signed participation agreement
Inspection format
Scheduled video call
Slot length
15 minutes
Permits covered
Two, one appointment
Modules
Canadian Solar CS6K-280M
Recording
Not permitted
Utility / AHJ
LADWP / LADBS

The story

Most of what a building department does on a solar project ends in somebody standing on the property. An inspector arrives inside a window, looks at the work, and signs or does not sign. That window is one of the least predictable parts of the calendar.

On this project it did not happen that way.

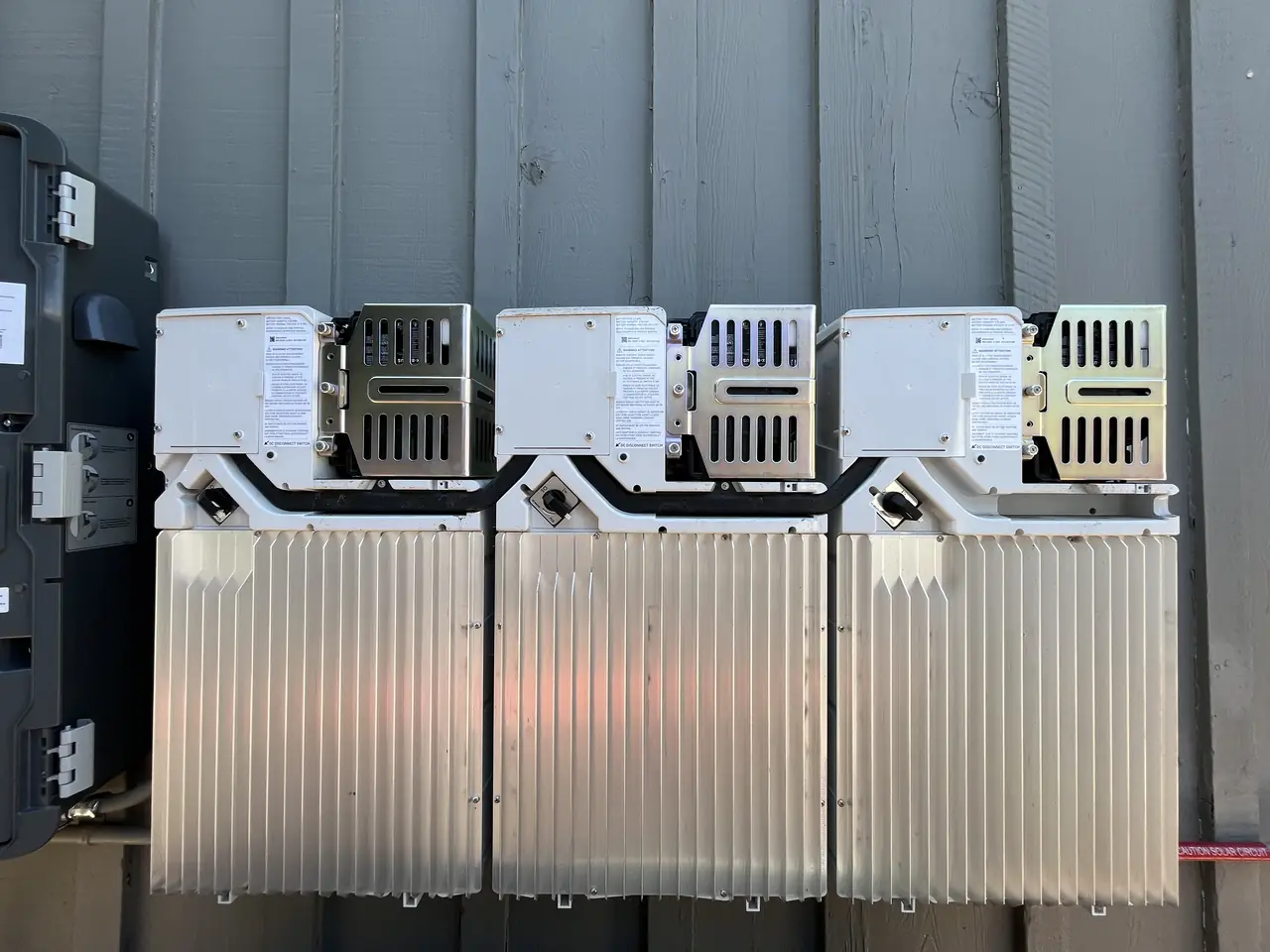

Inverter equipment mounted in a row on an exterior wall, Chatsworth
The equipment the inspection covered, on the wall.

The Los Angeles Department of Building and Safety runs a Virtual Inspection Program. It is not an informal arrangement with an individual inspector: joining it means signing a participation agreement with the department, in which the applicant accepts the terms of the program, takes responsibility for taking part, and acknowledges that no part of the inspection may be recorded or broadcast.

We signed into the program for this permit on a Wednesday. The appointment came back for the following day — a fifteen-minute slot, held over a video call, covering both permit numbers on the job in one sitting.

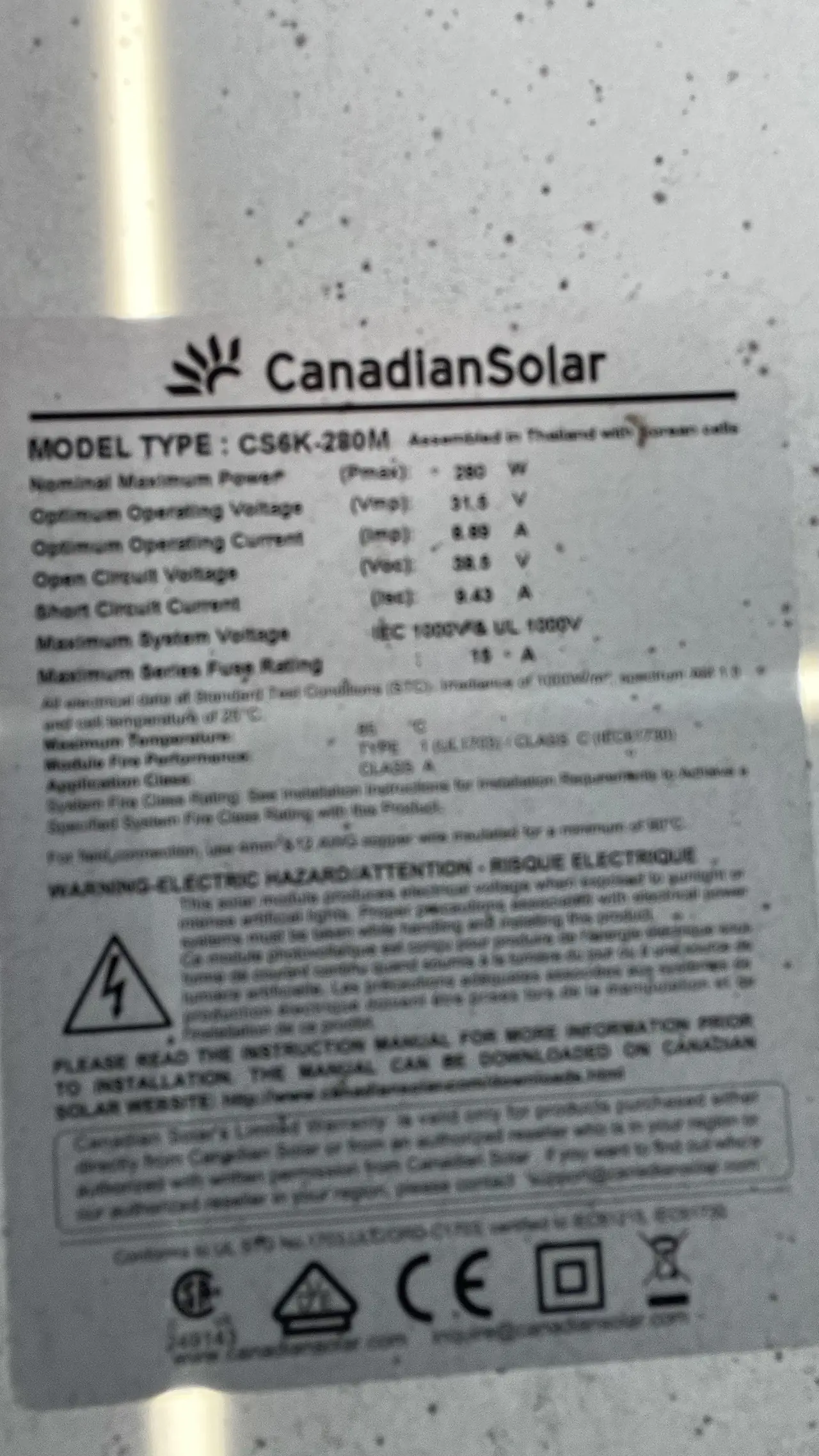

Module nameplate label on the back of a solar panel, Chatsworth
The module nameplate — the kind of detail an inspection confirms.

What the format changes is not the standard. The same things are checked: the equipment installed against the equipment approved, the labeling, the conductors, the disconnects. What changes is that someone has to be on site with a camera, walking the inspector through it, and able to put the camera where it is asked to go.

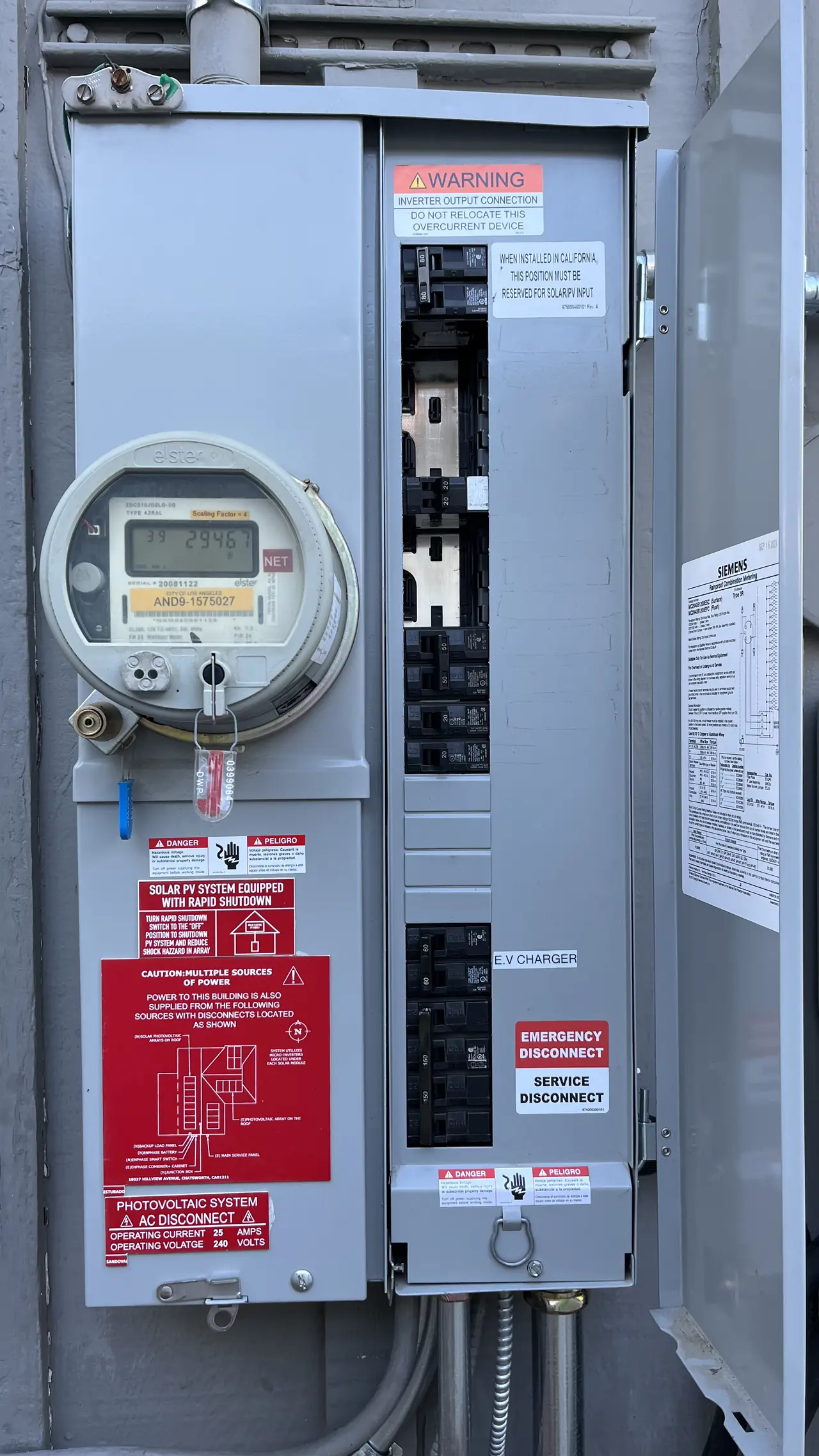

Service equipment and disconnects on an exterior wall, Chatsworth
Service equipment and disconnects, on camera.

The useful part is knowing the program exists and that there is a form to sign to join it. Availability is the department's to decide, on its own criteria, and it can change. But on a project that is otherwise ready and waiting on an inspection window, it is worth asking the question rather than assuming the only route is a site visit.

How it ran

12 July 2023Virtual Inspection Program participation agreement signed for the permit
12 July 2023Appointment issued for the following day
13 July 2023Inspection held over video — a fifteen-minute slot covering both permits

These dates cover the virtual inspection step on this project. The program is the department's, and what it offers is set by the department rather than by the contractor.

What we did

  • Established that the department's Virtual Inspection Program applied to this permit.
  • Signed the participation agreement and release on behalf of the permit holder.
  • Took the appointment for the following day.
  • Attended on site with a camera and walked the inspector through the installation.
  • Covered both permit numbers on the job in the one appointment.

System specifications

ProgramLADBS Virtual Inspection Program
Joining requirementSigned participation agreement and release
FormatScheduled video call with the department
Slot length15 minutes
ScopeTwo permit numbers in one appointment
RecordingNot permitted under the program terms
ModulesCanadian Solar CS6K-280M, 280 W
Utility / AHJLADWP / LADBS

Is your project like this one?

  • Your project is finished and waiting on an inspection window.
  • You have more than one permit open on the same job.
  • You want to know which steps have to happen on site and which do not.
  • Nobody has explained what the inspection will actually look at.
  • Your Chatsworth property is served by LADWP, while permits are handled by LADBS.

Cali Energy in Chatsworth

Chatsworth is inside City of Los Angeles boundaries: permits run through LADBS, interconnection through LADWP.

Not every step on a project here happens on site, and knowing which ones do not is part of keeping a calendar honest.

This installation is on the Chatsworth projects page alongside the others, and what the work covers is set out on the Chatsworth service area page.

Frequently asked questions

Does LADBS do inspections over video?

It runs a Virtual Inspection Program, which a permit holder joins by signing a participation agreement with the department. On this project the inspection was then held over a video call in a scheduled fifteen-minute slot. Whether it is available on a particular permit is the department's decision.

What do you have to agree to in order to take part?

The program's participation agreement is a waiver and release: the applicant accepts the terms, assumes responsibility for taking part, and acknowledges that no part of the inspection may be recorded or broadcast — no audio, no video, no stills. We signed it for this permit the day before the appointment.

Is a virtual inspection easier to pass?

No. The same things are checked — equipment against the approved plans, labeling, conductors, disconnects. What changes is that somebody has to be on site with a camera and able to show the inspector whatever is asked for, which means the work has to be genuinely finished and accessible before the slot starts.

Can two permits be inspected in one appointment?

On this project they were: both permit numbers on the job were covered in the same fifteen-minute slot. That is a practical reason to have the permits lined up and the whole job ready rather than calling for inspections one at a time.

What this would look like on your roof

Every number on this page came off a real job in Chatsworth, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.
