Santa Clarita, CA · June – July 2022 · Southern California Edison / City of Santa Clarita

Santa Clarita: one clean final on the permit record.

A withdrawn inspection costs a date. A failed one costs a correction on the record.

An inspection request can be withdrawn as easily as it is made, and there are days when that is the right call: turning up for a final that cannot pass produces a correction against the permit, and a correction has to be cleared and re-inspected. On this Santa Clarita project the job depended on a recessed, flush-mount service panel rather than a surface one, so Cali Energy did the panel first, booked the final behind it, and the permit closed on a single clean inspection in July 2022.

A solar array on a clay tile roof above a walled yard, Santa Clarita
The array on the clay tile roof, finished at the end of June.

At a glance

Array
REC 365 W modules
Installed
Late June
Final
Passed on the first inspection, July 2022
Order of work
Panel replacement first, final after
Utility / AHJ
Southern California Edison / Santa Clarita

The story

The array went in at the end of June, quickly — the modules arrived on site the morning of the install.

A final was booked for the following Tuesday, and then moved behind the panel work.

The reason was a panel. Not the modules — the service panel, the one the array connects into. It needed replacing, and the replacement had to be a flush-mount unit: recessed into the wall rather than surface-mounted on it.

A service panel recessed into an opened stucco wall, Santa Clarita
The service panel recessed into the opened stucco wall: the opening decides what can go back in.

That distinction sounds cosmetic and is not. A surface panel hangs on the finished wall and can be swapped for anything that fits the wall. A flush panel sits inside the wall cavity, with the finish closing around its edge. Replacing one means finding a unit that matches the opening, or opening up the wall, patching it and refinishing — which turns an electrical job into a construction one. So the hunt for the right enclosure is real work, and it can hold up everything behind it.

Which brought the question of what to do about the inspection already on the calendar.

Two options, and they are not equal. Keep the date before the panel is in, and the inspector writes a correction that attaches to the permit, has to be cleared and the work re-inspected. Or withdraw the request before he leaves the office: the slot is released, nothing attaches to the record, and the next booking is a fresh first attempt.

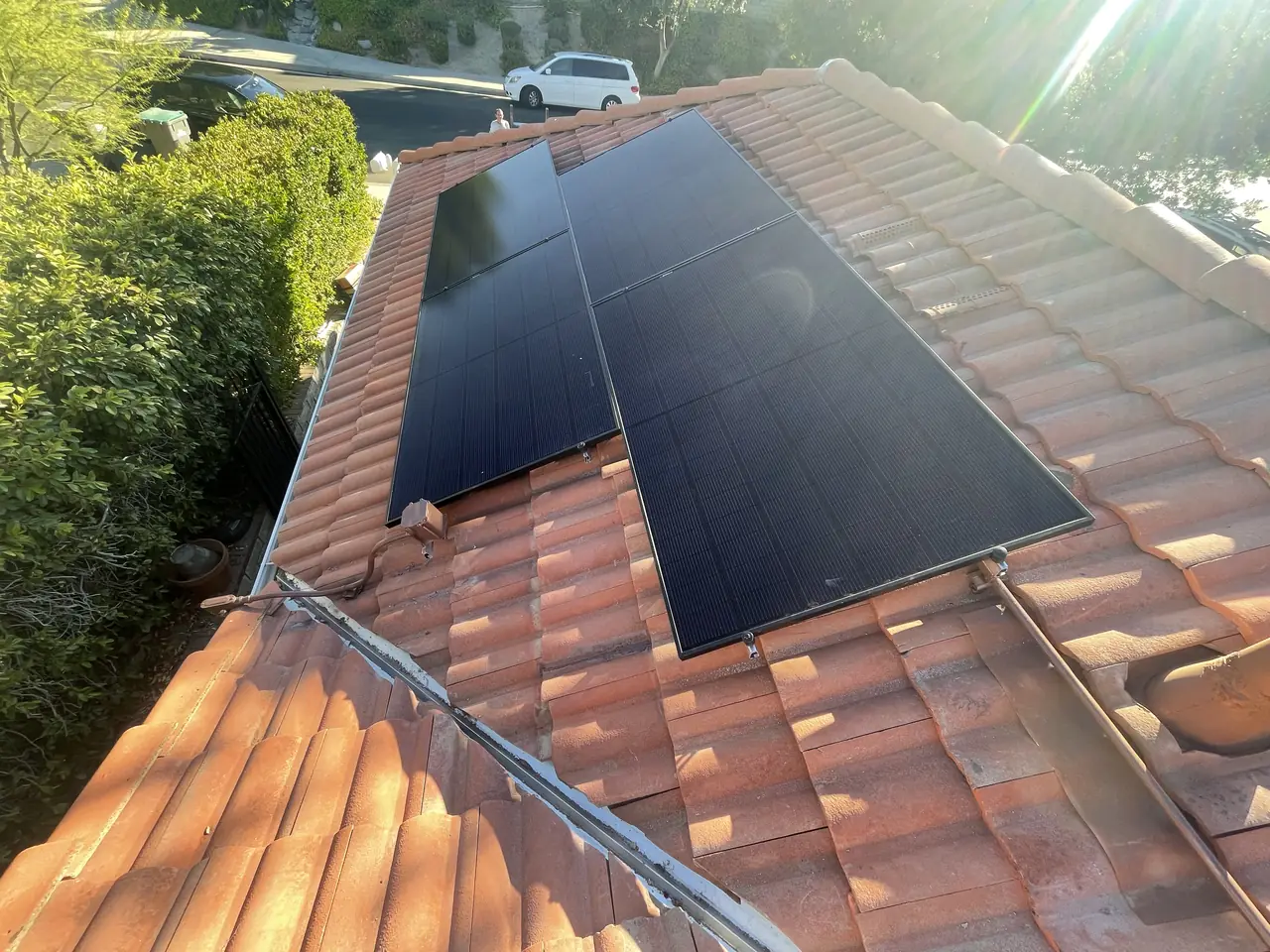

Modules laid across a tile roof beside the ridge, Santa Clarita
REC 365 W modules along the ridge.

The second costs a date. The first costs a date plus a correction plus a re-inspection, and leaves a mark on the permit record that a future buyer's inspector can read.

So the booking came off and the panel was sourced.

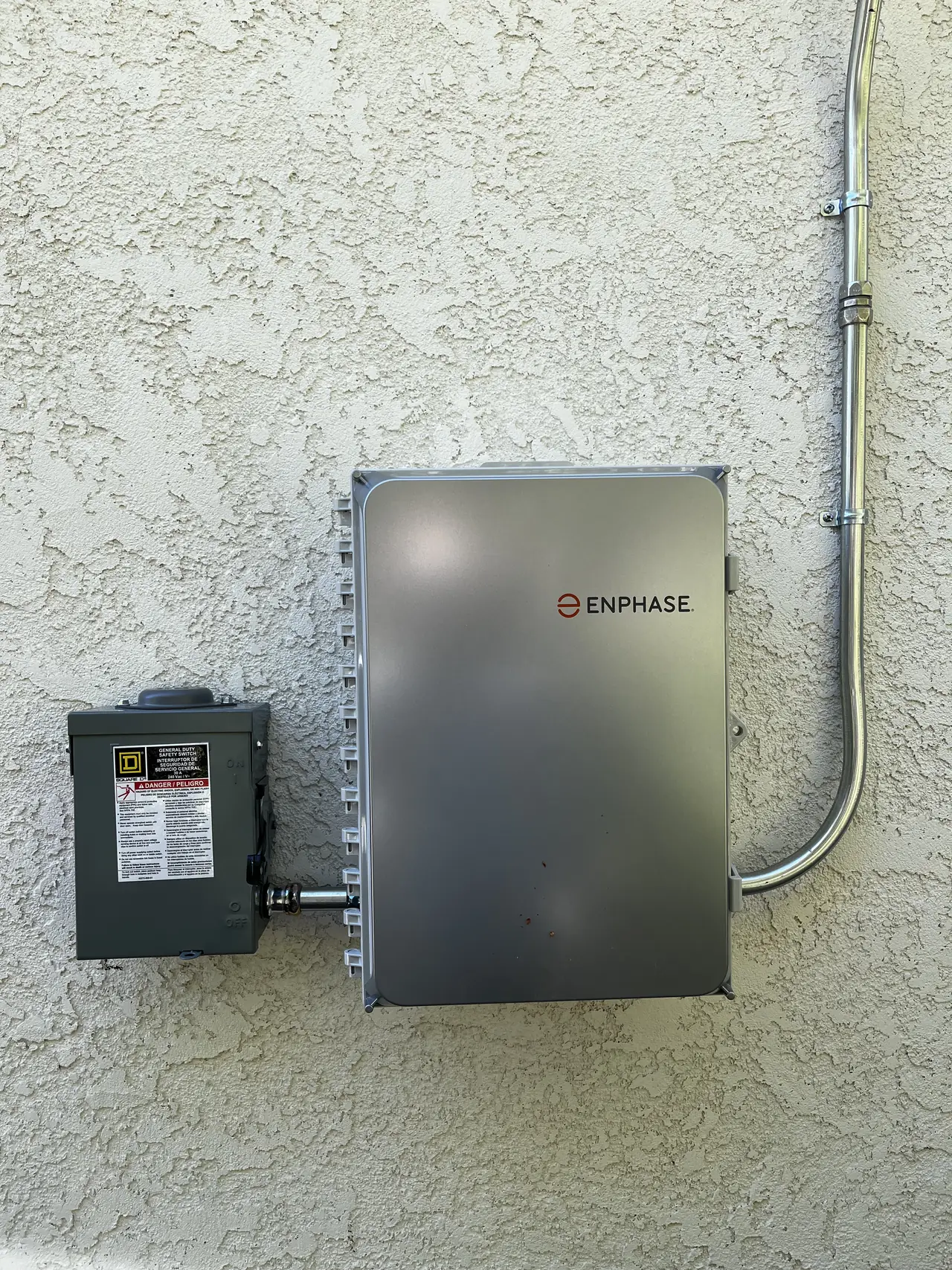

A closed combiner enclosure on a stucco wall, Santa Clarita
The panel first, the final after it.

The general lesson for an owner watching a schedule slip: an inspection date that moves is not automatically bad news. Ask which direction it moved for. A withdrawn inspection usually means somebody looked ahead and decided not to waste a pass.

The panel was replaced on the Saturday, the final was held the following Tuesday and passed, and the permit closed with nothing attached to it. The record for this address reads as one clean inspection, which is exactly what the withdrawn booking bought.

Cali Energy installed, upgraded and finaled this project in Santa Clarita, and the house has run on the array since July 2022.

How it ran

22 June 2022Materials released; modules delivered to site
23 June 2022Installation
27 June 2022Final booked for the next day
27 June 2022Booking withdrawn until the flush-mount panel is in
7 July 2022Panel replacement scheduled for the Saturday
9 July 2022Service panel replaced
12 July 2022Final inspection held
13 July 2022Final passed

Three weeks, and the decision that saved the record was withdrawing a date rather than keeping it.

What we did

  • Withdrew the inspection request until the panel was in, rather than spend a first attempt.
  • Sourced a flush-mount enclosure that suited the existing opening.
  • Did the panel replacement before the final rather than after it.
  • Kept the permit record free of a correction that was avoidable.

System specifications

ArrayREC 365 W modules
ServiceFlush-mount panel replacement
Why flush mattersRecessed into the wall; the opening constrains the unit
FinalPassed at the first inspection, after the panel
Utility / AHJSouthern California Edison / Santa Clarita

Is your project like this one?

  • Your inspection date has moved and nobody explained why.
  • Your service panel is recessed into the wall and needs replacing.
  • You are being told a correction is normal.
  • You want to know what ends up on a permit record.

Cali Energy in Santa Clarita

Santa Clarita is its own city in Los Angeles County, permitted through the City of Santa Clarita Building & Safety Division and interconnected through Southern California Edison. Tract housing where the service panel is often recessed into the wall rather than hung on it.

This installation is on the Santa Clarita projects page alongside the others, and what the work covers is set out on the Santa Clarita service area page.

Frequently asked questions

Can an inspection request be withdrawn?

Yes, and it is released as easily as it is booked. Withdrawing a request before the inspector attends costs the slot and nothing else; letting an unready installation be inspected produces a correction against the permit that then has to be cleared and re-inspected.

What is a flush-mount service panel?

One recessed into the wall cavity, with the wall finish closing around its edge, rather than surface-mounted on the finished wall. Replacing one means finding a unit that suits the existing opening, or opening the wall and refinishing it afterwards.

Does a correction stay on the permit record?

It does, and it is readable later. That is the practical argument for not letting an inspection go ahead when the work is not ready: the cost is not only the re-inspection but a note on the permit record that outlives the project.

Is a moved inspection date a bad sign?

Not by itself. The useful question is which direction it moved for. A withdrawn inspection usually means somebody looked ahead and decided not to spend a first attempt on work that could not pass.

Does Cali Energy handle panel replacements in Santa Clarita?

Yes, including recessed flush-mount units where the opening limits what can go back in. Projects here are permitted through the City of Santa Clarita Building & Safety Division and interconnected through Southern California Edison.

What this would look like on your roof

Planning solar in Santa Clarita? Tell us your utility, your roof and what your bill looks like now, and we will model what a system like this would do on your house before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
