Santa Clarita, CA · February – March 2022 · Southern California Edison / City of Santa Clarita

Santa Clarita: ten working days and nothing went wrong.

No corrections, no substitutions, no missing documents. The interesting part is what made that possible.

A solar project can run from a request for an installation date to a passed final in about two weeks, and when it does it is because everything the job needed existed before it started: an approved plan set, the equipment on hand, and a permit ready to be inspected against. On this Santa Clarita project the plans and the AC disconnect were already in hand when the date was asked for, Cali Energy installed on the Monday of the following week, and the final passed ten working days after the first email.

A solar array on a tile roof with the valley and hills behind it, Santa Clarita
Requested on 16 February, installed on the 21st, signed off on 1 March.

At a glance

Date requested
16 February
Installed
21 February
Final
Passed 1 March
Corrections
None
What made it possible
Plans and equipment ready before the date was set
Utility / AHJ
Southern California Edison / Santa Clarita

The story

Most case studies are about something going wrong, because that is where the lesson usually hides. This one is here for the opposite reason: it is what the process looks like when every input was ready before it was needed.

The sequence, in full. A Wednesday in the middle of February: a request for an installation date, with a note that the plans and the AC disconnect were already at hand. The next day: installation booked for the Monday of the following week, confirmed the same morning. Monday: installed. The Friday after: final requested for the Monday. That Monday: inspected, photographs issued. Tuesday: passed.

Ten working days from the first email to a closed permit, with no corrections and no re-inspection.

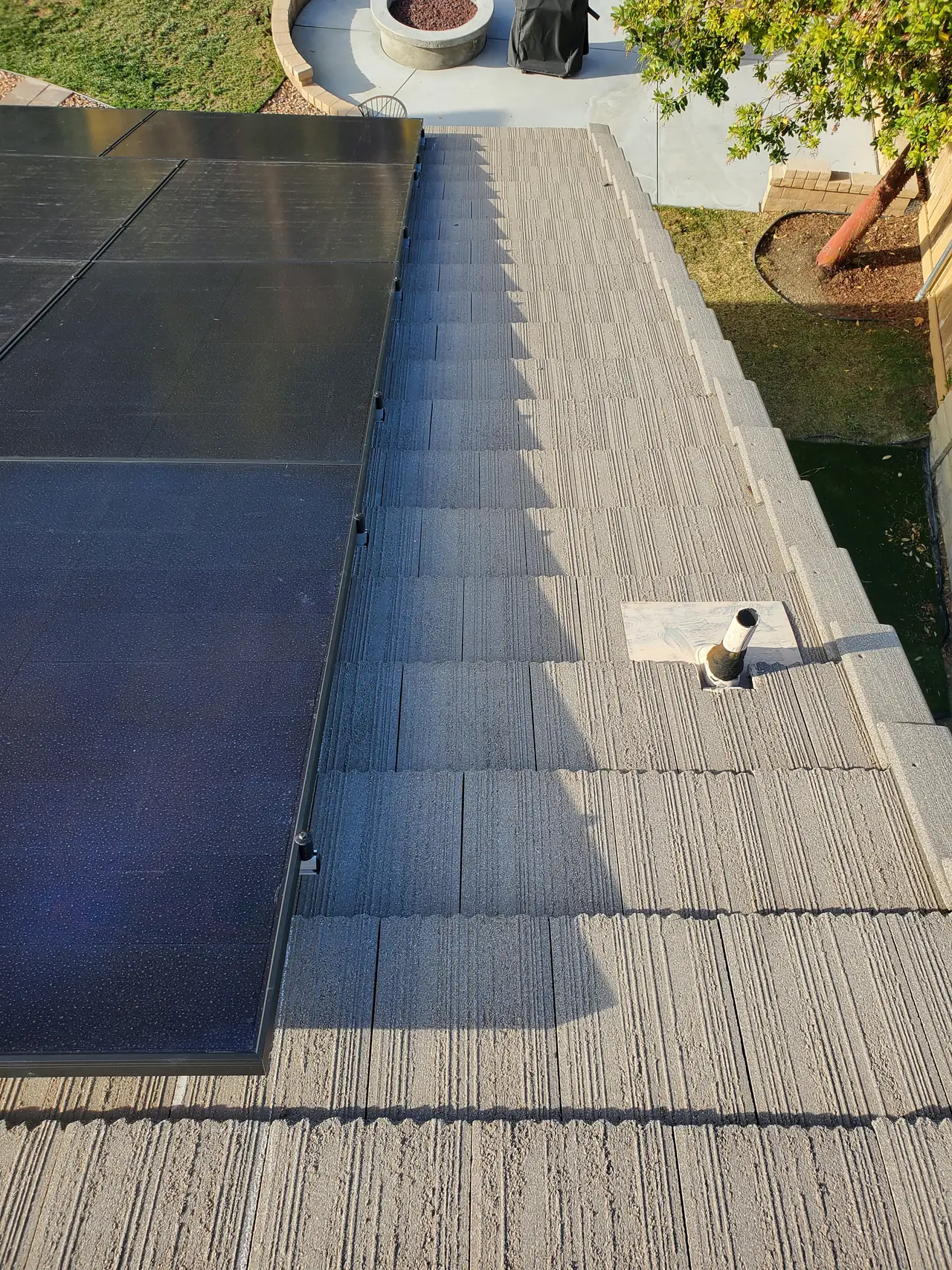

Solar modules seen from above on a tile roof, Santa Clarita
Nothing here needed a correction.

What is worth extracting from that is not the speed. It is which things had already been settled before the clock started, because they are the same things that hold up every project that takes four months instead.

The plan set existed and was approved. Nothing was waiting on drafting, on plan check, or on a revision — which is the single largest variable in residential solar and the one owners have the least visibility into.

The equipment was in hand, including the AC disconnect. Not ordered, not promised — physically available. That one item has delayed more installations than any other small component, because it is easy to assume it will be there and it frequently is not.

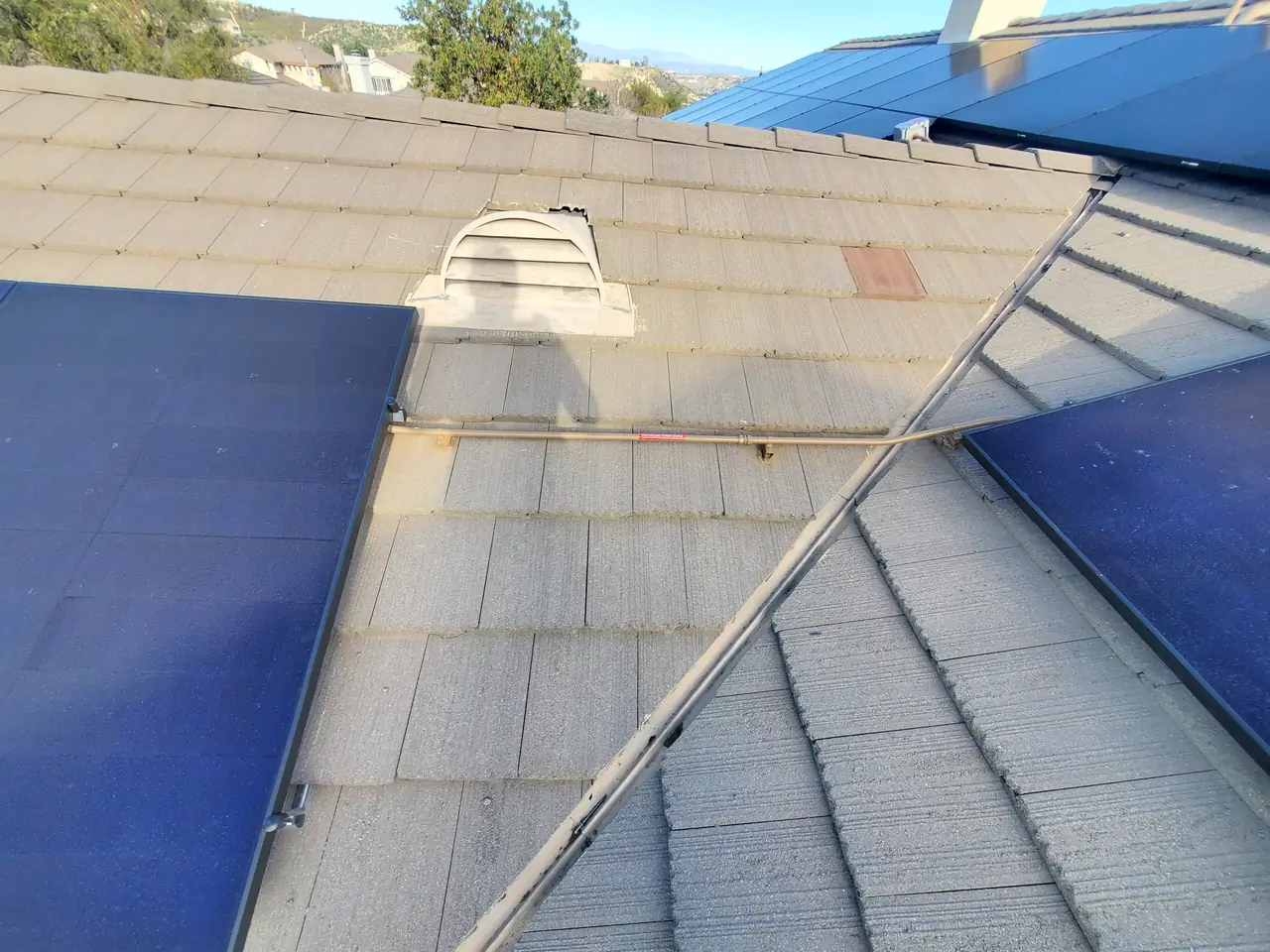

A second slope of the same tile roof carrying modules, Santa Clarita
Plans and equipment were on hand before the date was set. That is the whole story.

The permit was live and inspectable, and the job card went with it, so the final could be requested the moment the work was finished rather than after a hunt for a document.

And the installation was a single day with no surprises on the roof, which is mostly a consequence of the survey having been straight.

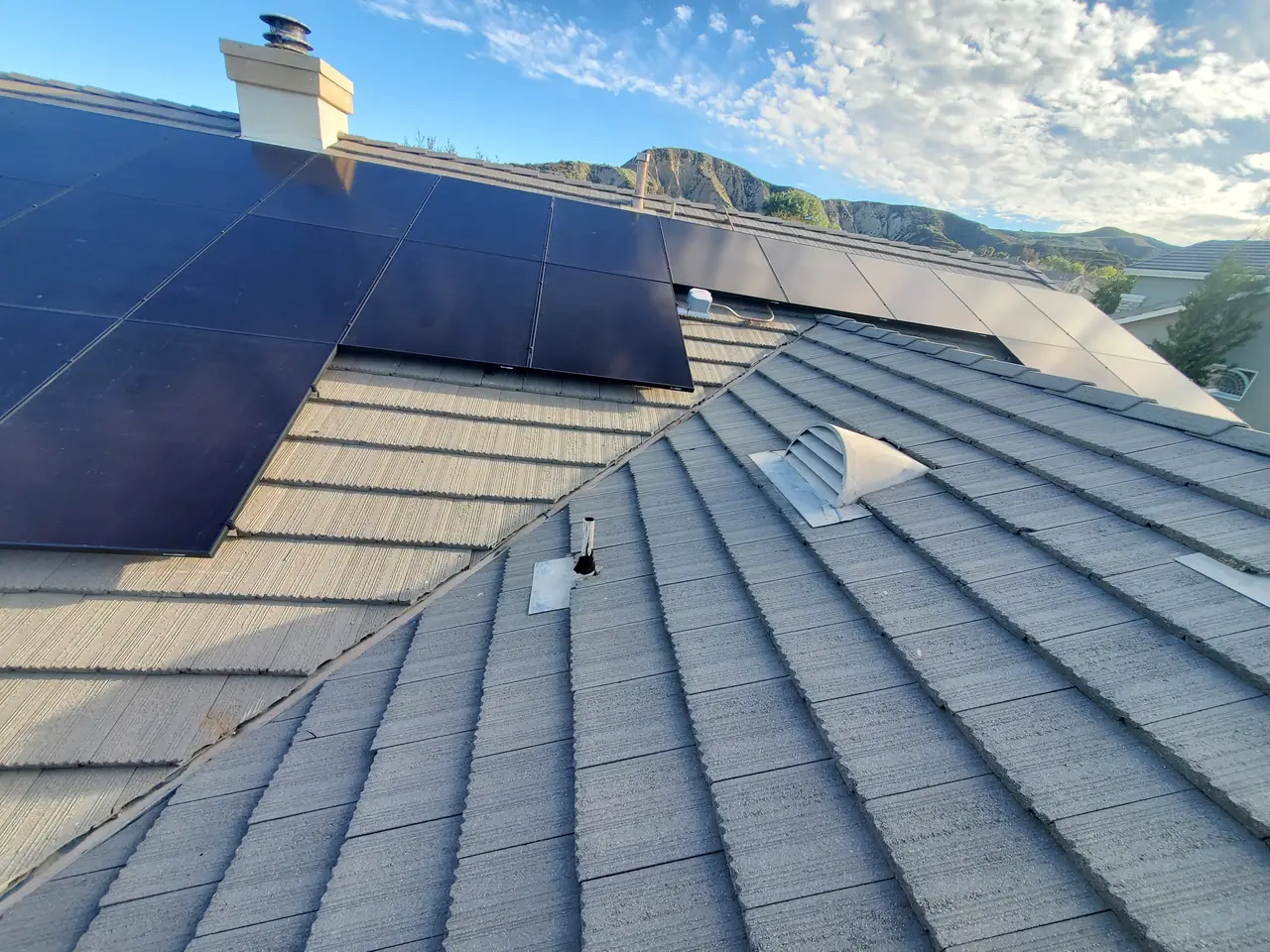

A tile roof seen along the ridge with modules on both sides, Santa Clarita
Five days from crew to a final that passed first time.

So when somebody asks how long solar takes, the truthful answer is that the installation takes a day and everything else depends on how much was ready beforehand. Two weeks is achievable. Four months is also achievable, on the same house, with the same crew, if the drawings are still in review and the disconnect is on a truck somewhere.

The final passed on the first of March with no corrections written against it, and the household had a working array thirteen days after asking for a date. Dull is the best outcome this process has.

Cali Energy installed and finaled this project in Santa Clarita.

How it ran

16 February 2022Installation date requested; plans and AC disconnect already in hand
17 February 2022Installation booked for Monday the 21st and confirmed
21 February 2022Installation
25 February 2022Final requested for Monday the 28th
28 February 2022Inspection held; photographs issued
1 March 2022Final passed

Ten working days, start to finish, and not one of them was spent waiting for a document.

What we did

  • Set the date only once the plans and the equipment were actually in hand.
  • Installed in a single day with no surprises on the roof.
  • Requested the final the same week the work finished.
  • Issued the photograph set on the day of the inspection.

System specifications

ArrayResidential rooftop
PlansApproved and in hand before the date was set
EquipmentOn hand, including the AC disconnect
InstallationOne day
CorrectionsNone
Utility / AHJSouthern California Edison / Santa Clarita

Is your project like this one?

  • You want to know how fast solar can realistically go.
  • Your project has stalled and you cannot see where.
  • You are being given an install date before the plans are approved.
  • You want to know what actually determines the timeline.

Cali Energy in Santa Clarita

Santa Clarita is its own city in Los Angeles County, permitted through the City of Santa Clarita Building & Safety Division and interconnected through Southern California Edison. Inspection slots here come round quickly when the paperwork is ready for them.

This installation is on the Santa Clarita projects page alongside the others, and what the work covers is set out on the Santa Clarita service area page.

Frequently asked questions

How long does a residential solar project take?

The installation is usually a day. Everything around it is what varies: an approved plan set, equipment physically in hand and a live permit can produce a passed final in about two weeks, while the same house with drawings still in review can take months.

What is the most common cause of delay?

Plan check and equipment, in that order. Drafting and review are the largest variable and the least visible to an owner; after that it is a small component — frequently the AC disconnect — that was assumed to be available and was not.

Should I accept an install date before the plans are approved?

Be careful with it. A date set against drawings still in review is a hope rather than a booking, and the crew will be rescheduled. A date set once the plans are approved and the equipment is on hand is a date that holds.

How quickly can a final inspection be booked?

Within days where the permit is live and the job card is with it. On this project the final was requested on the Friday after installation and held the following Monday.

Does Cali Energy install solar in Santa Clarita?

Yes. Projects here are permitted through the City of Santa Clarita Building & Safety Division and interconnected through Southern California Edison, and inspection slots come round quickly when the paperwork is ready for them.

What this would look like on your roof

Every number above came off a real job in Santa Clarita, CA — not a brochure. Tell us your utility, your roof and what your bill looks like now, and we will model your own version of it before you commit to anything.

Or call +1 (323) 844-7777 · Cali Energy, Northridge · CSLB #1032379 (B, C-10, C-39) — design, permits, install and electrical under one licensed contractor.

Related

This timeline reflects this property and this permitting path. Updated September 2026.
